Debarker #1 Replacement
Year: 2017
Client: Louisiana-Pacific Canada
Location: Swan Valley, Manitoba

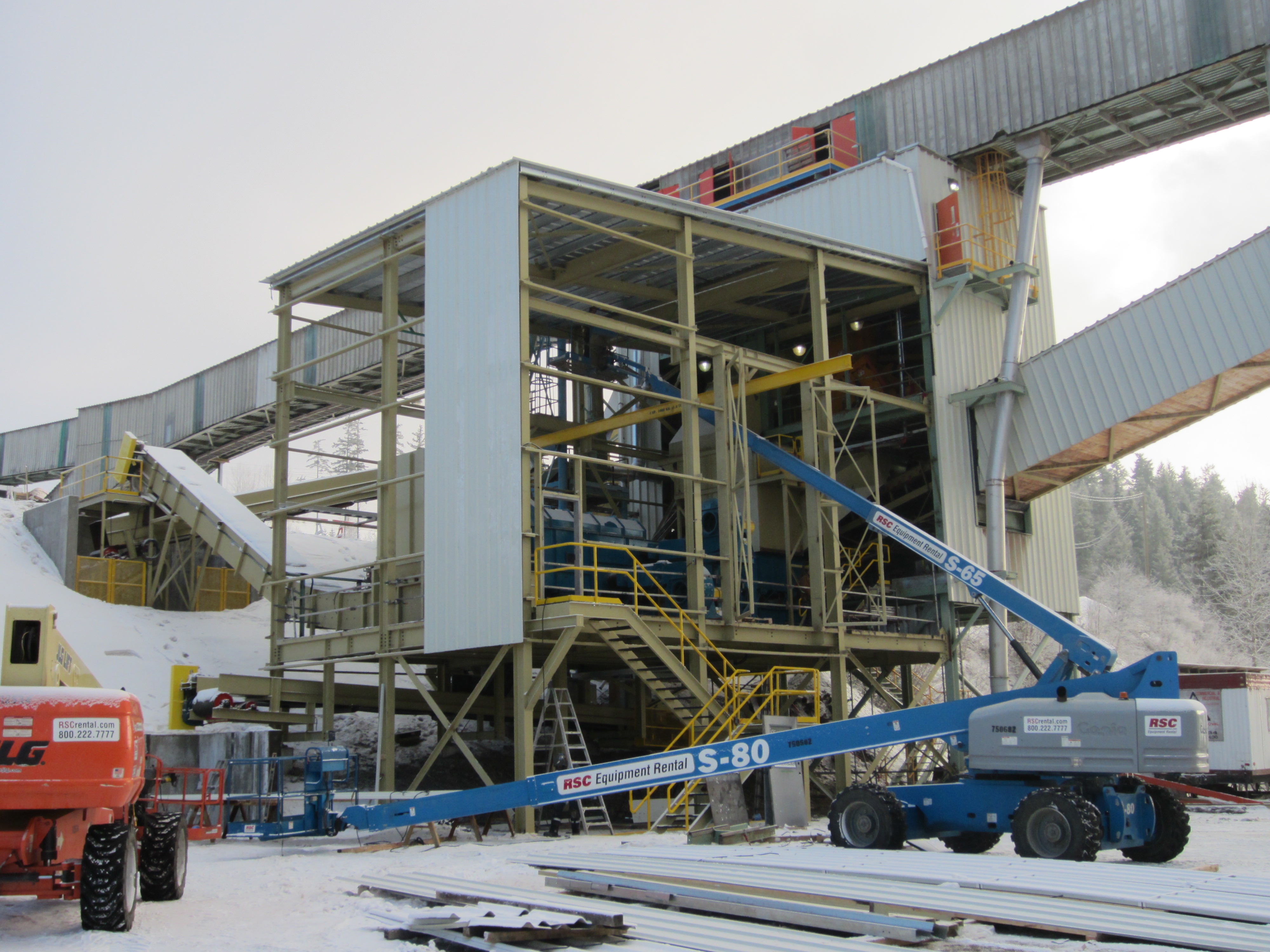

An 11 day shutdown to replace an old A5 debarker with a new A8 debarker was executed.

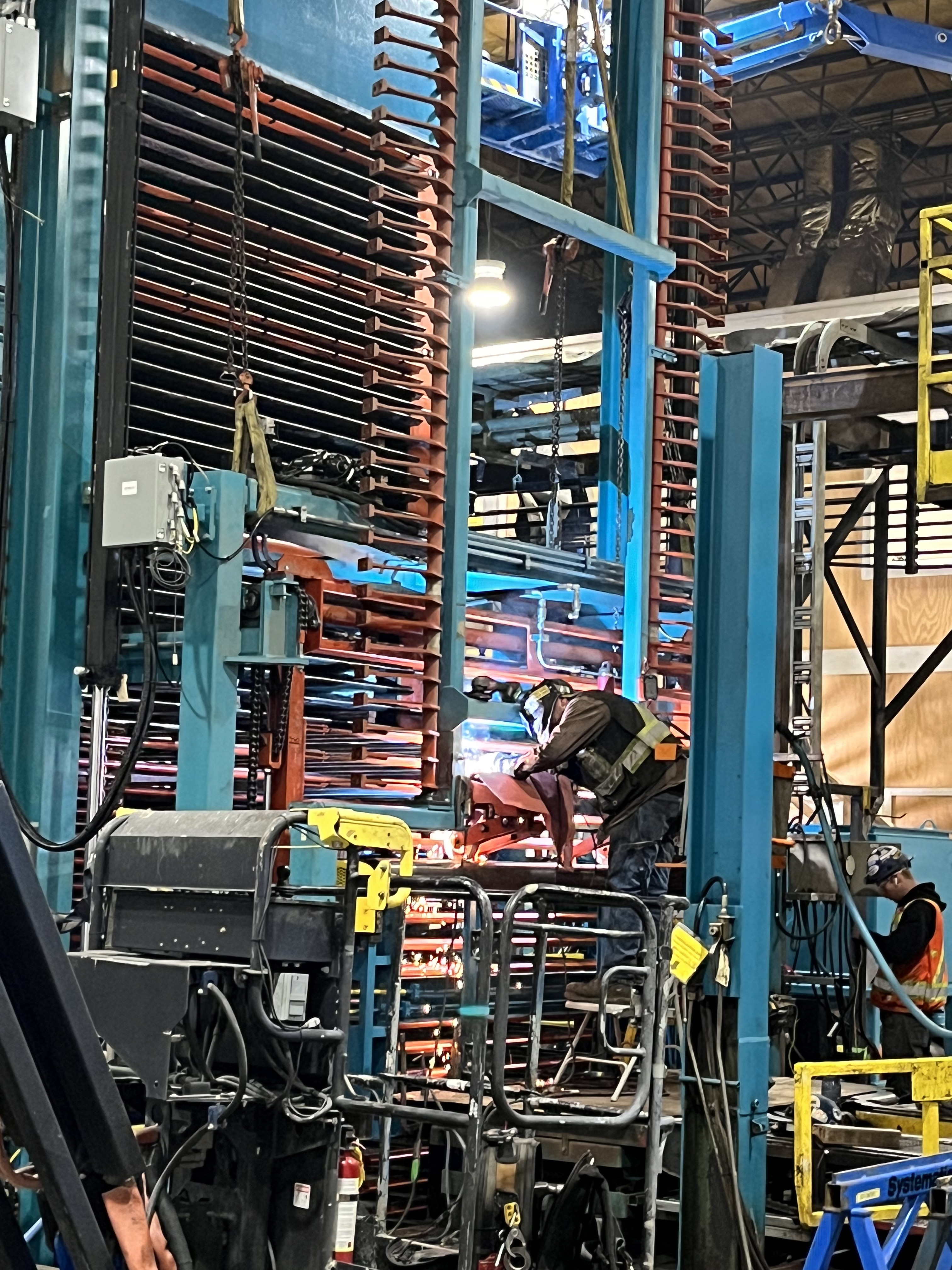

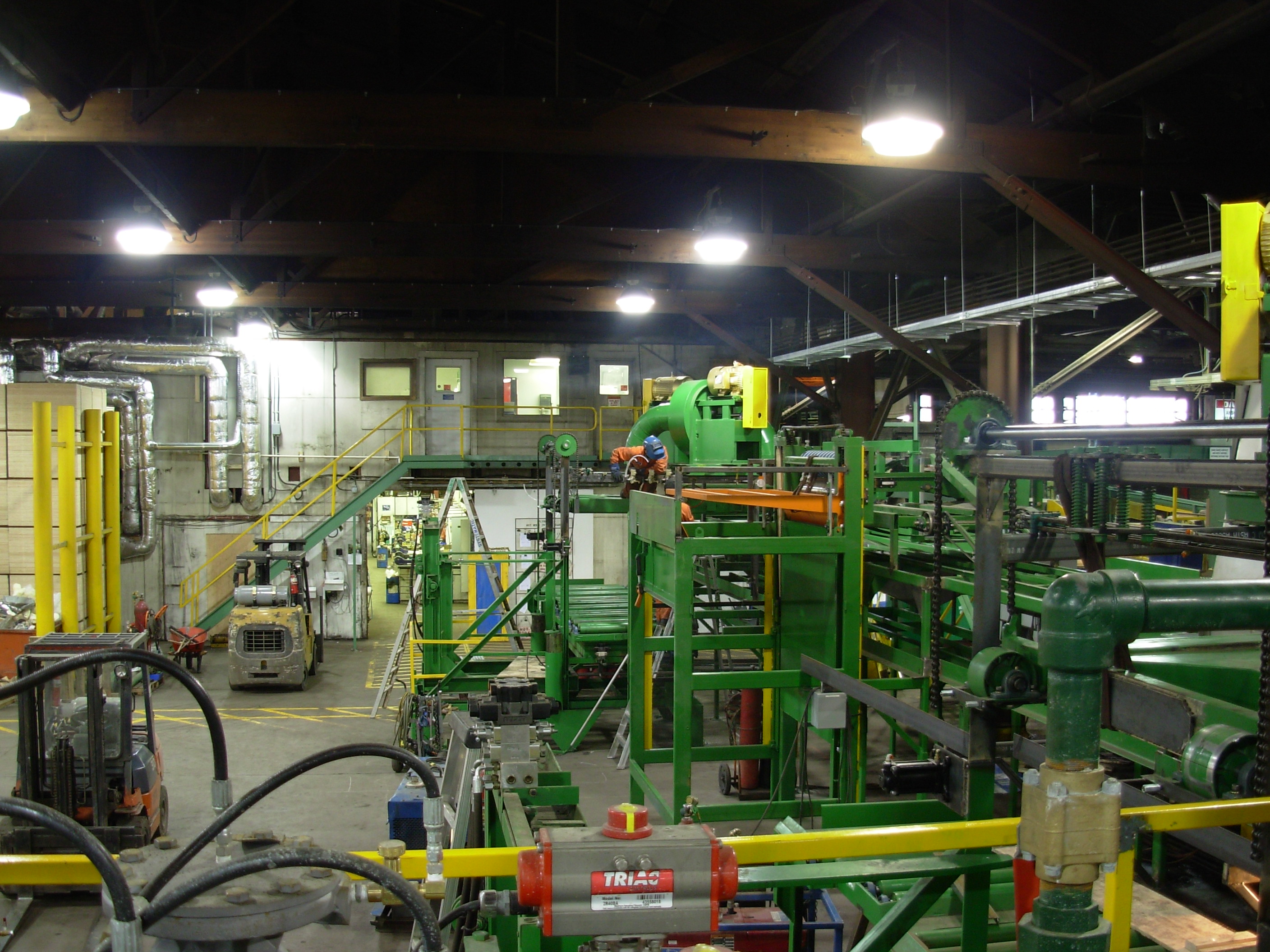

Project Overview

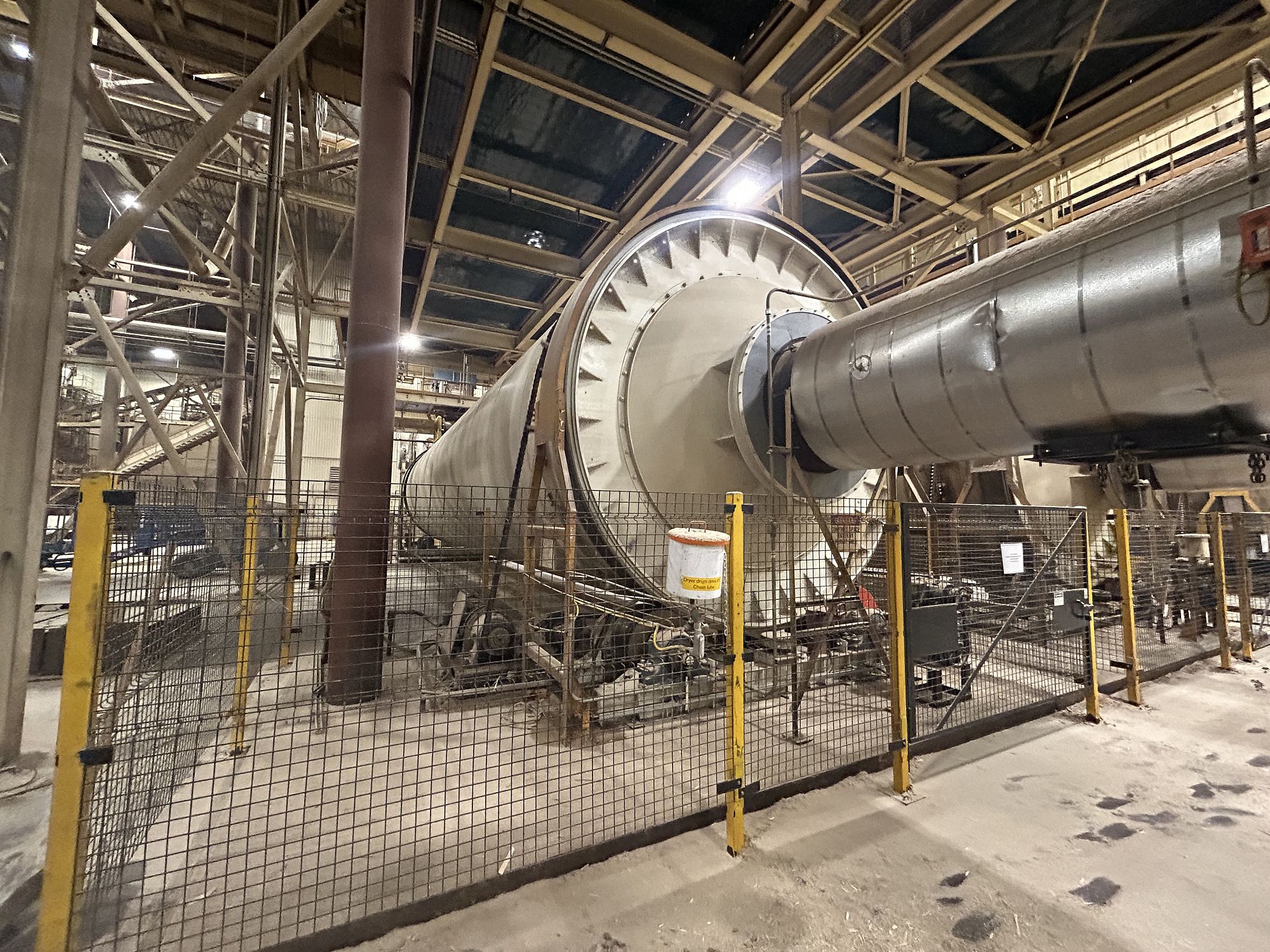

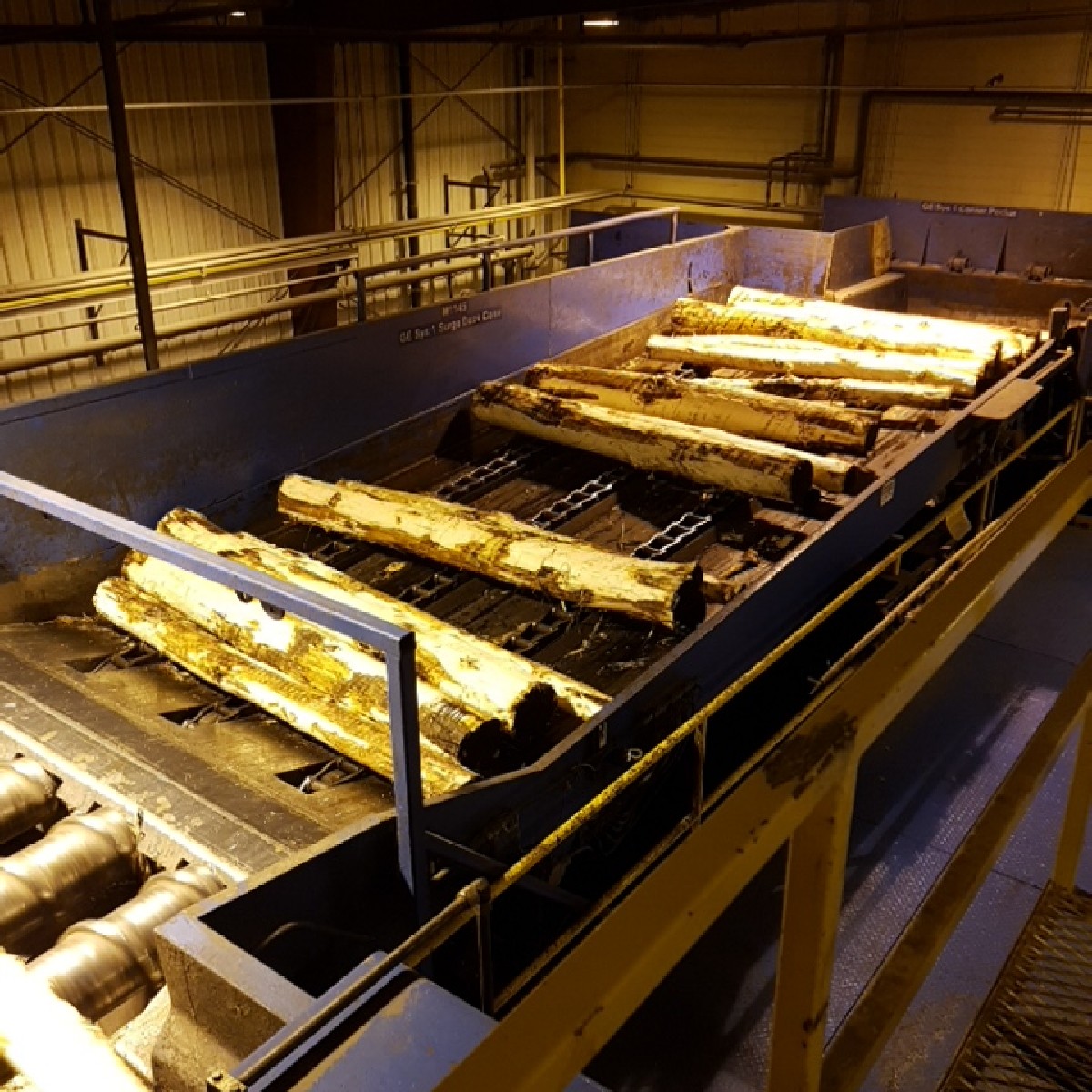

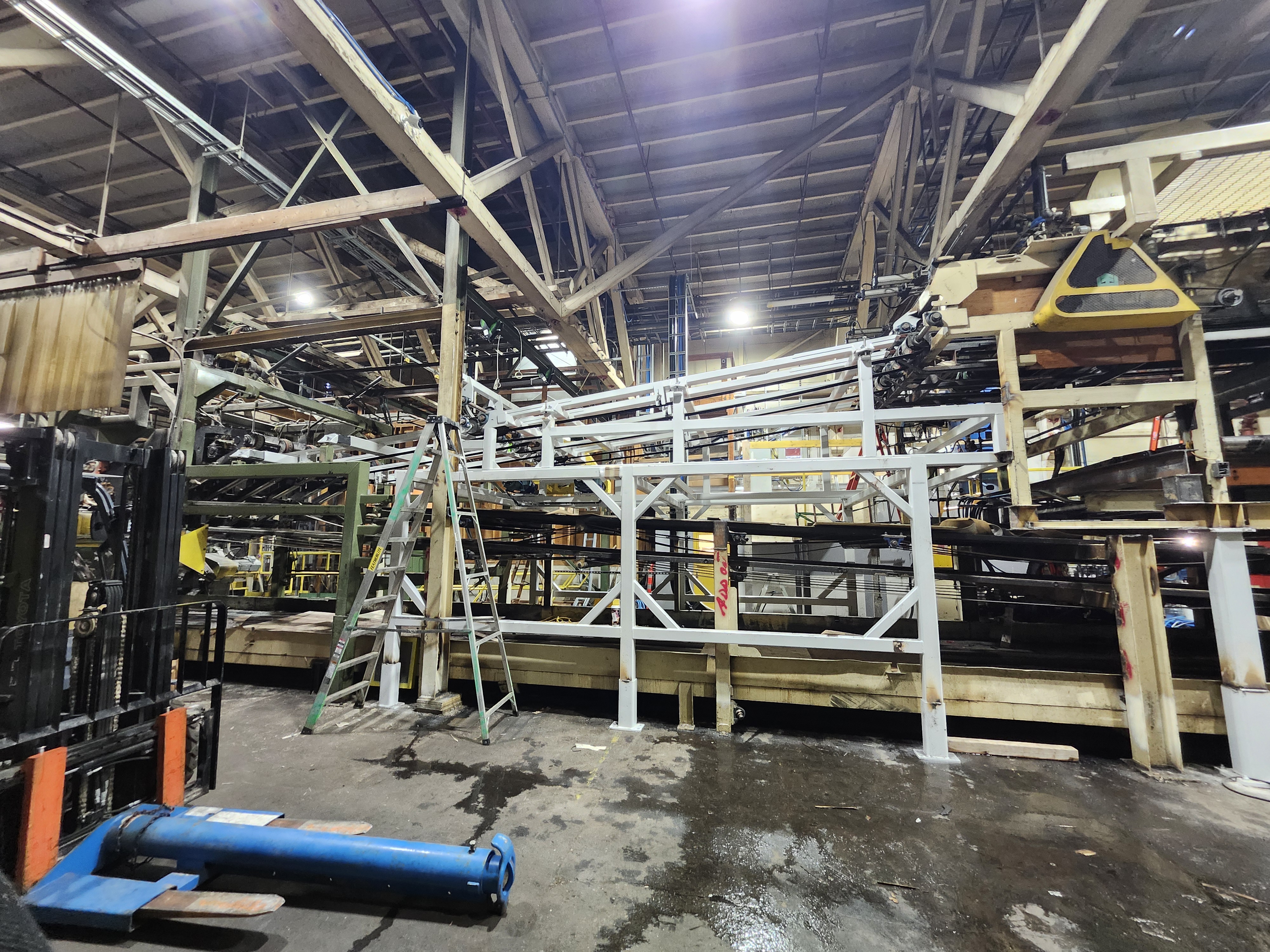

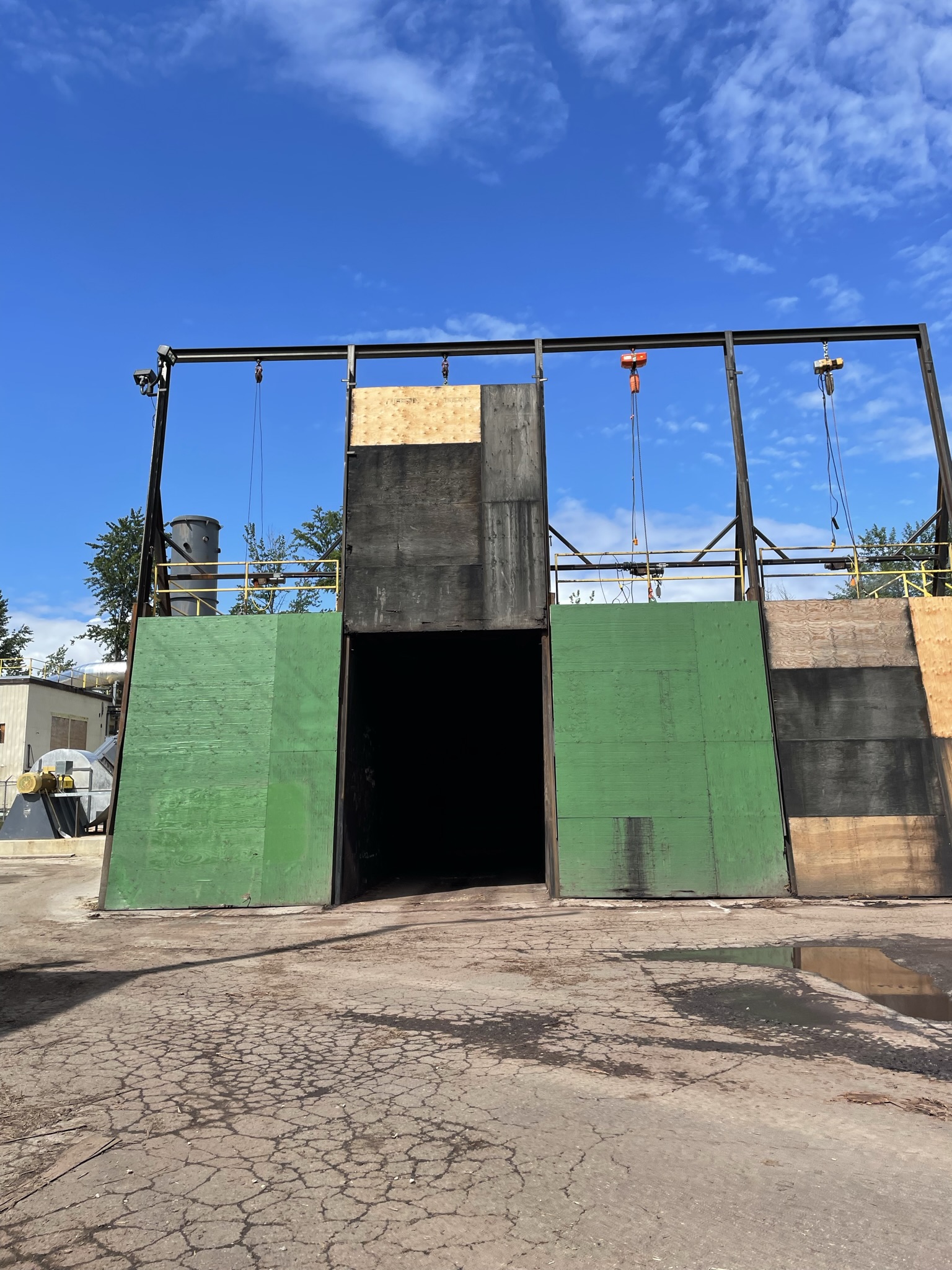

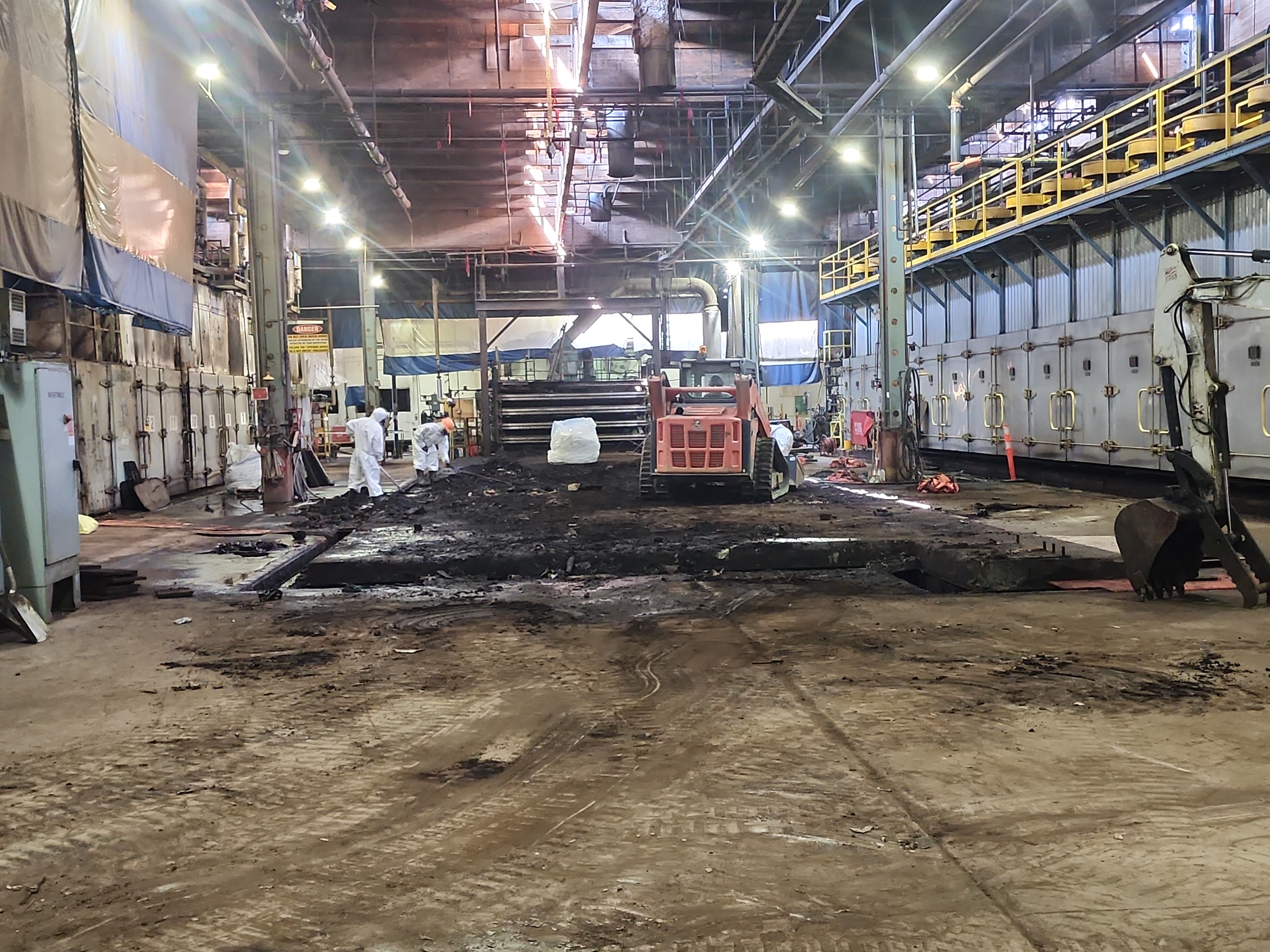

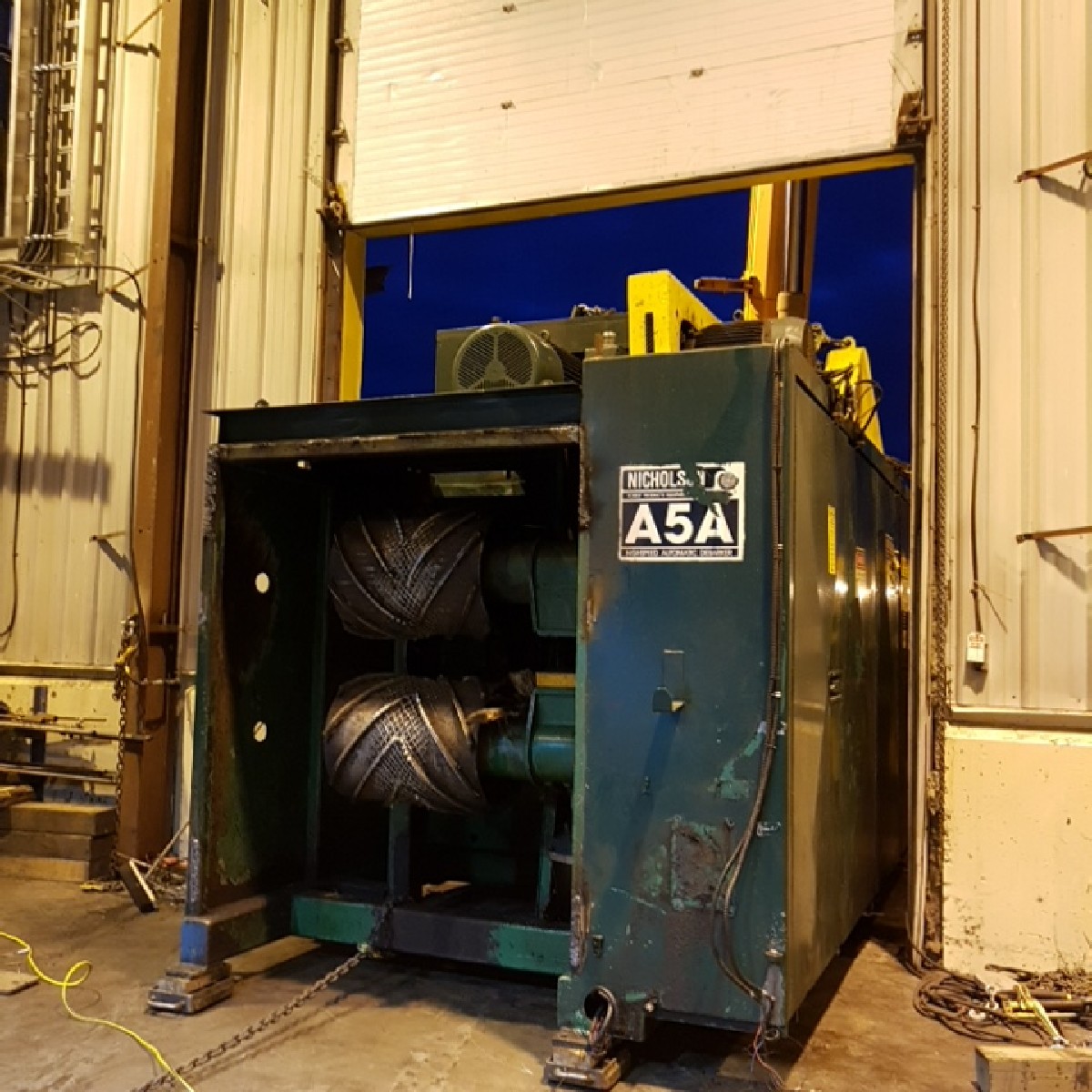

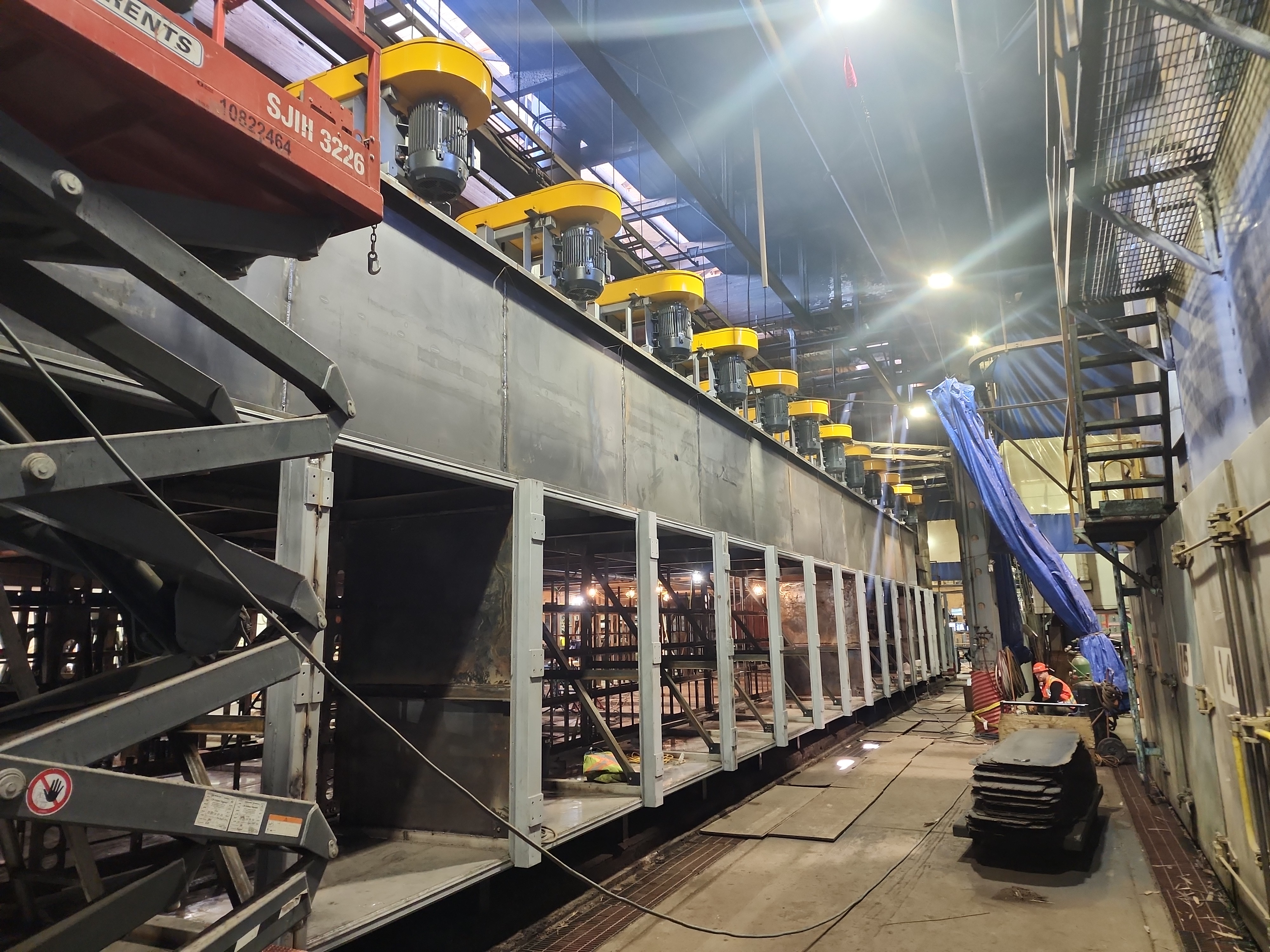

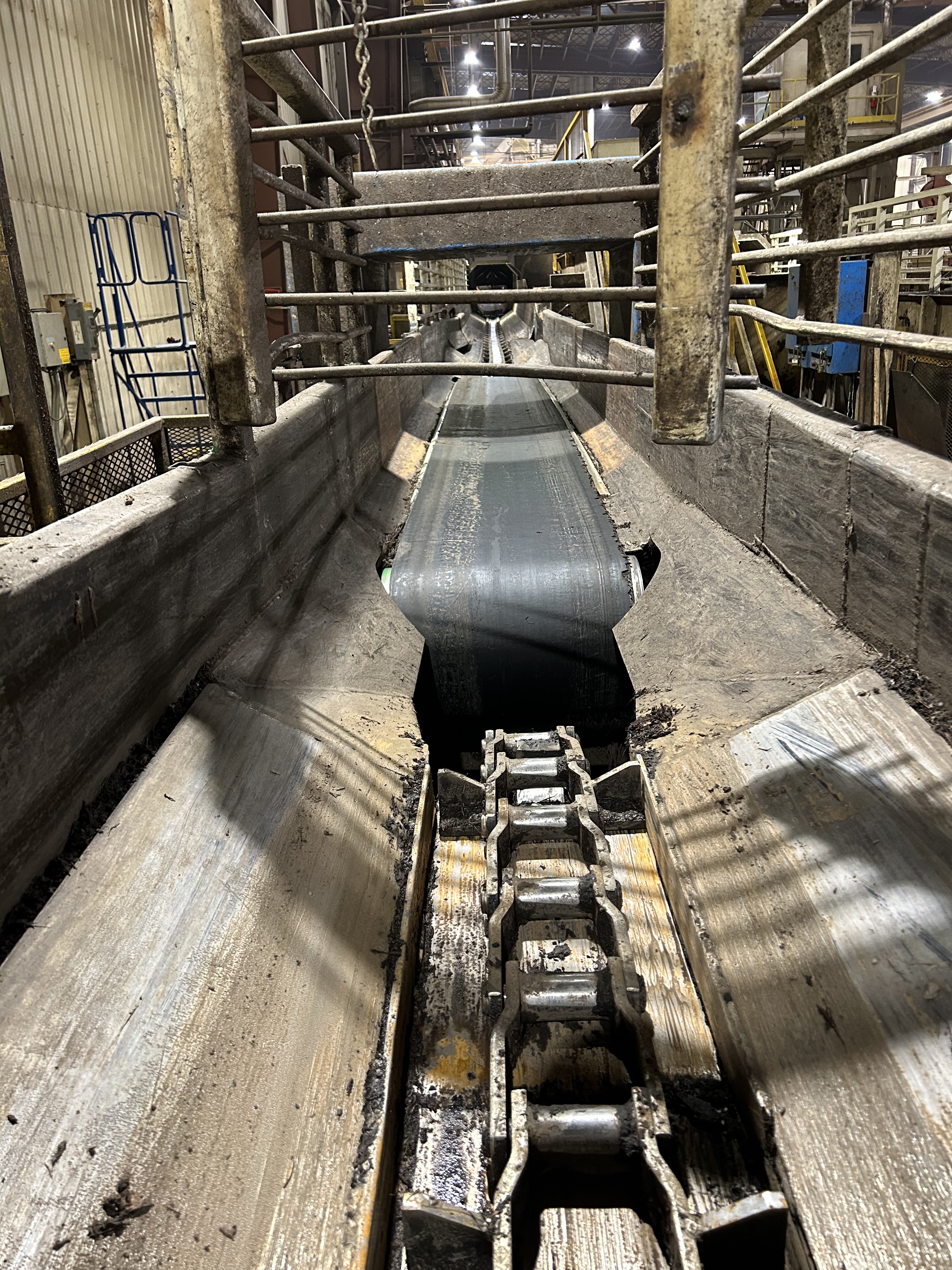

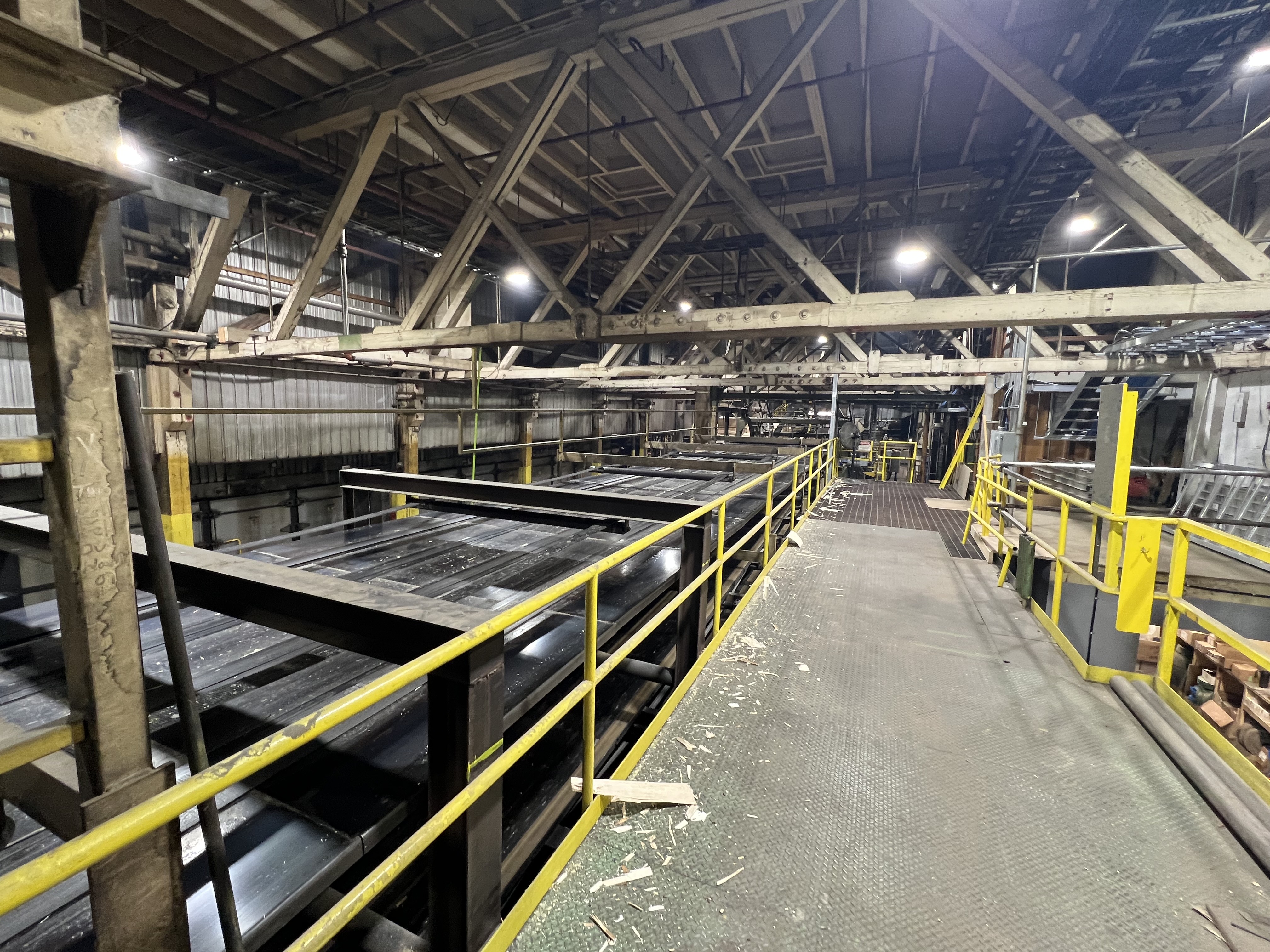

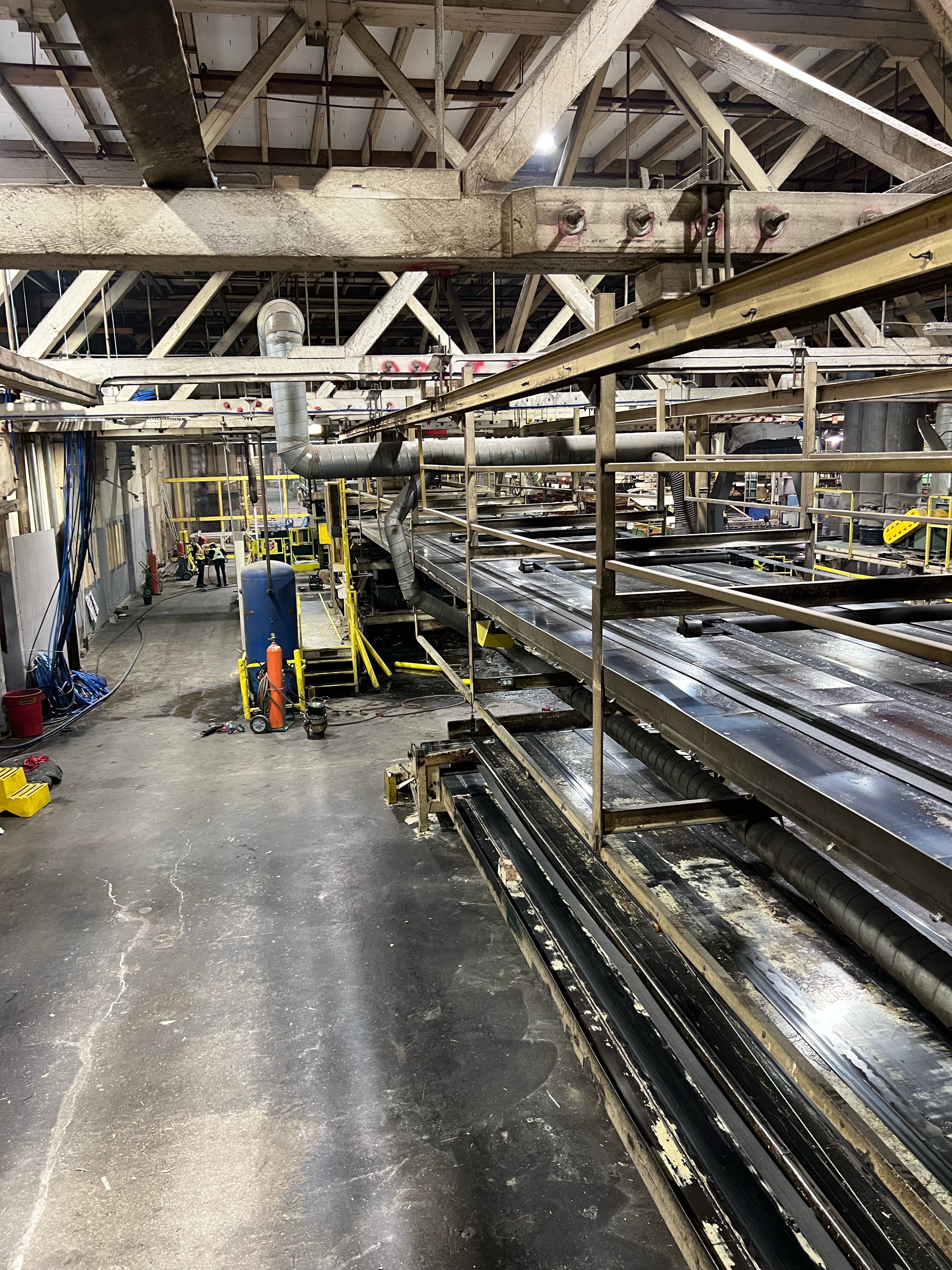

Existing Debarker #2 Removal:
- Separate then remove barker ring and other auxiliary equipment

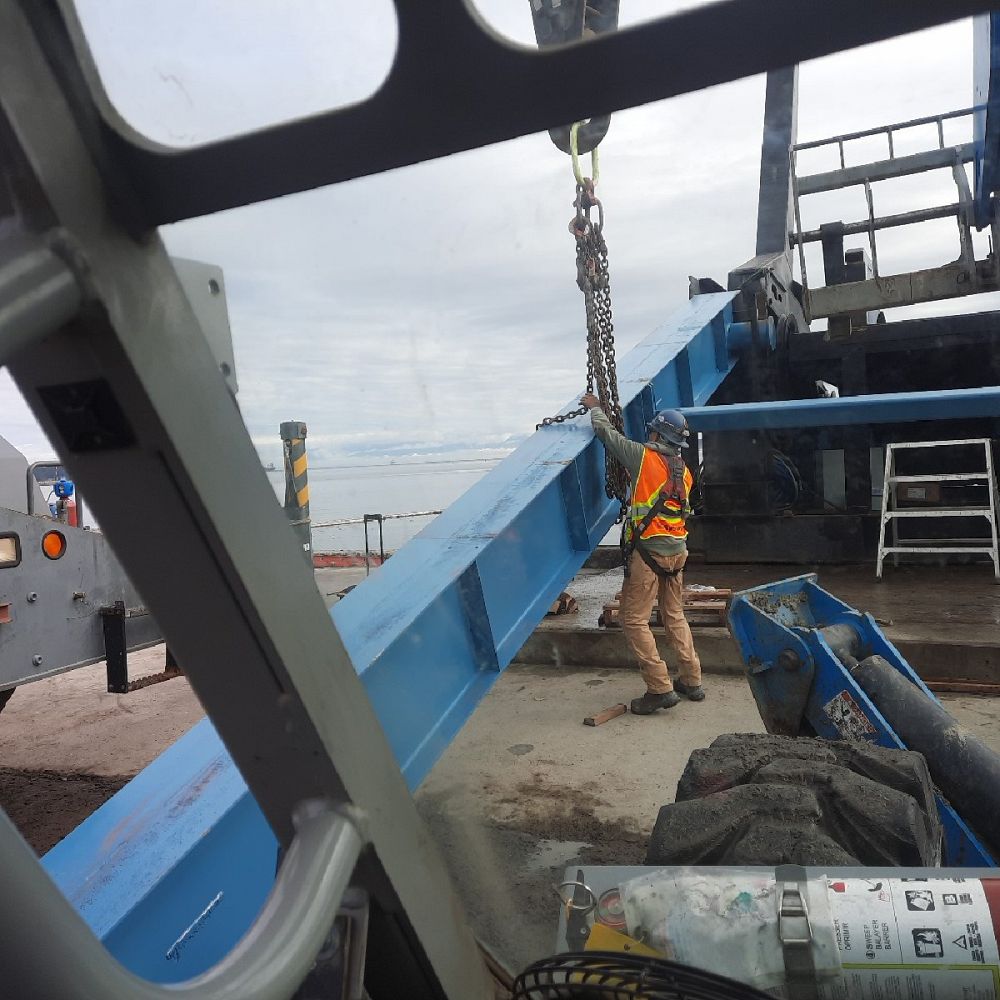

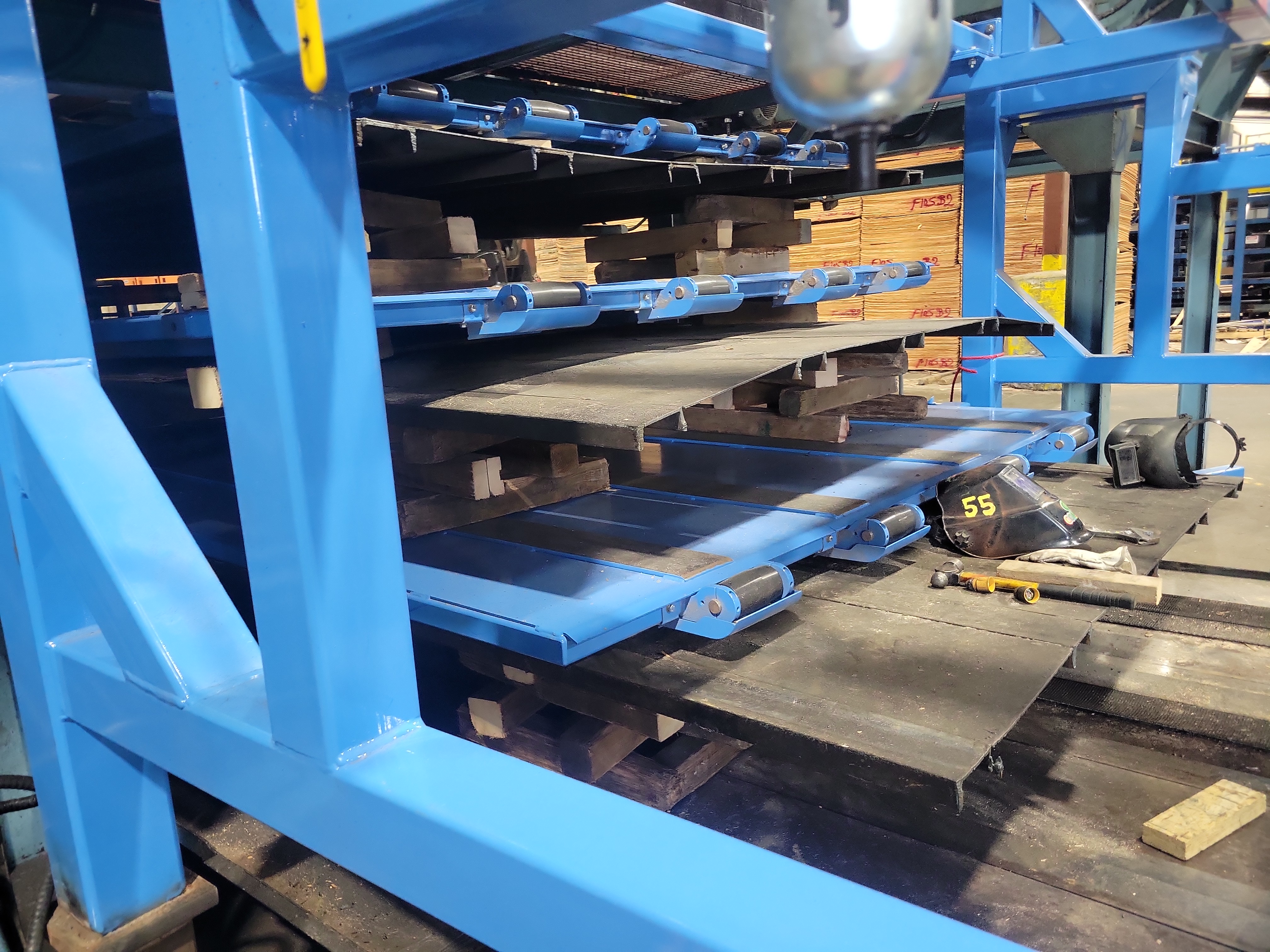

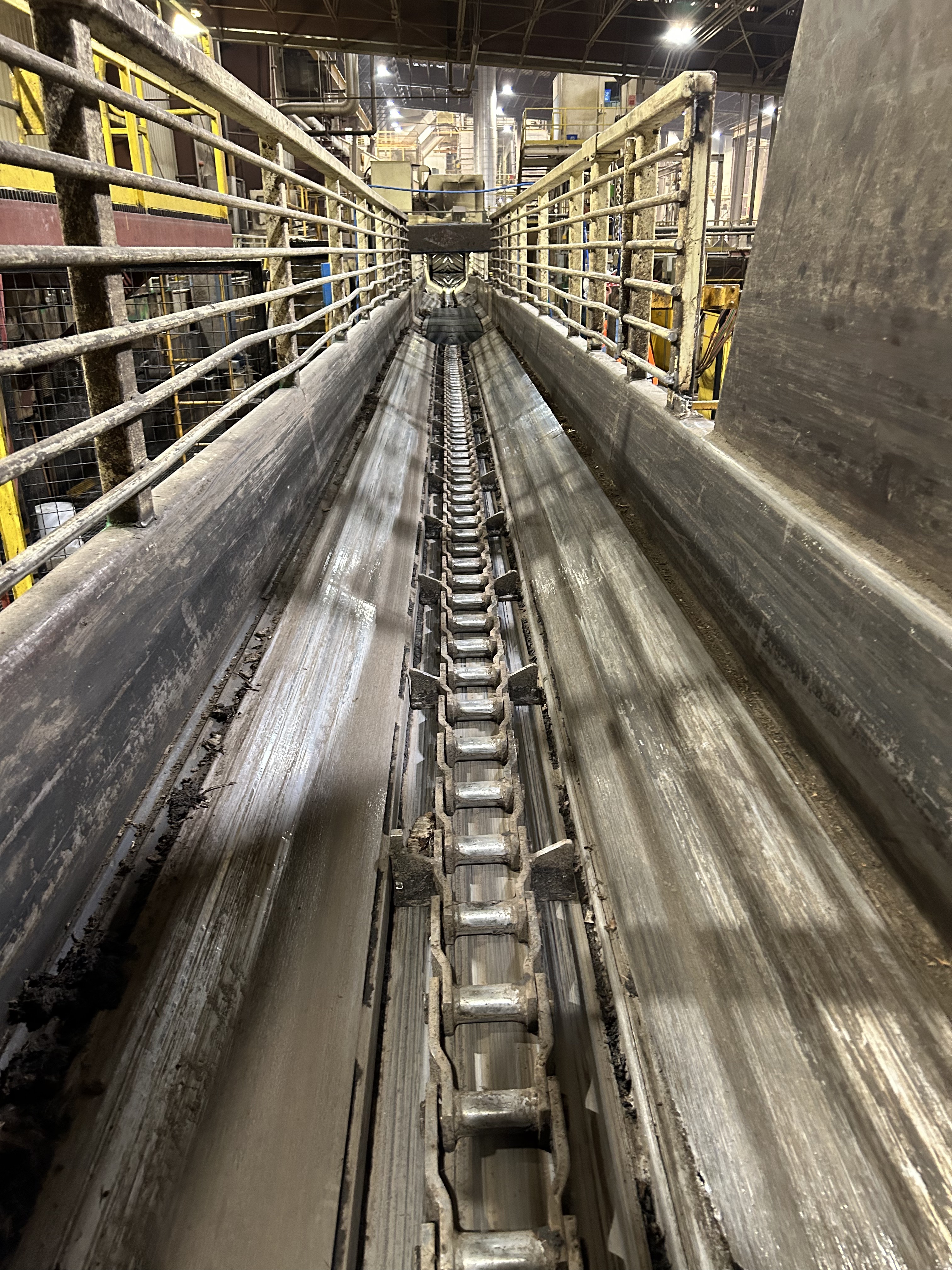

- Install temporary plates for clean-up conveyor
- Remove and modify platform/stairs for access to new Debarker

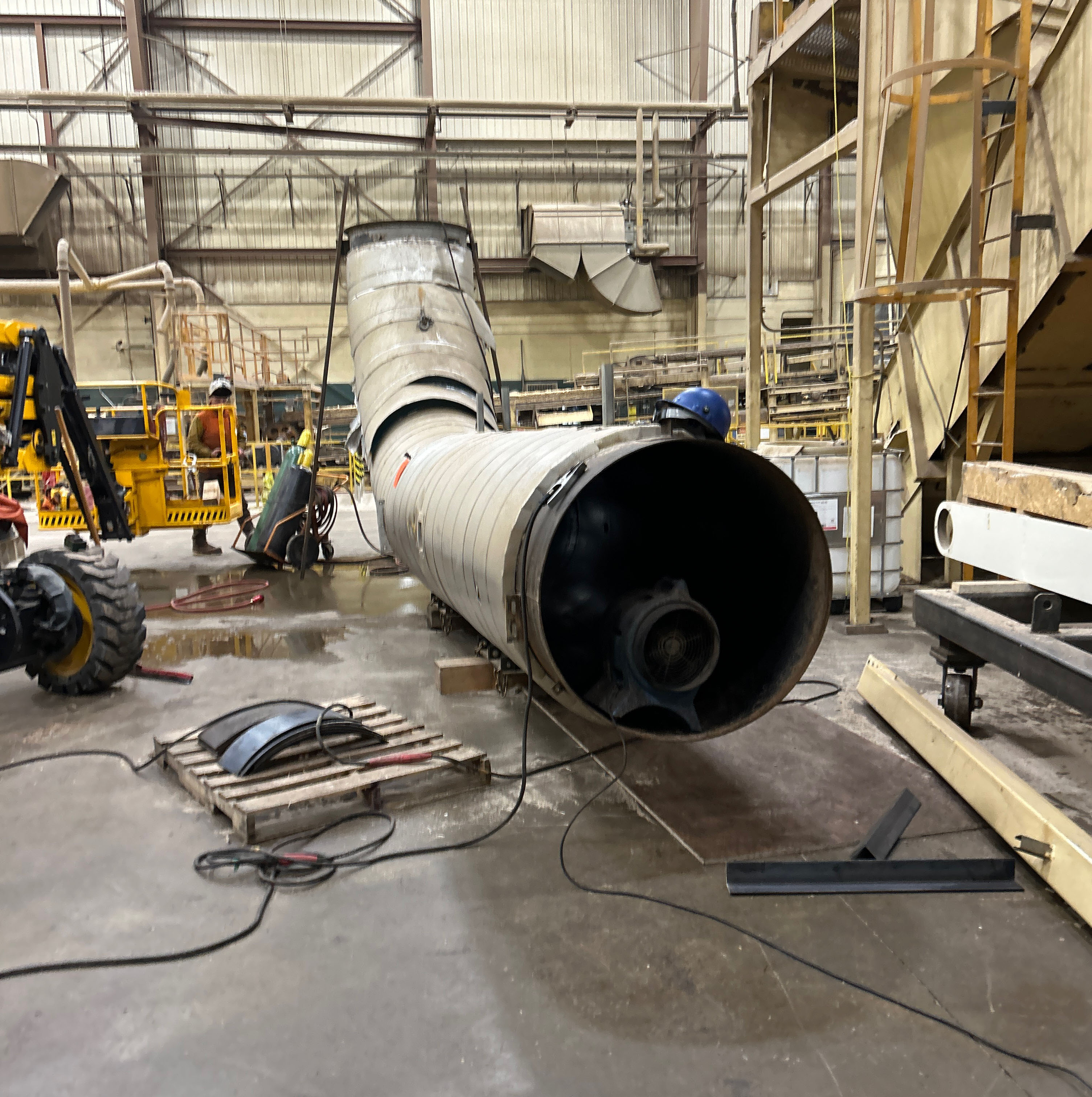

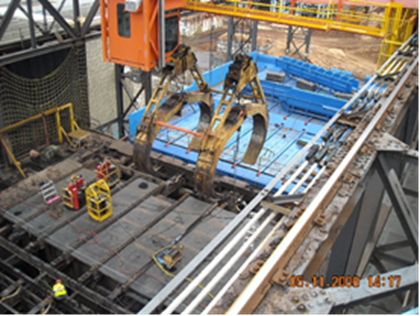

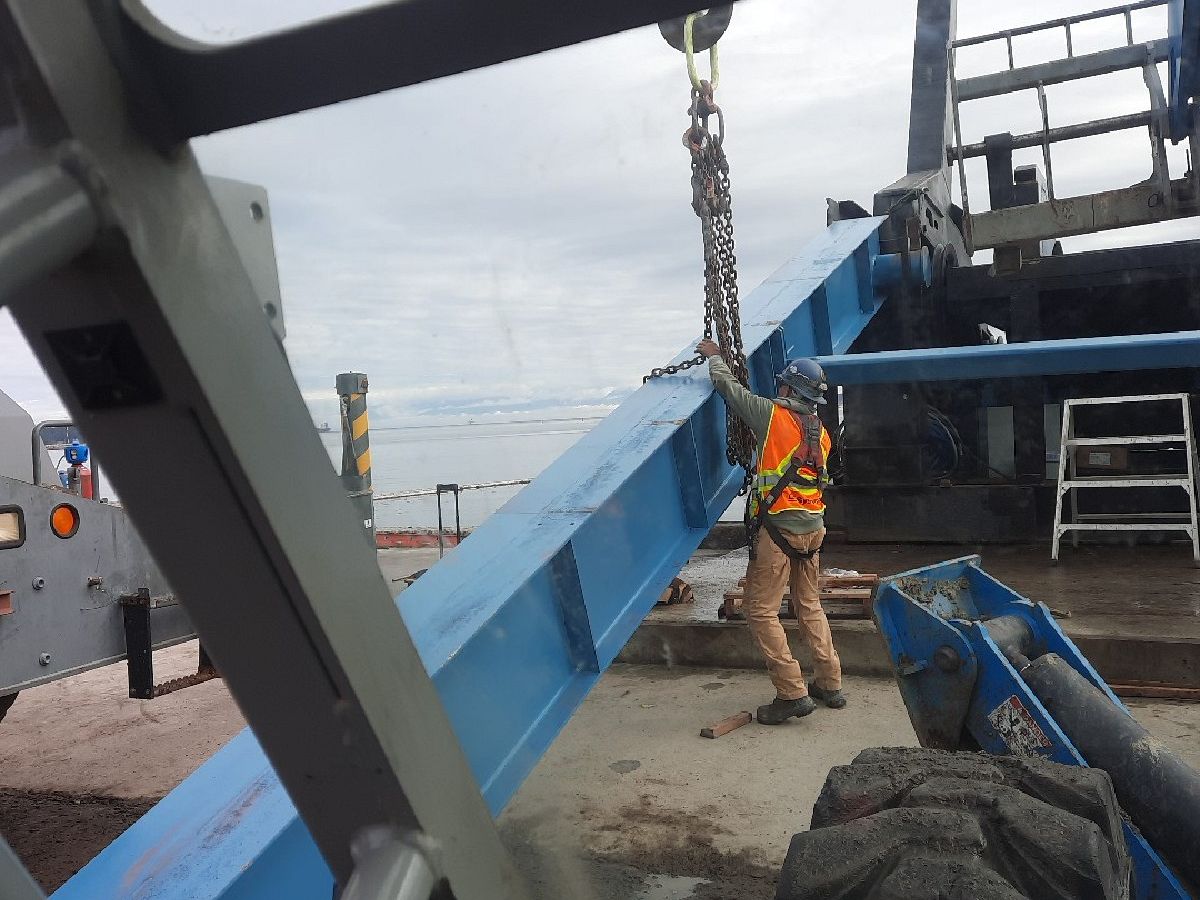

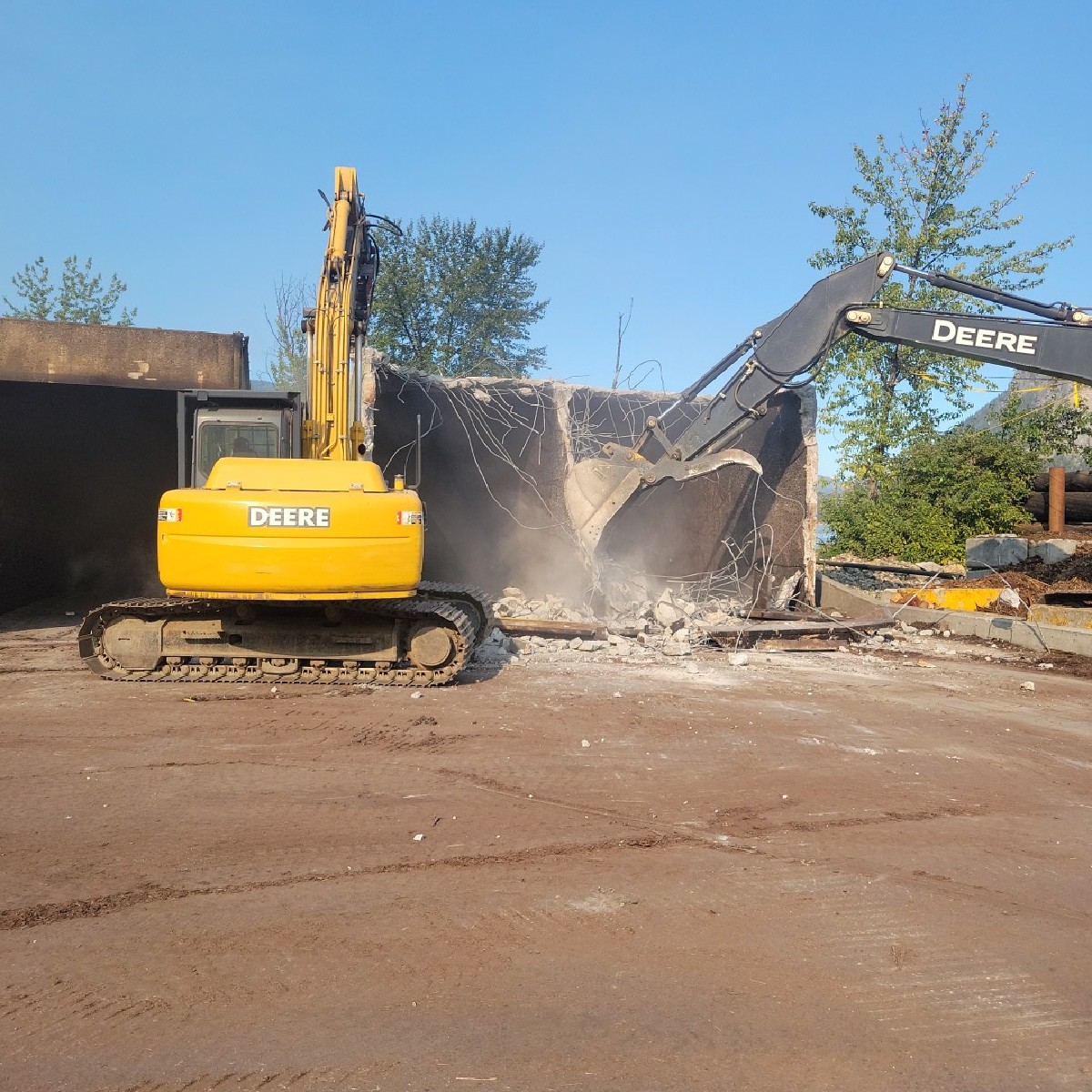

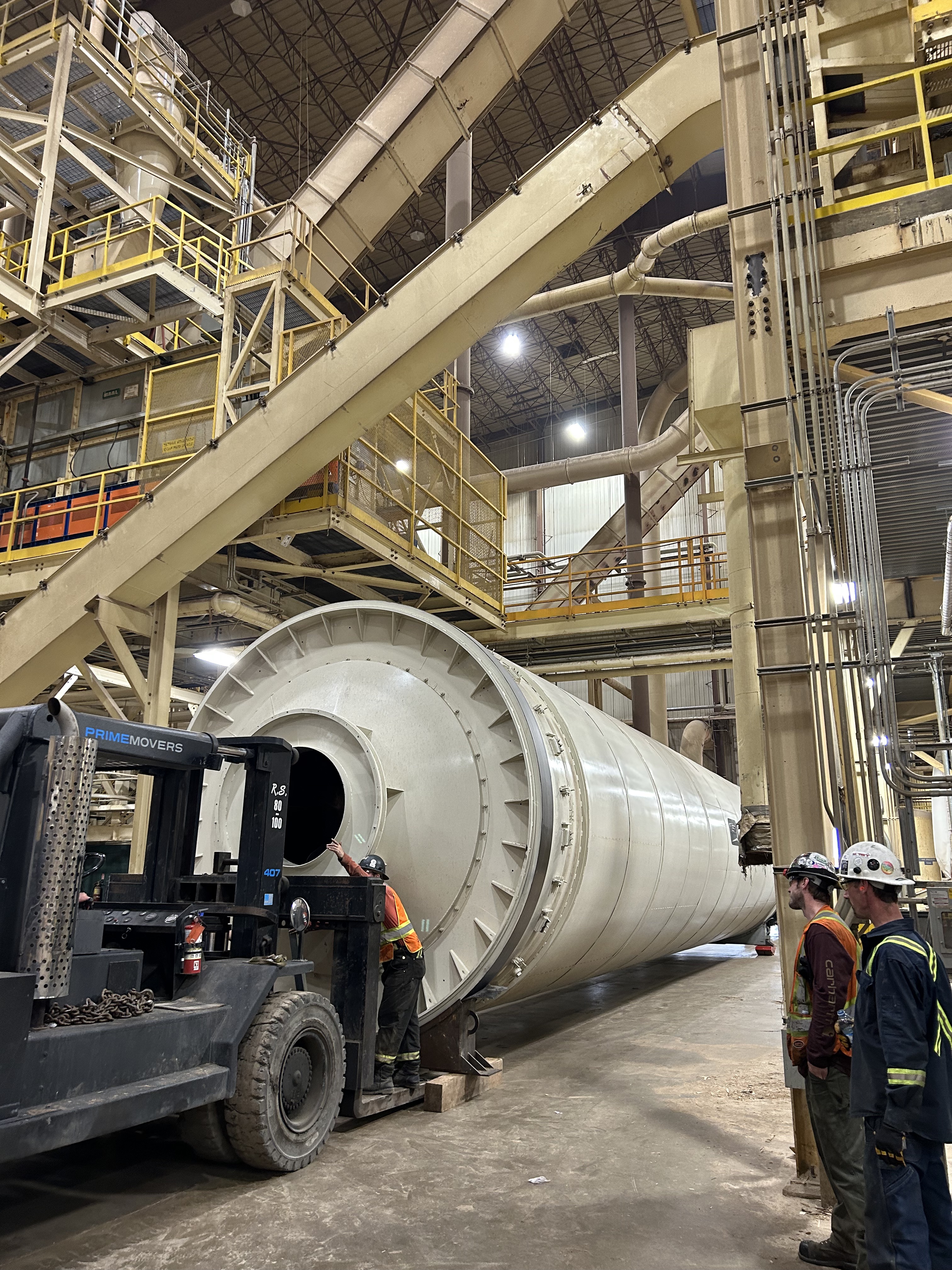

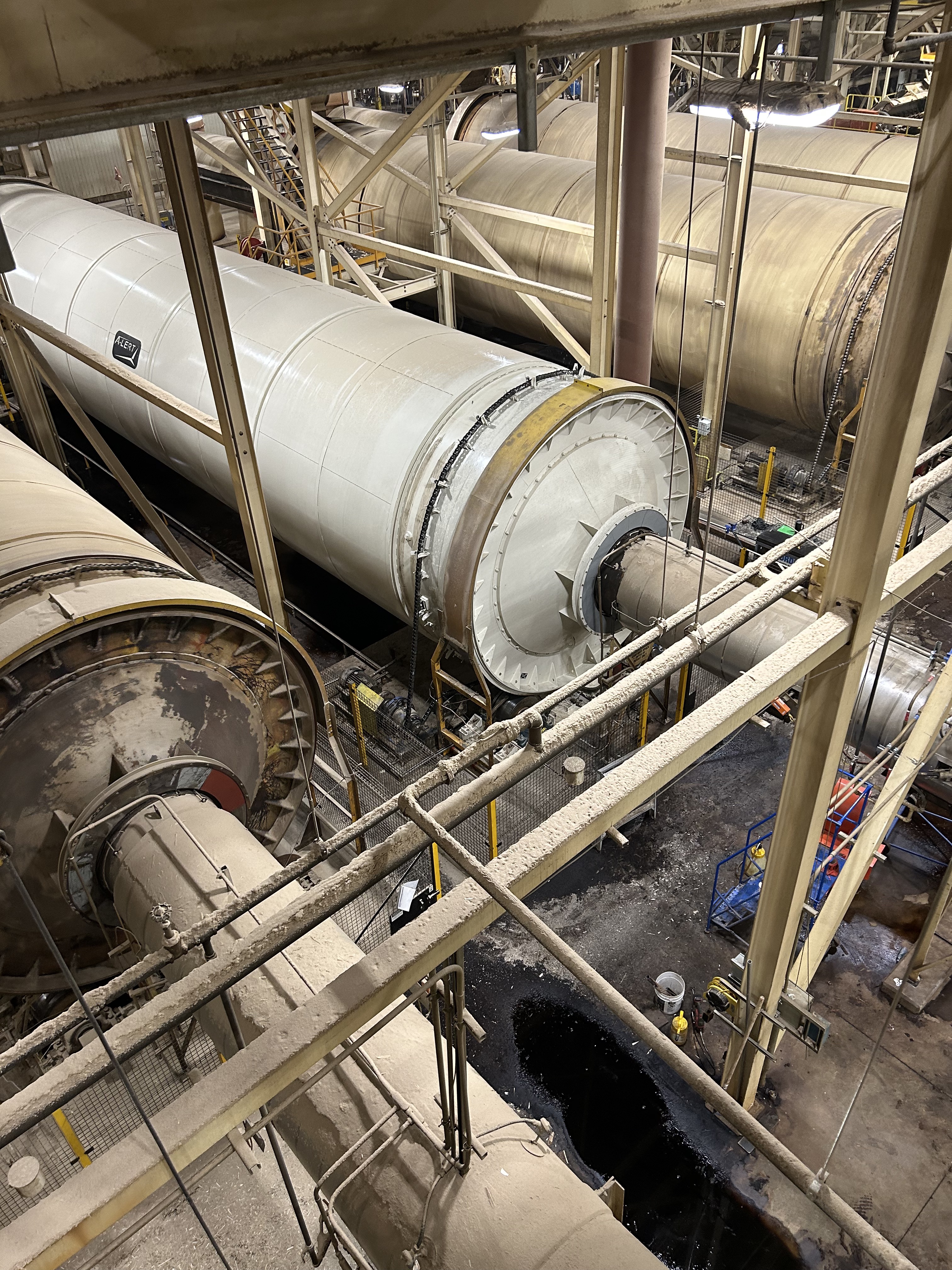

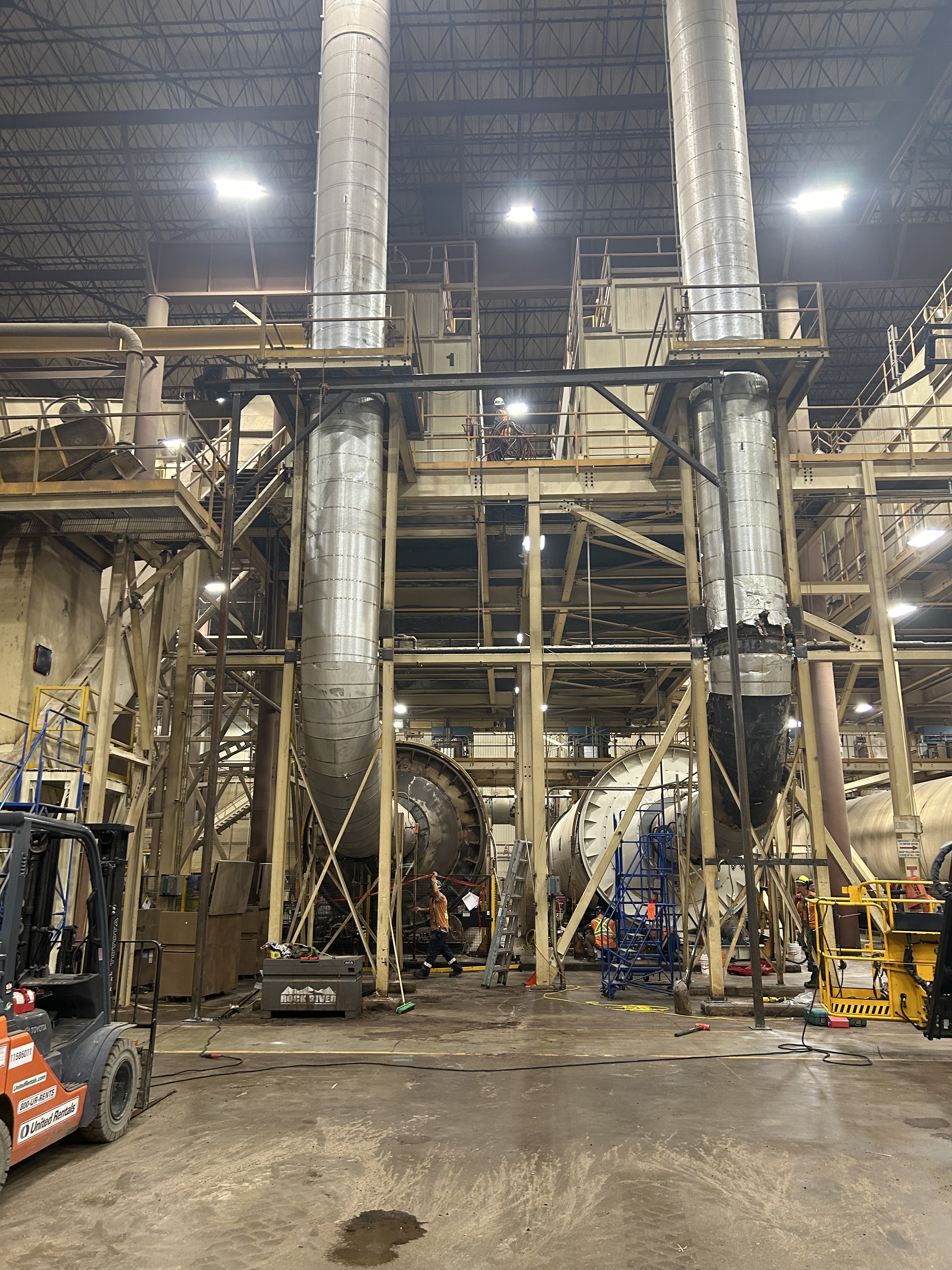

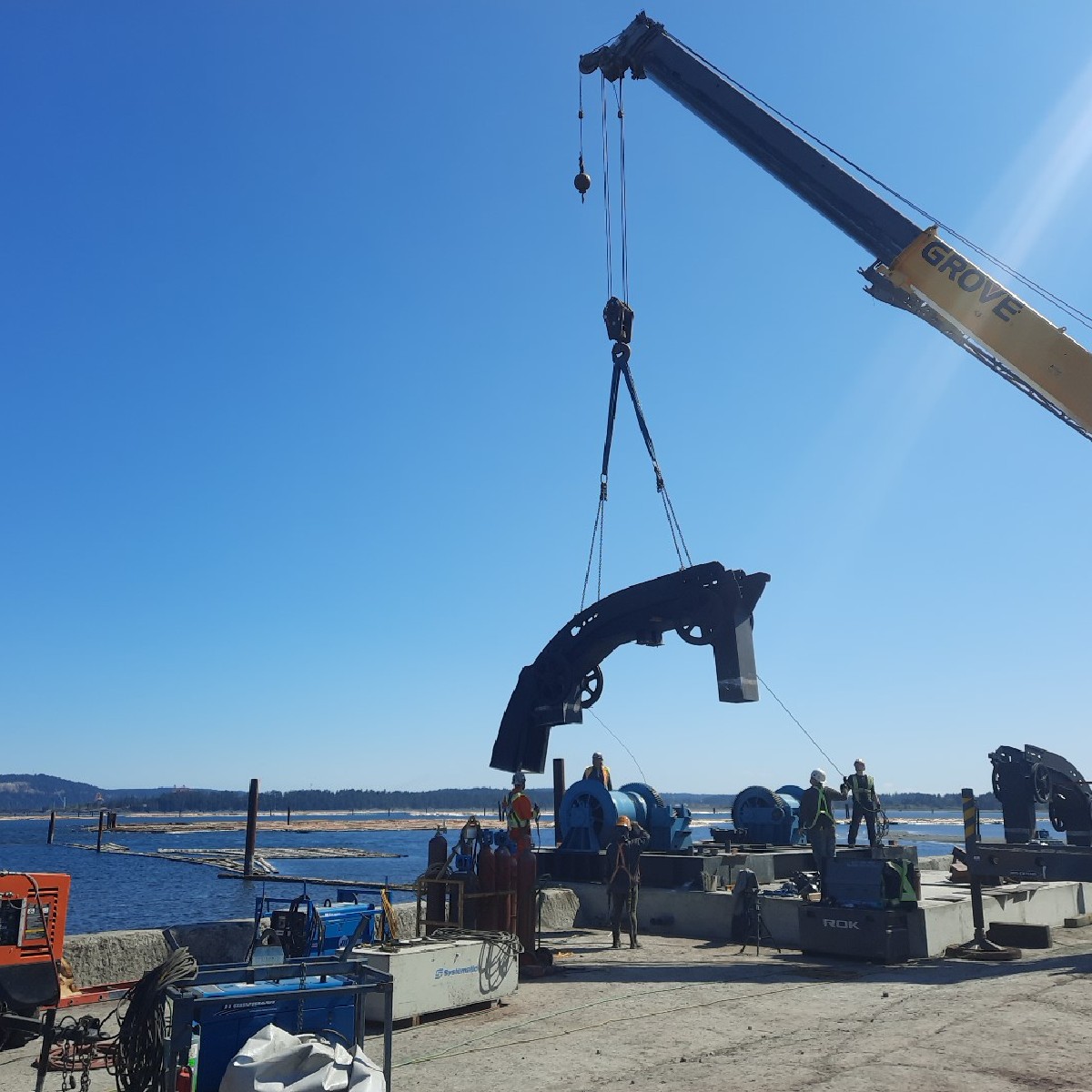

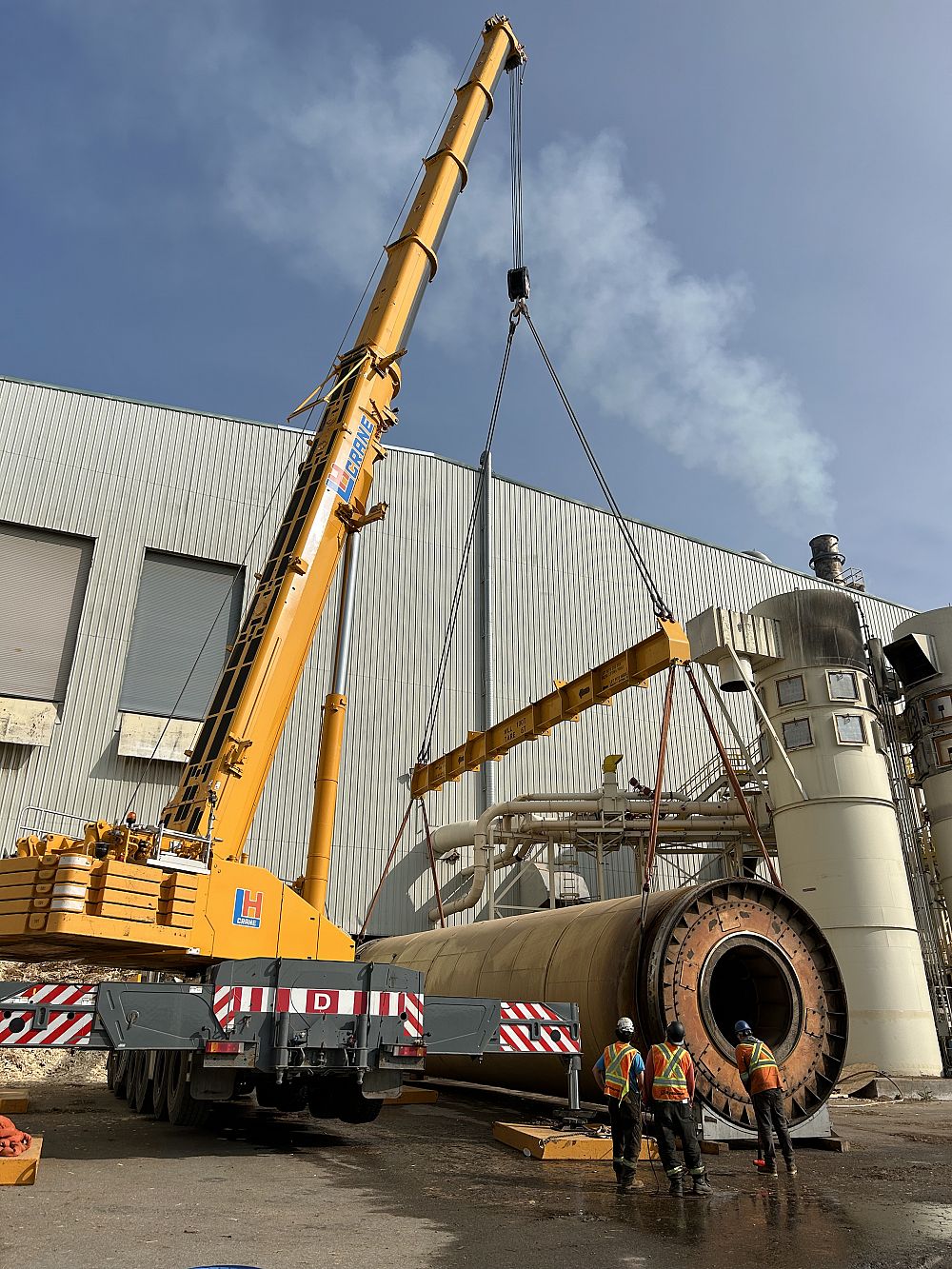

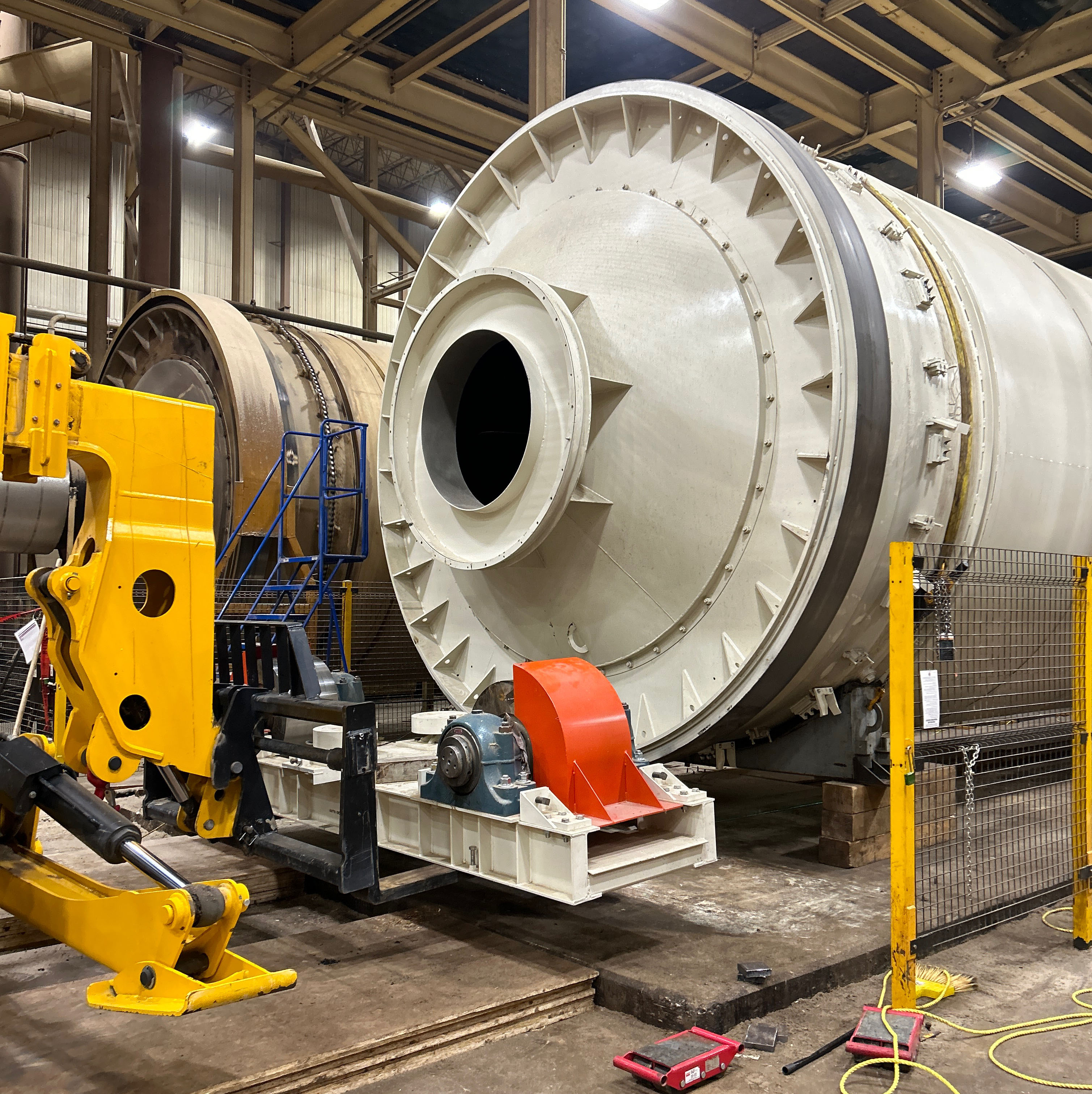

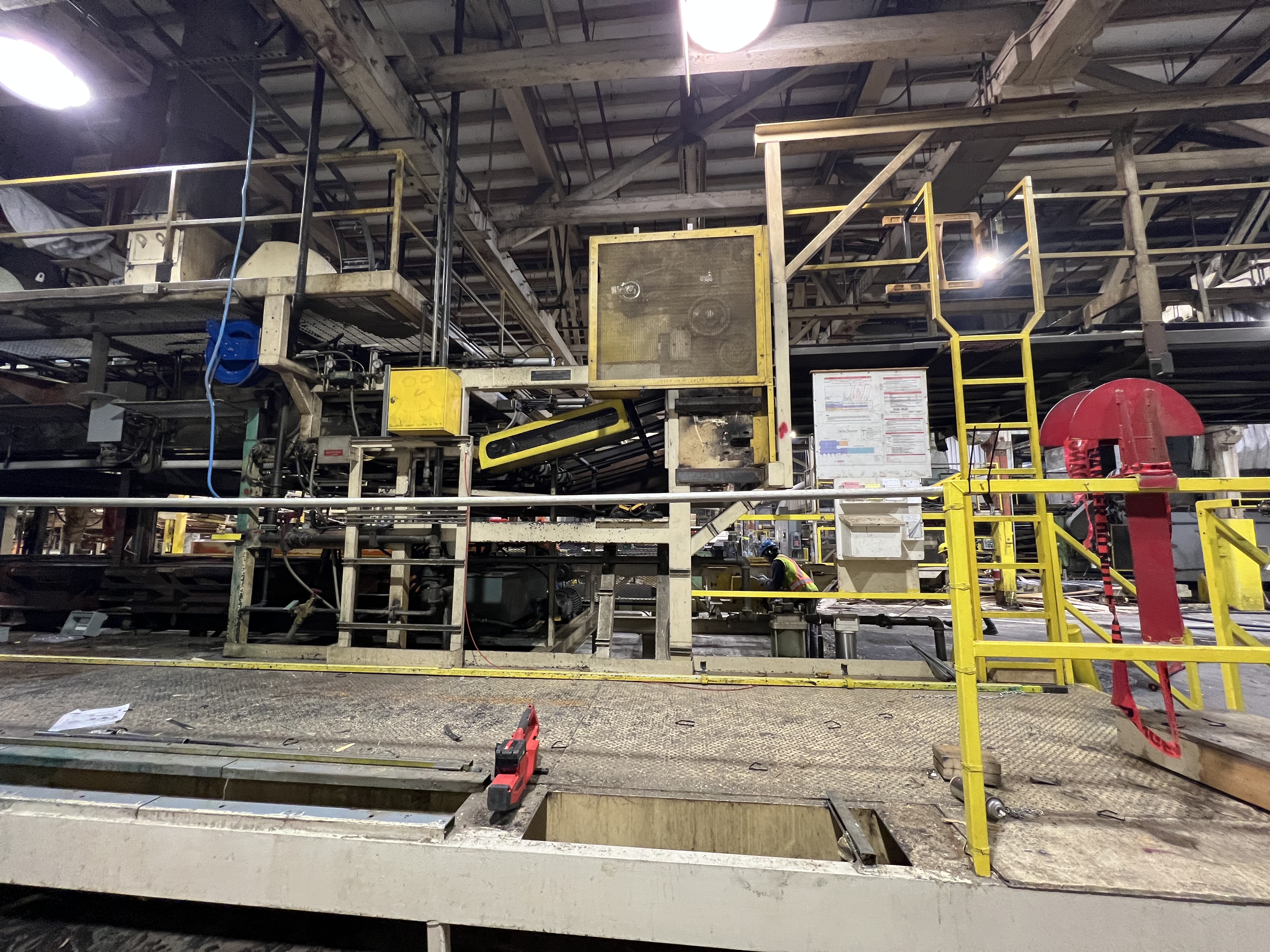

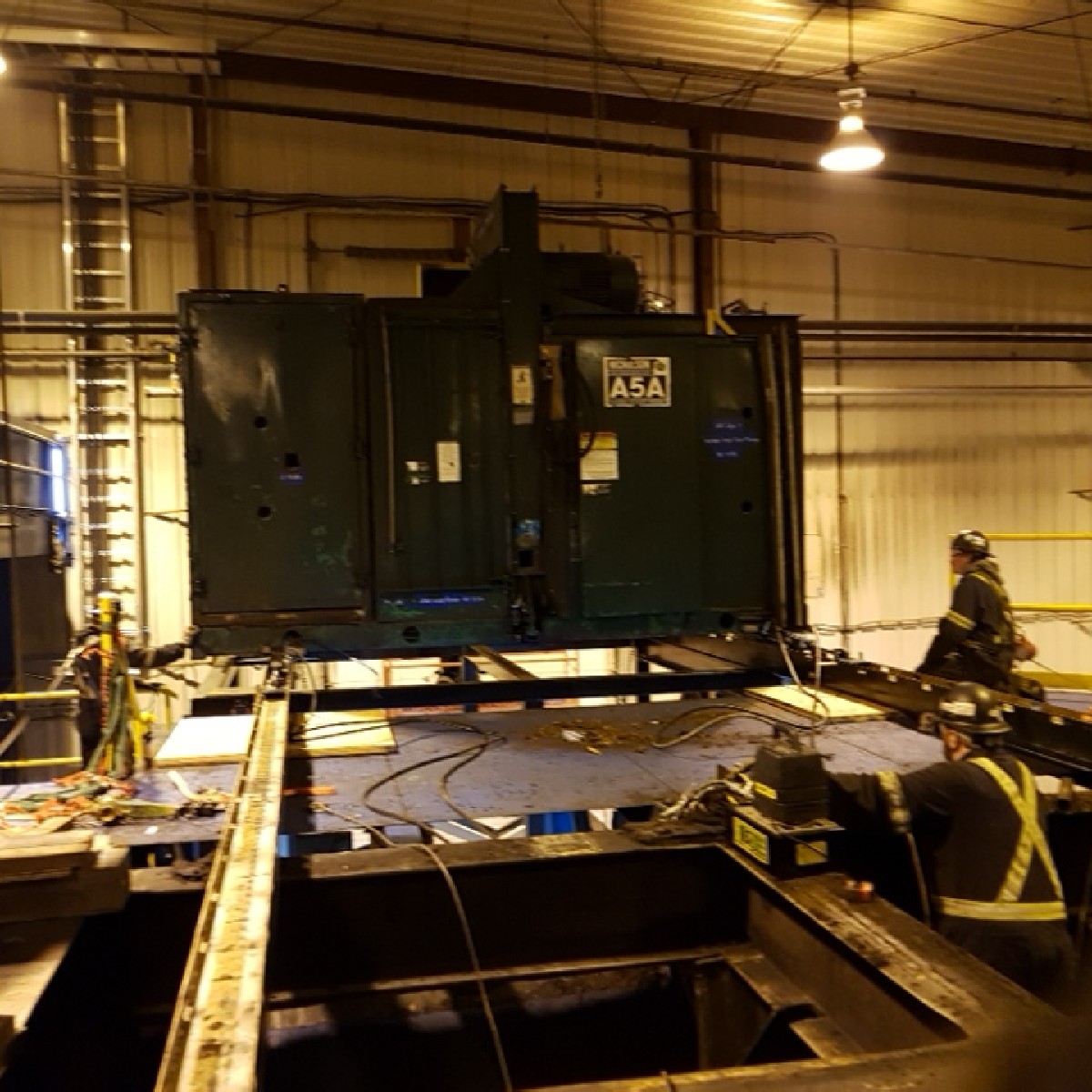

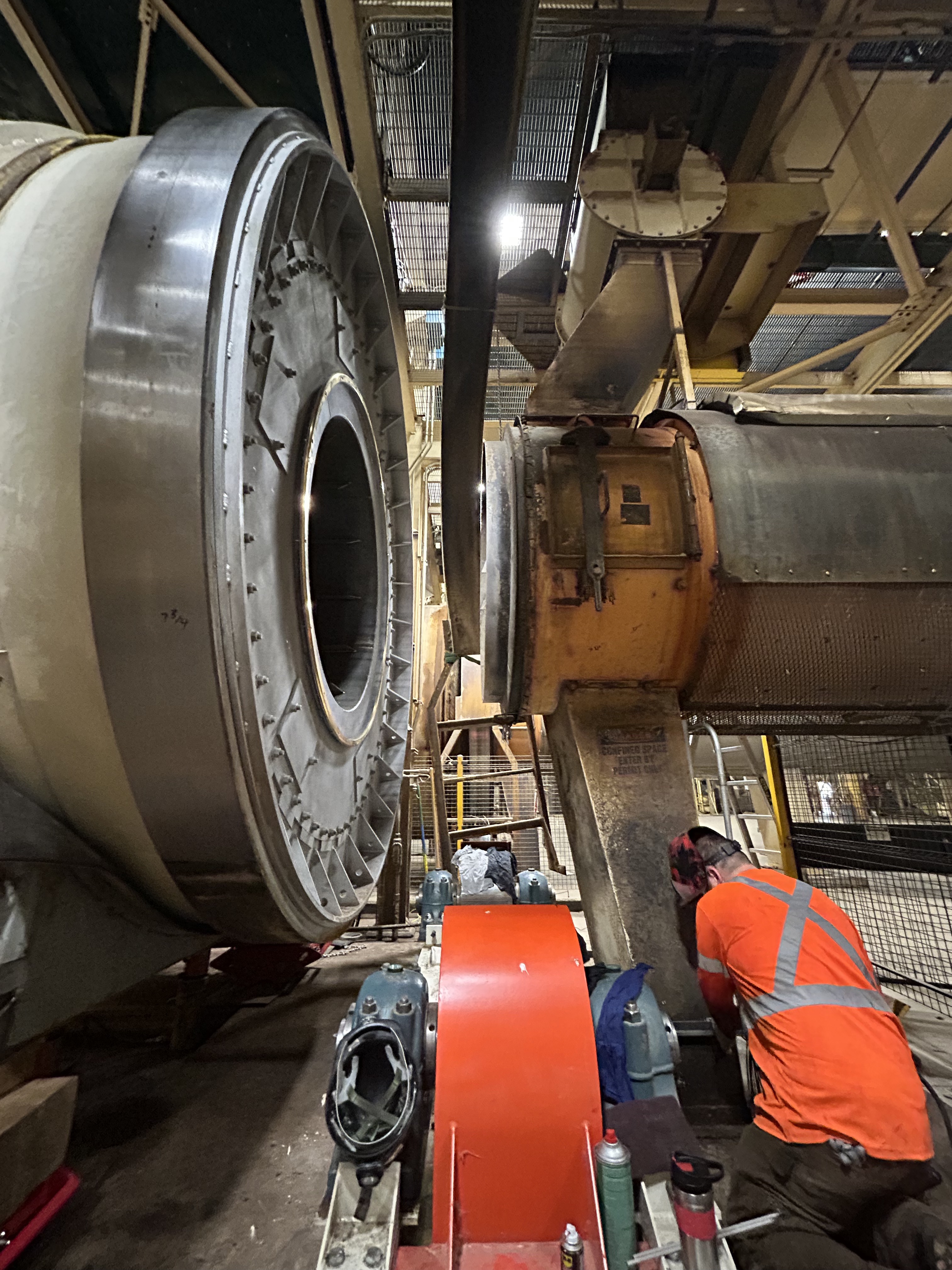

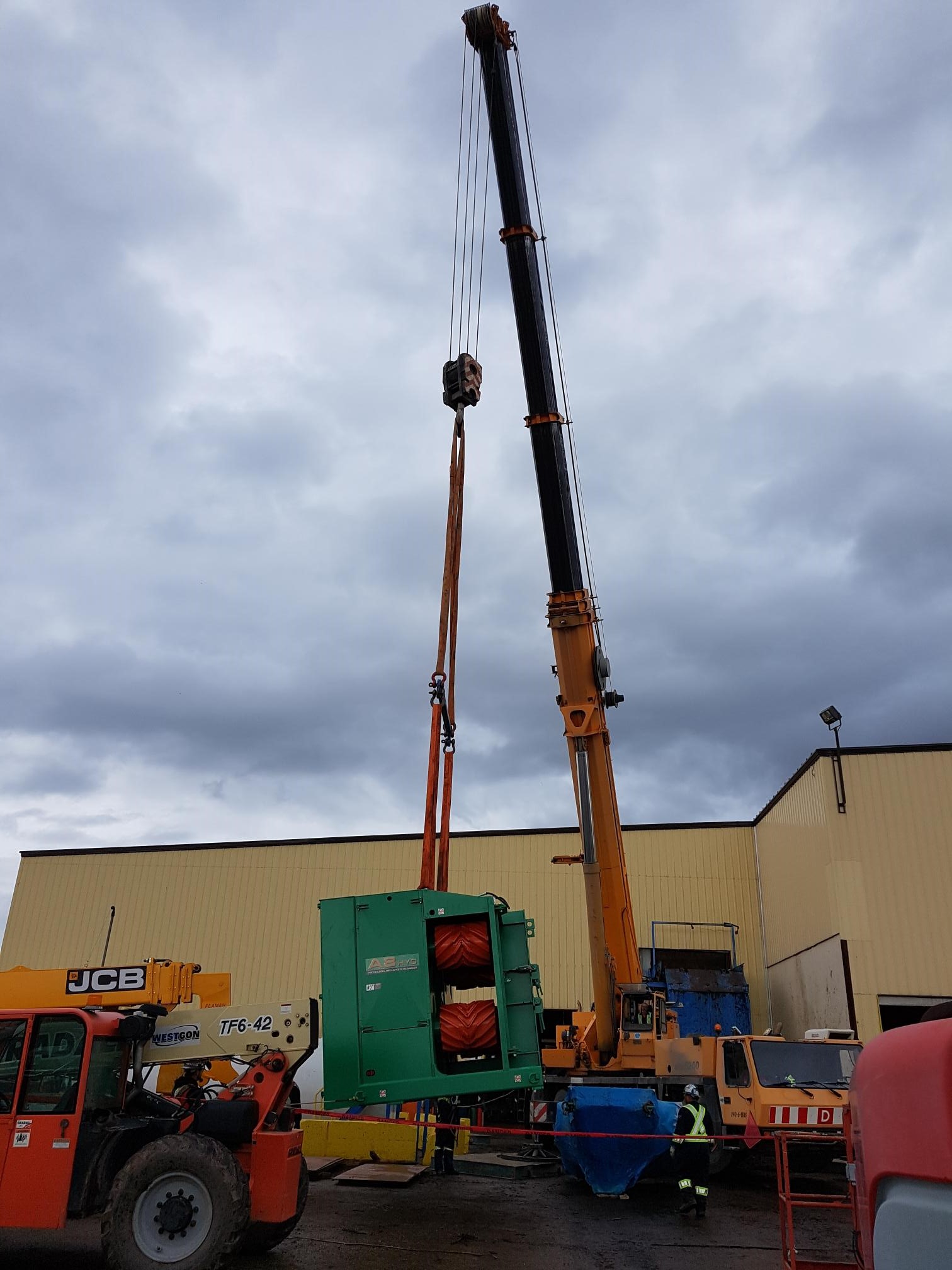

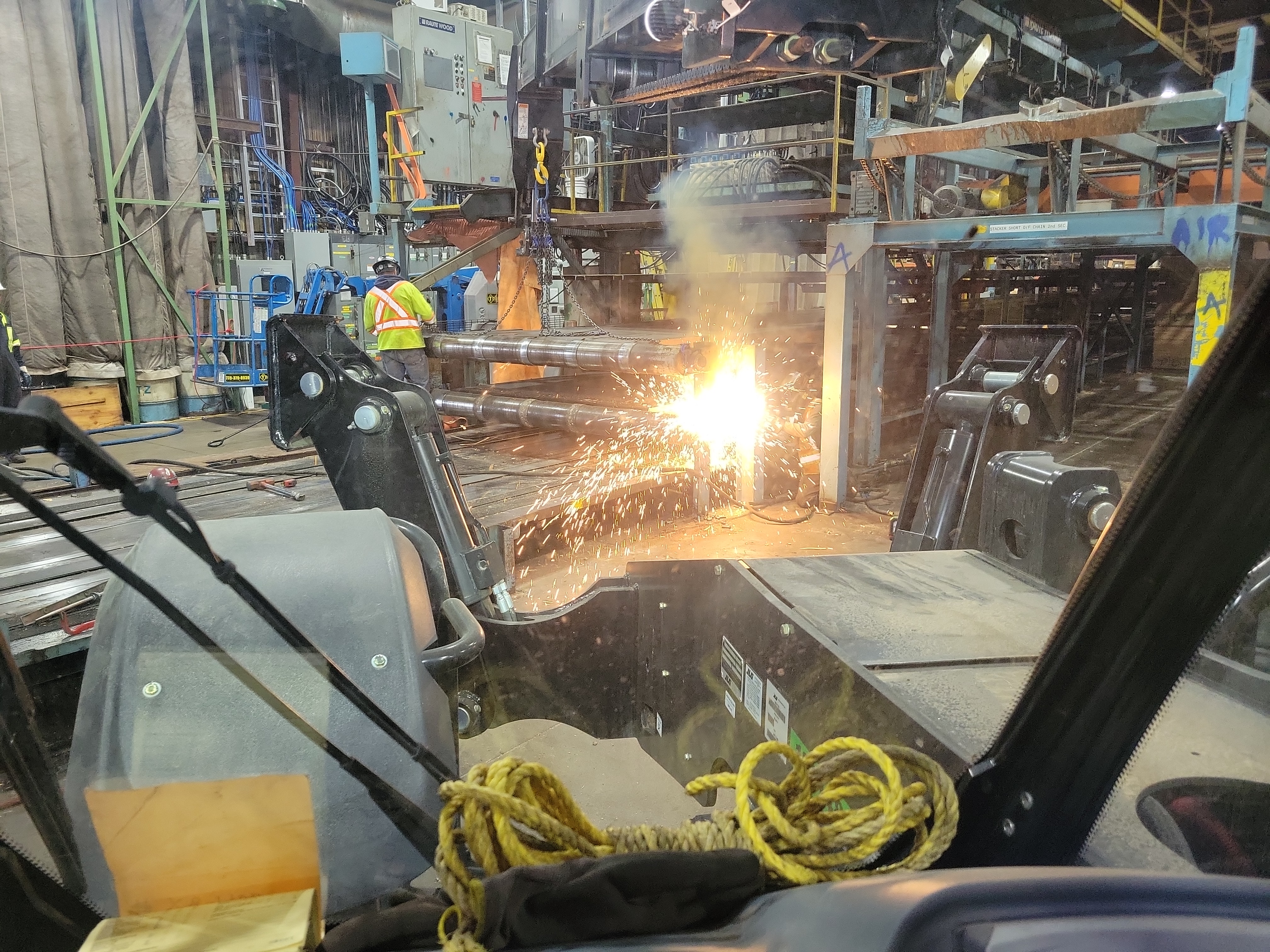

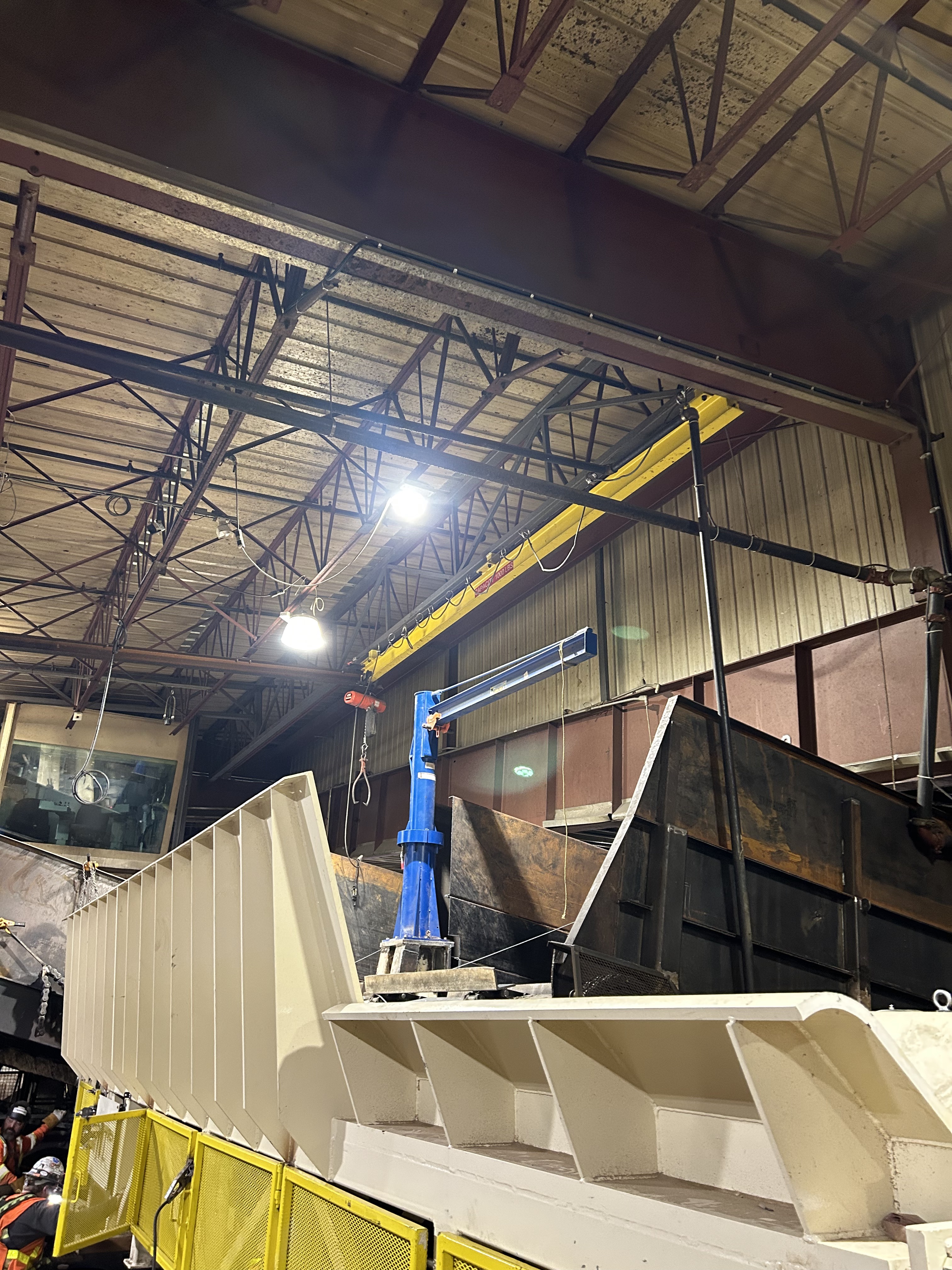

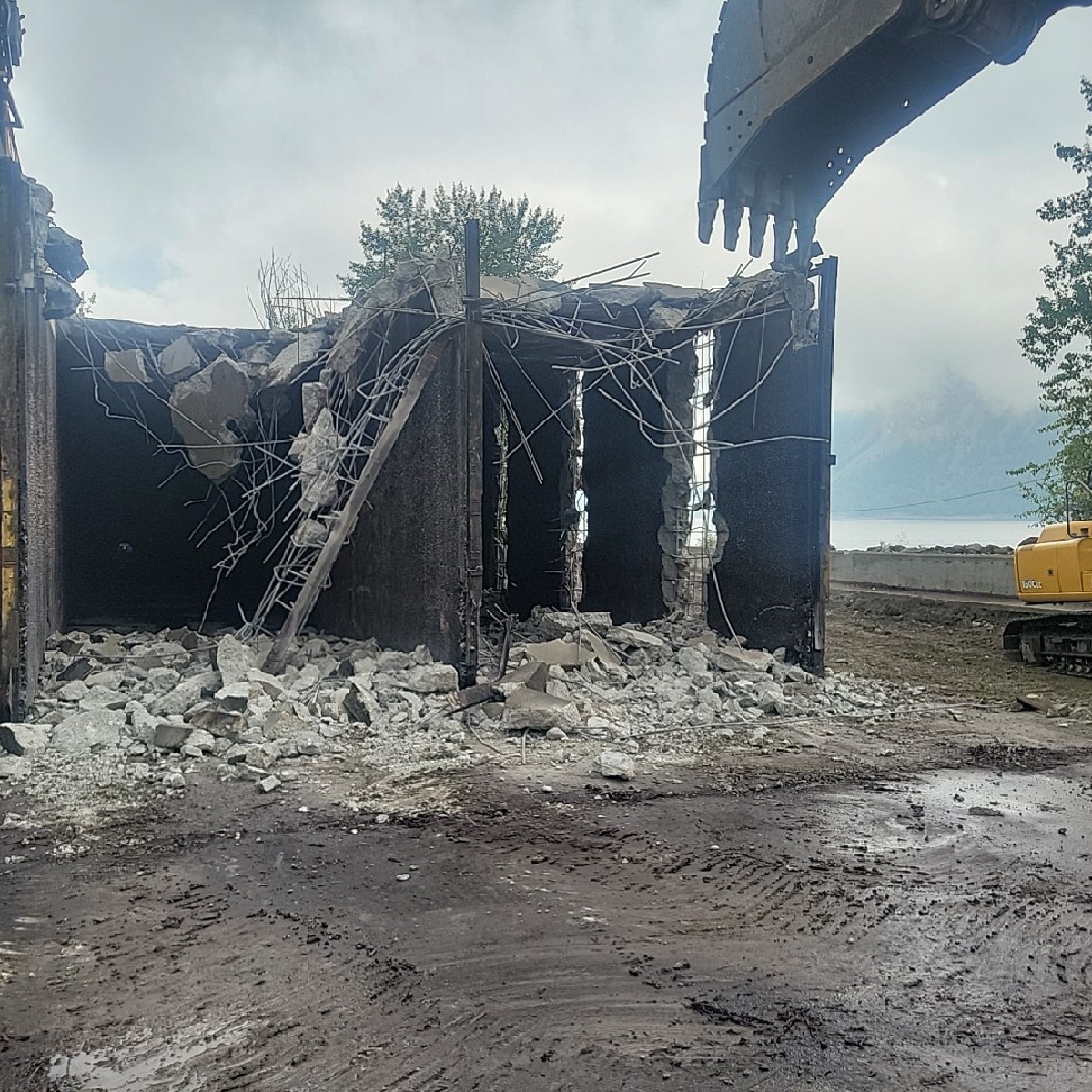

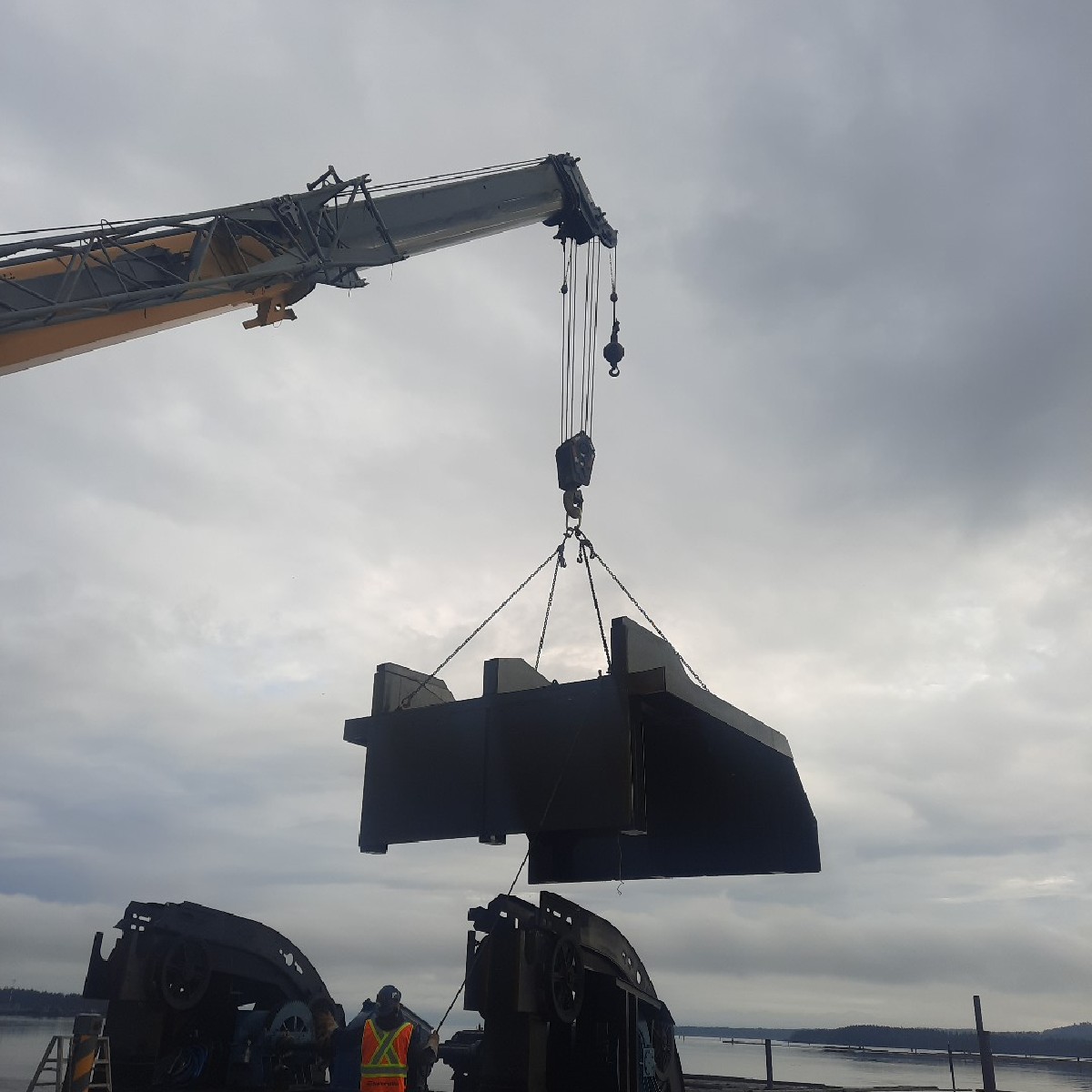

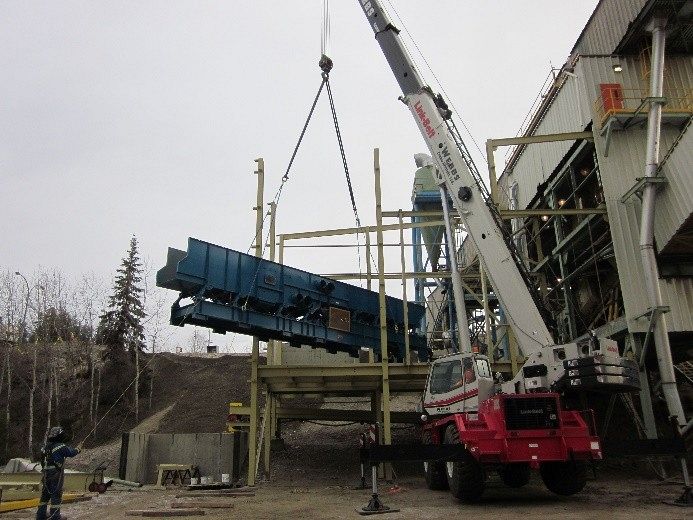

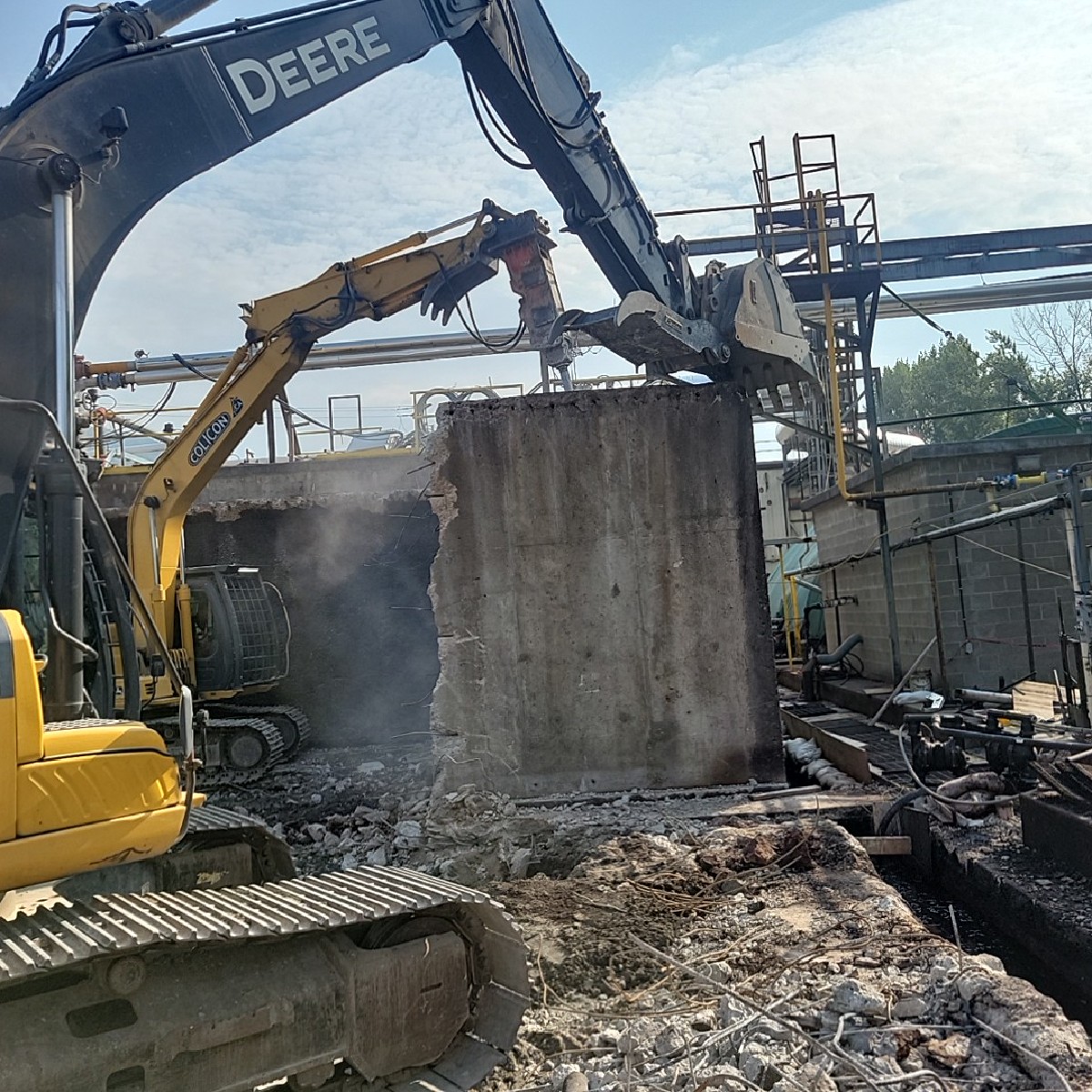

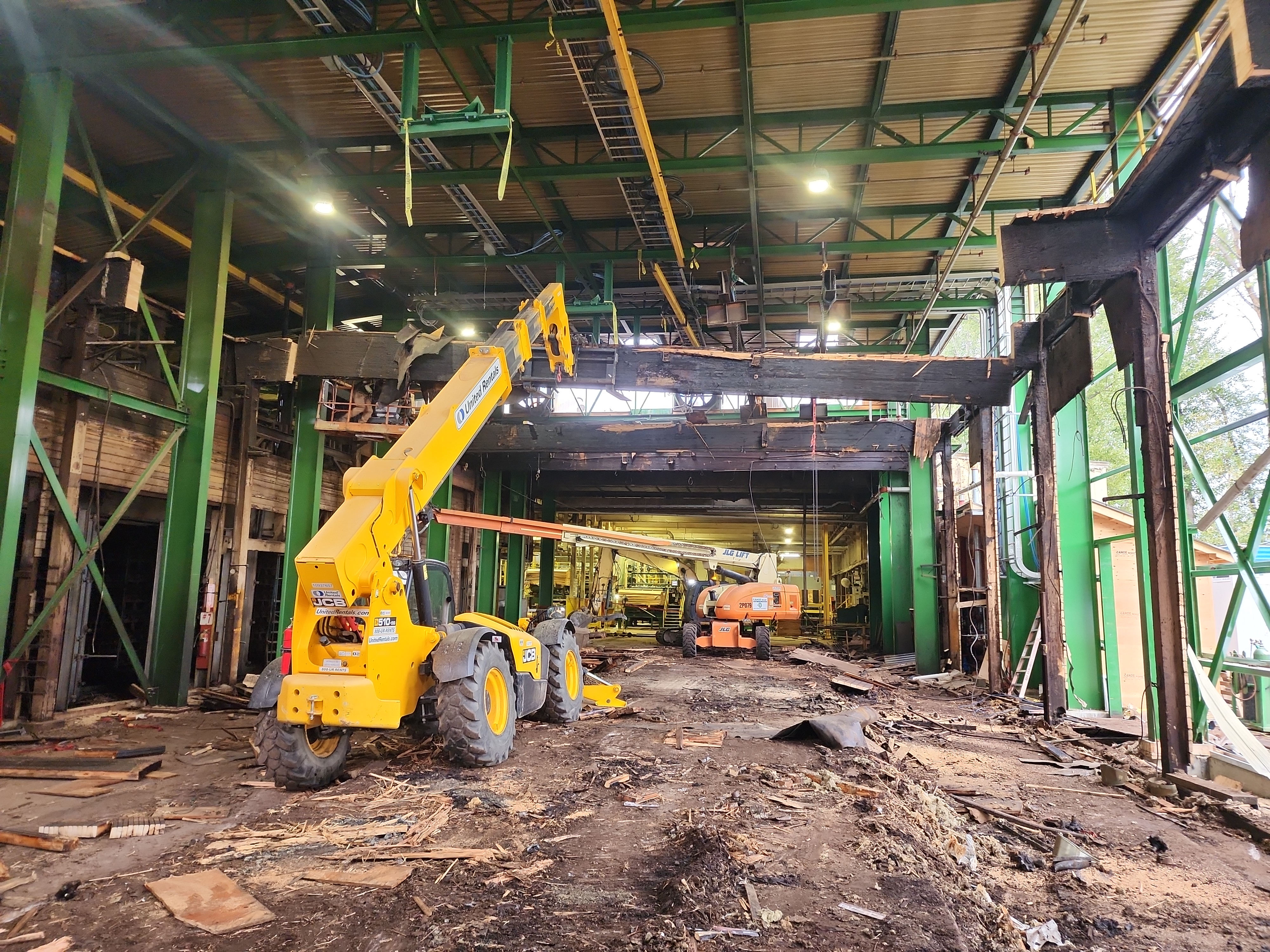

- Remove existing Debarker #2

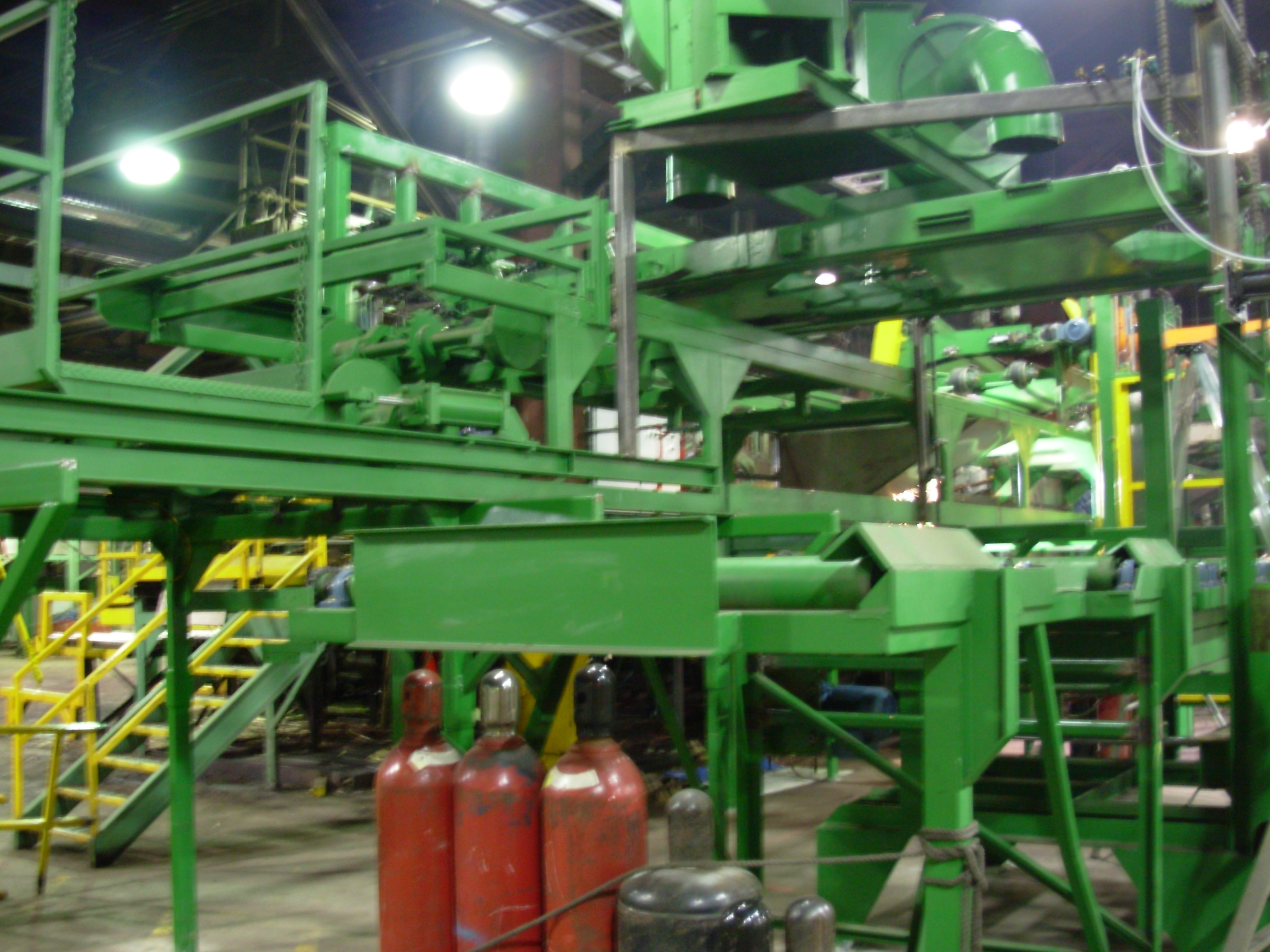

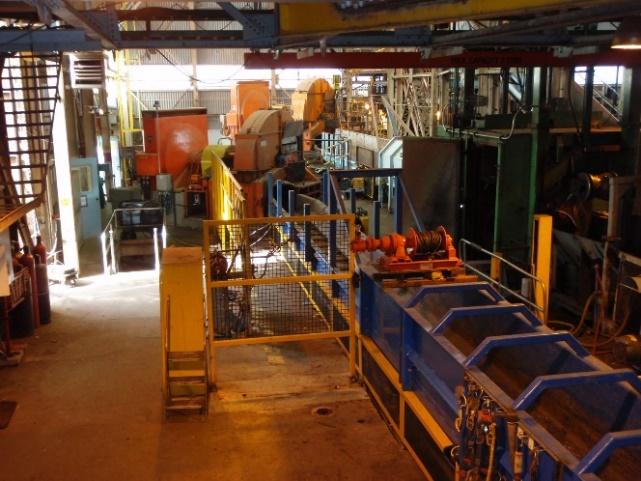

- Package and store in equipment bone yard

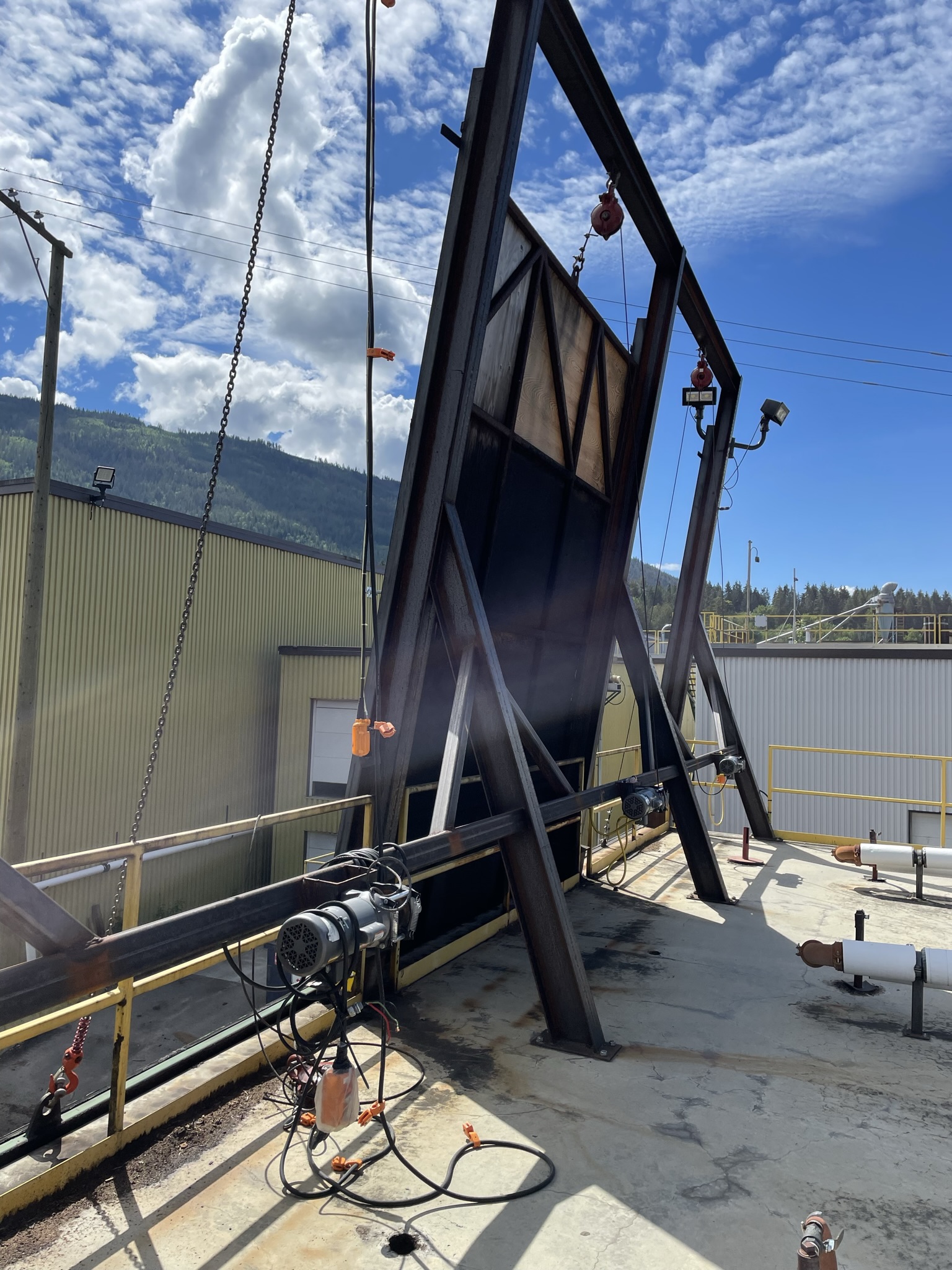

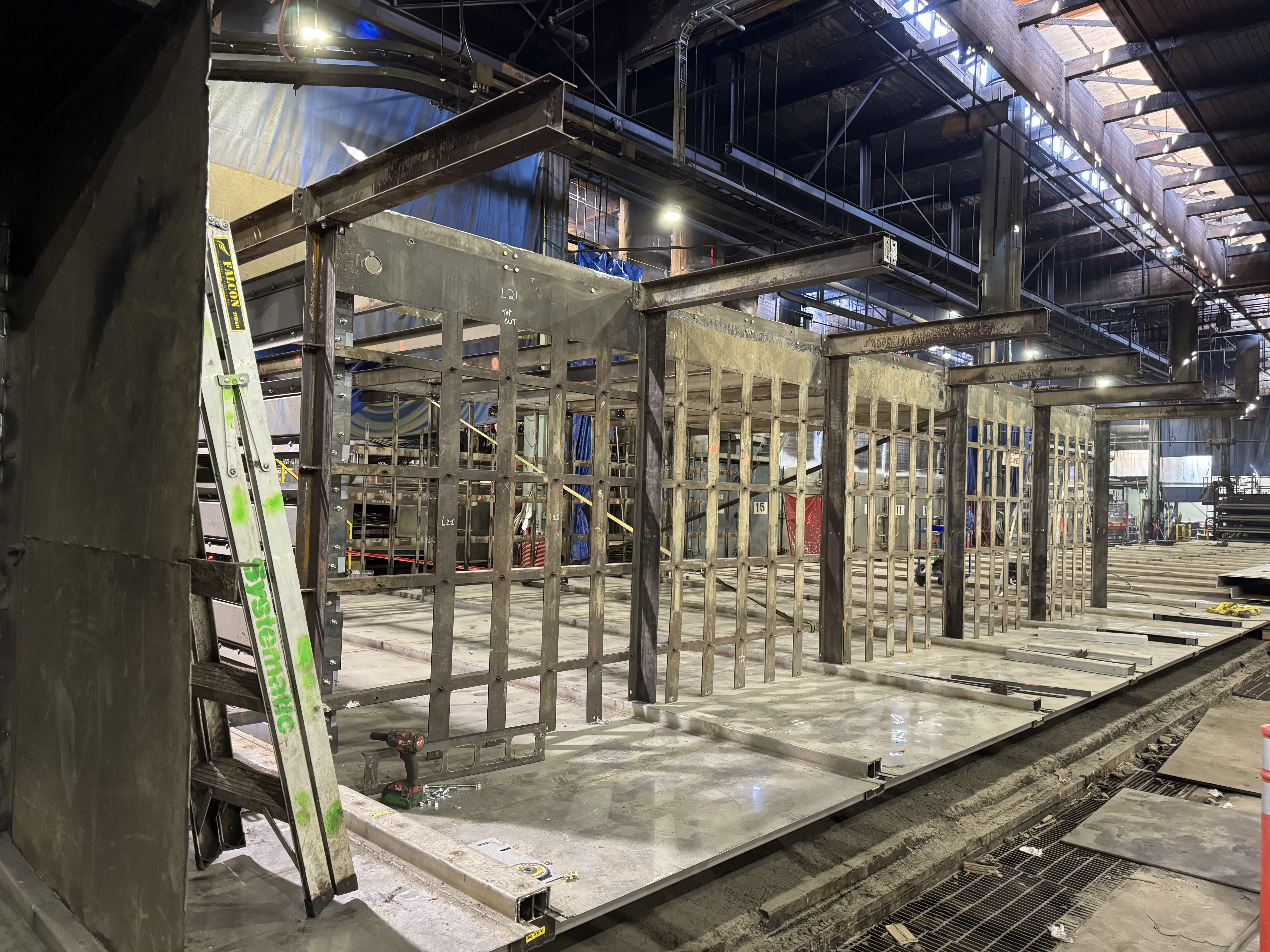

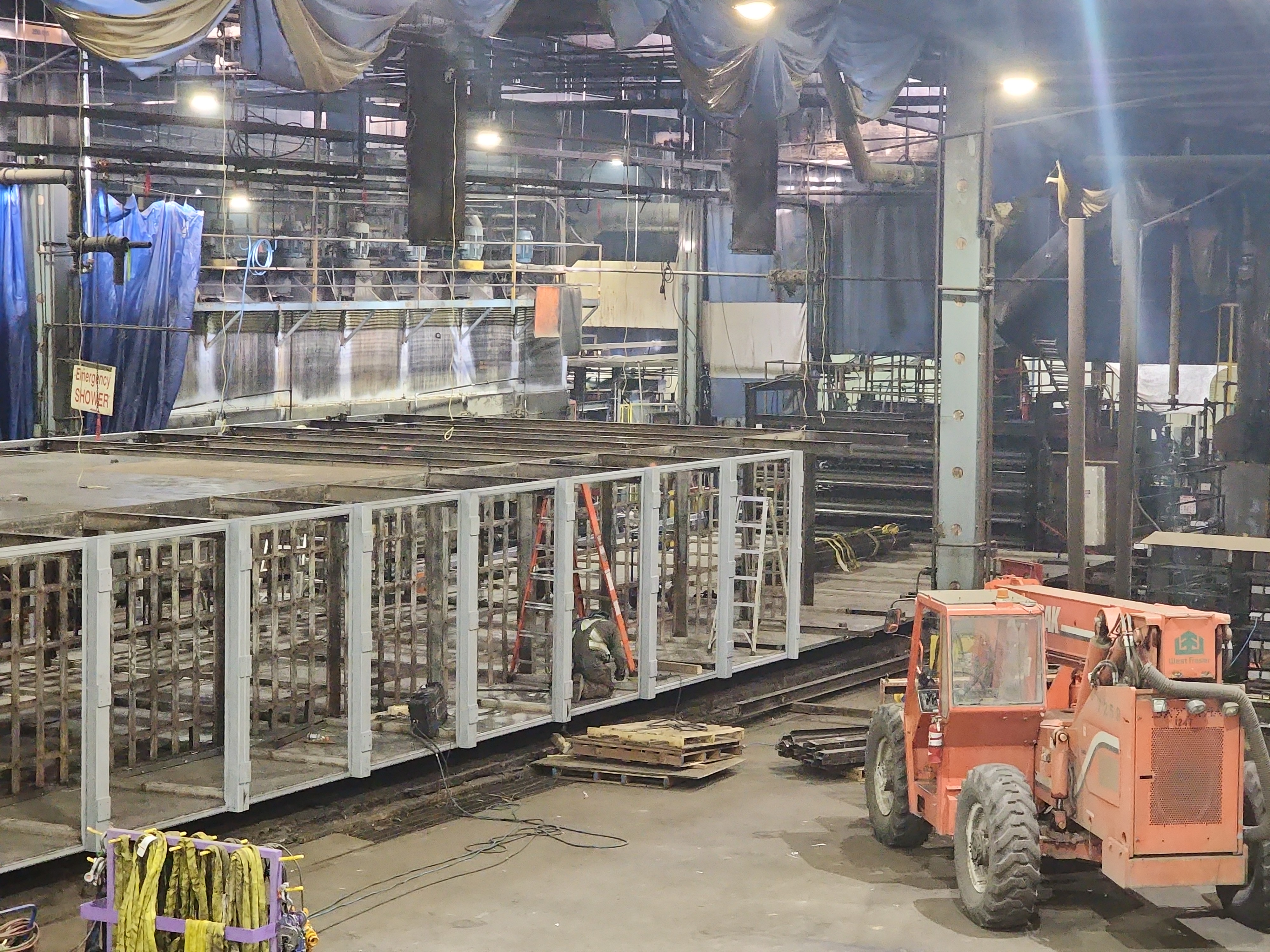

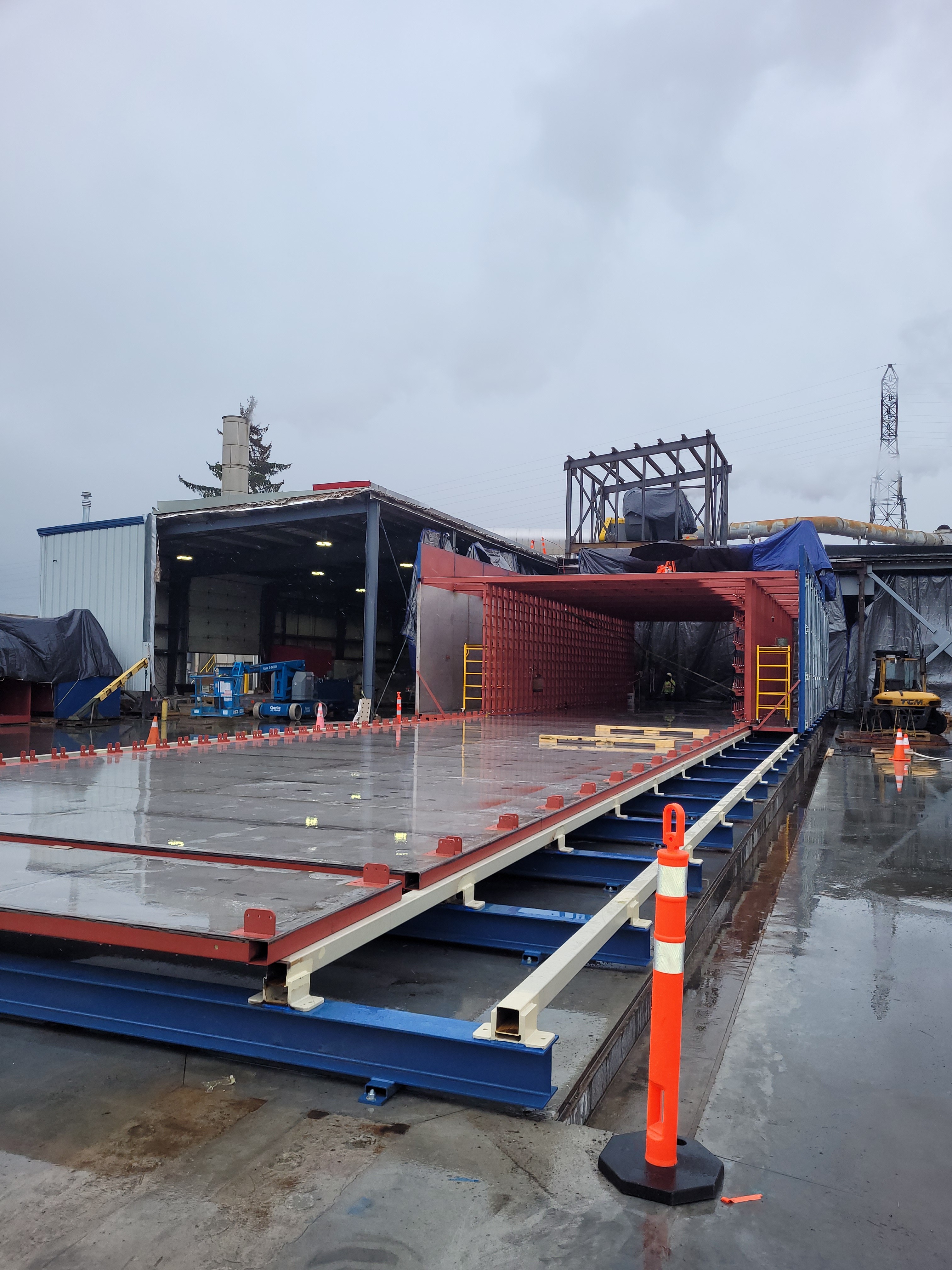

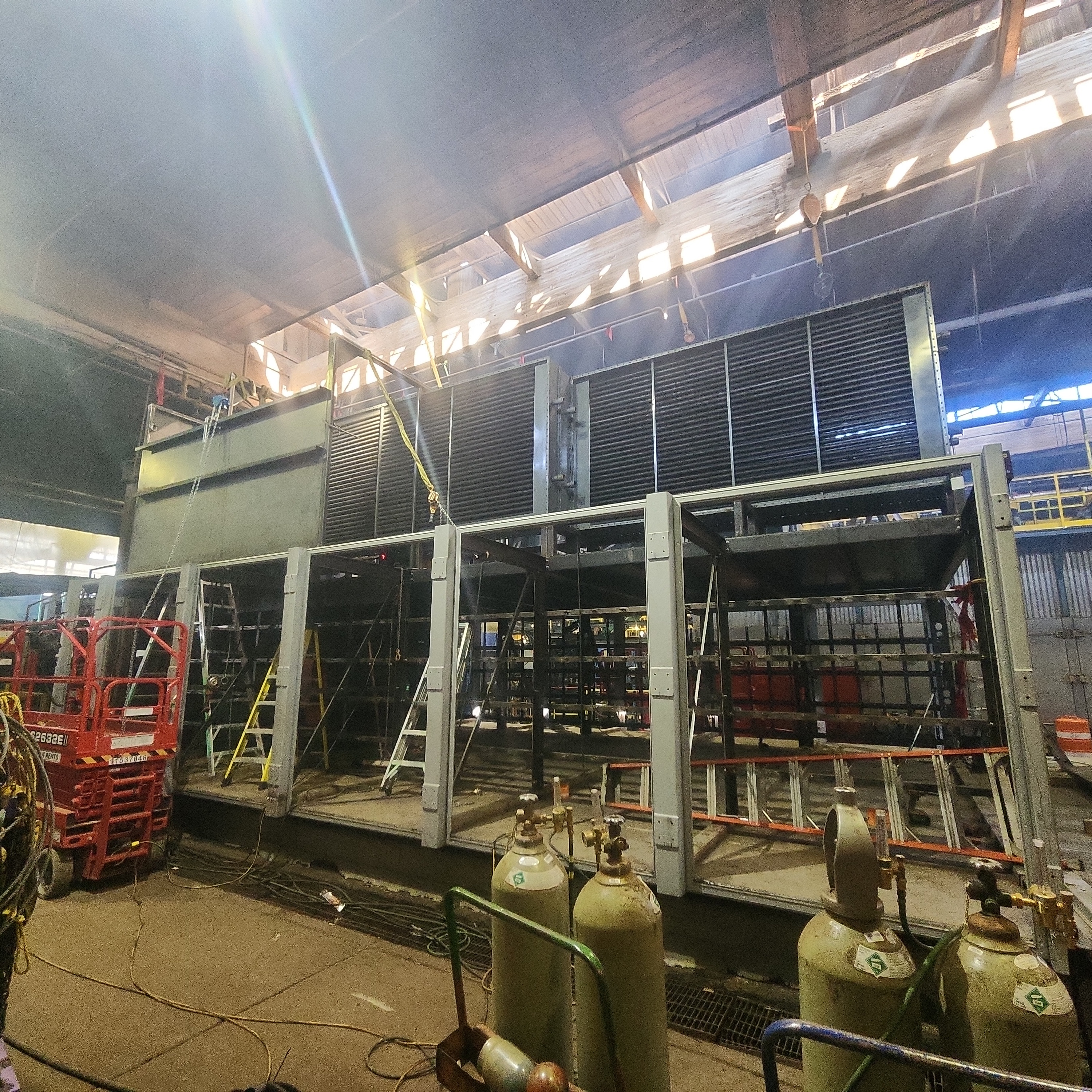

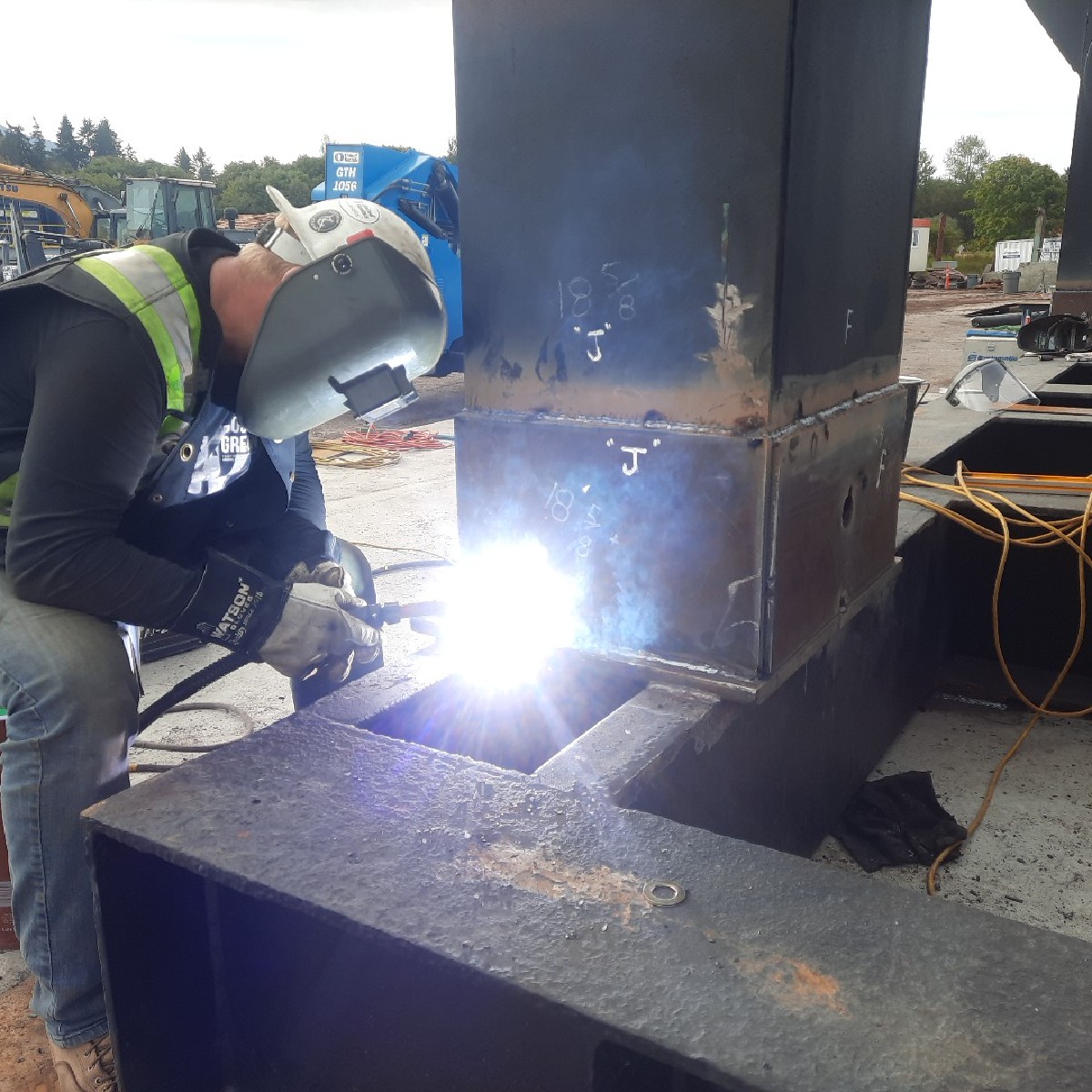

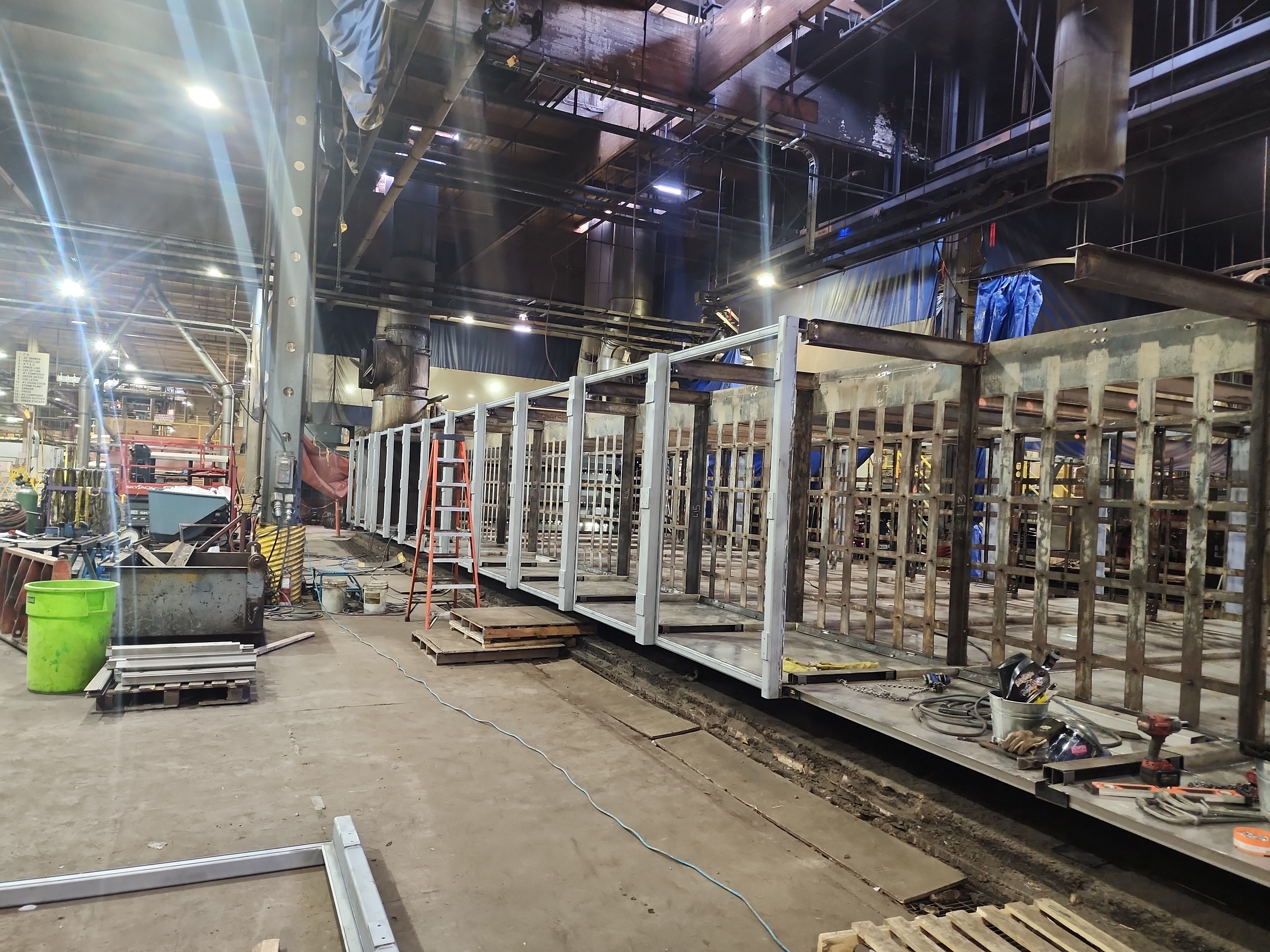

Modify and Repair Debarker Support Structure:

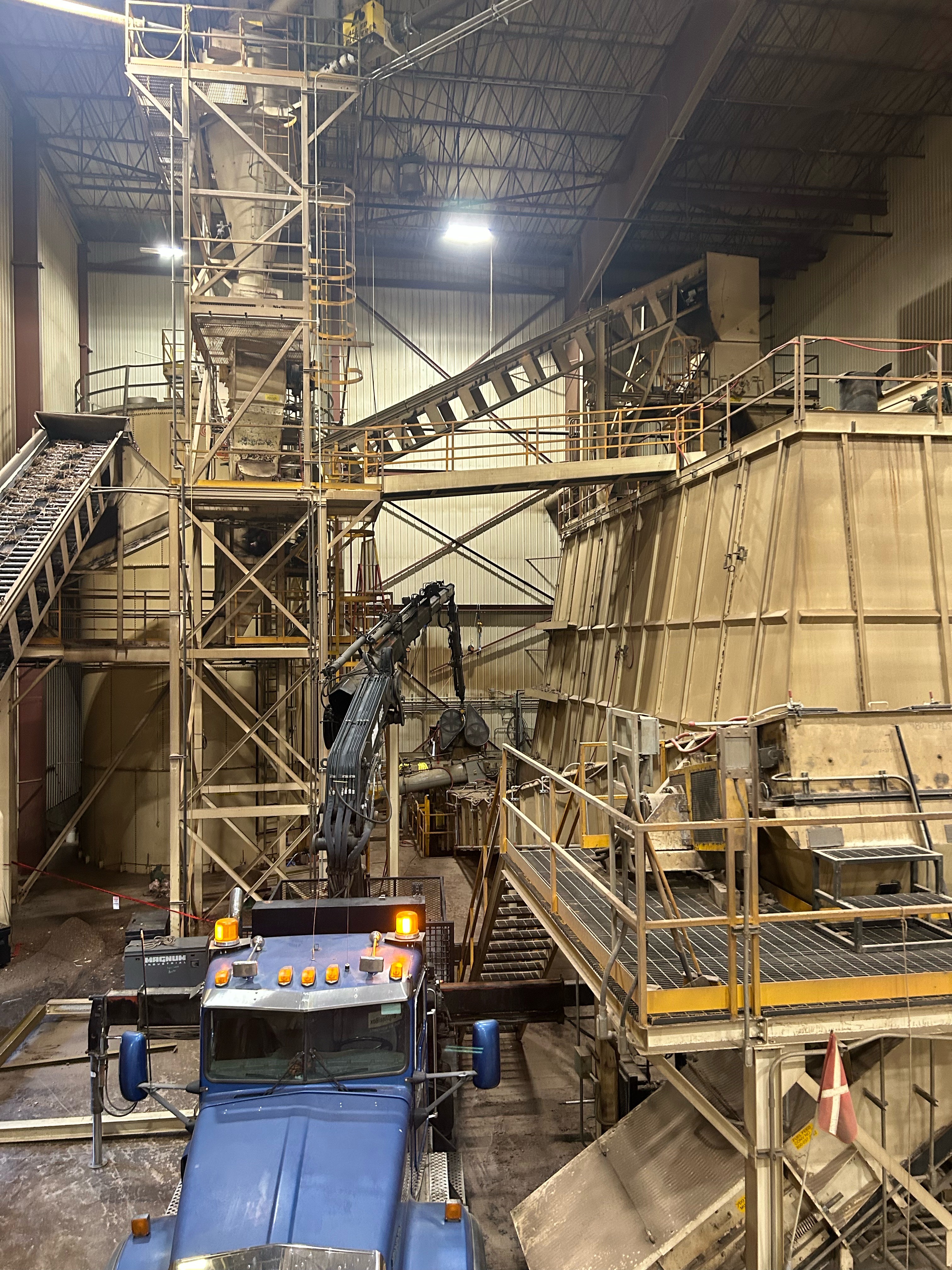

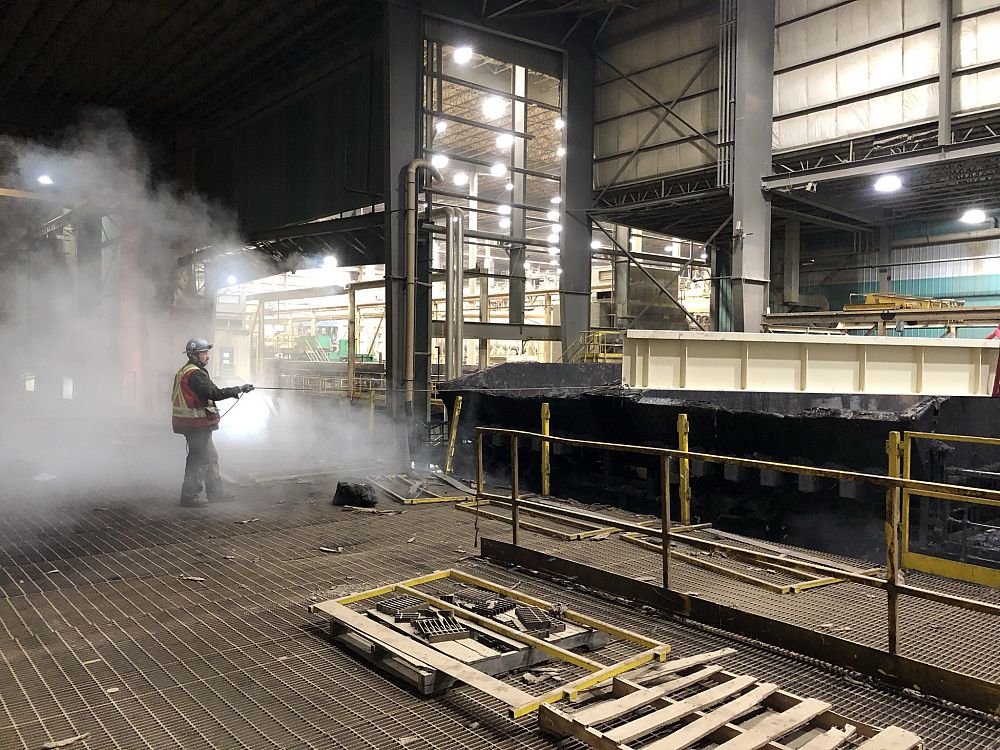

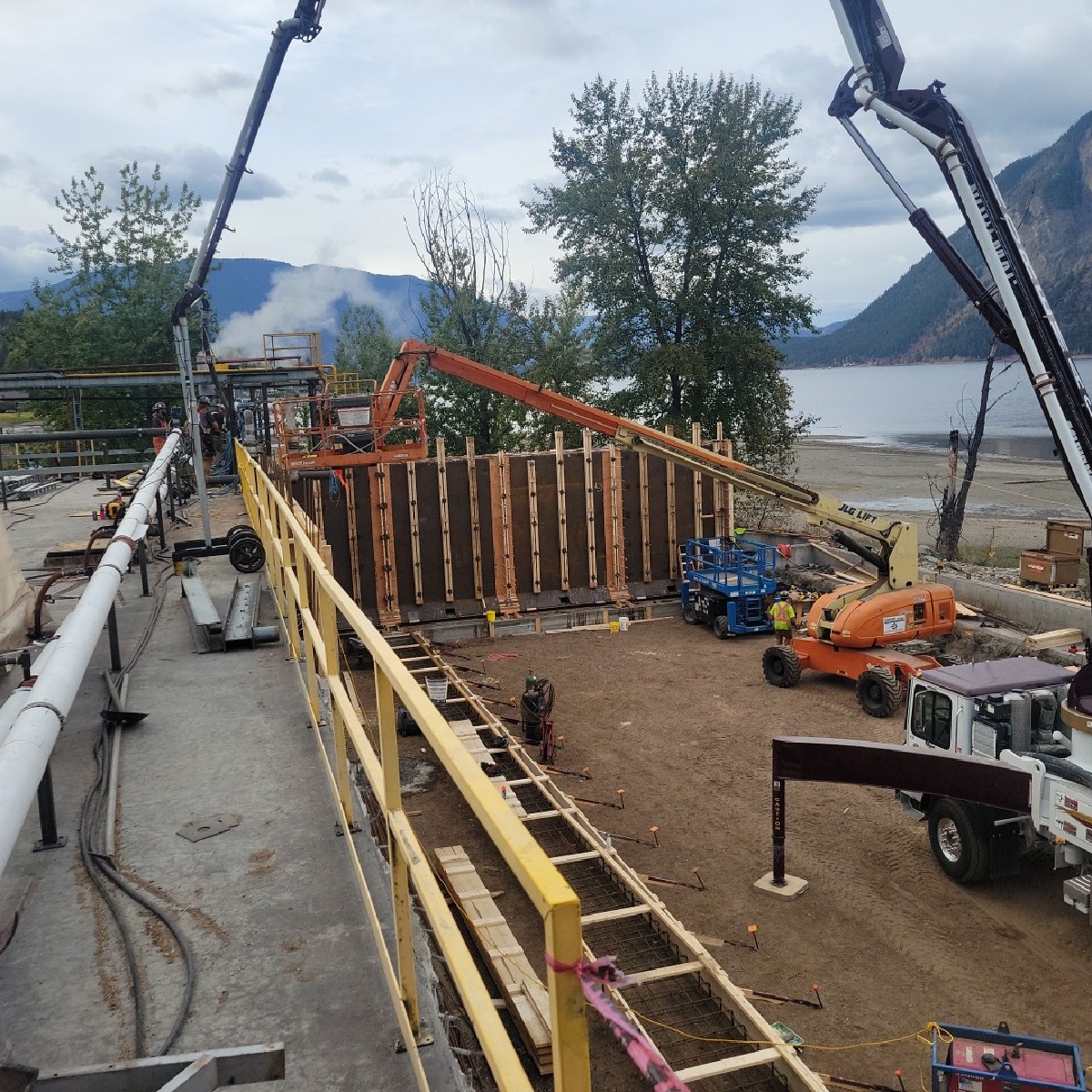

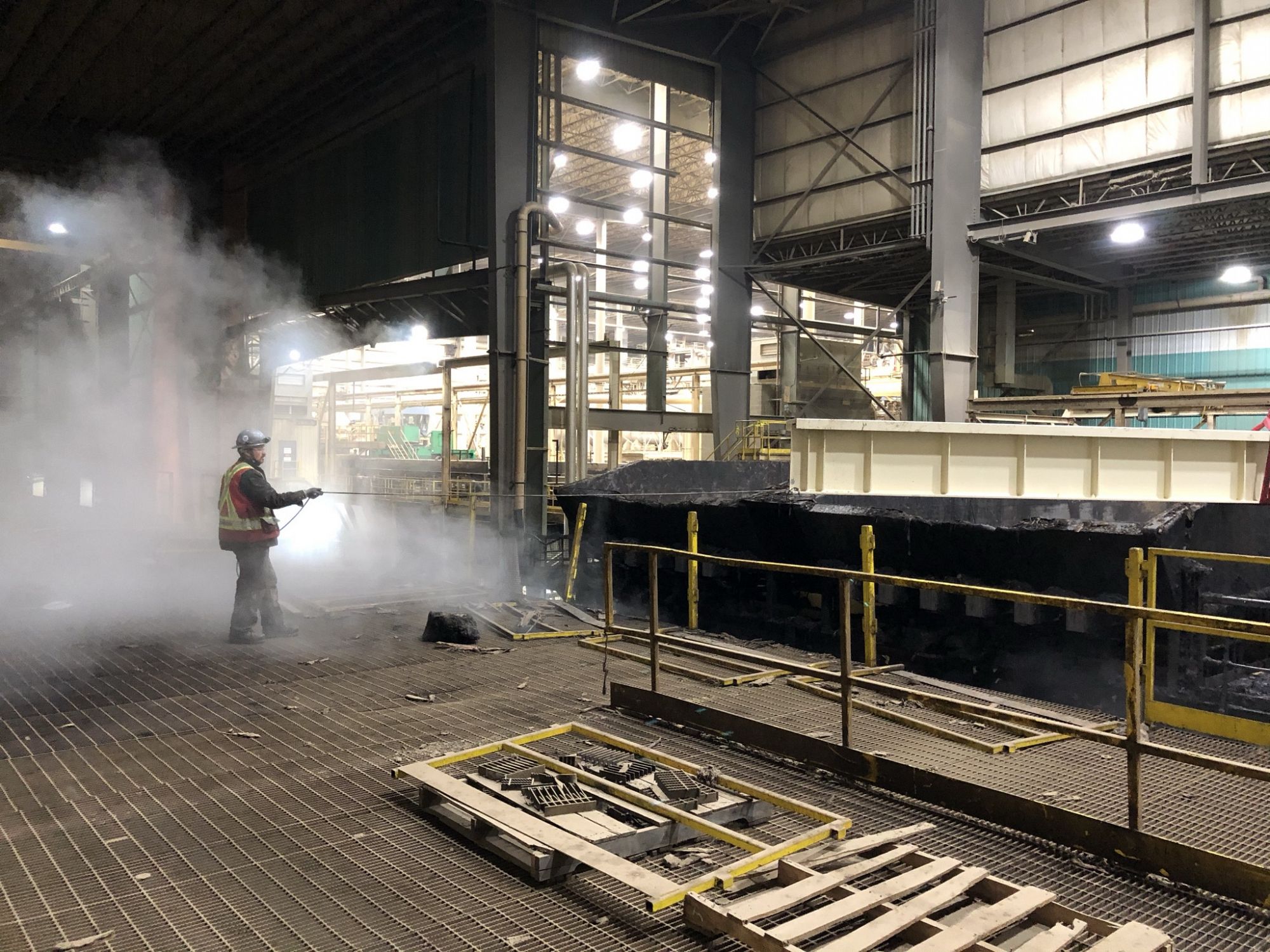

- Clean and asses structural frame/components

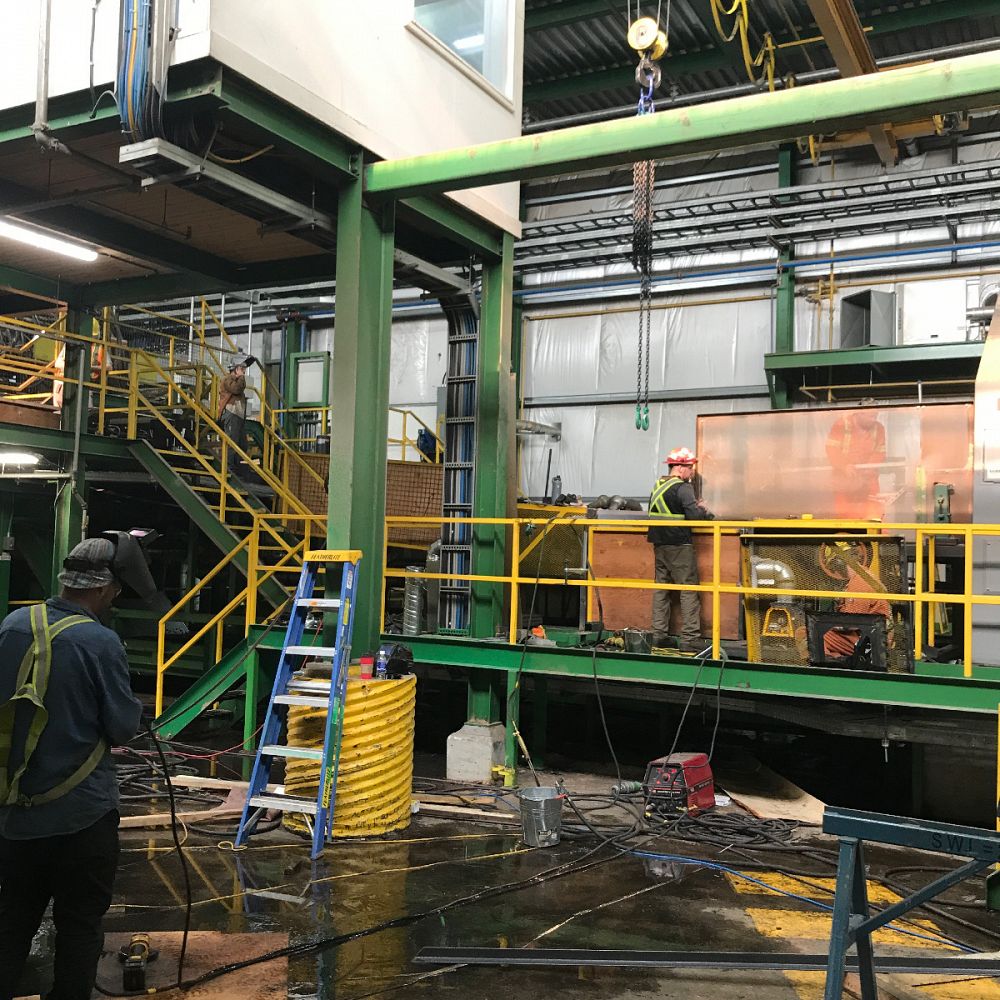

- Modify and repair frame

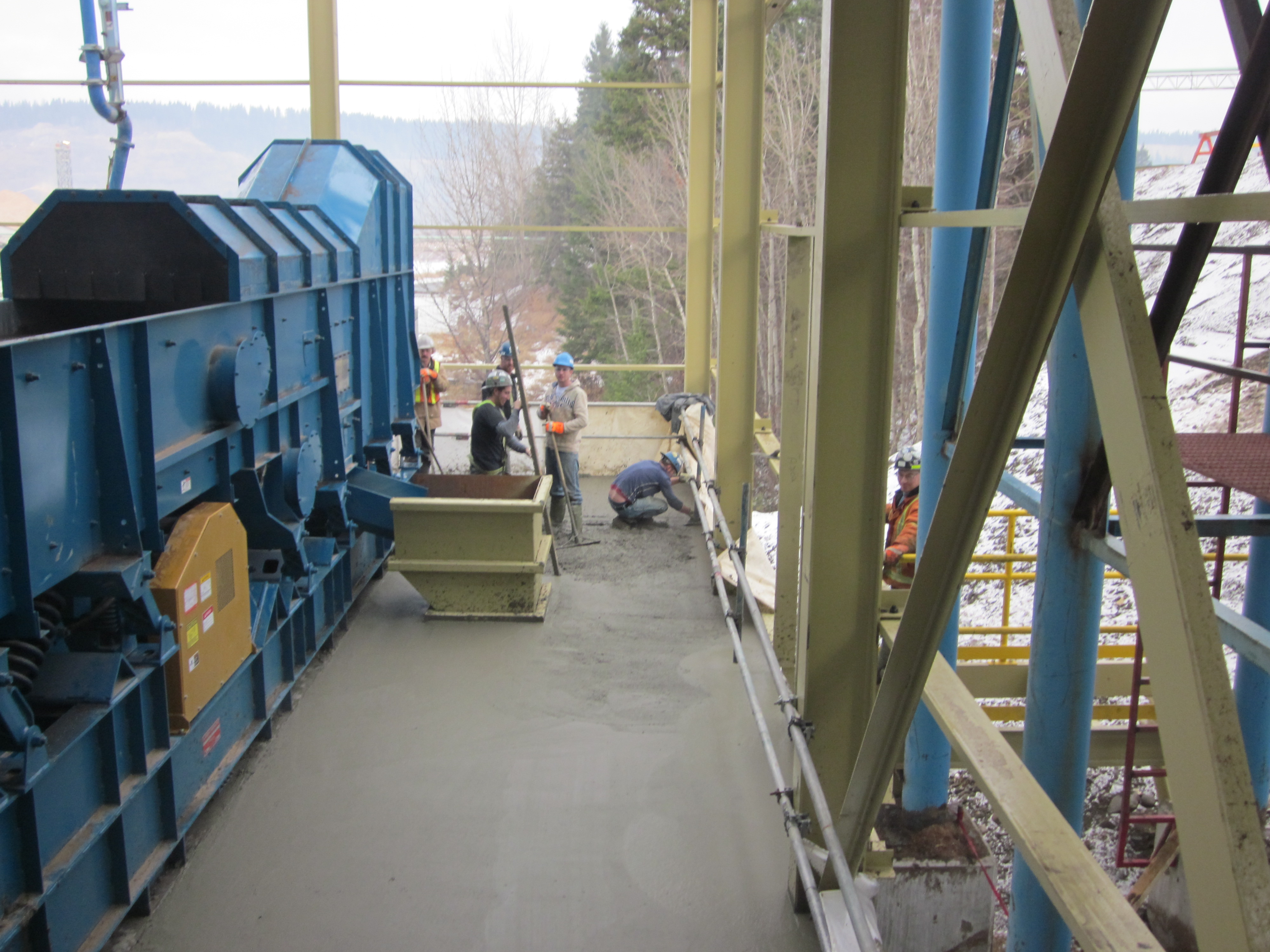

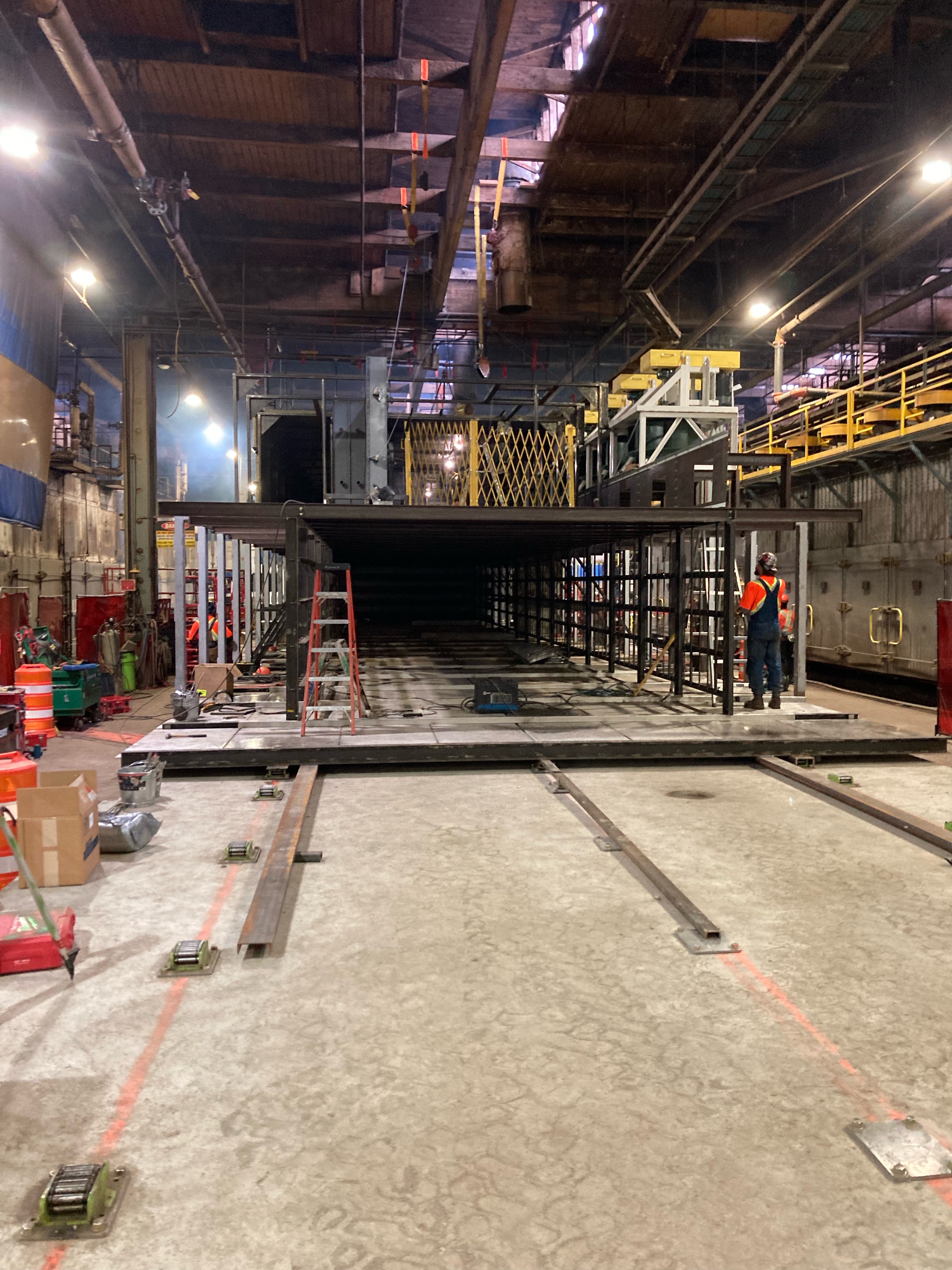

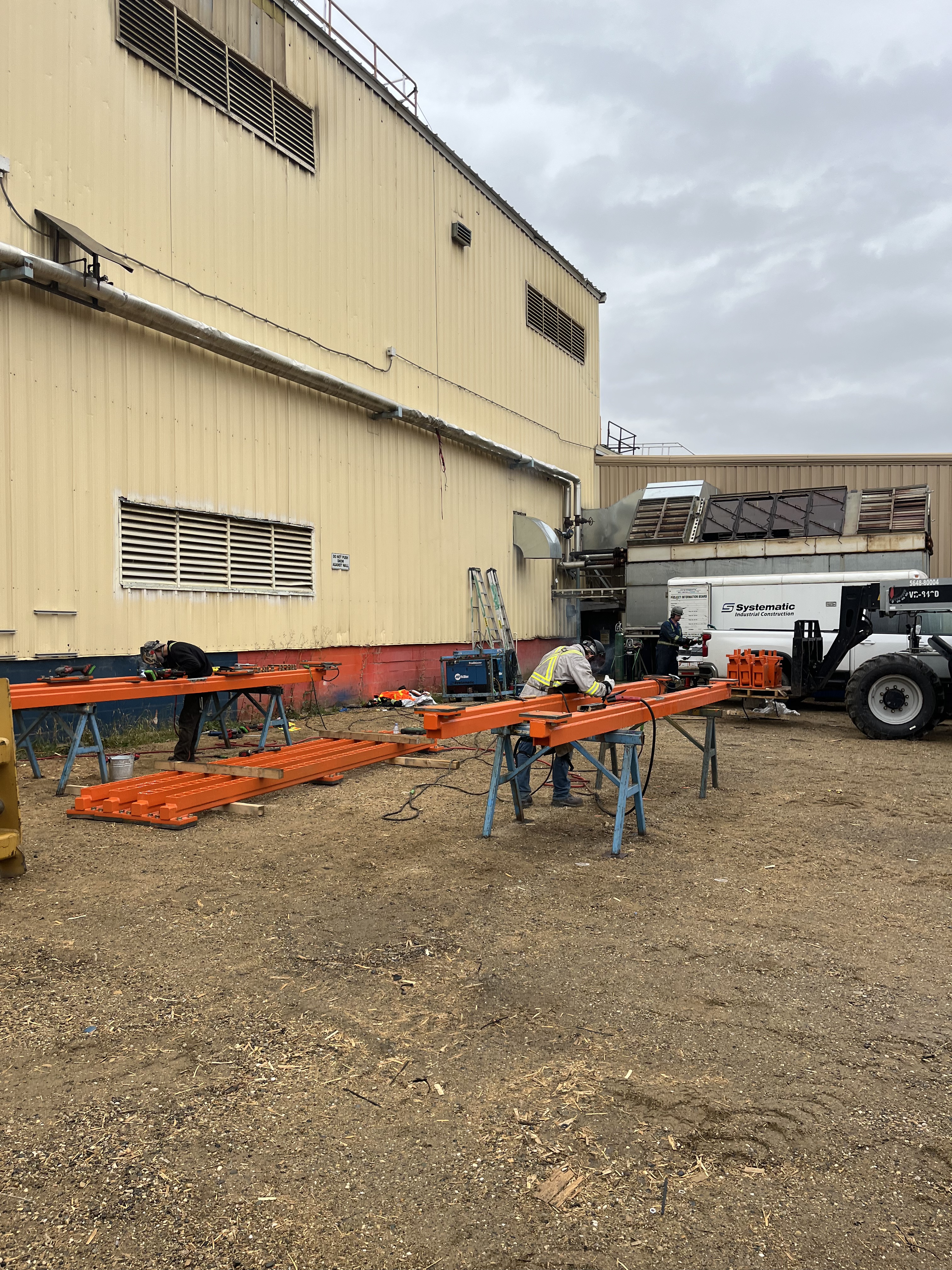

- Install additional chute plating

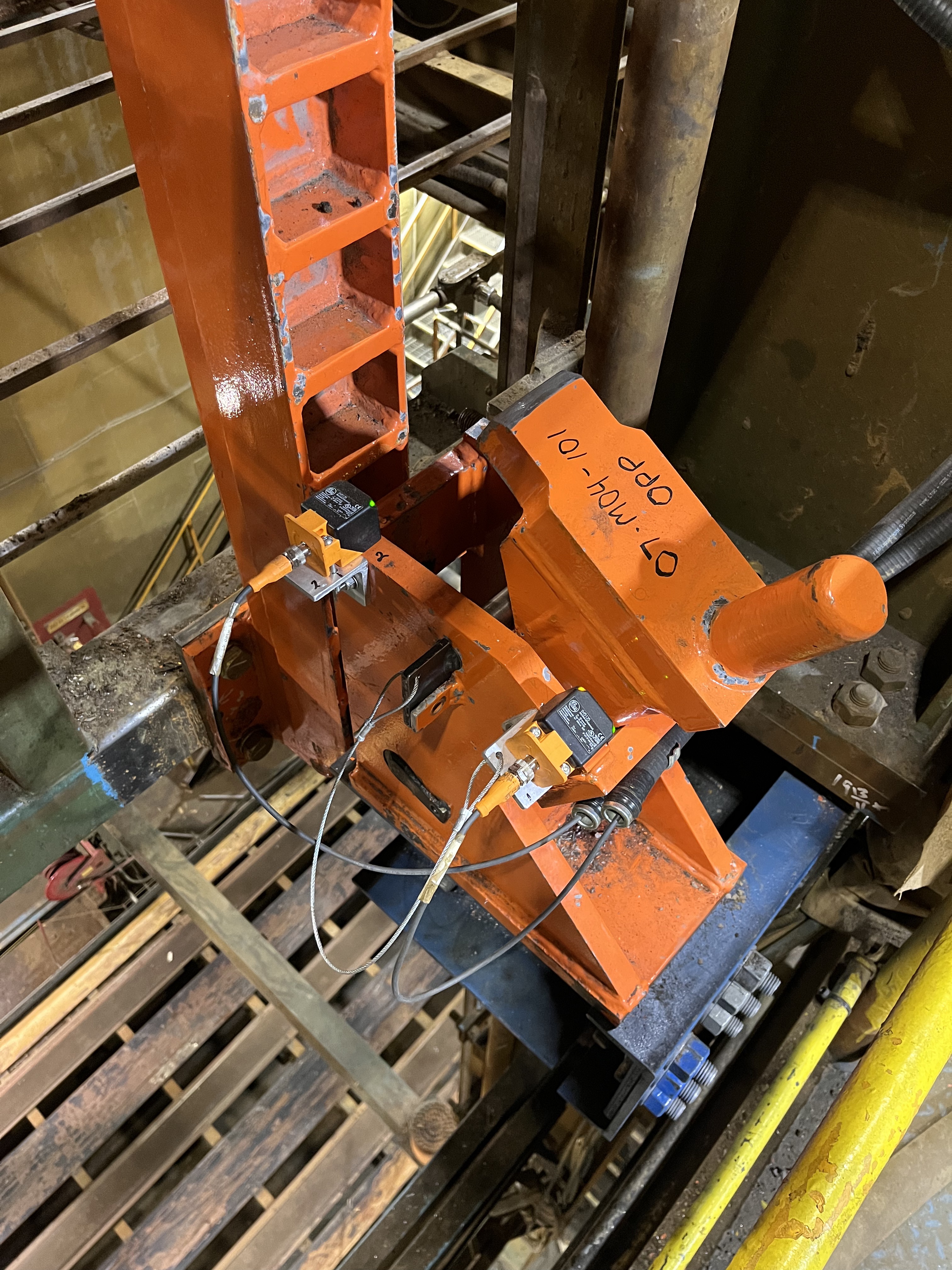

- Replace ring pullout support column

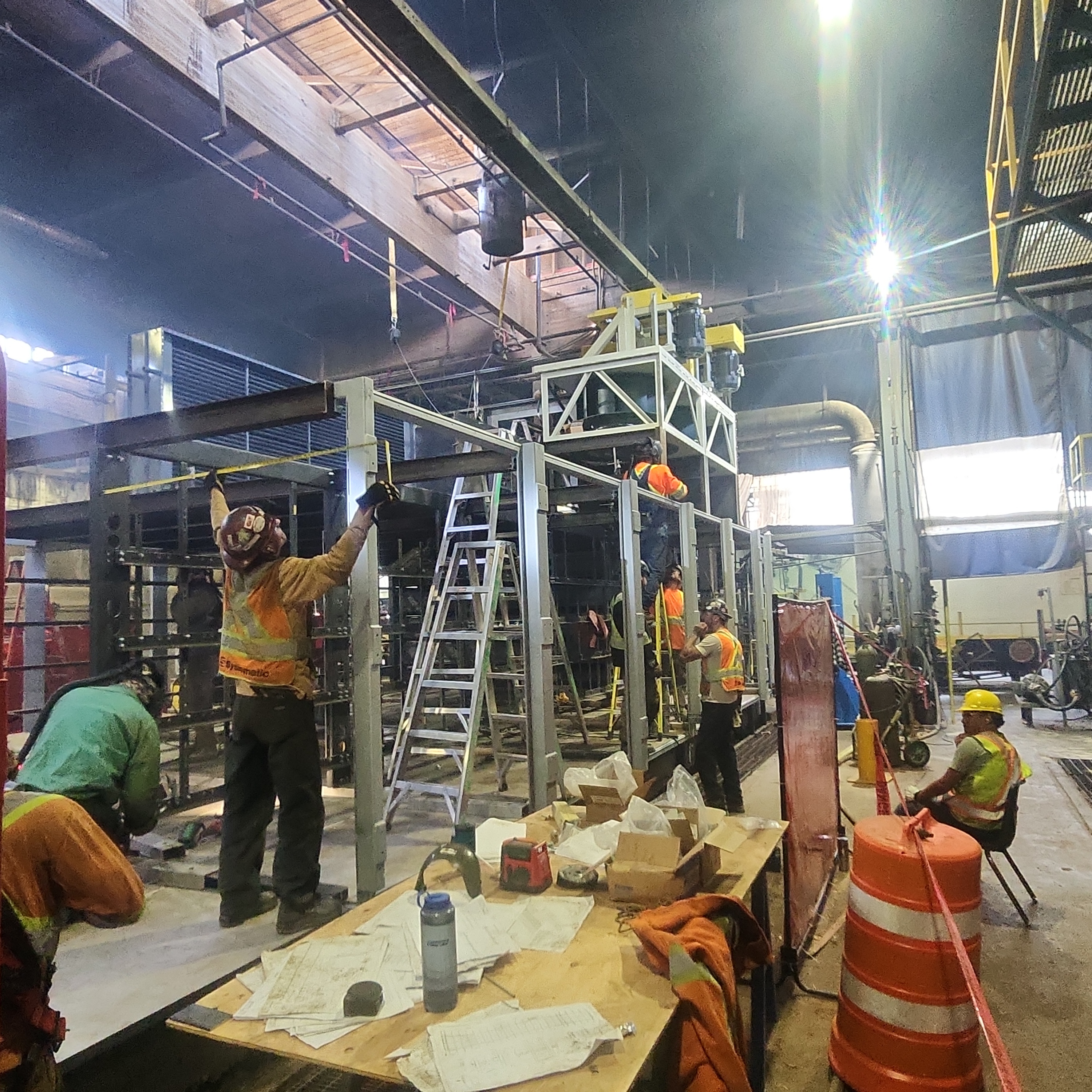

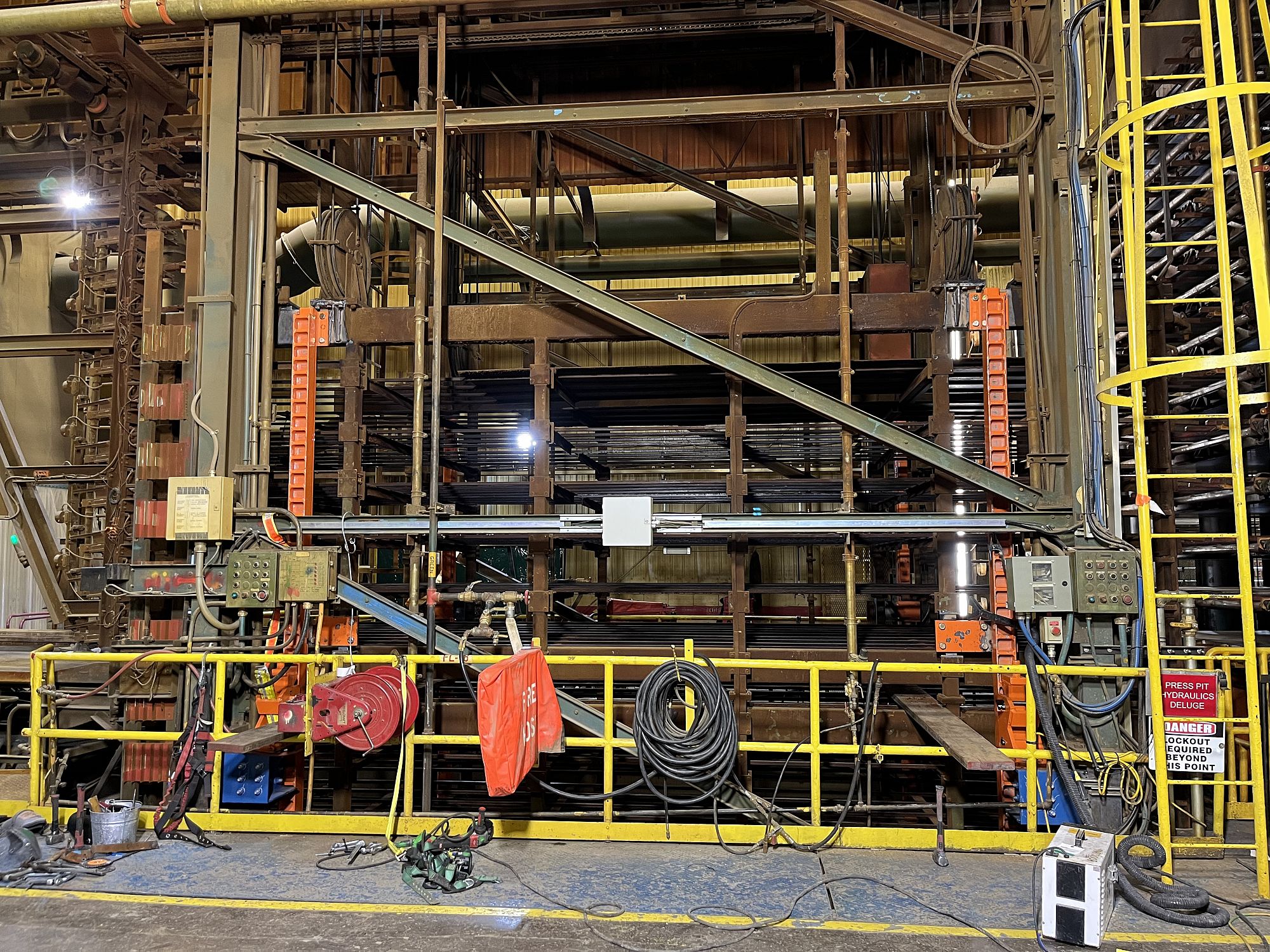

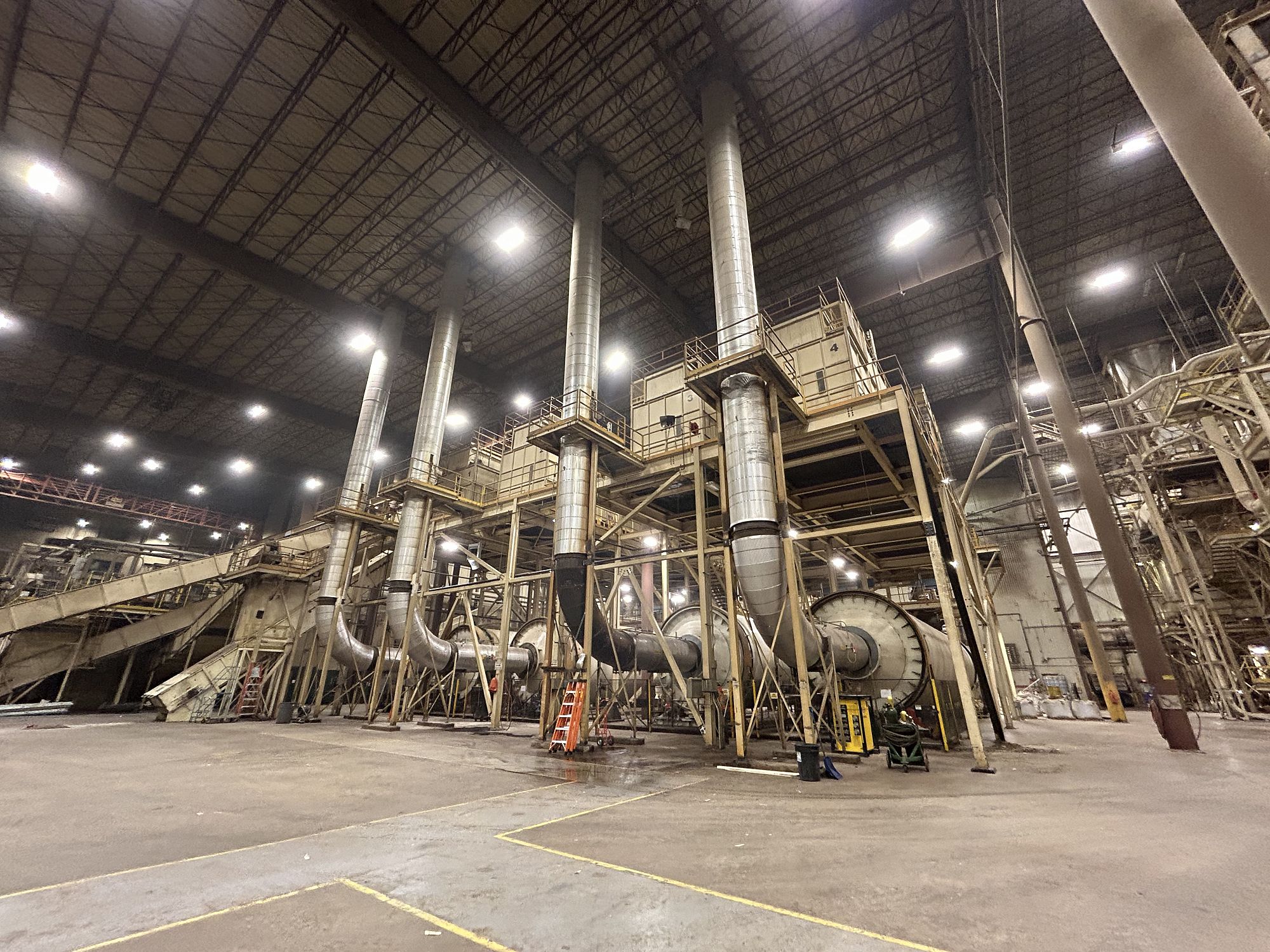

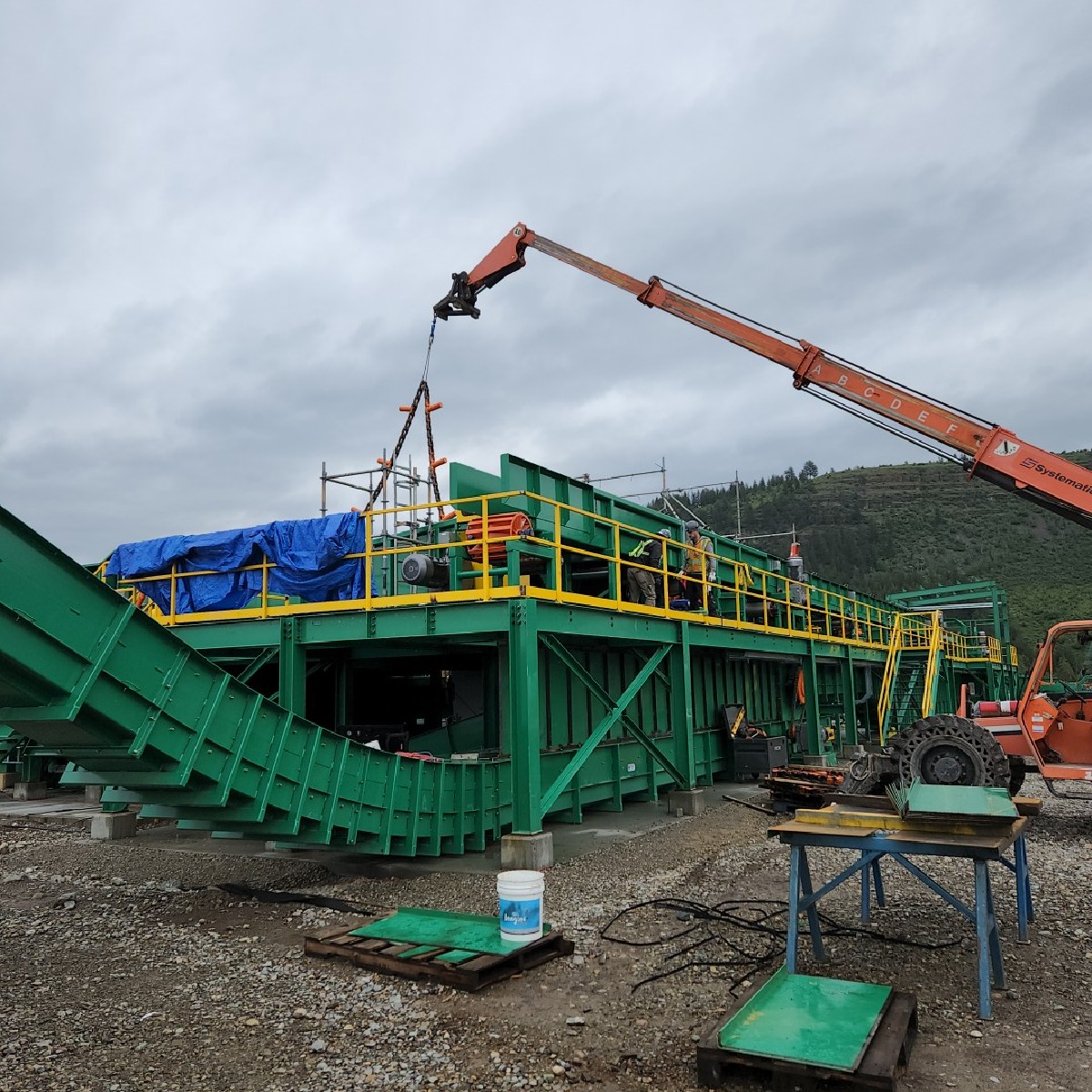

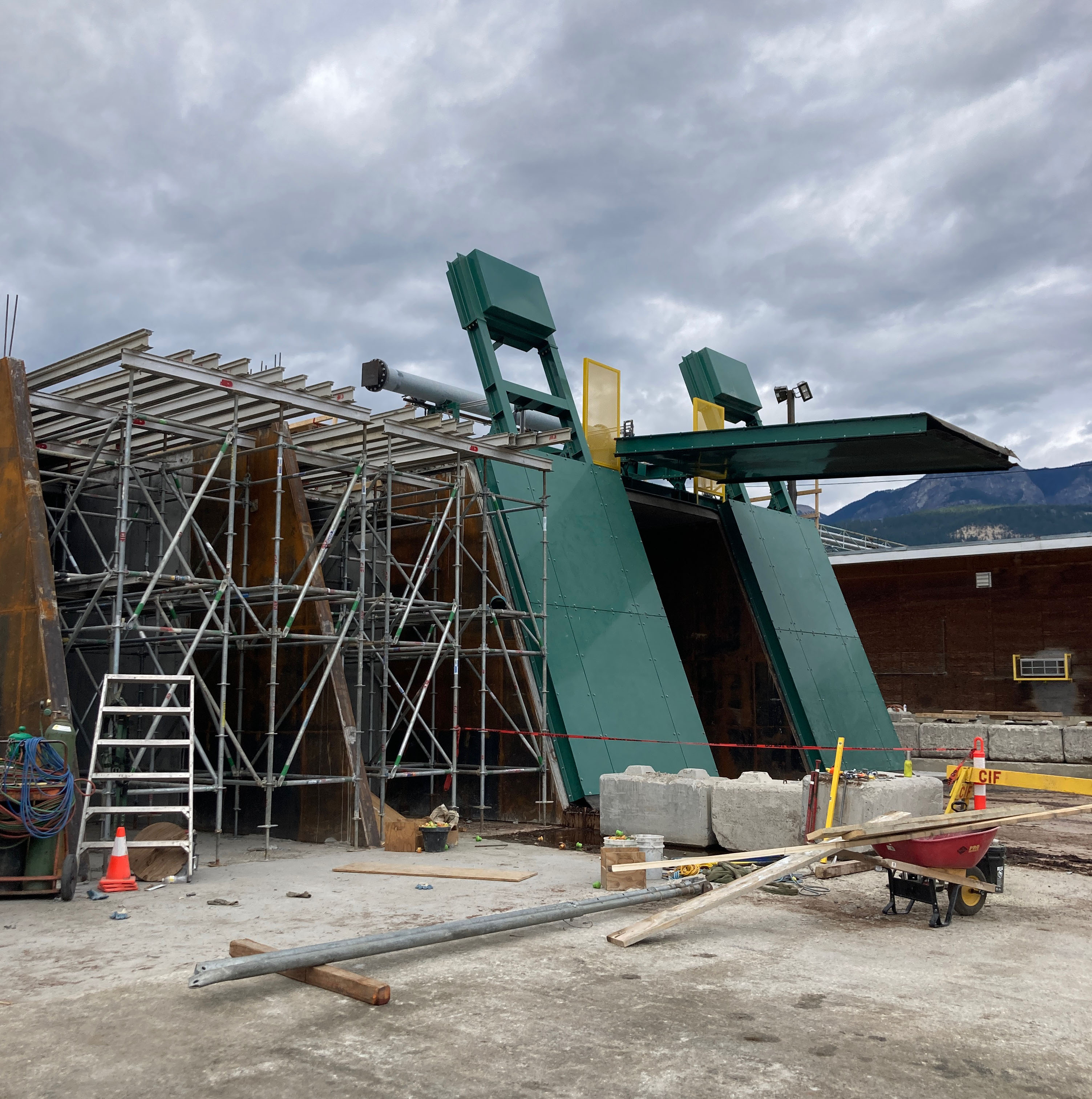

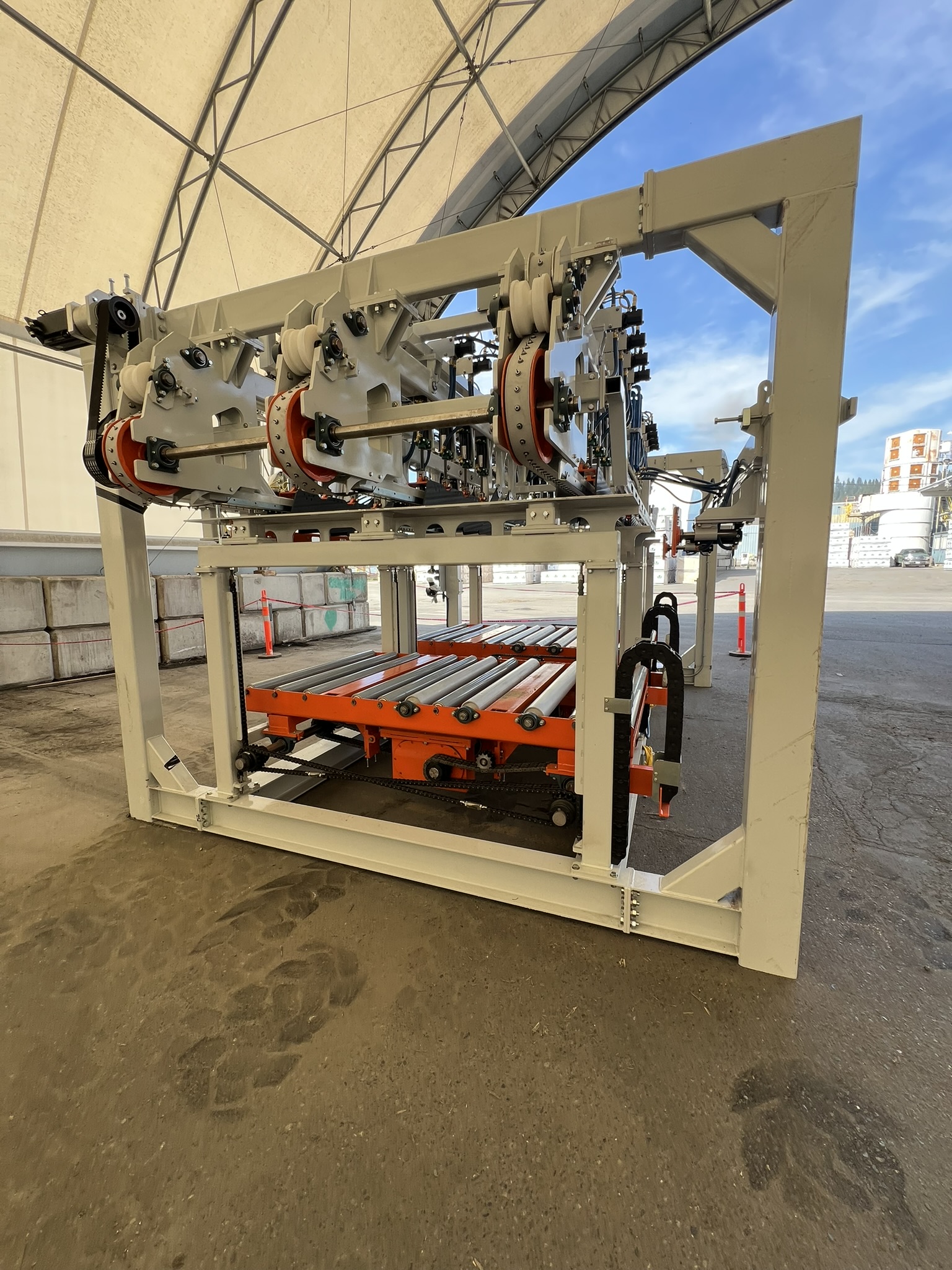

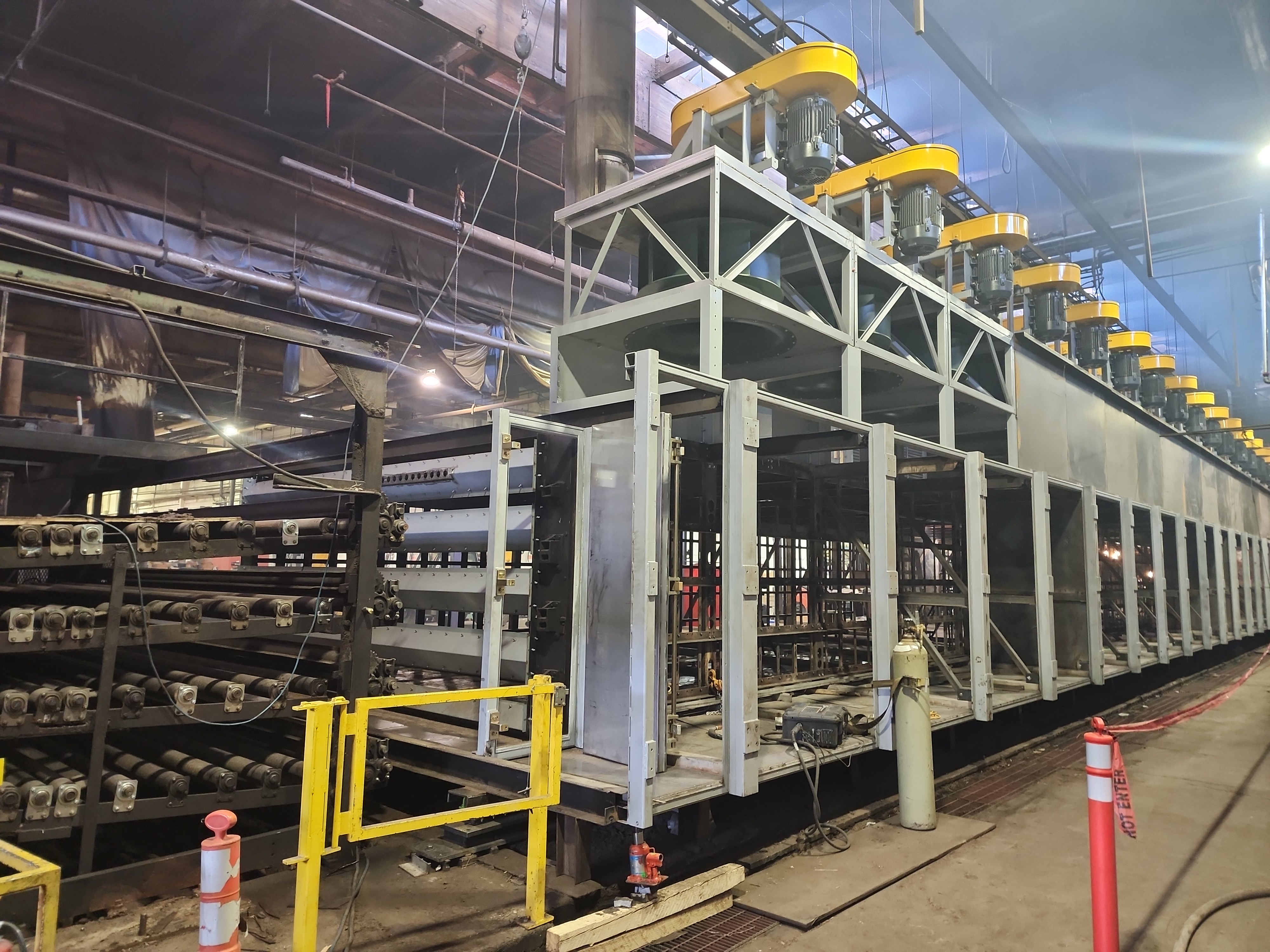

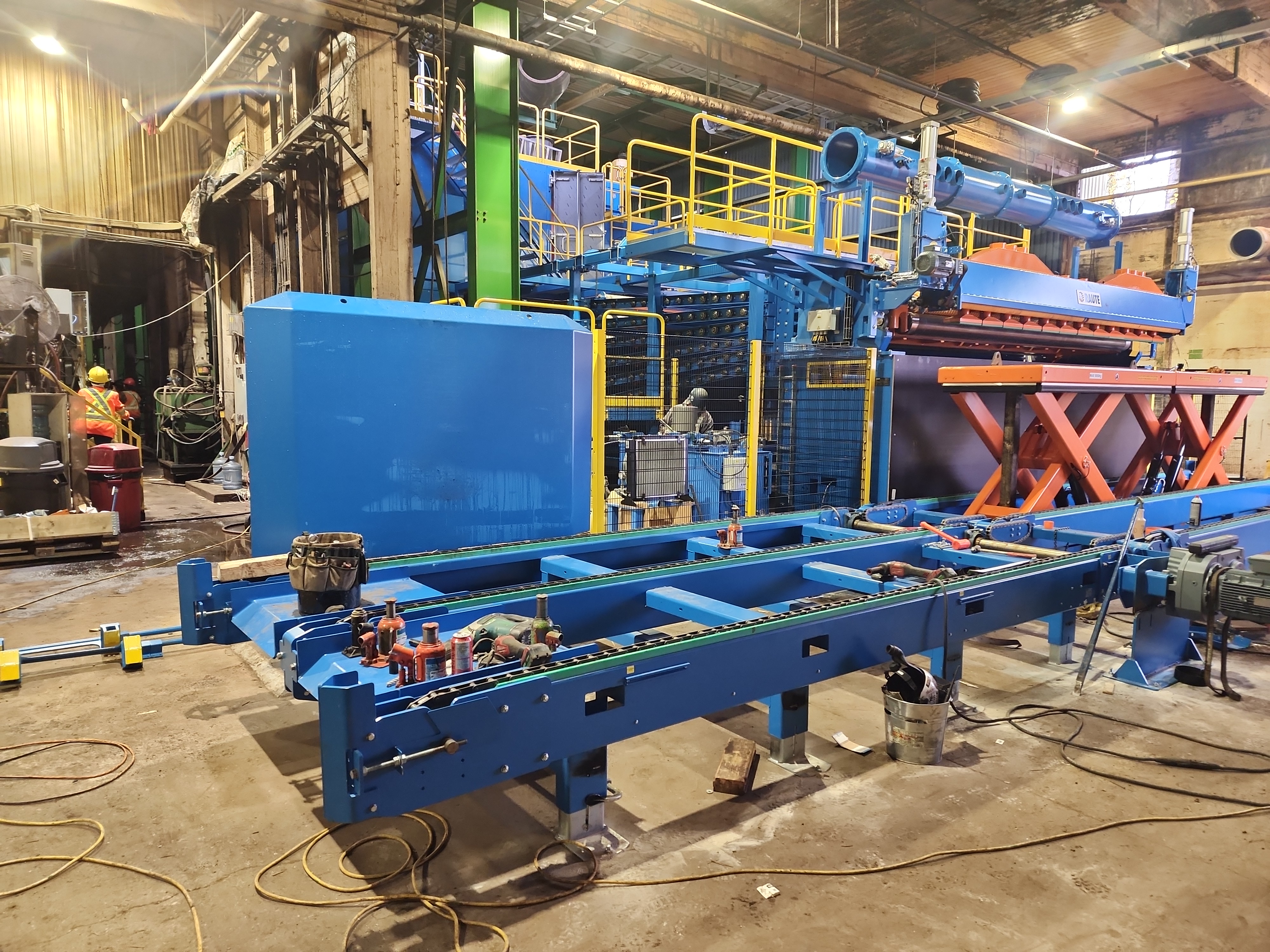

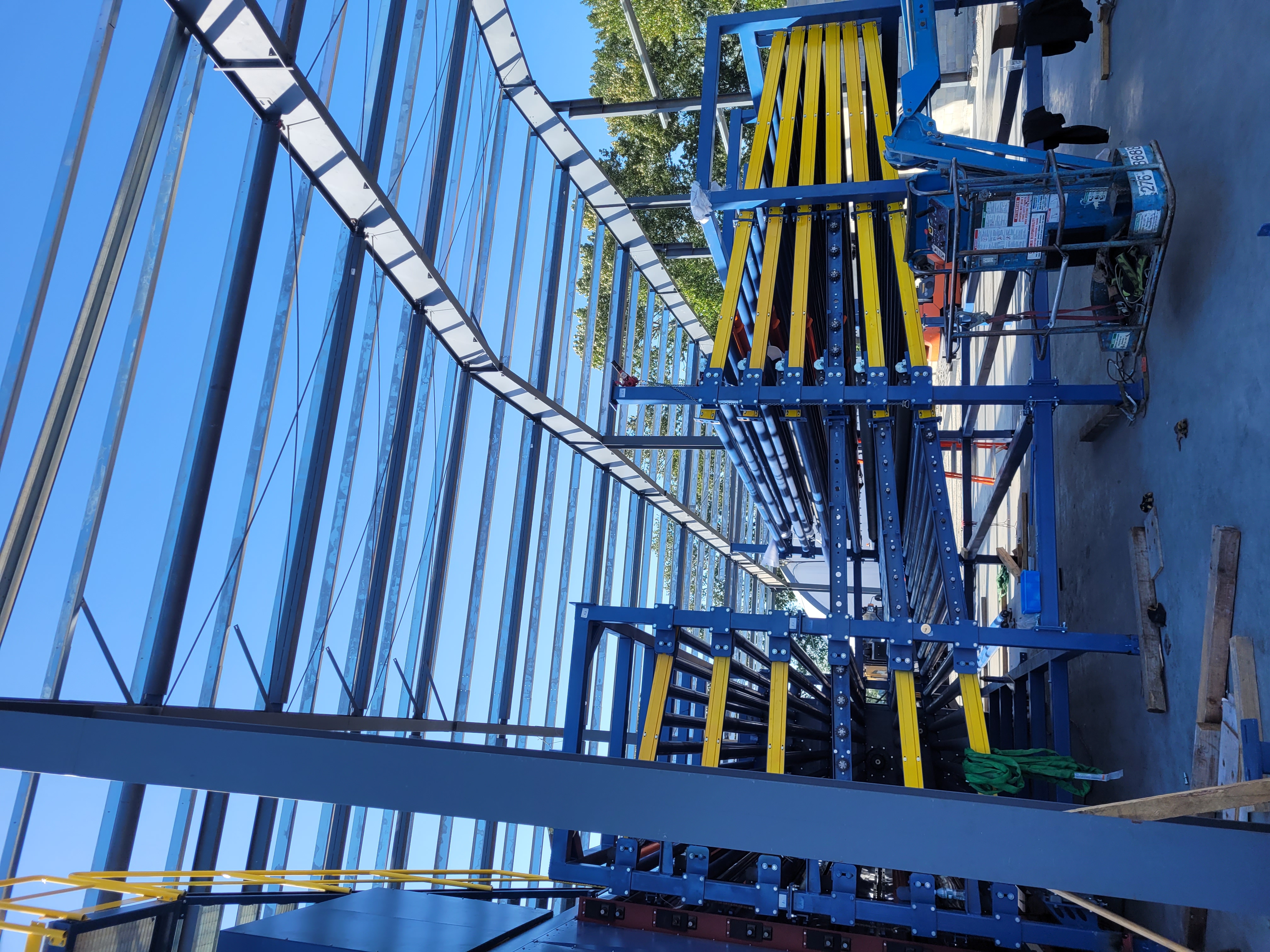

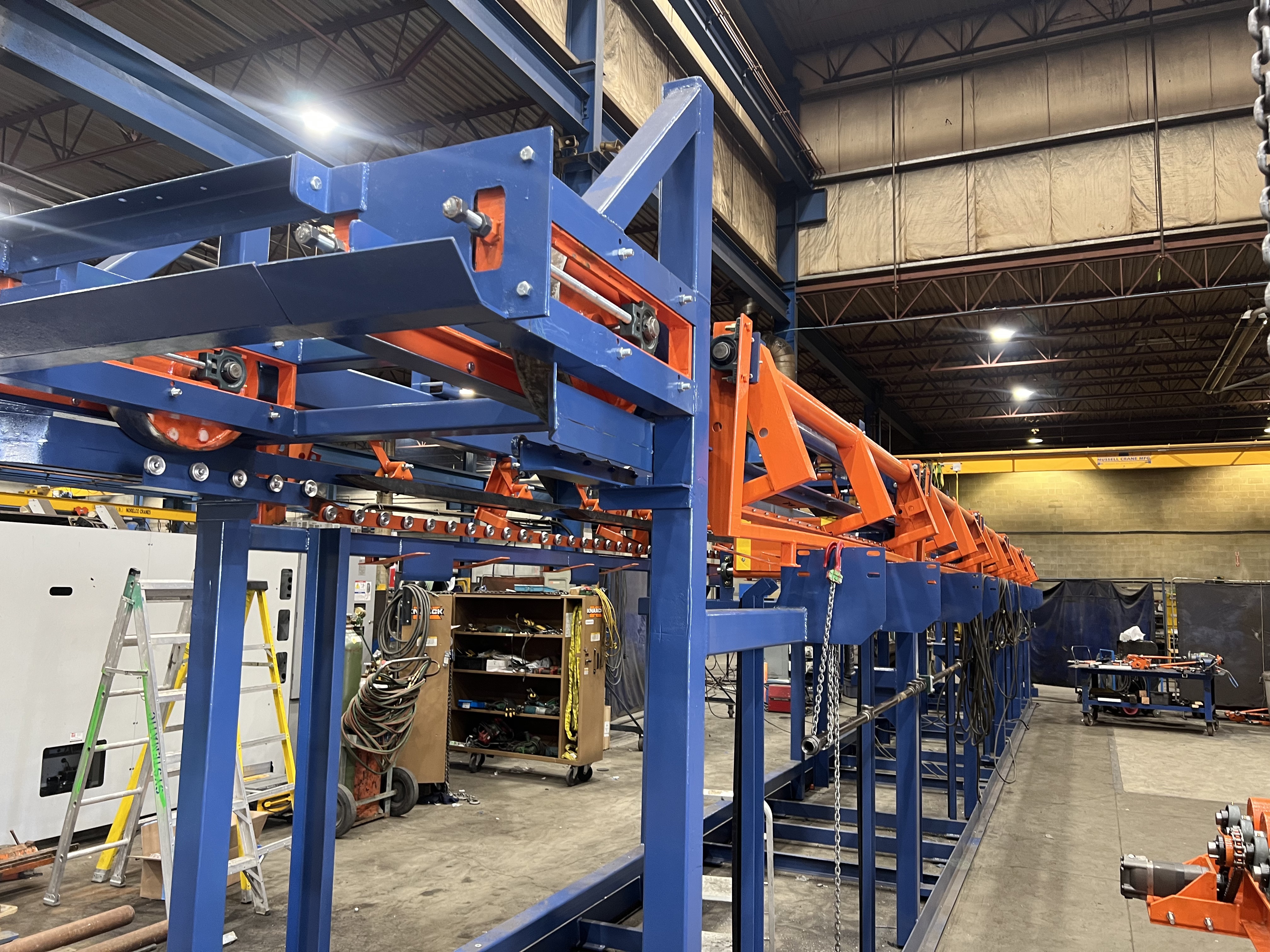

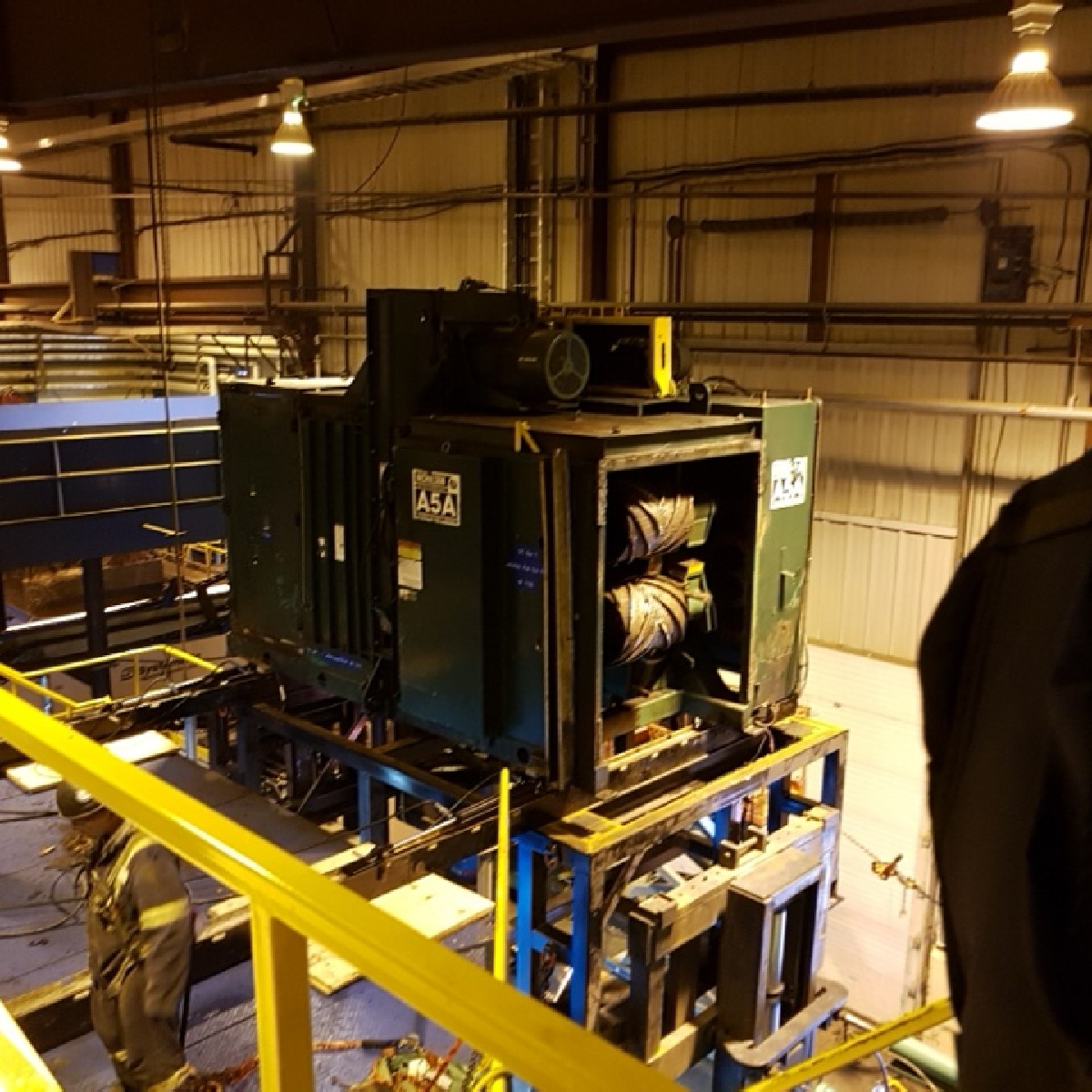

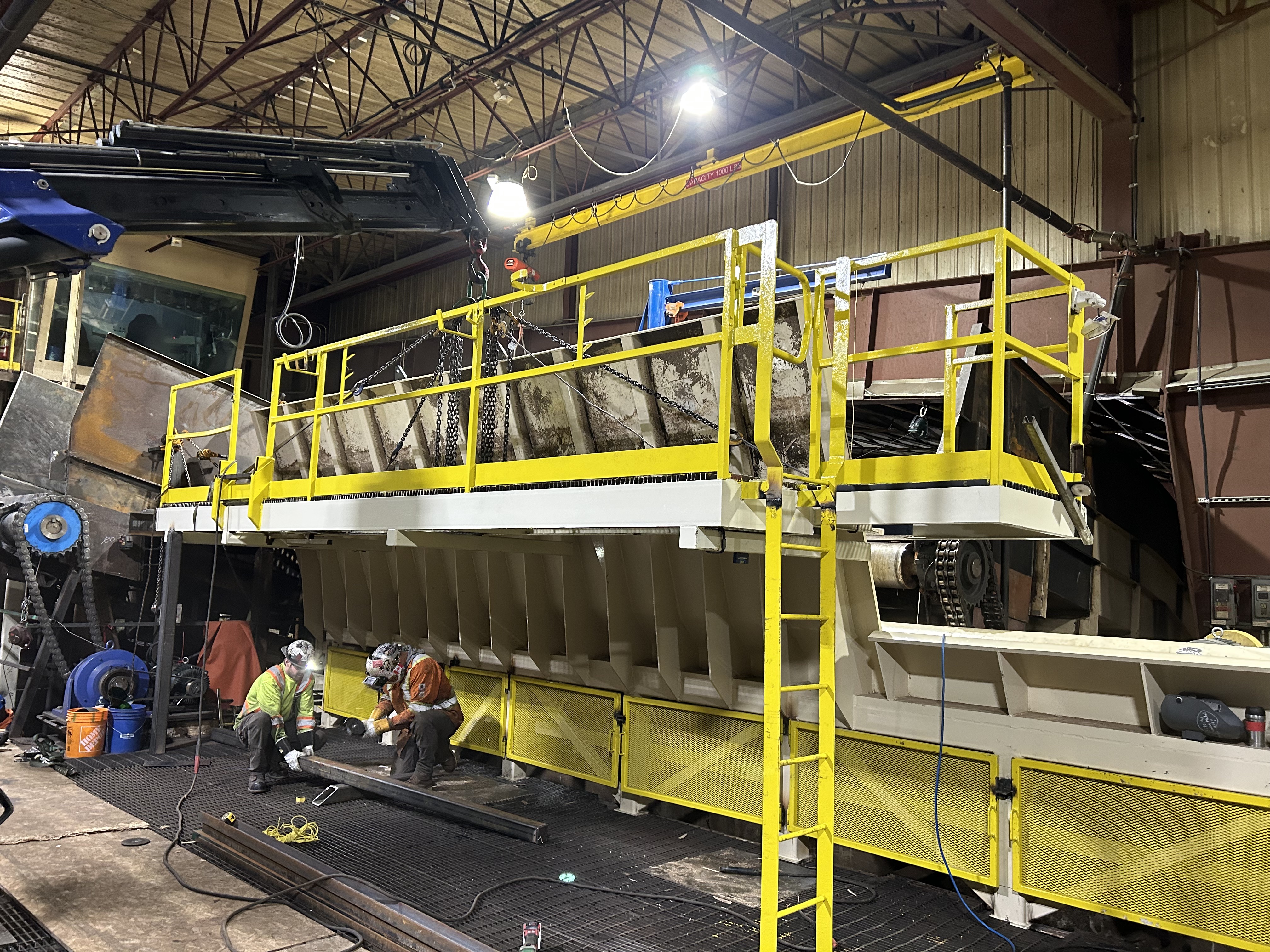

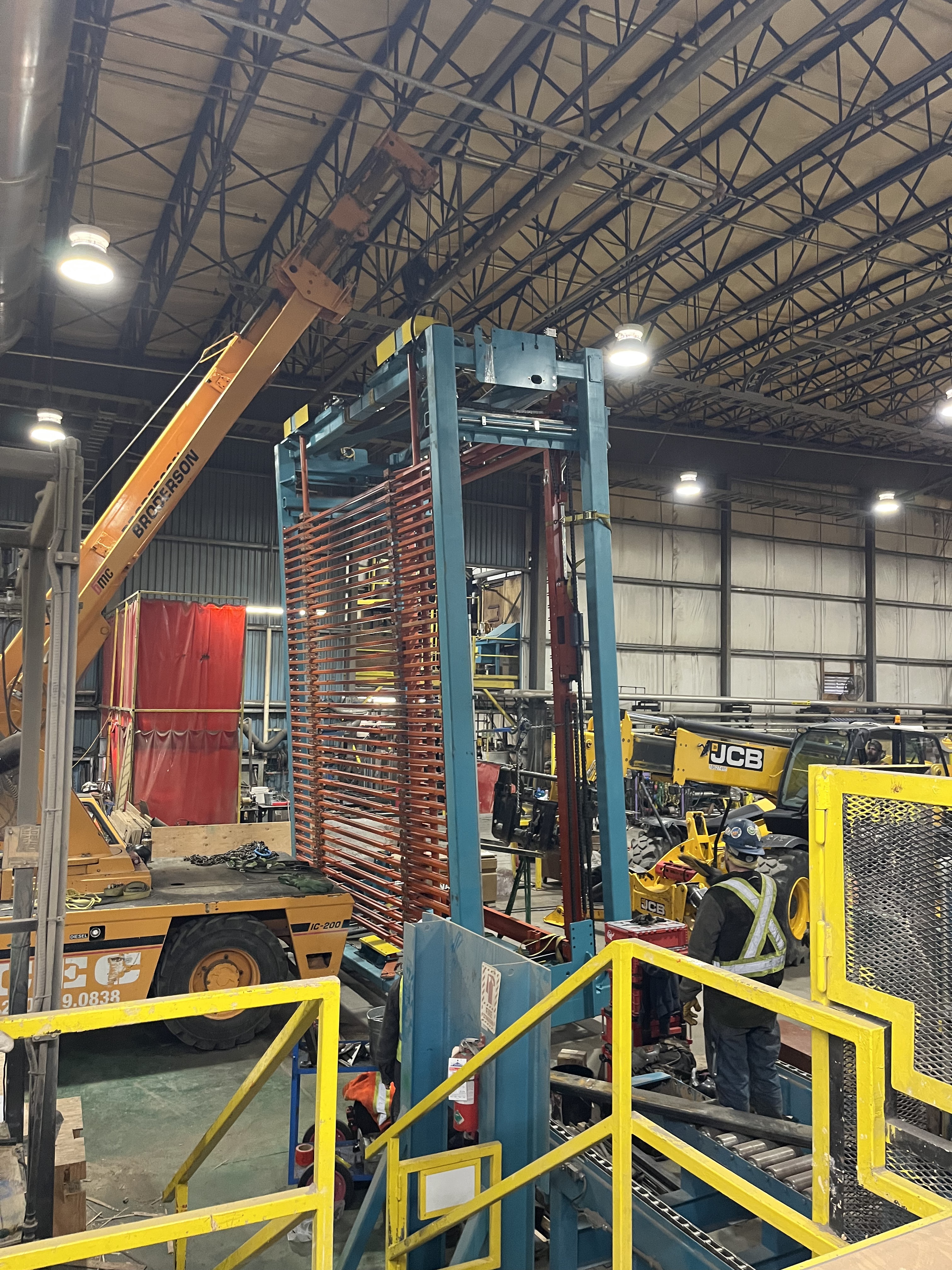

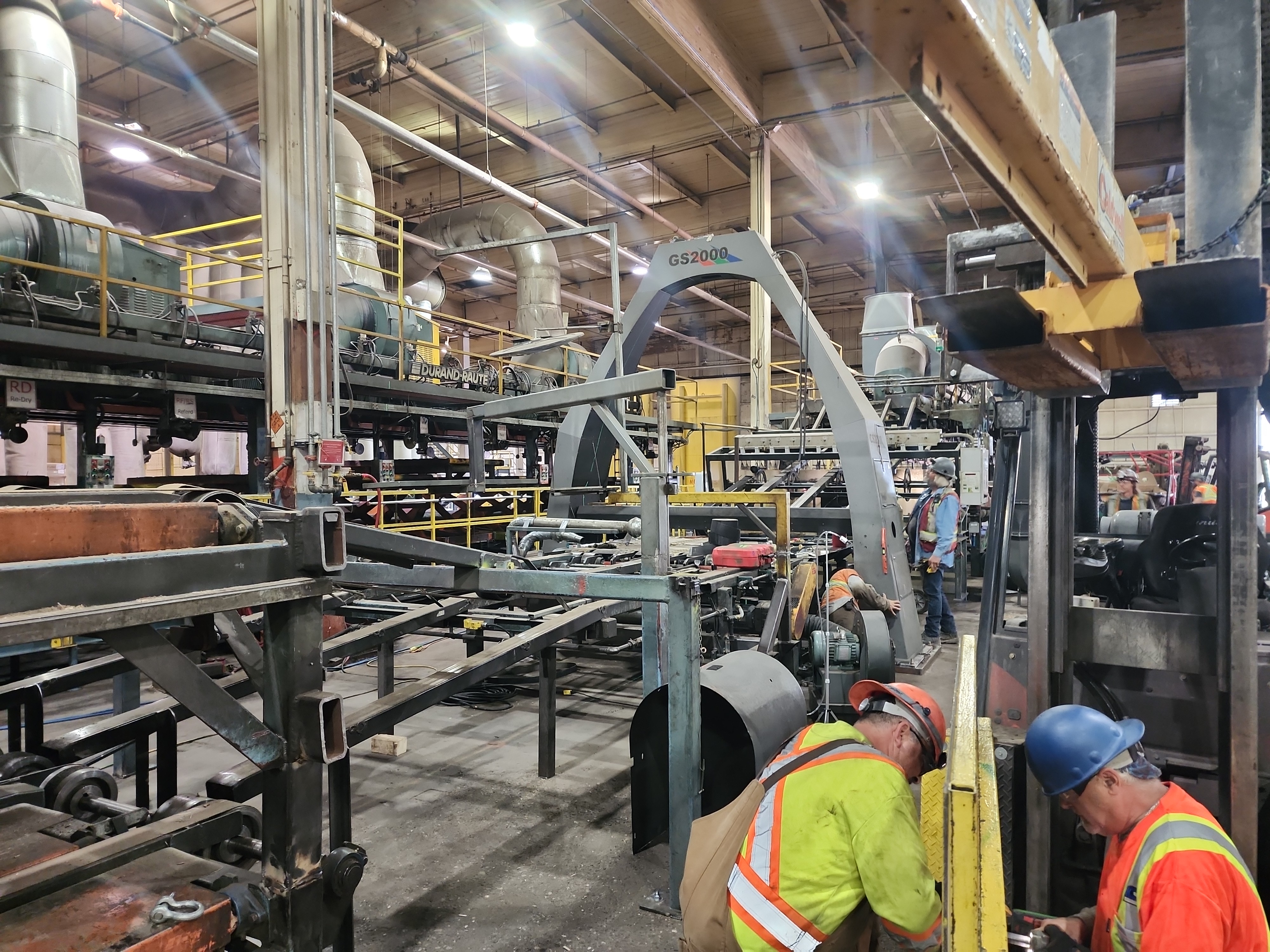

New Debarker # 2 installation:

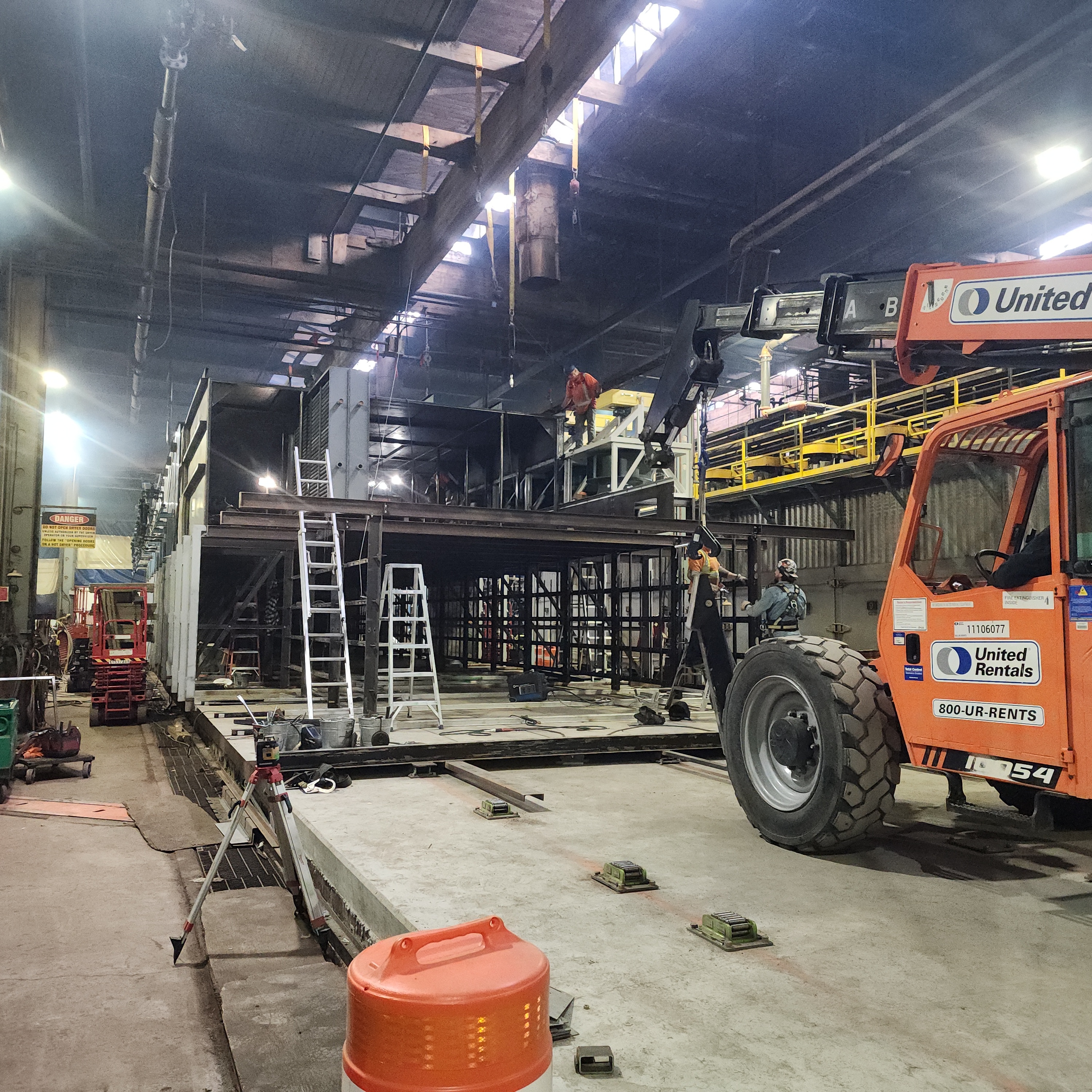

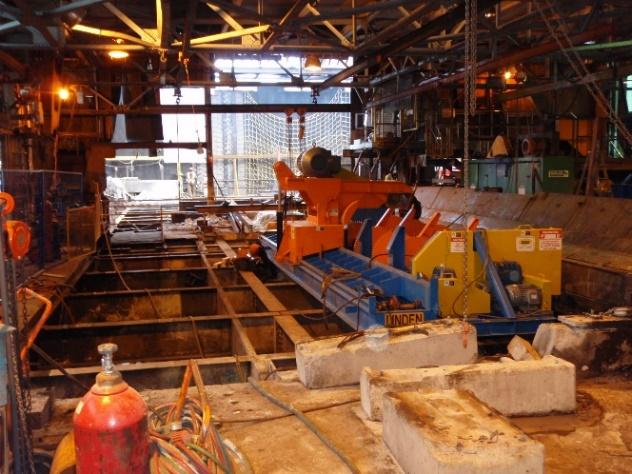

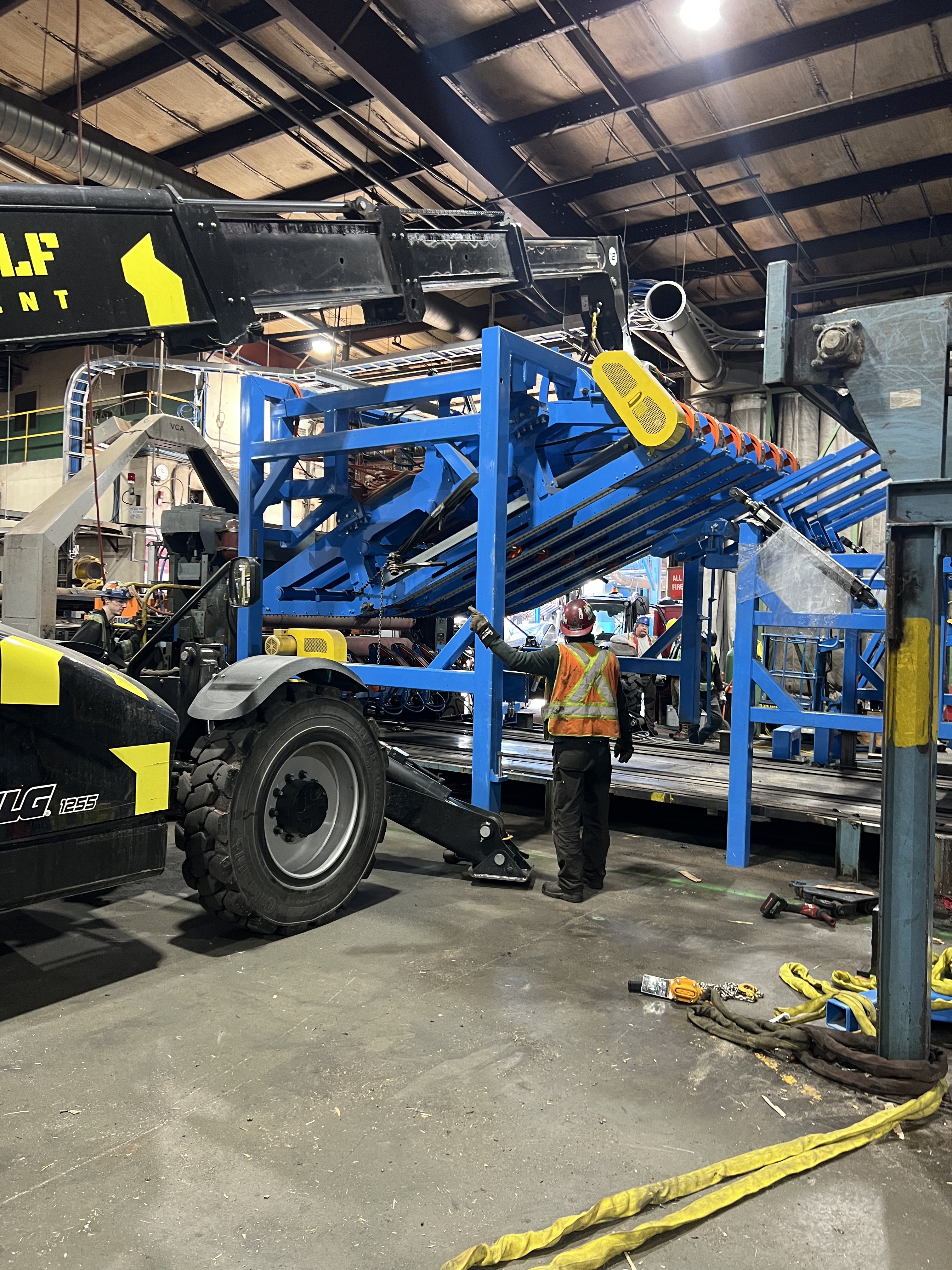

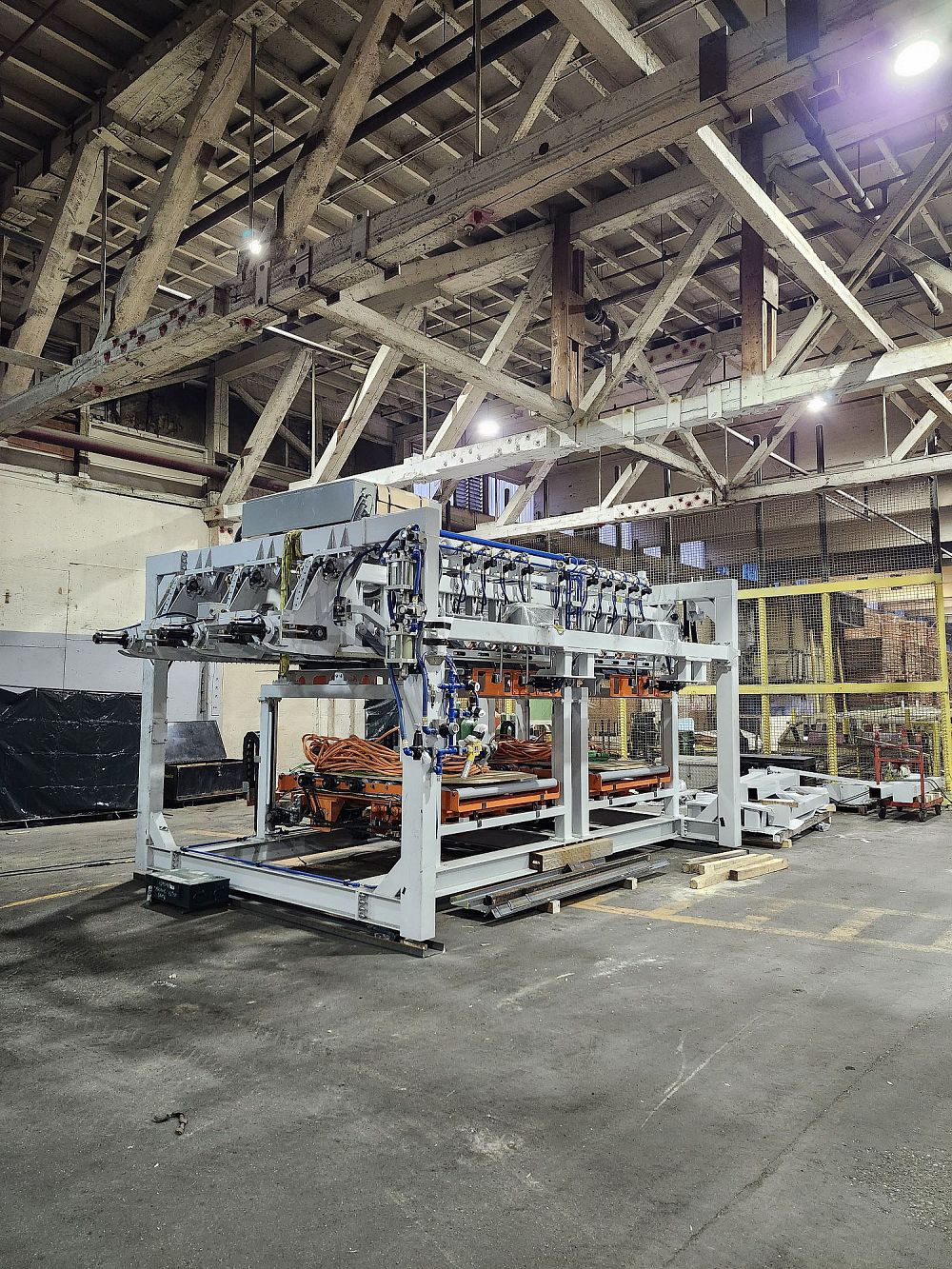

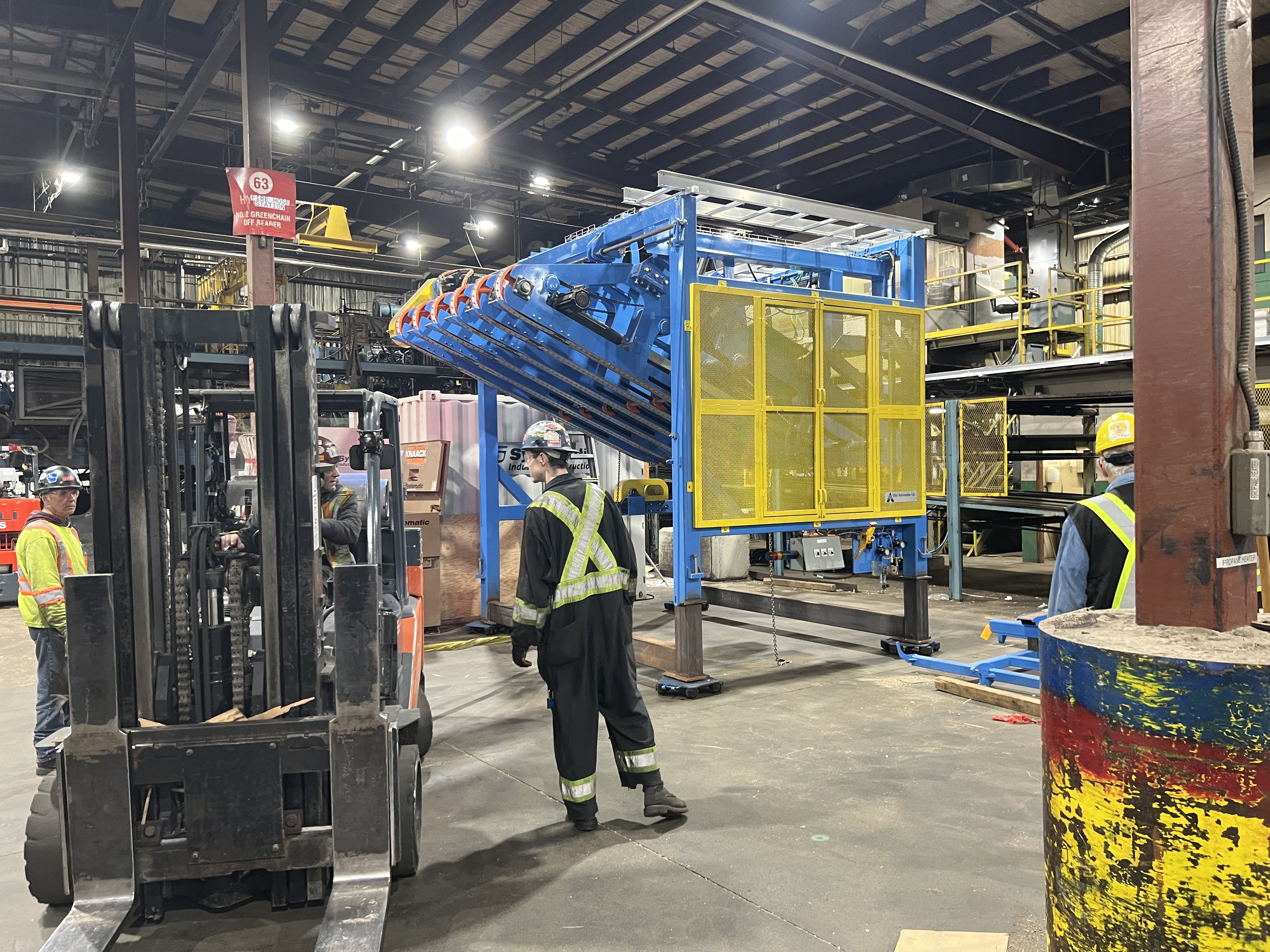

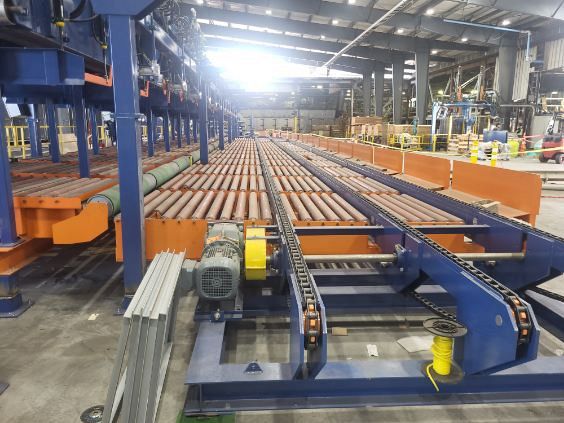

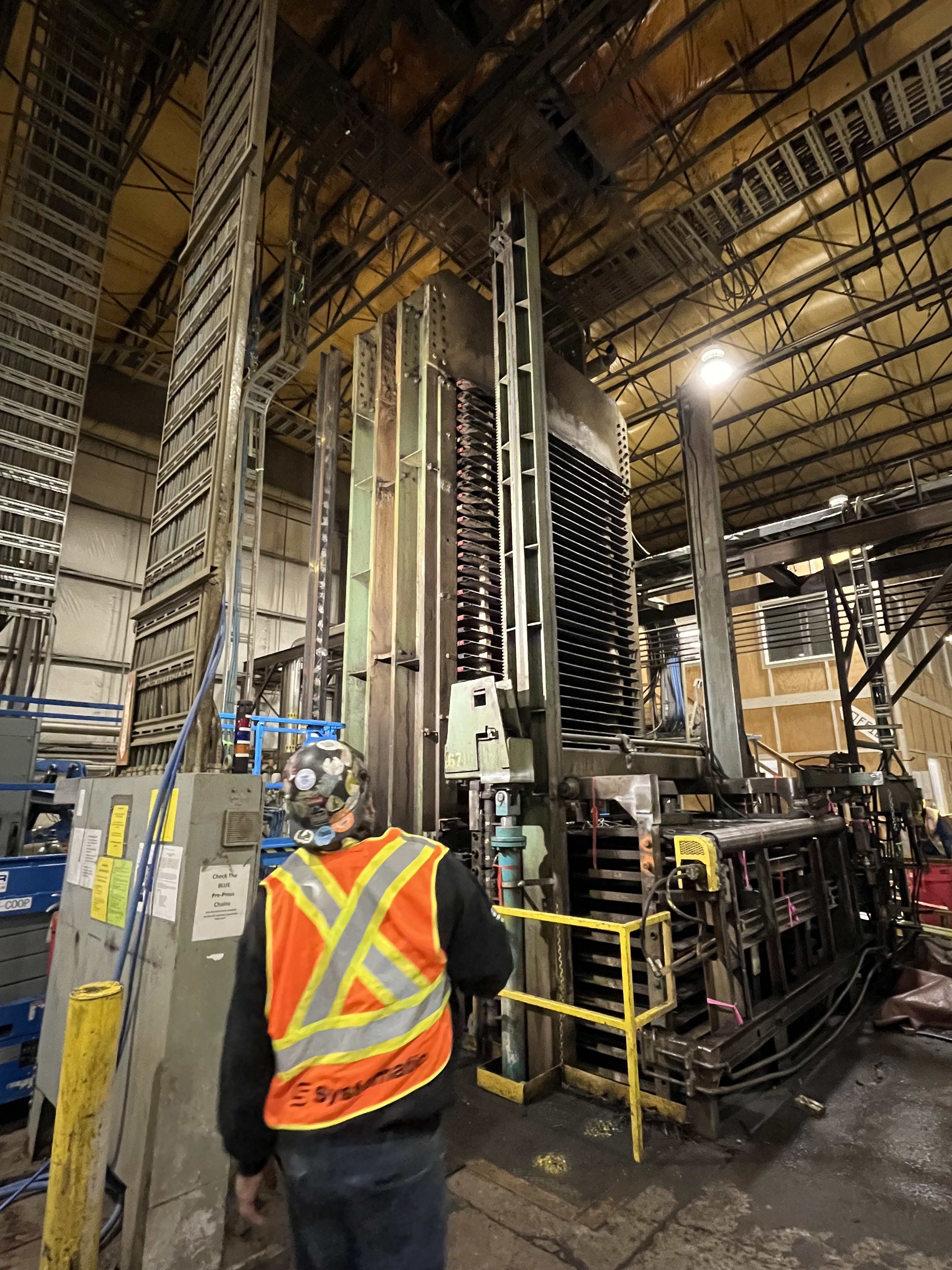

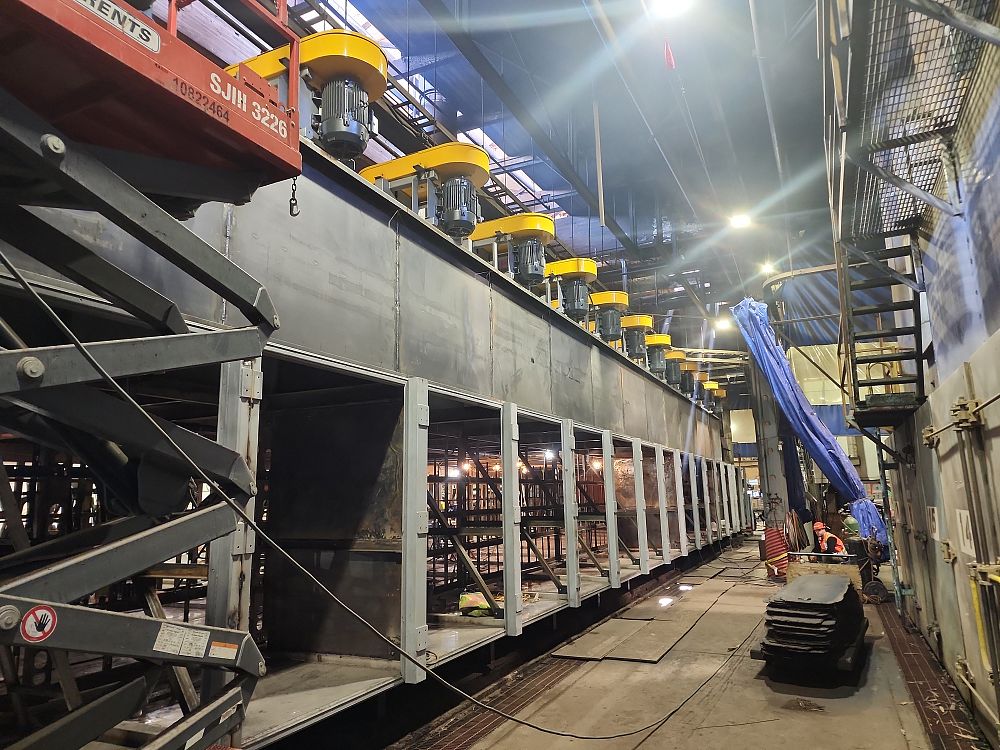

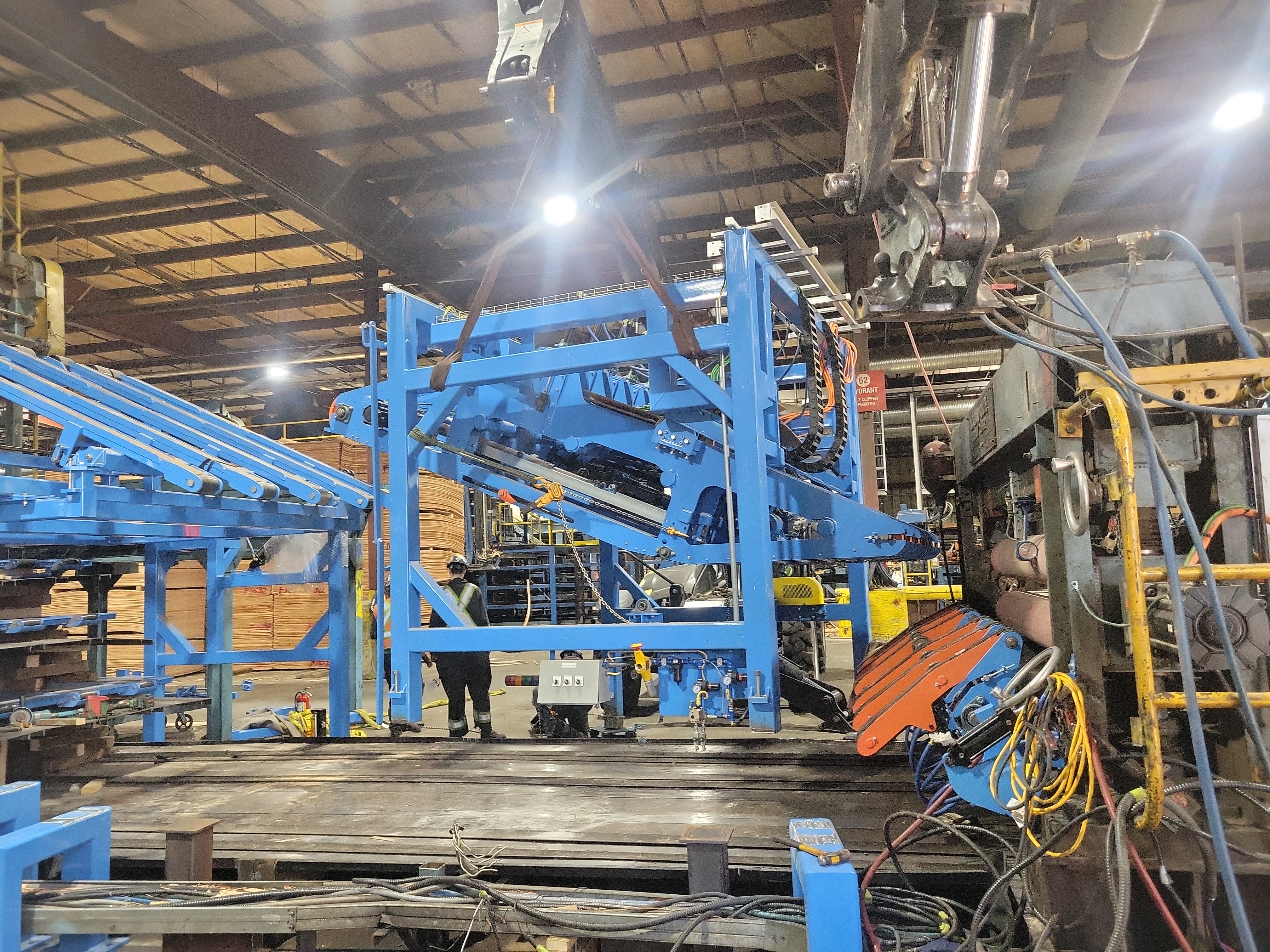

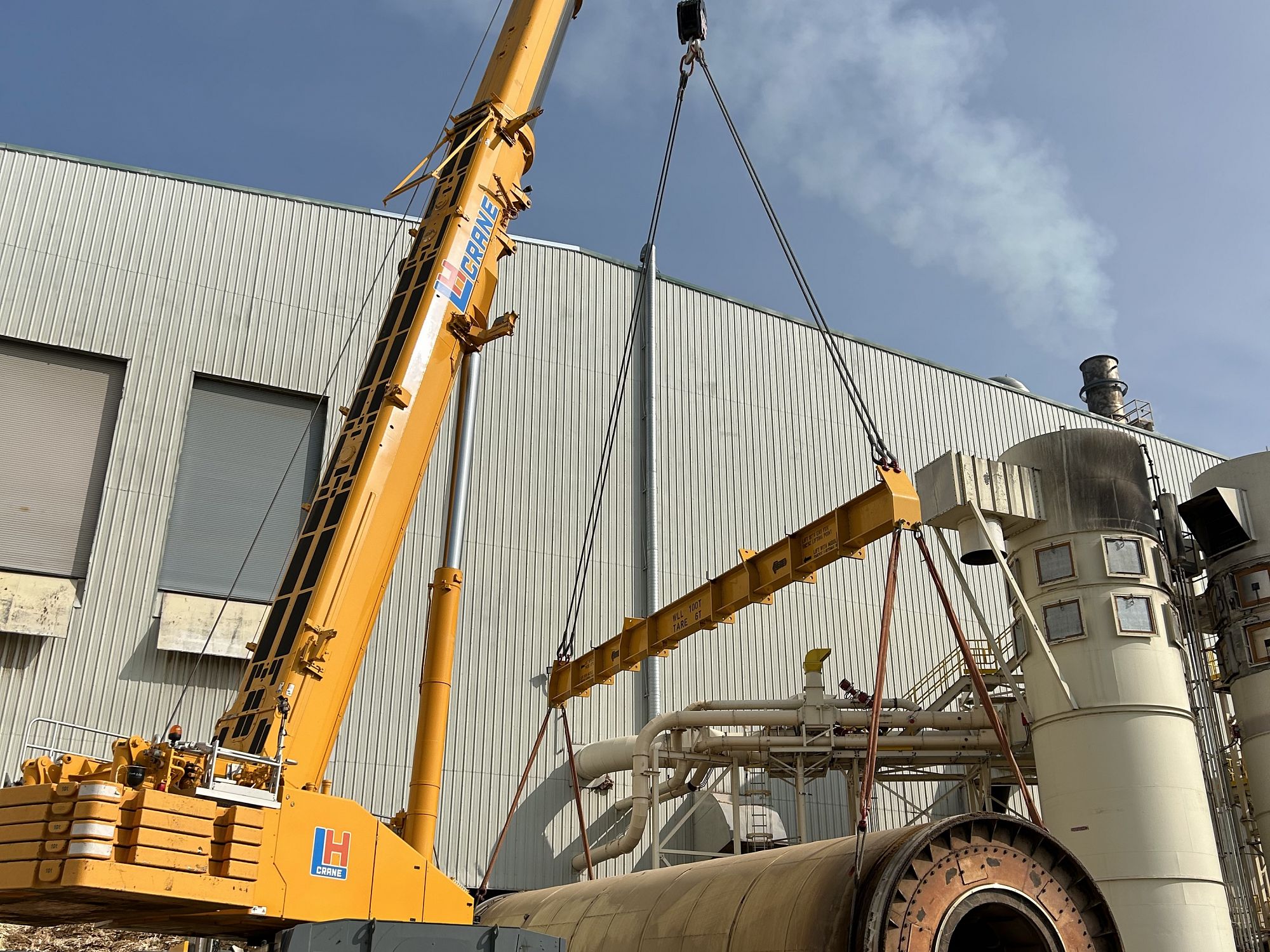

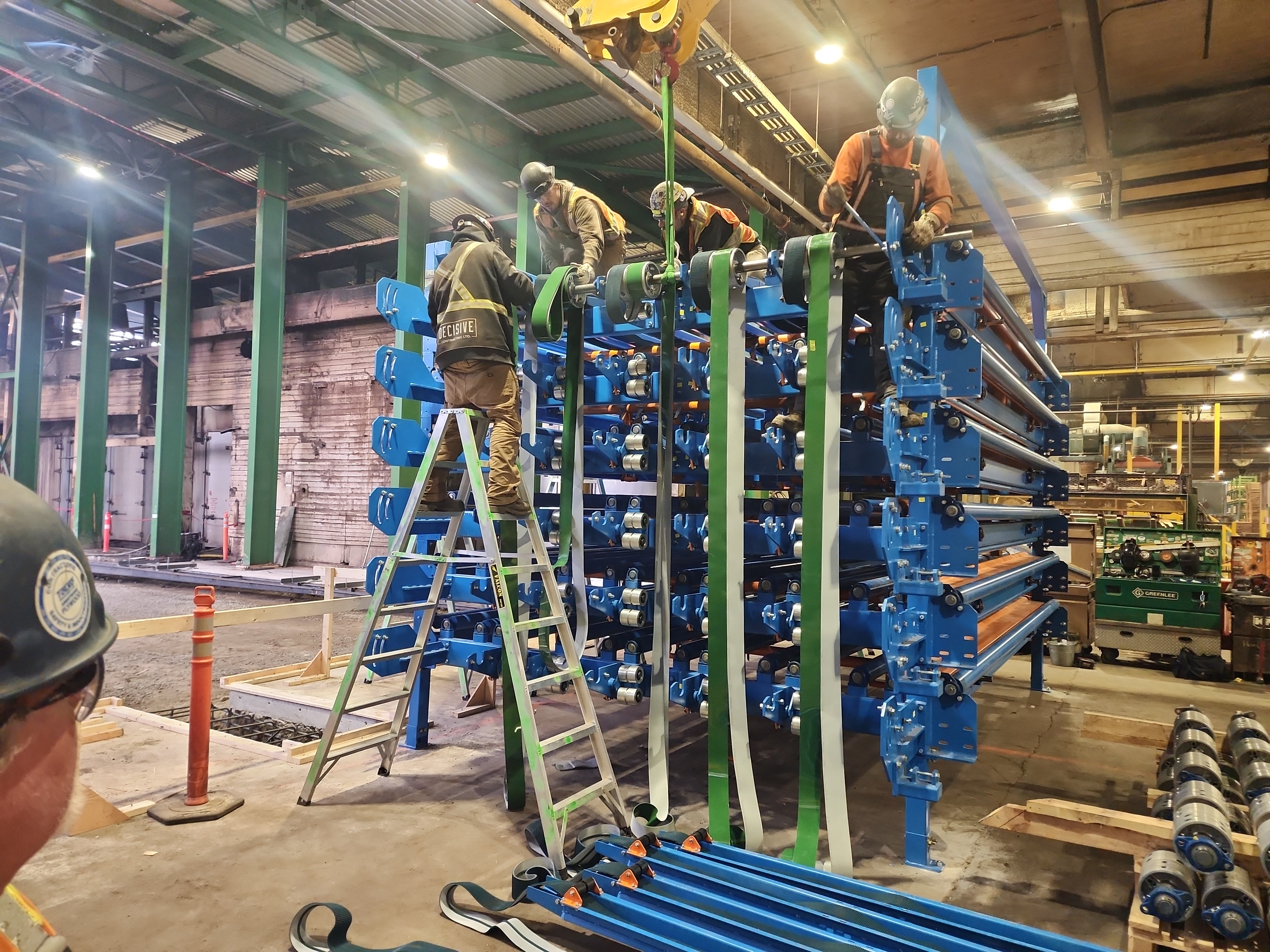

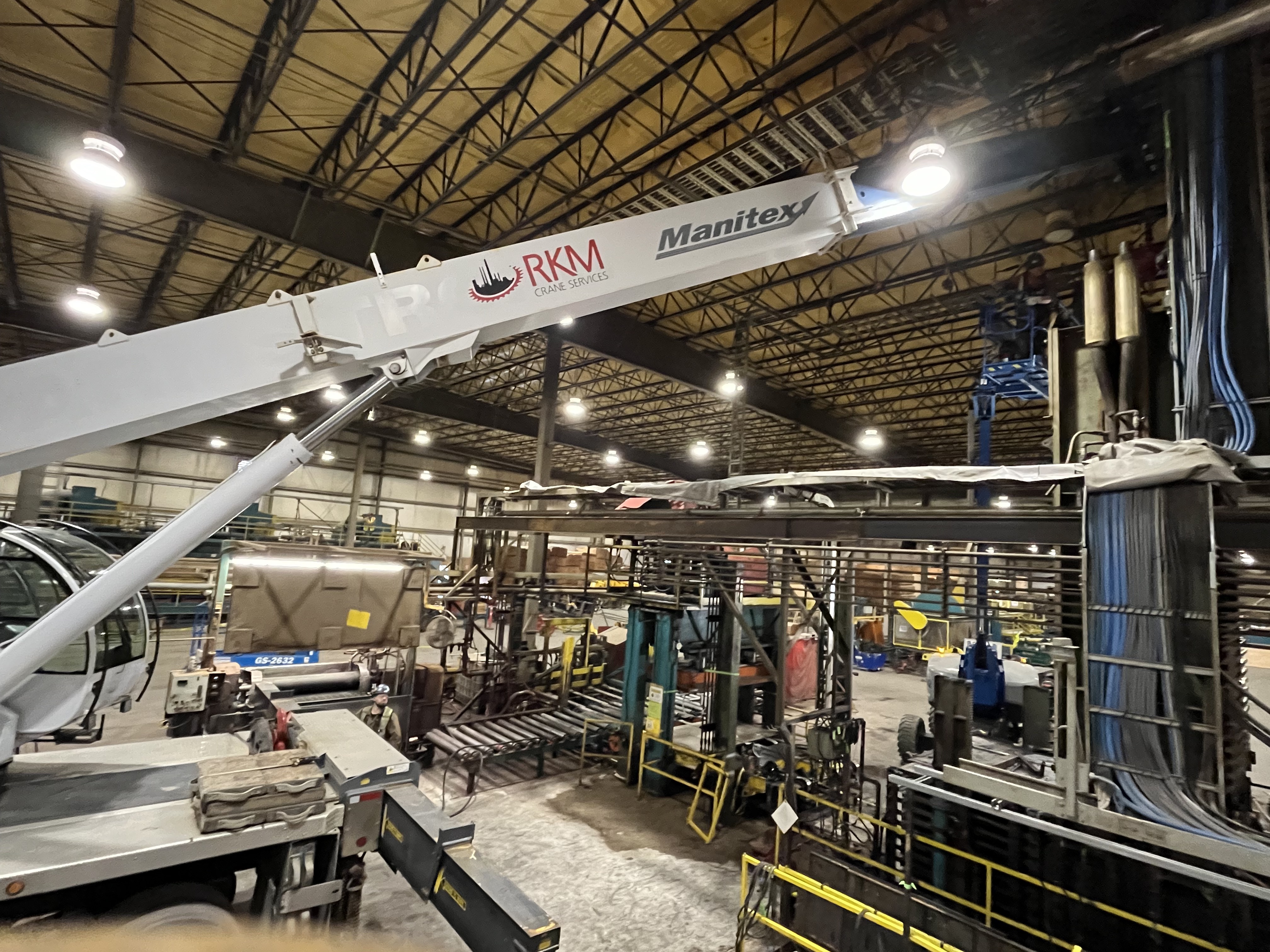

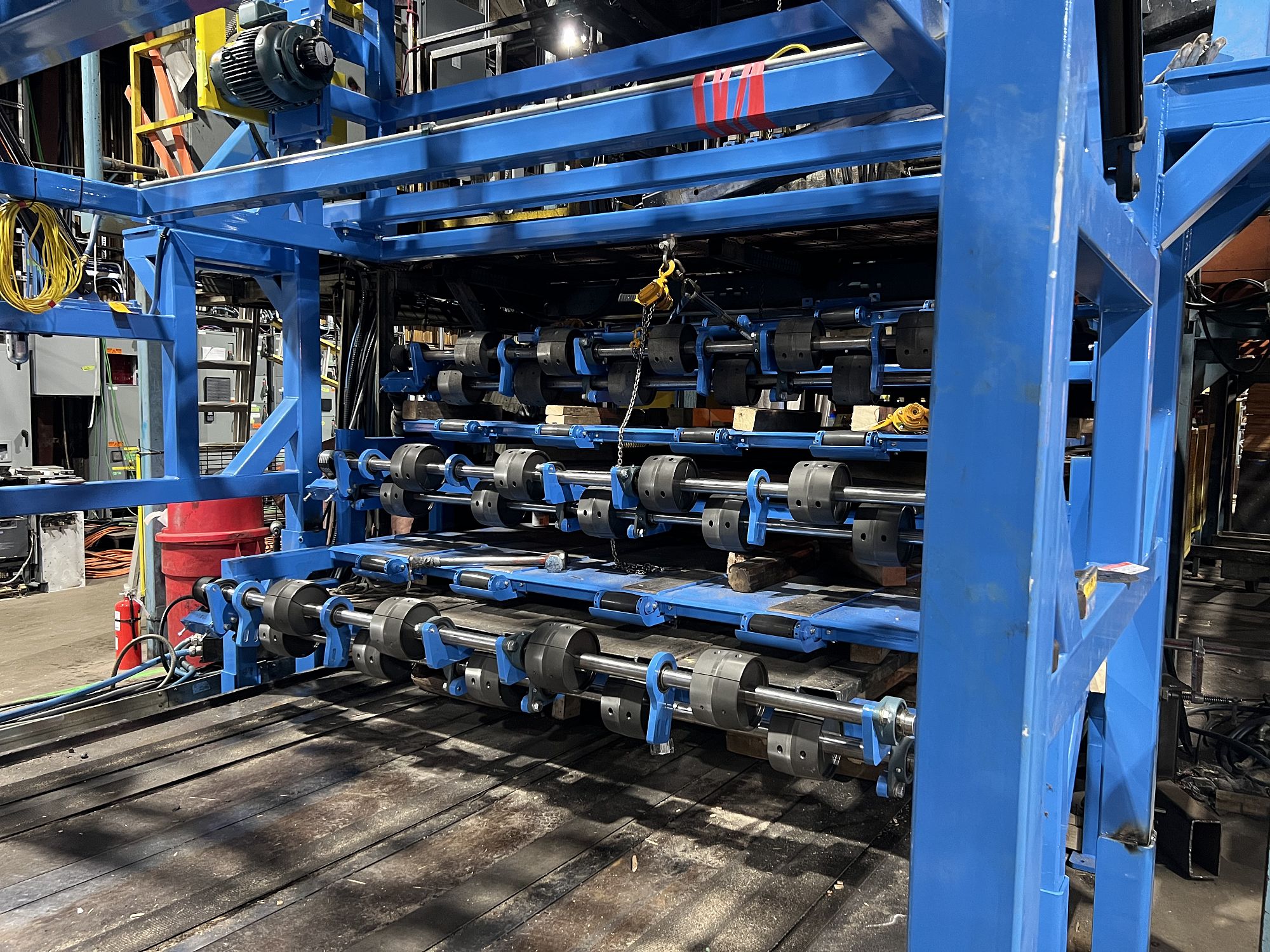

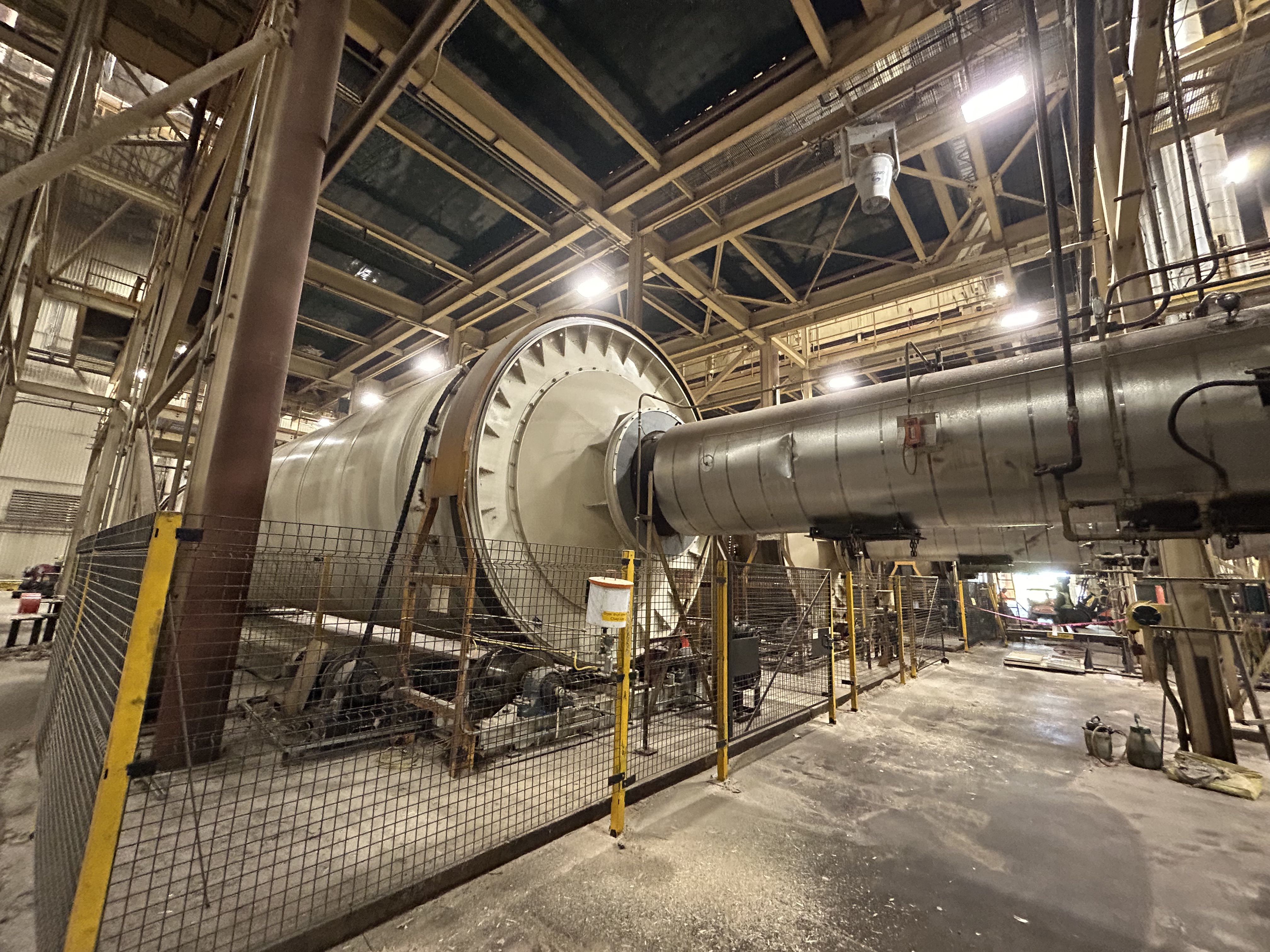

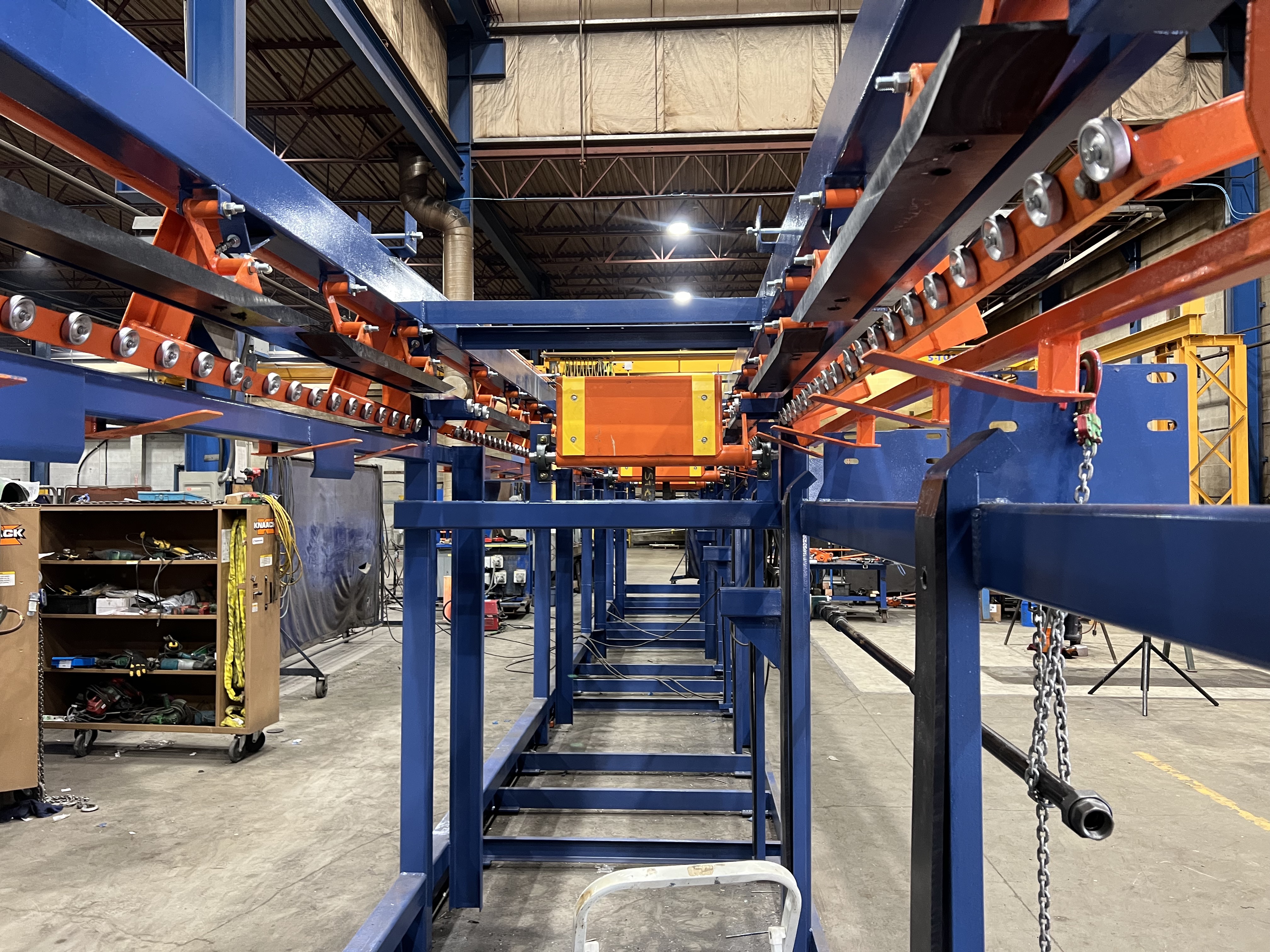

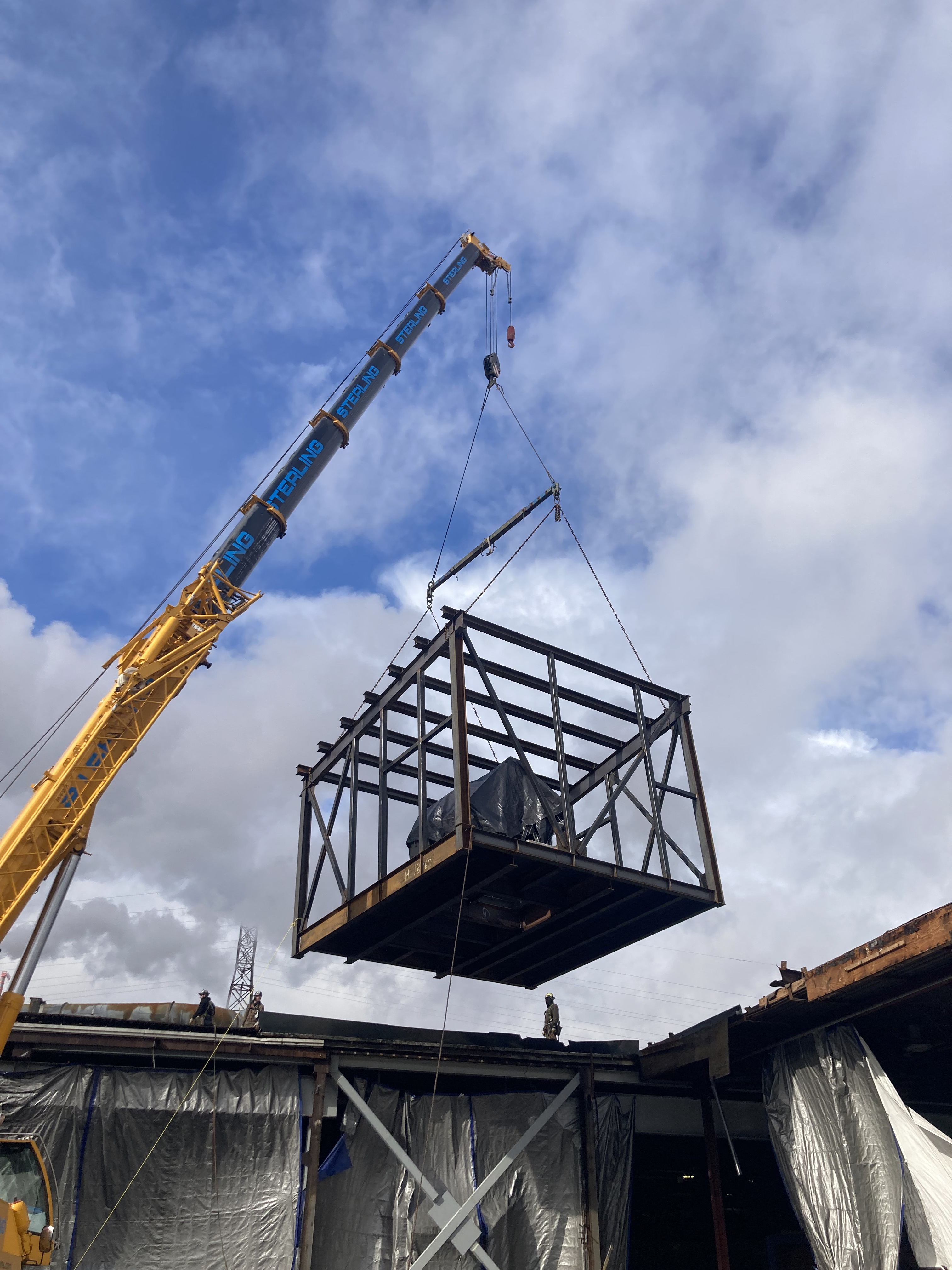

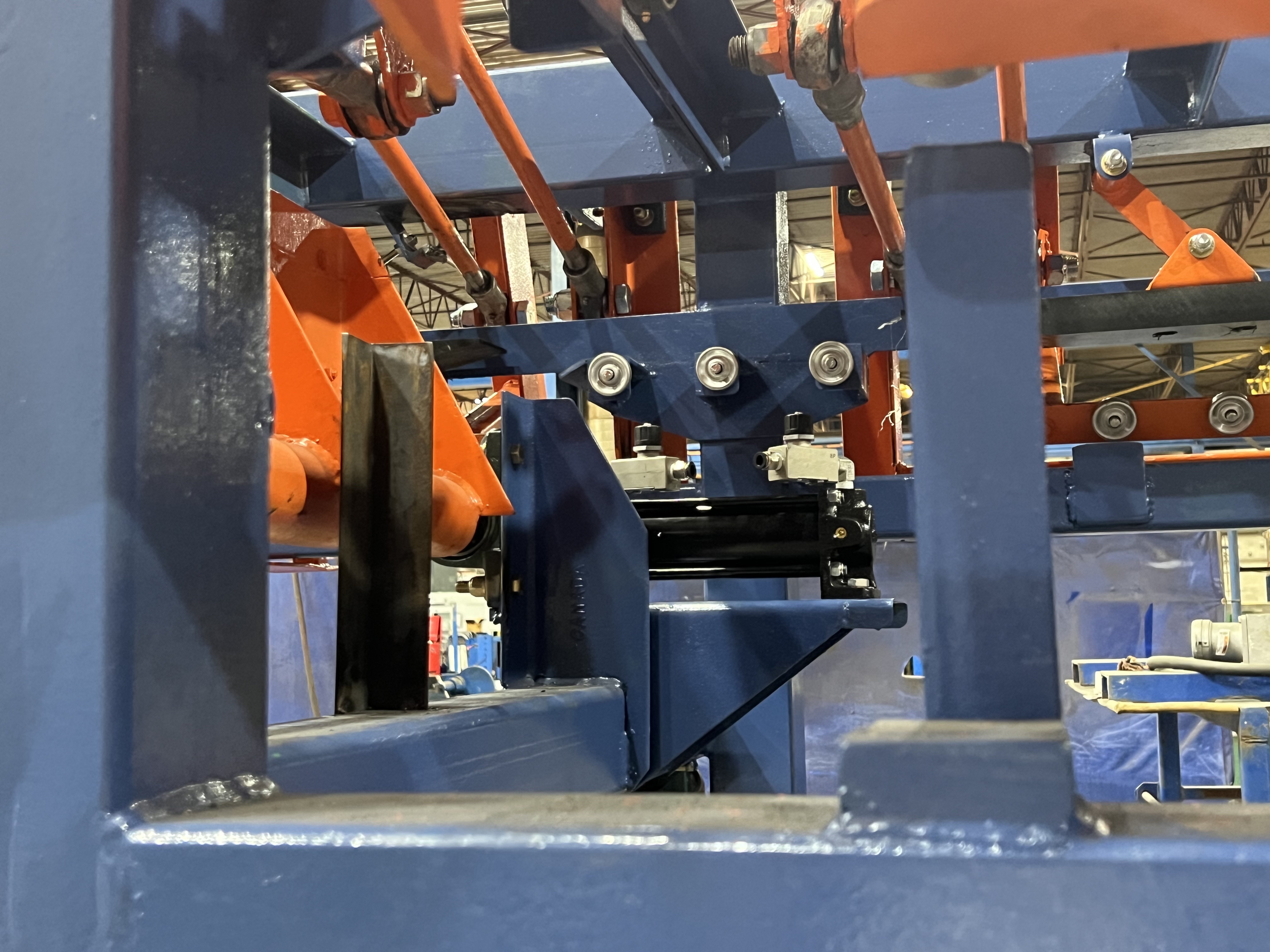

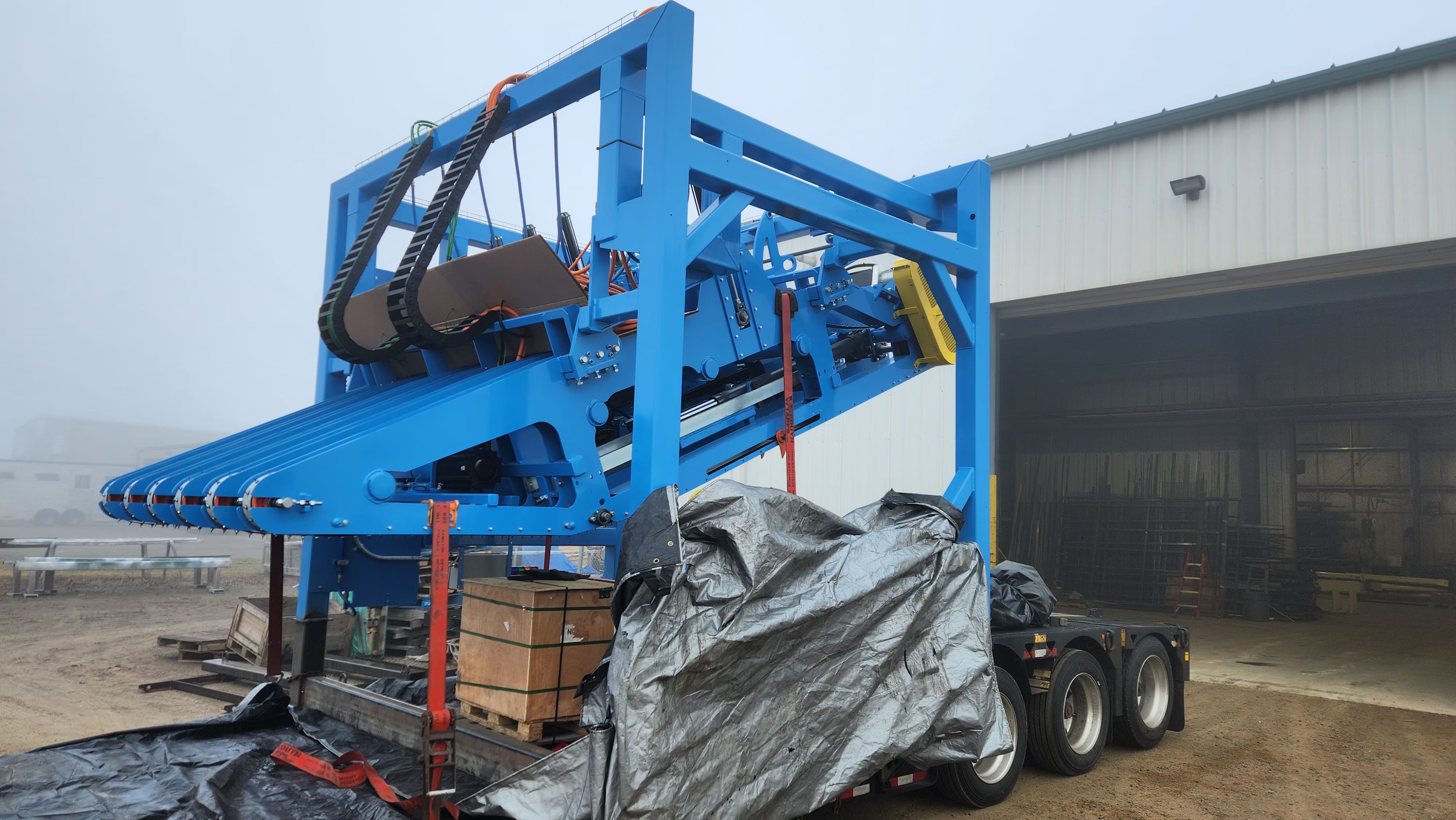

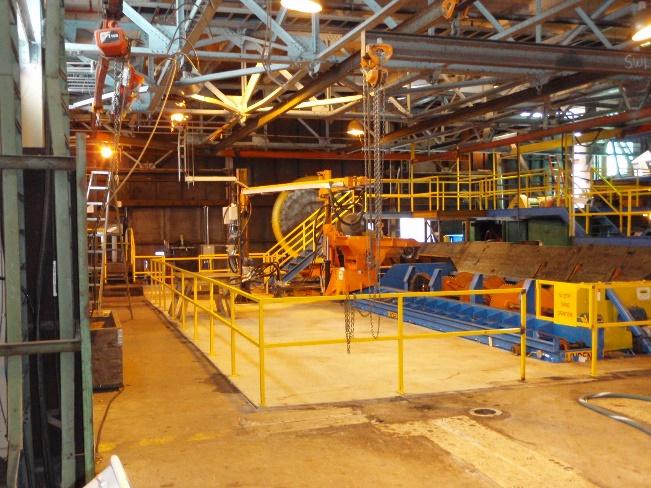

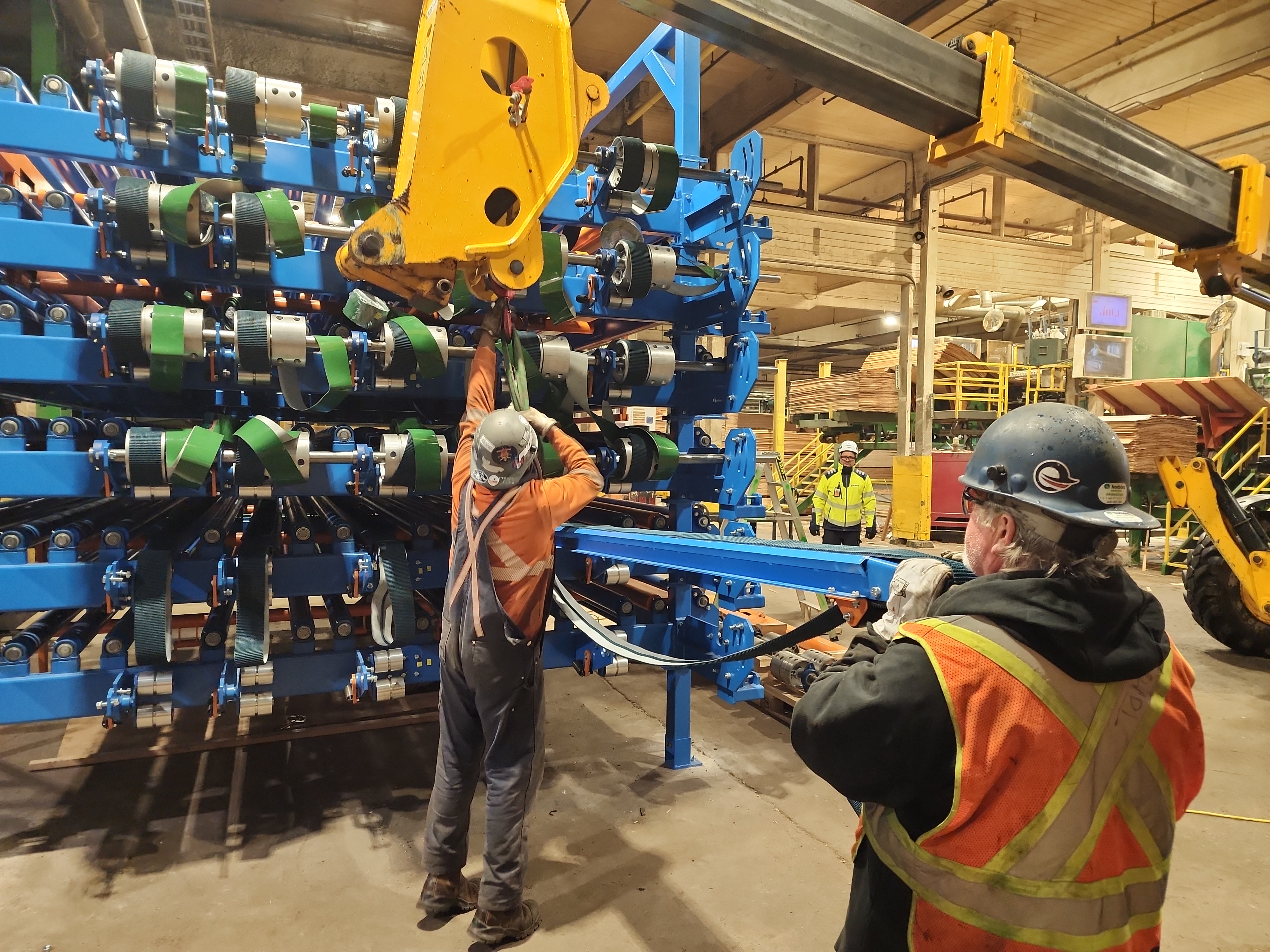

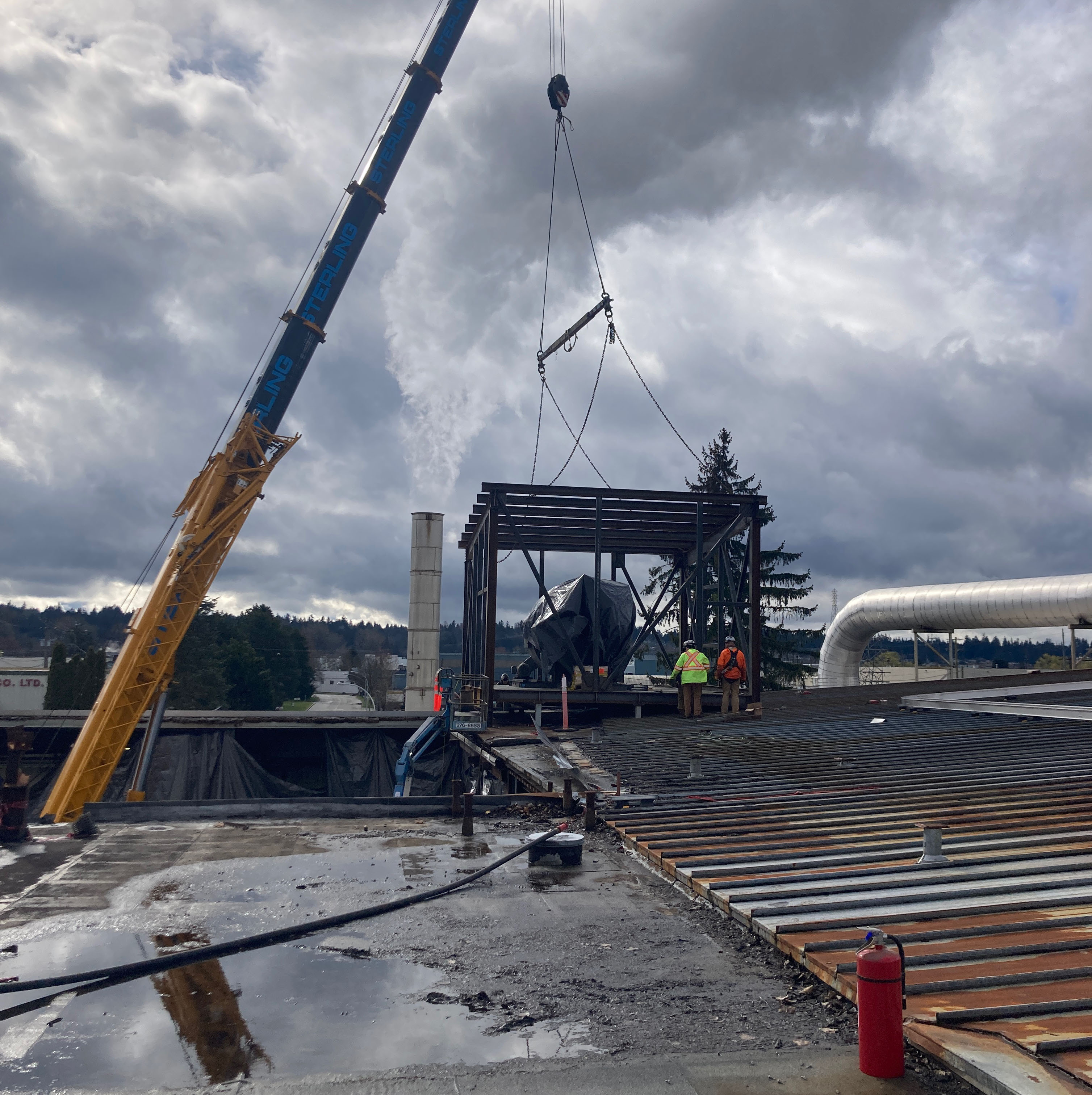

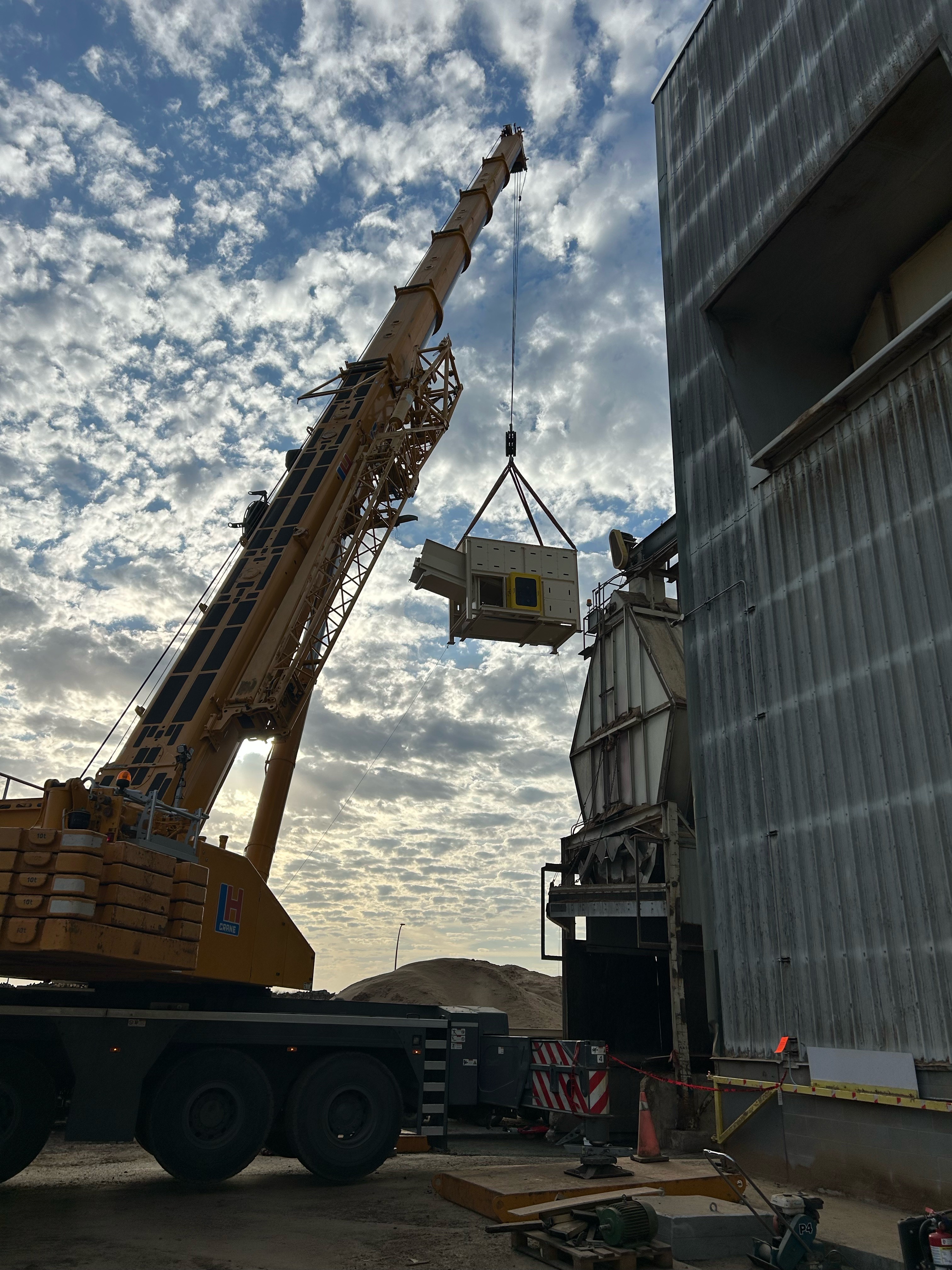

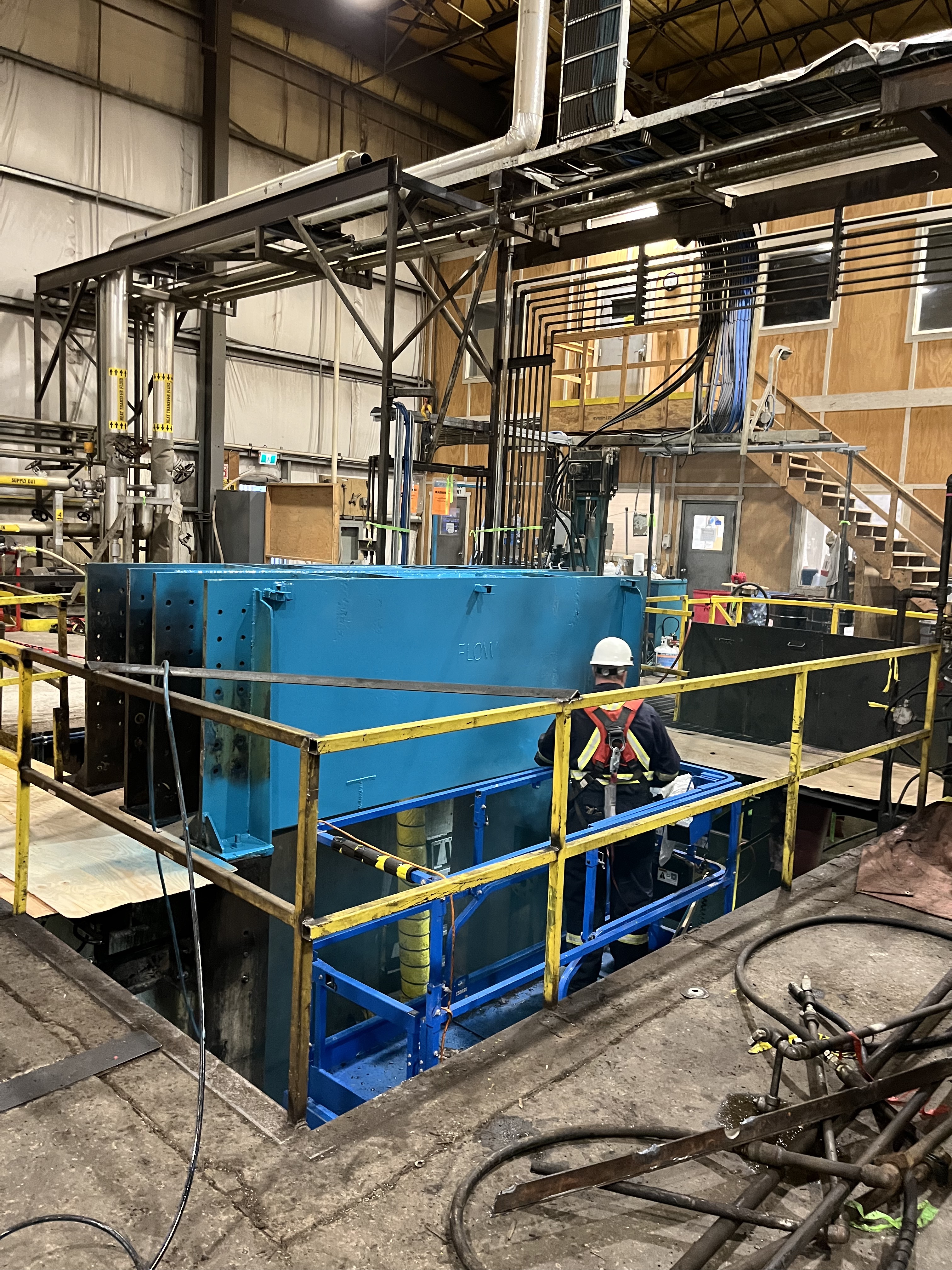

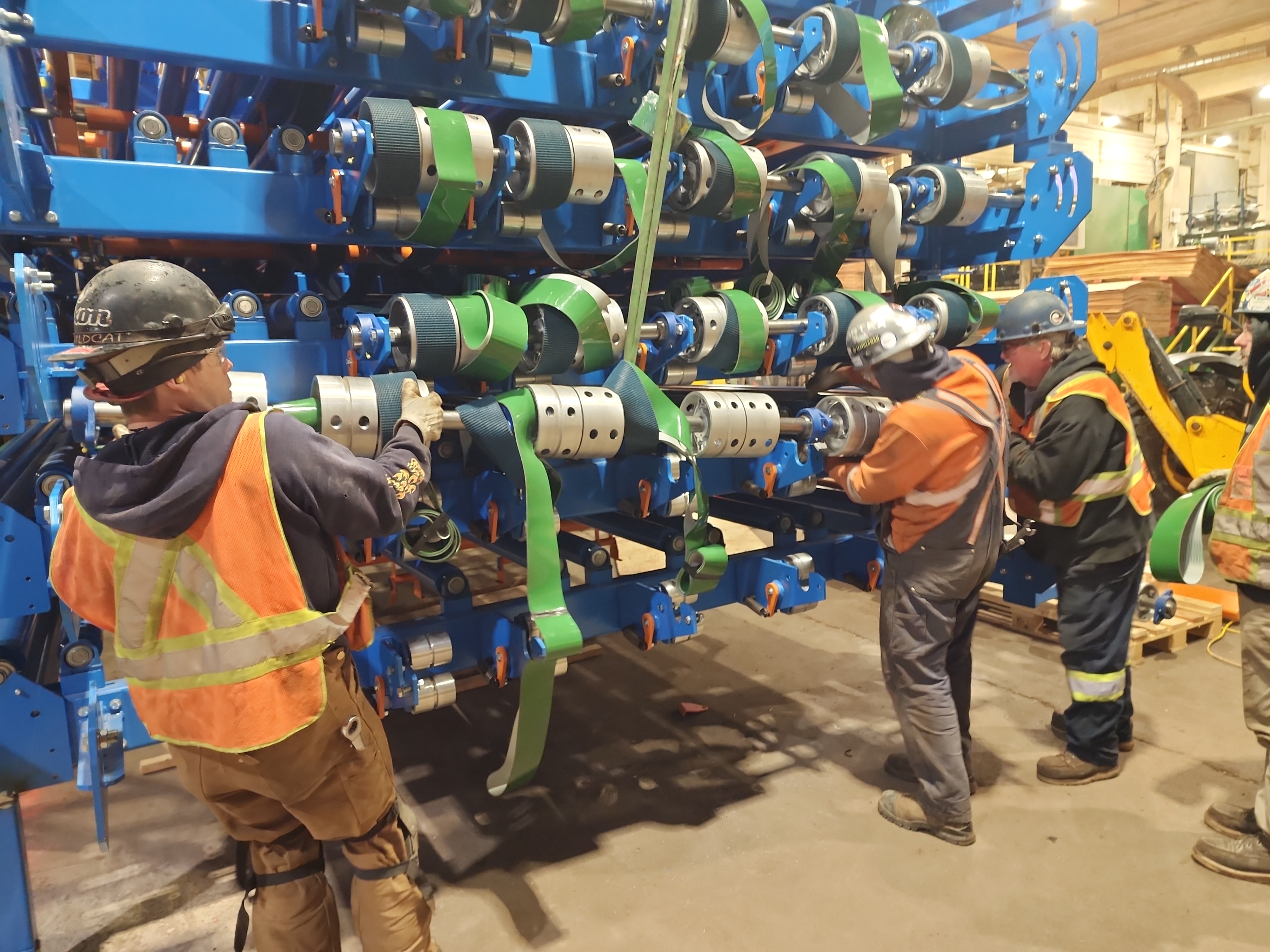

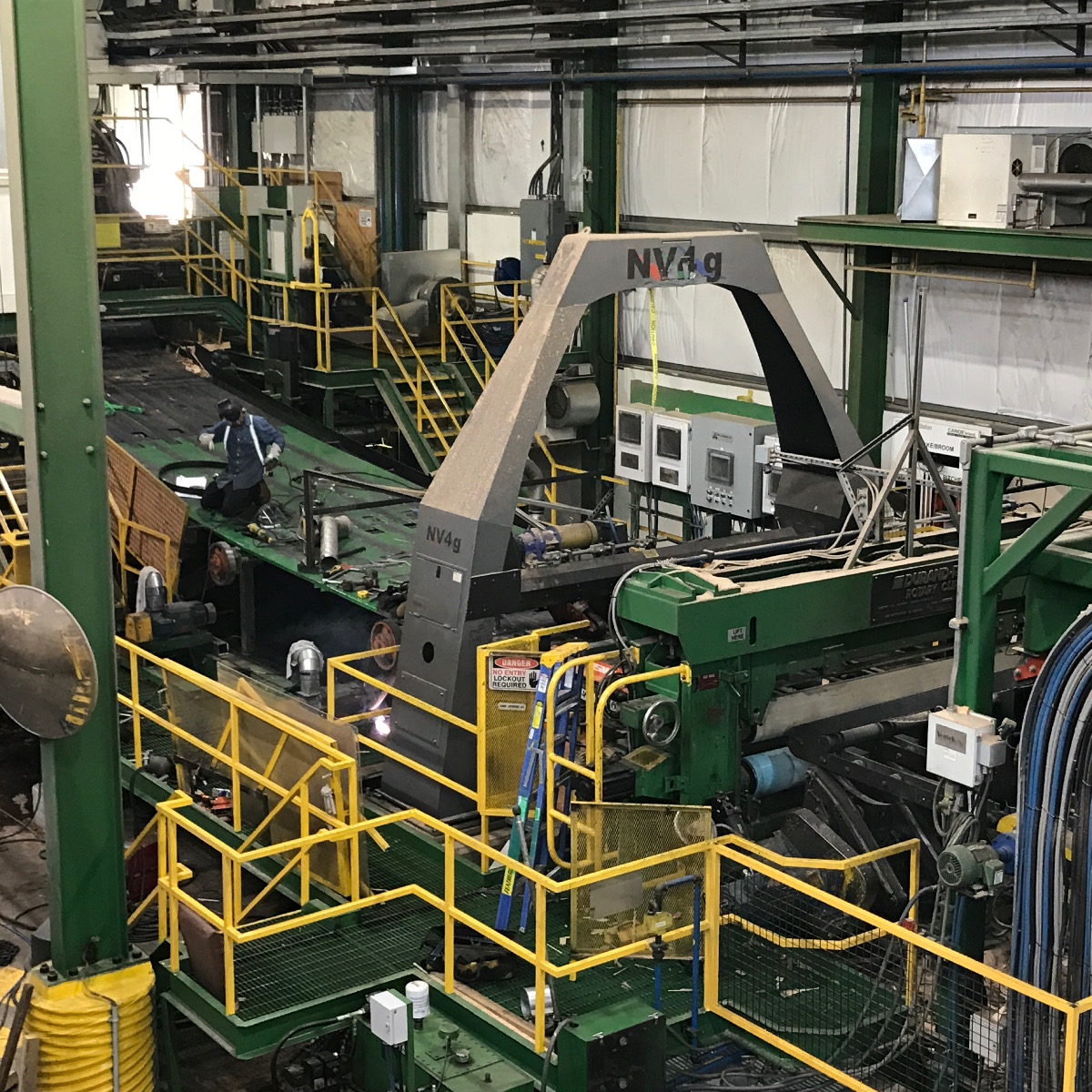

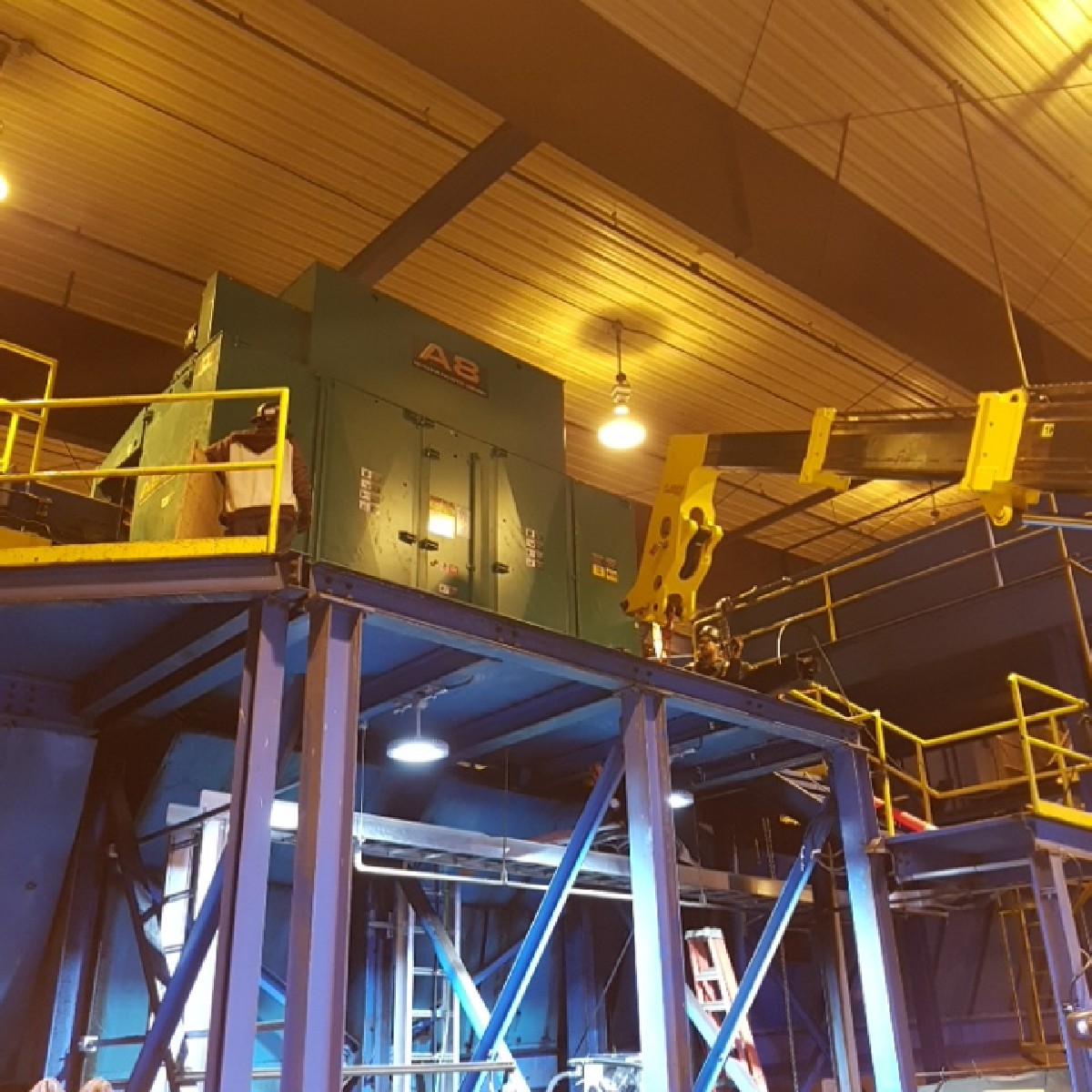

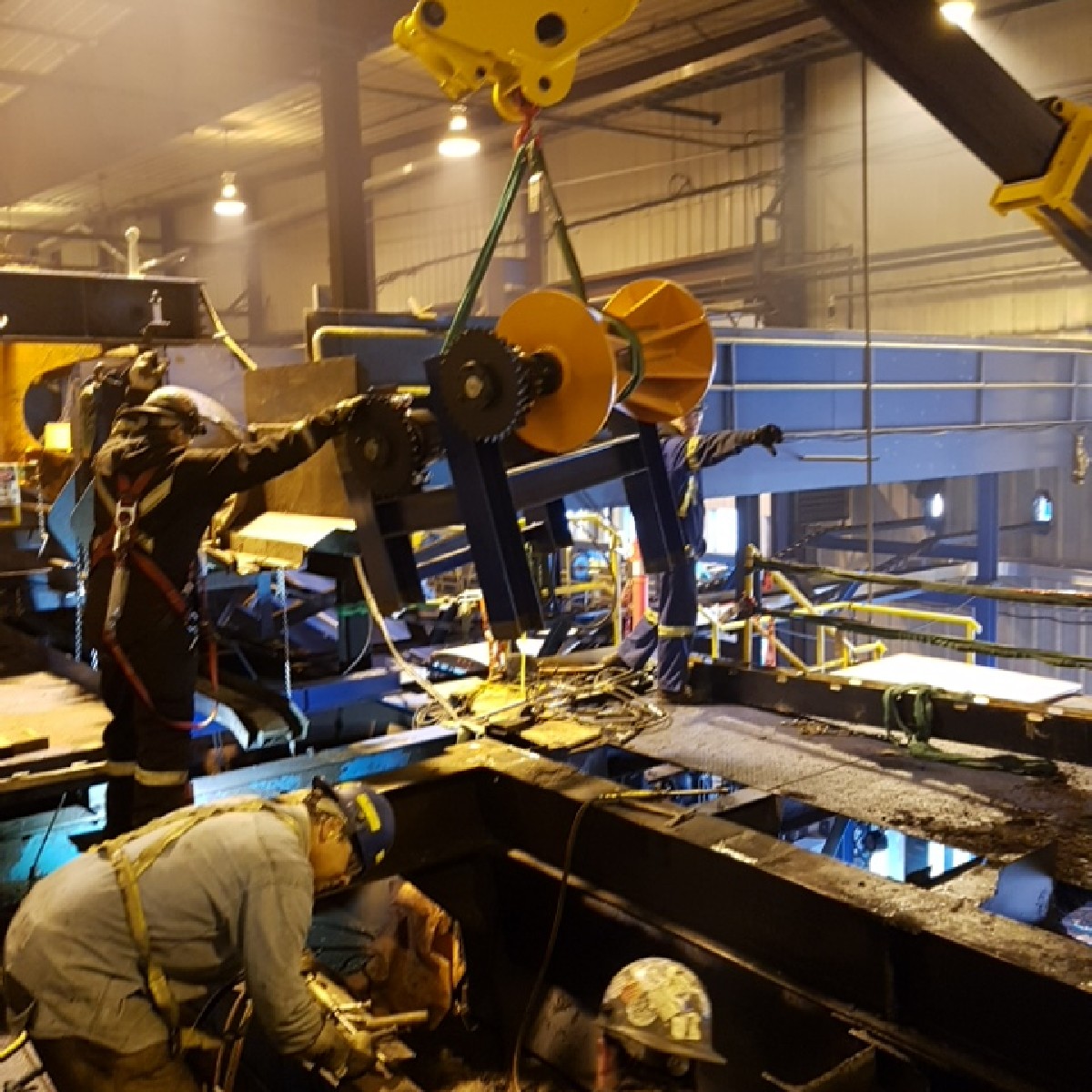

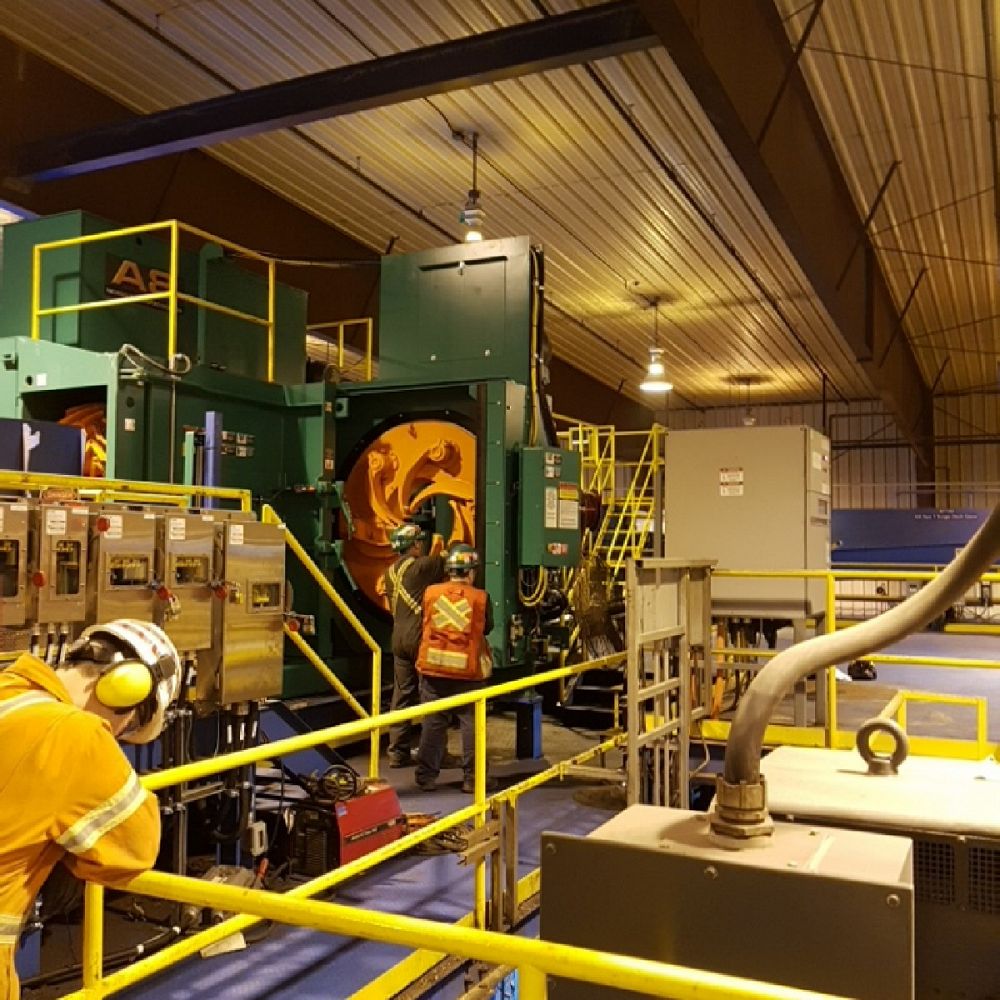

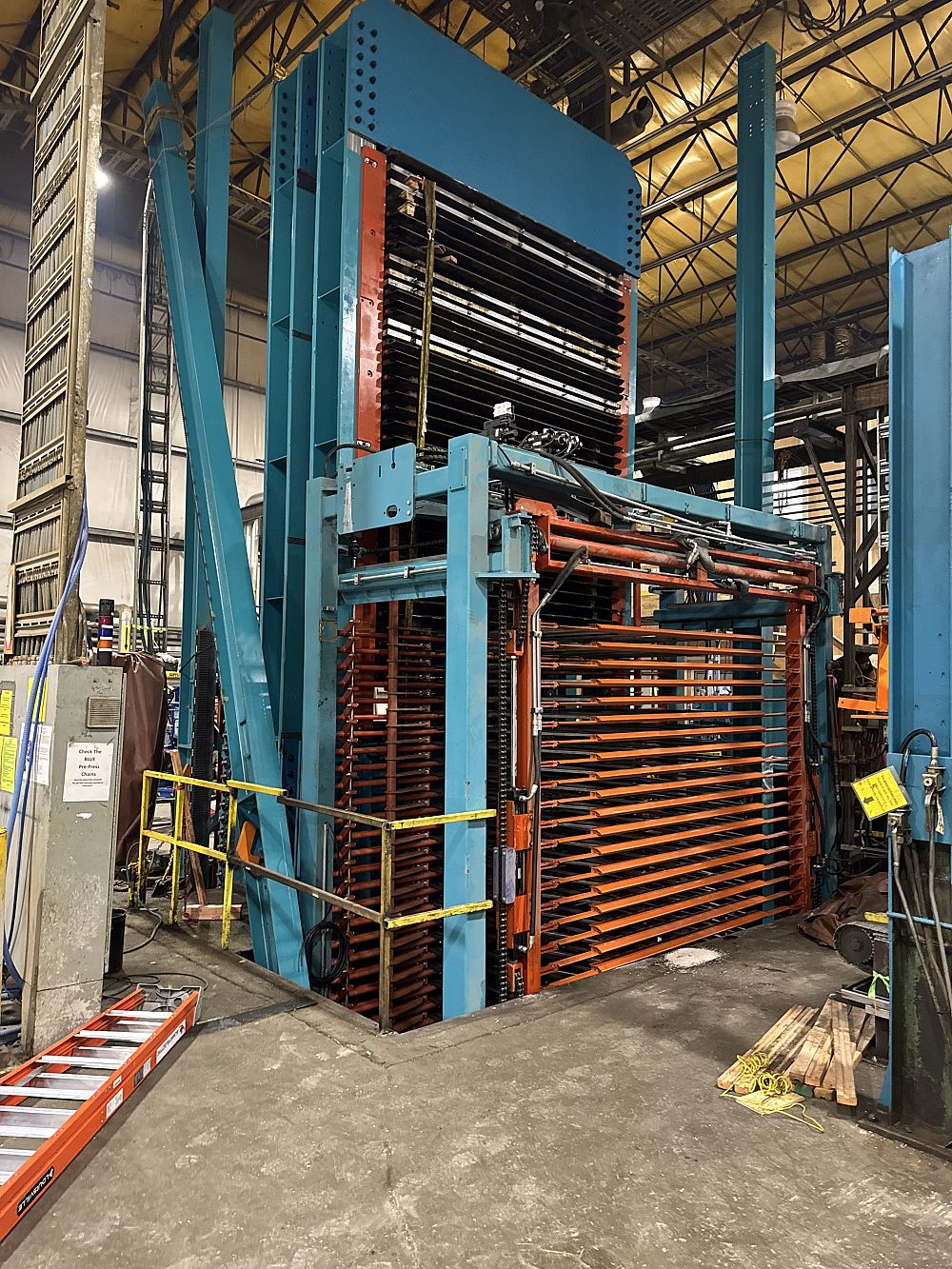

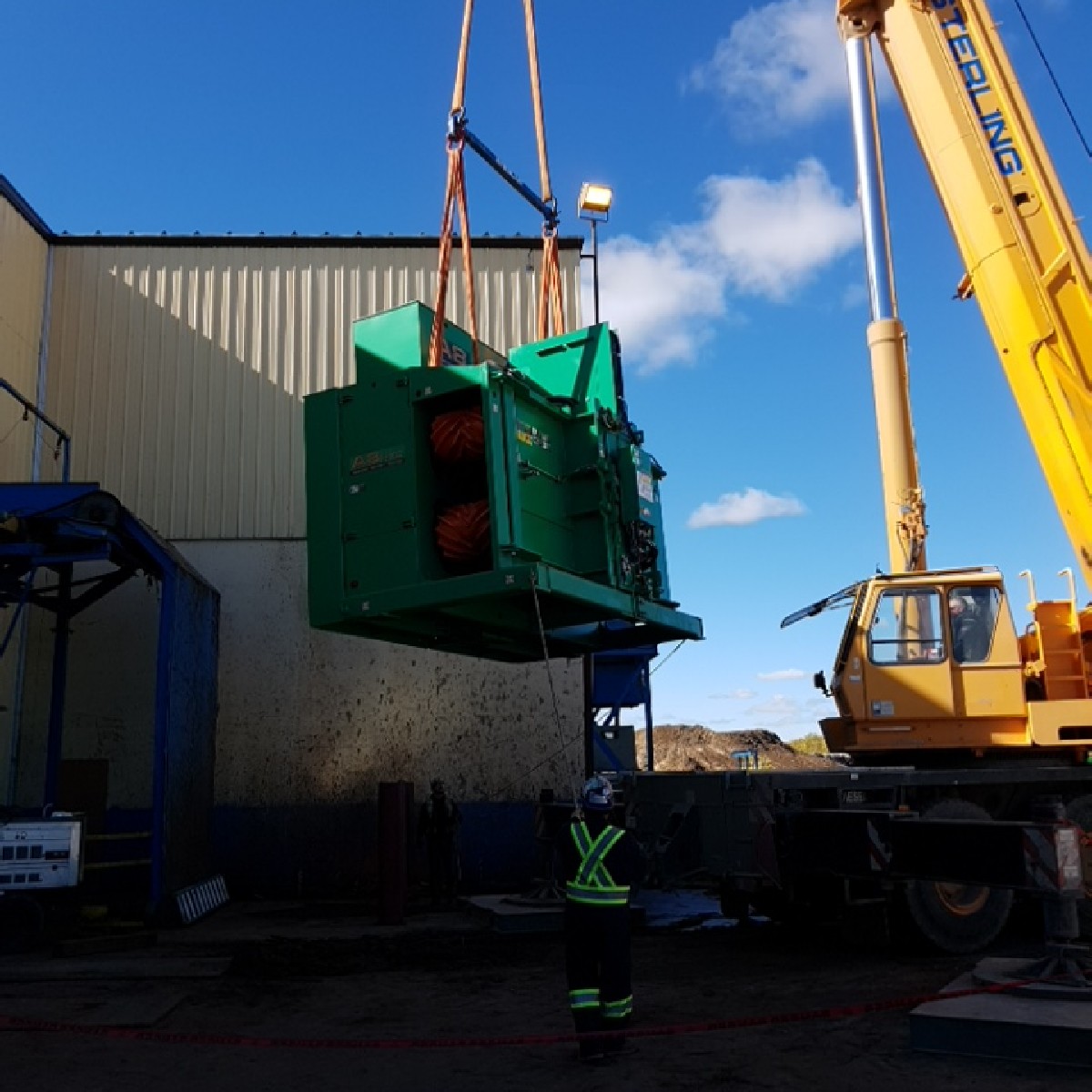

- Install new Debarker #2

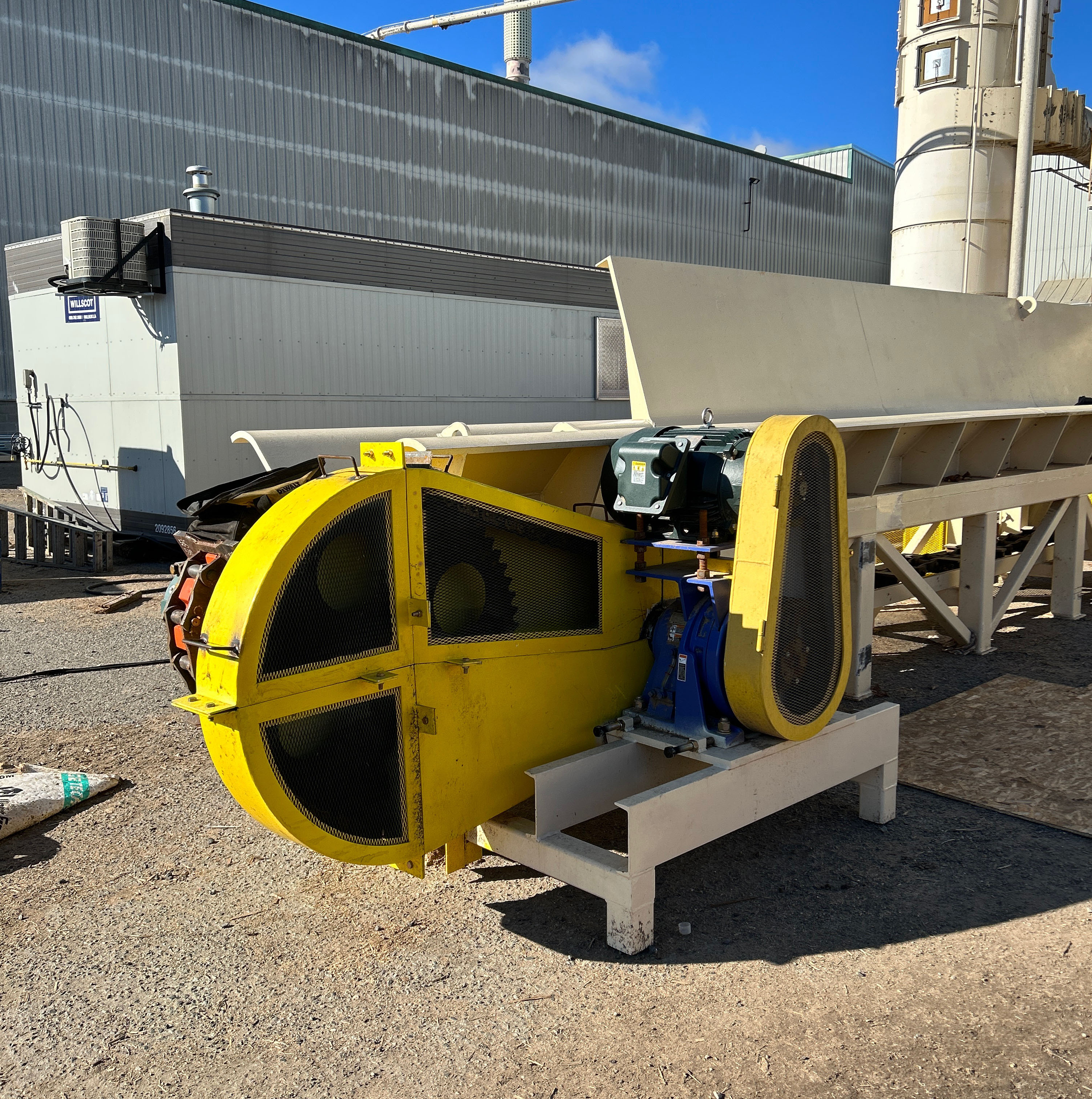

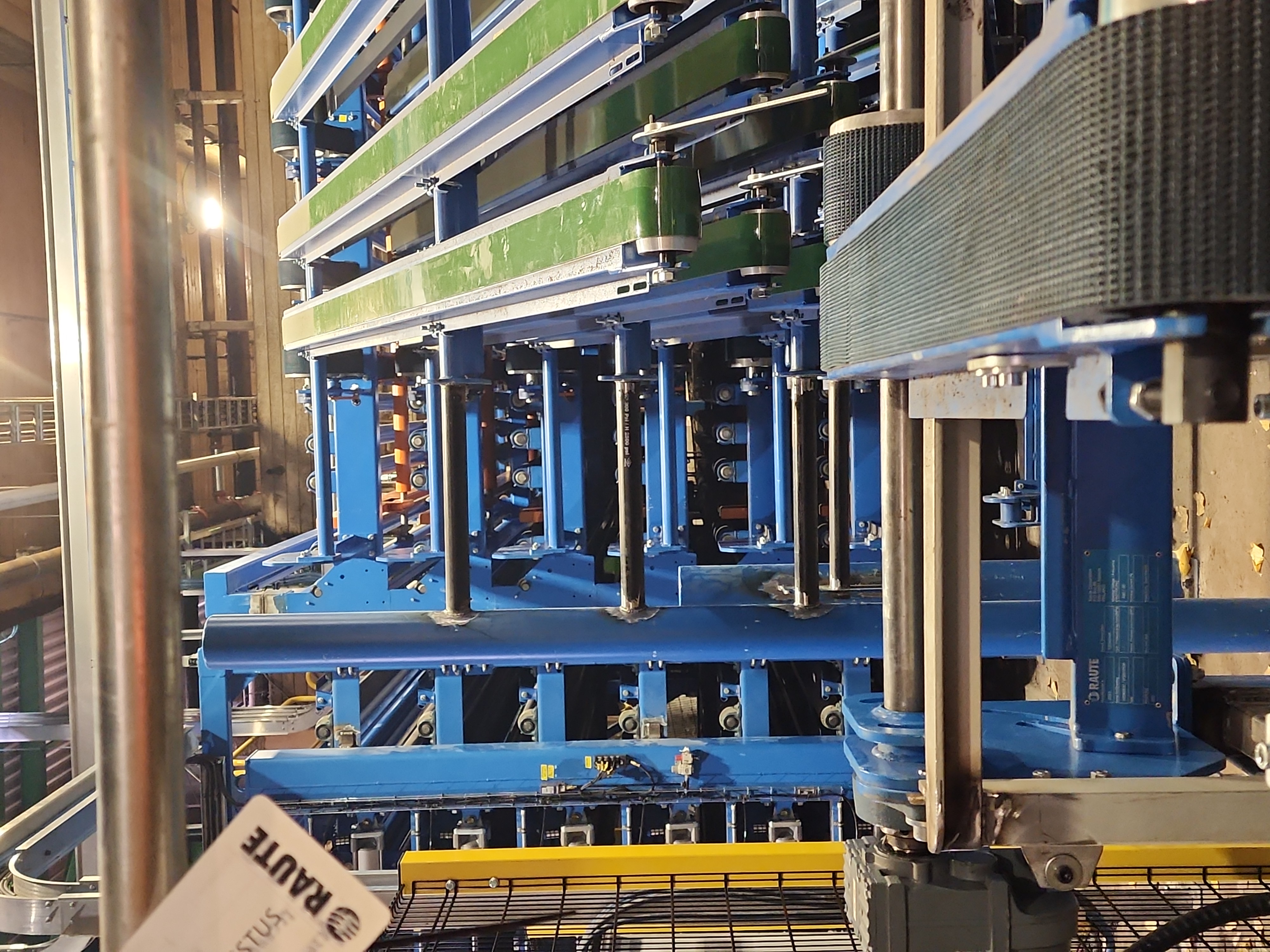

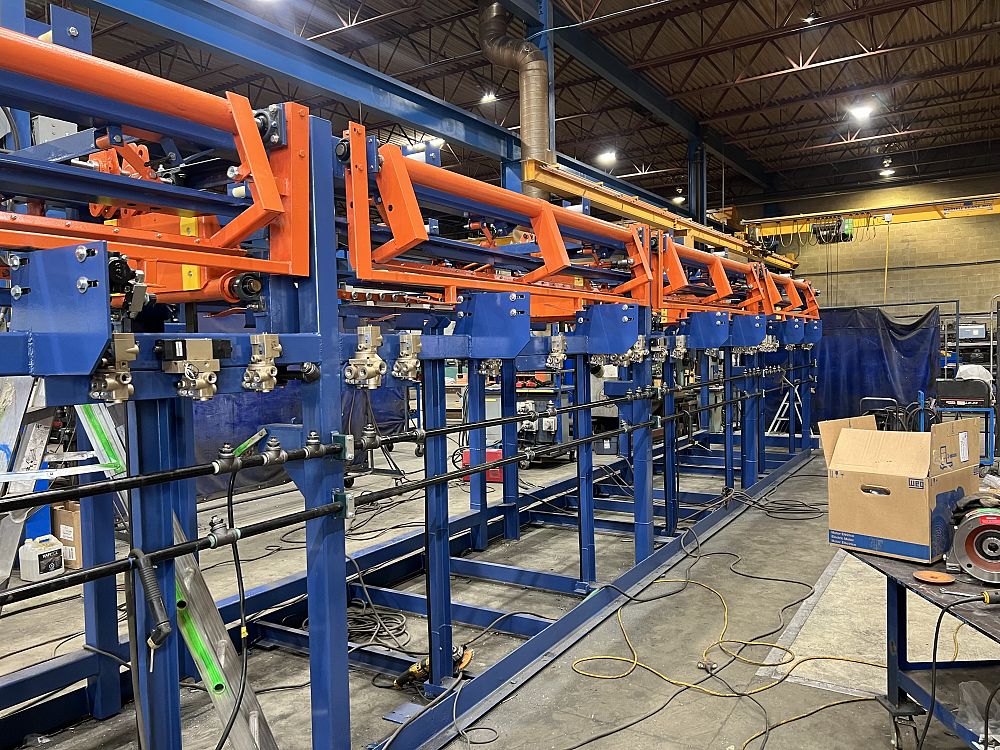

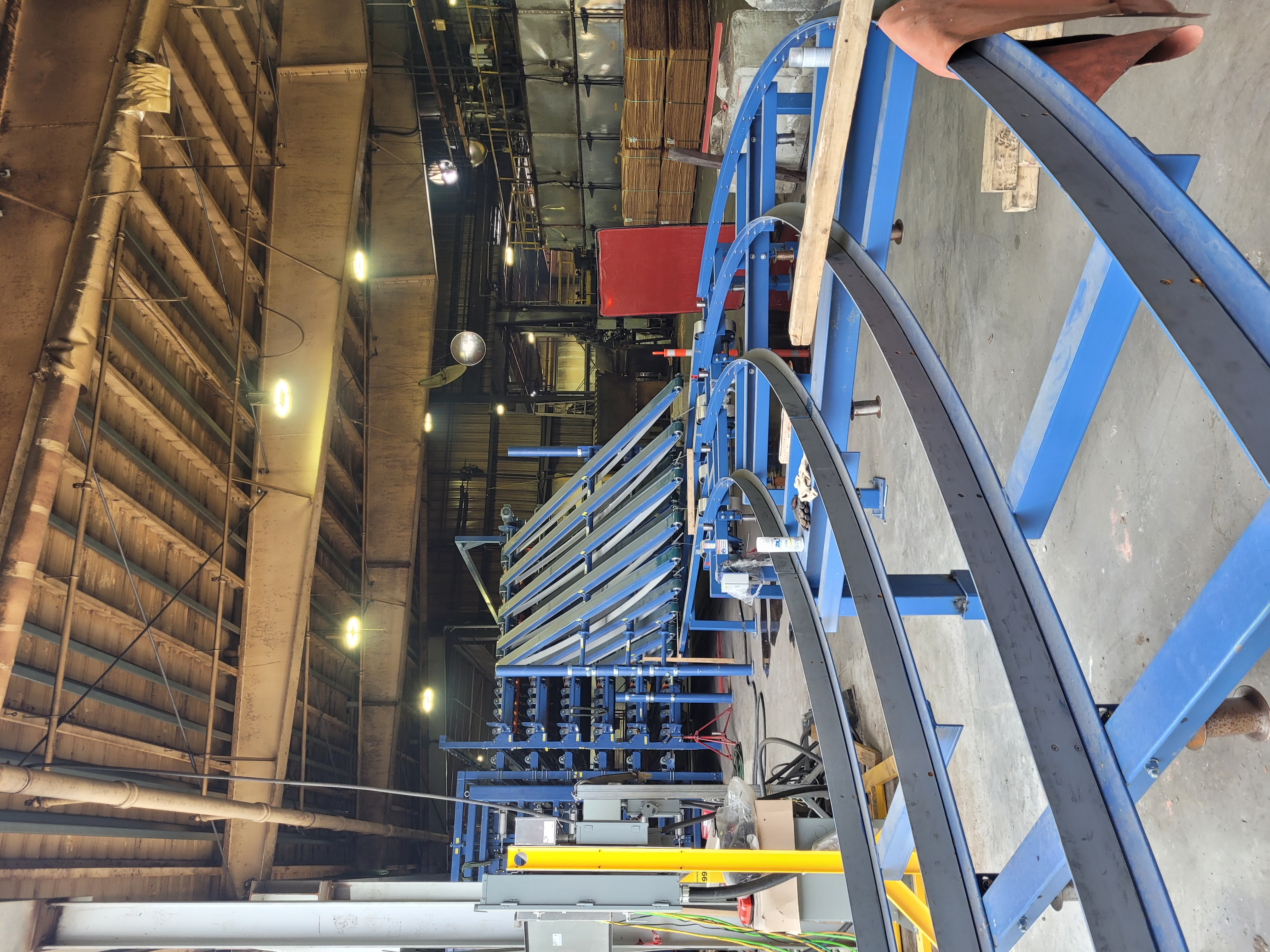

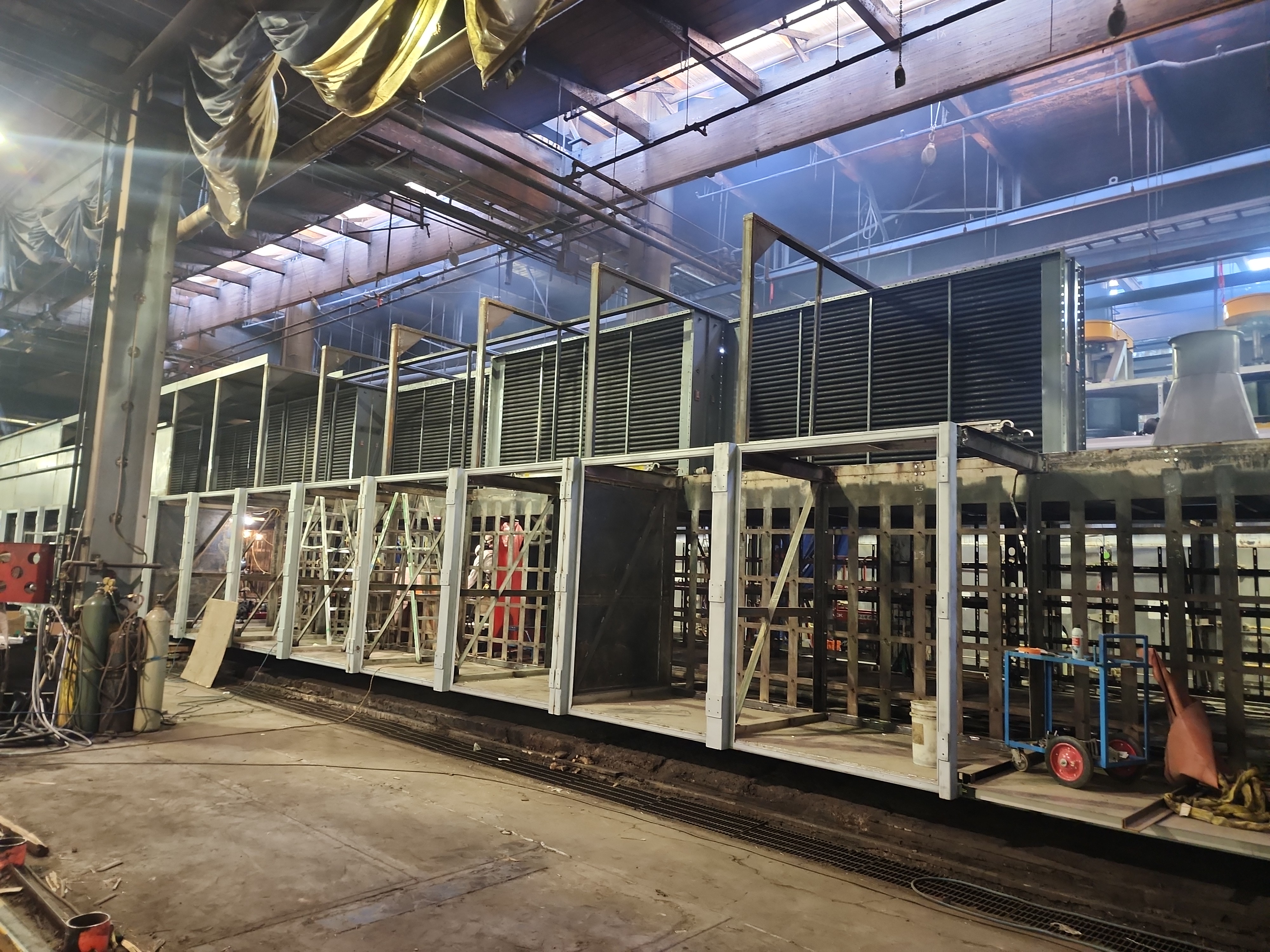

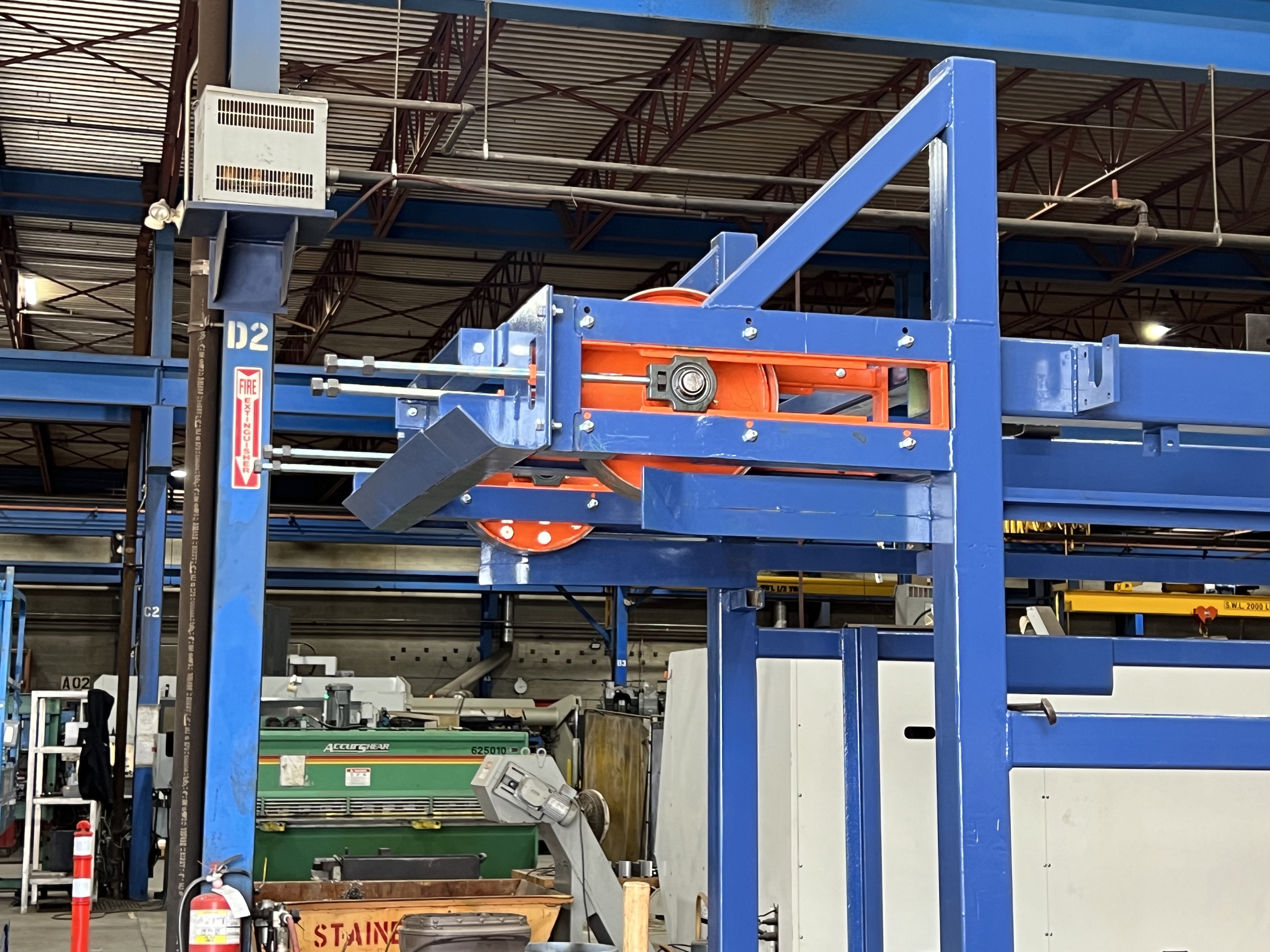

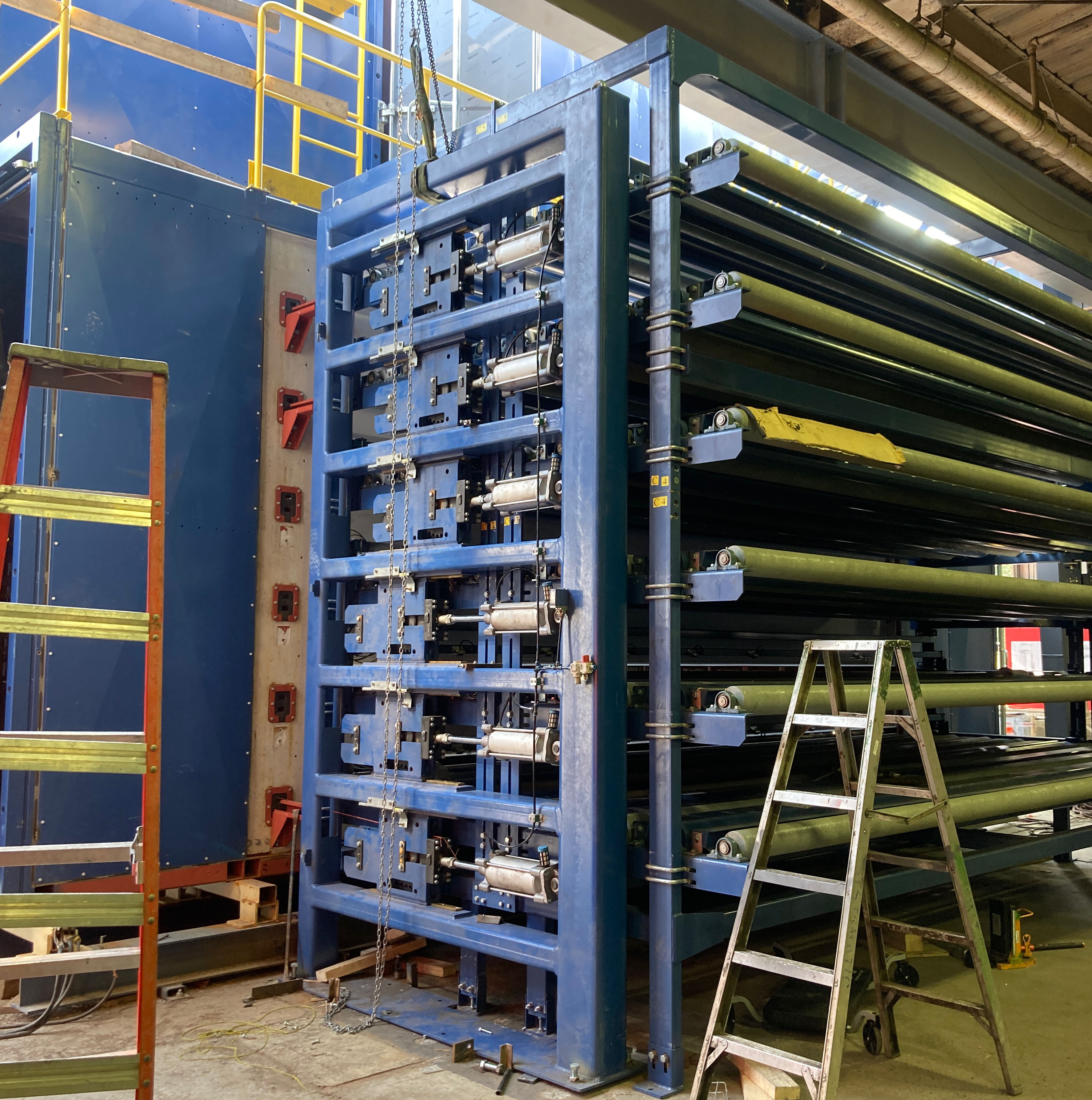

- Install new barker ring

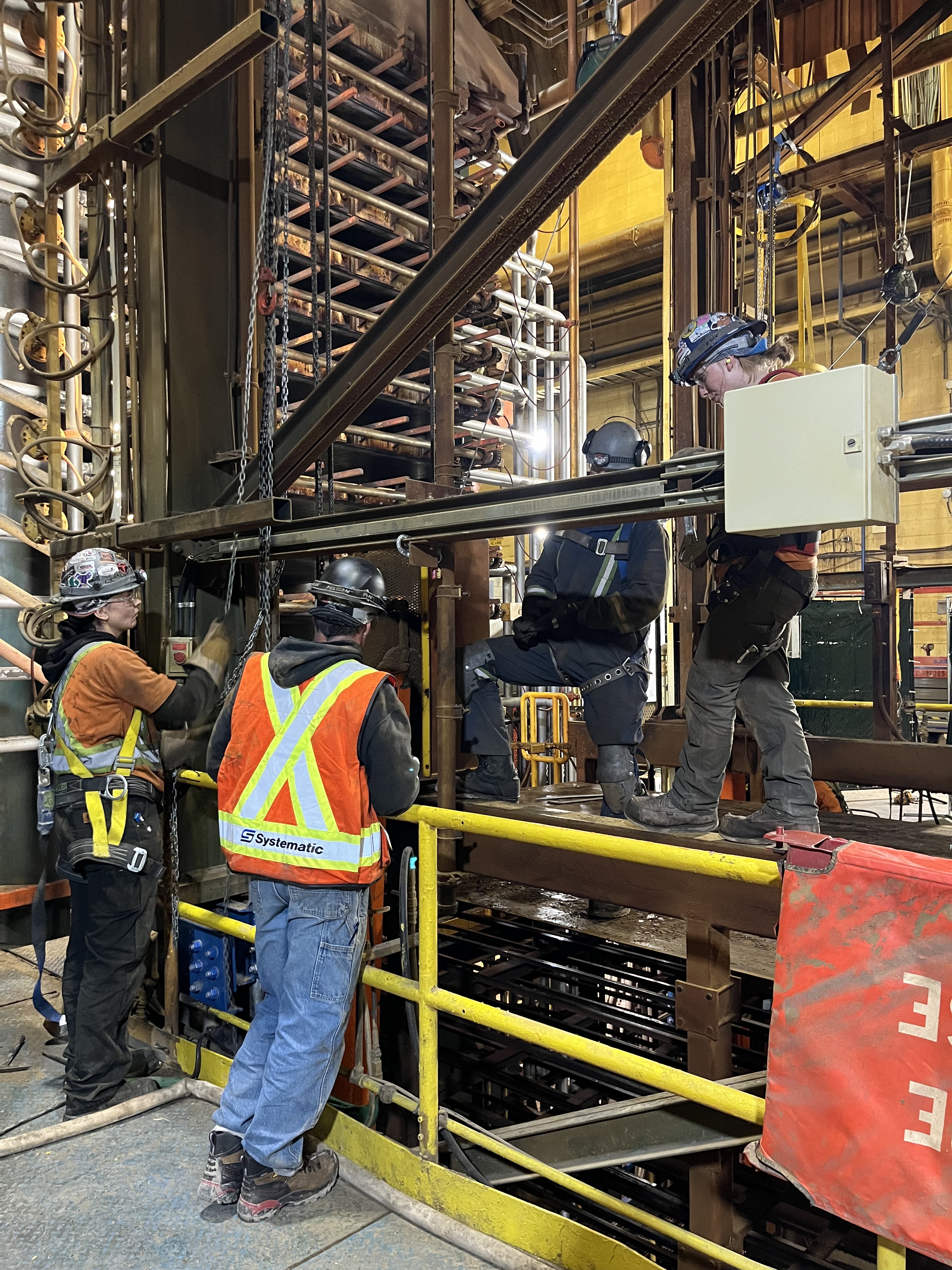

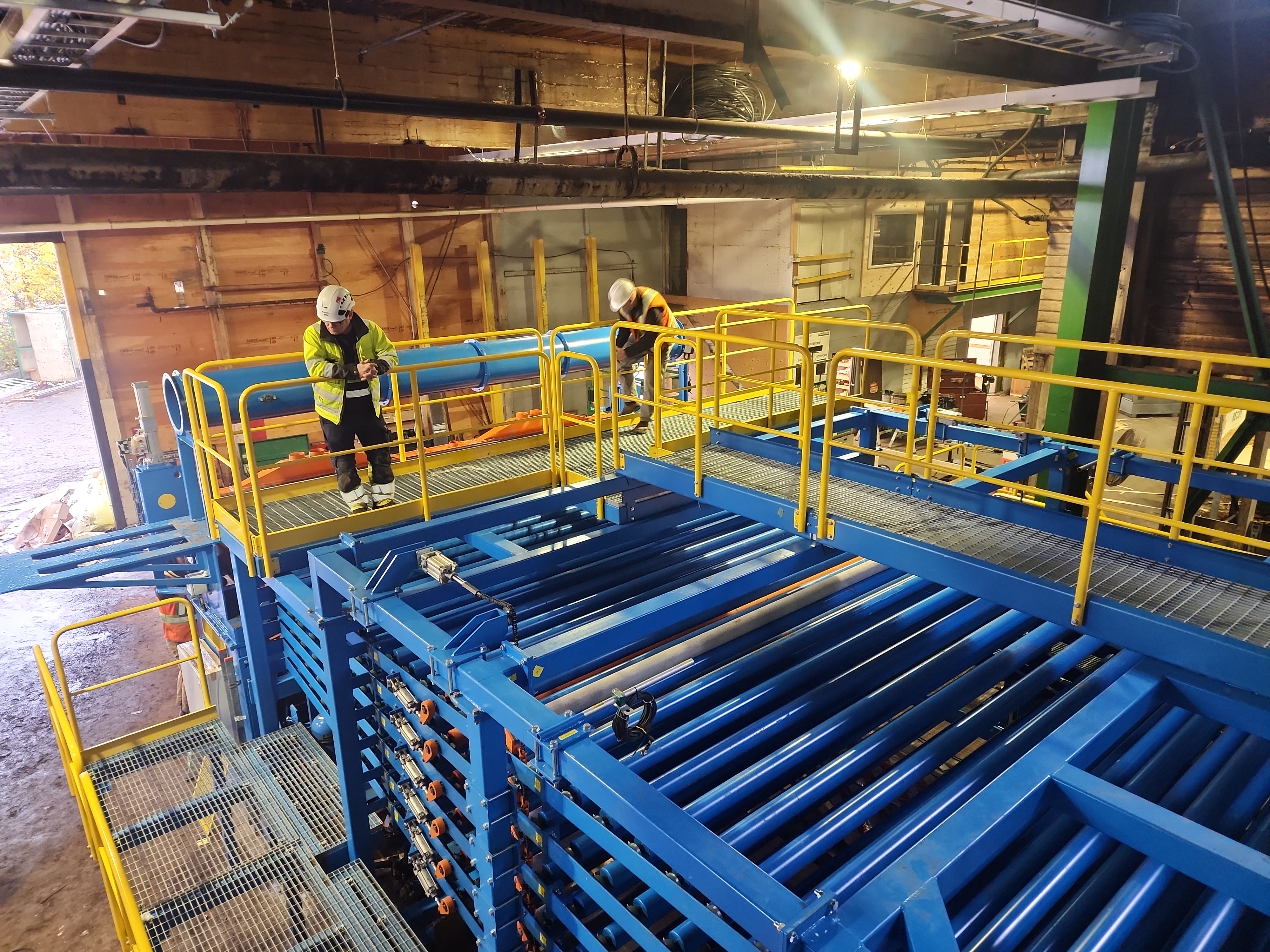

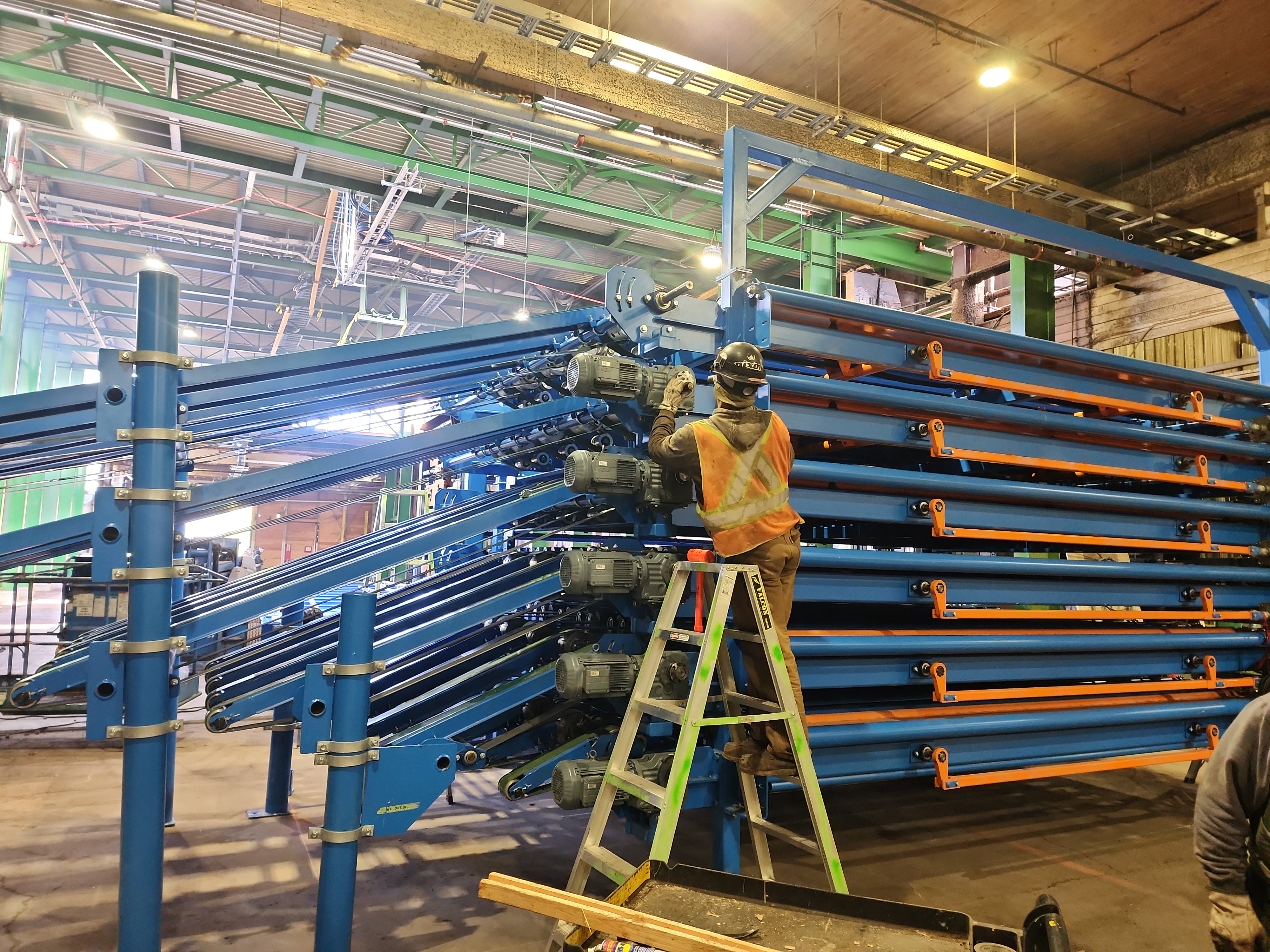

- Reinstall modified platform and stair assemblies

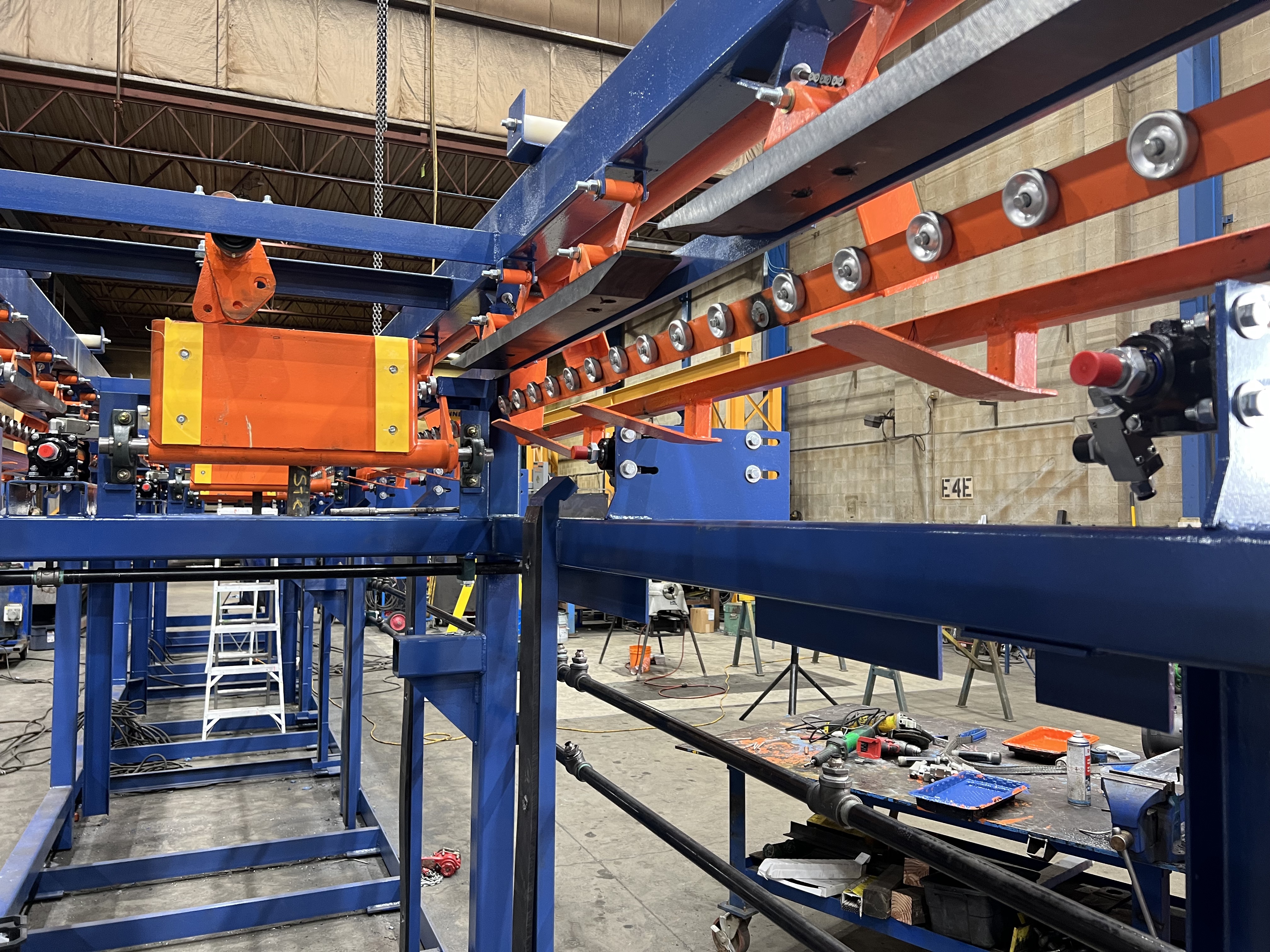

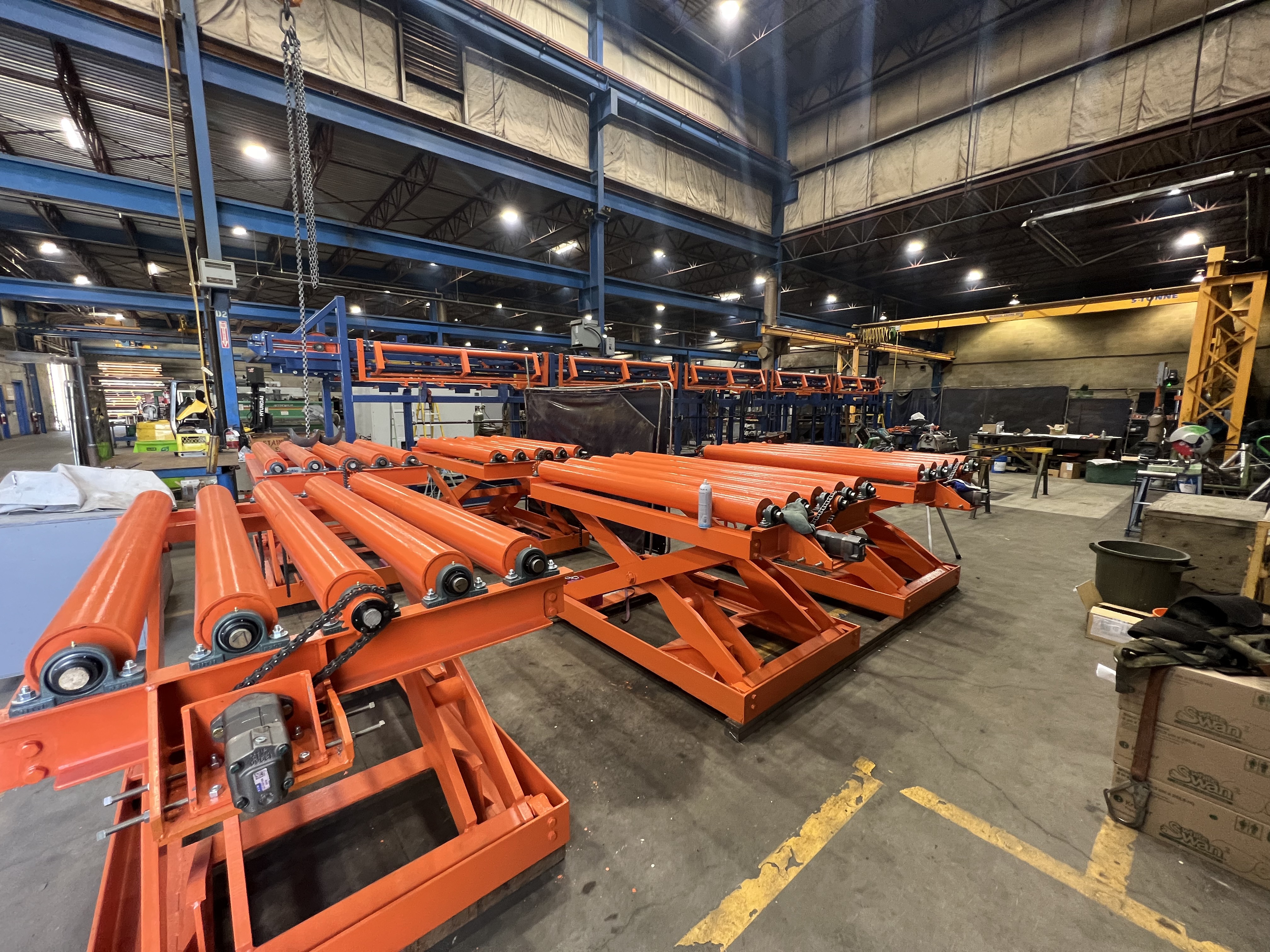

Debarker Auxiliary Equipment and Piping Installation:

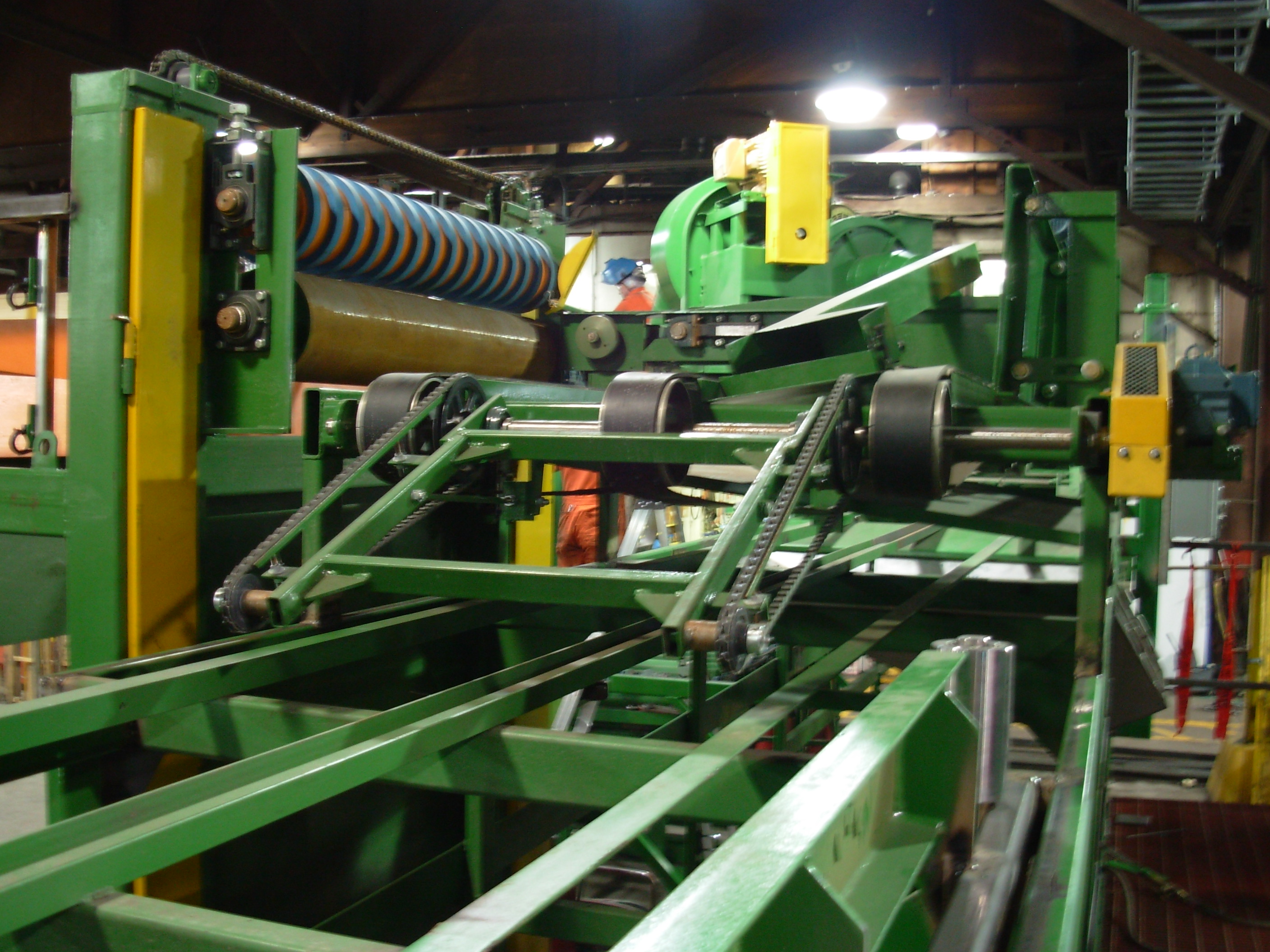

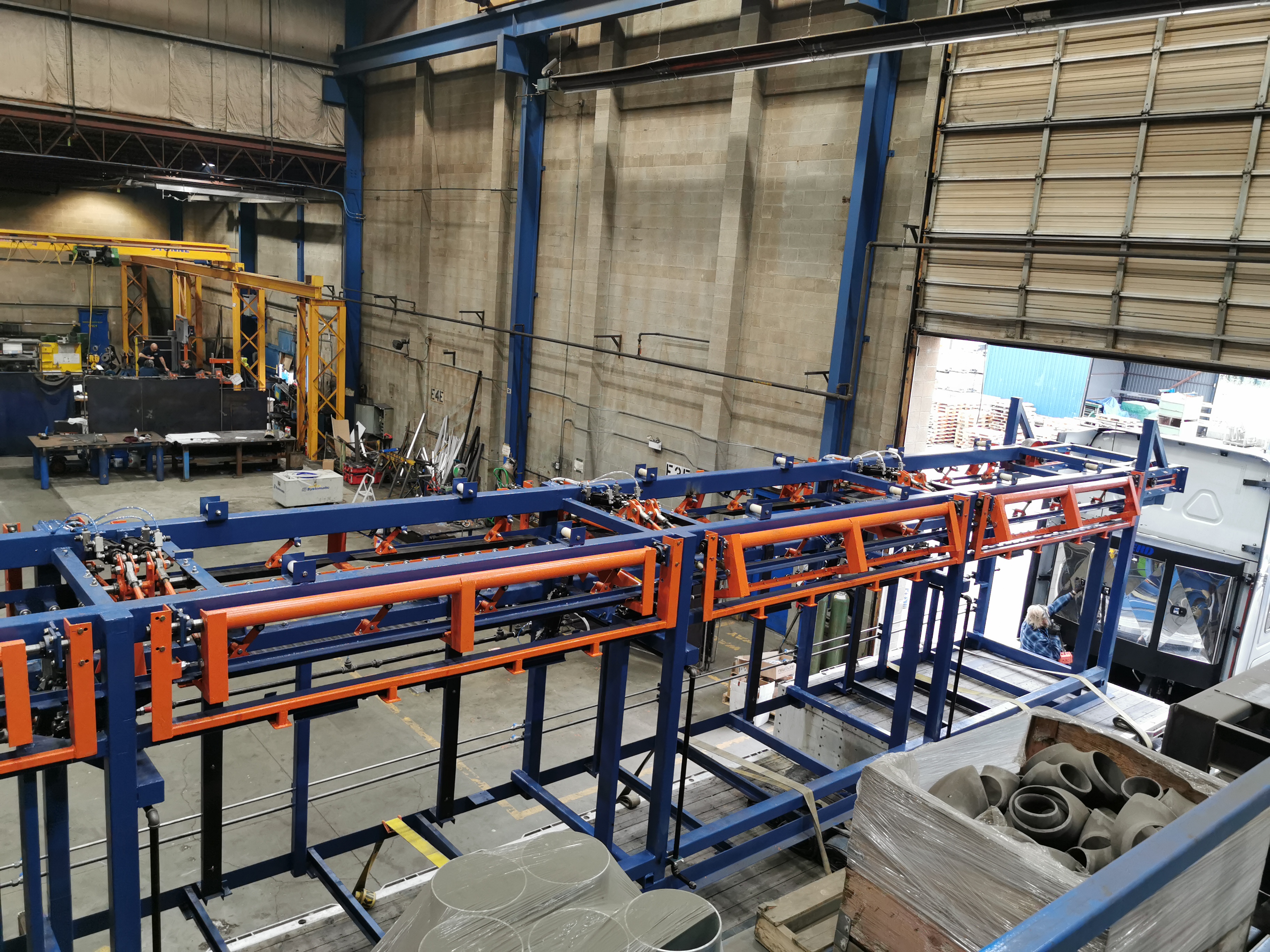

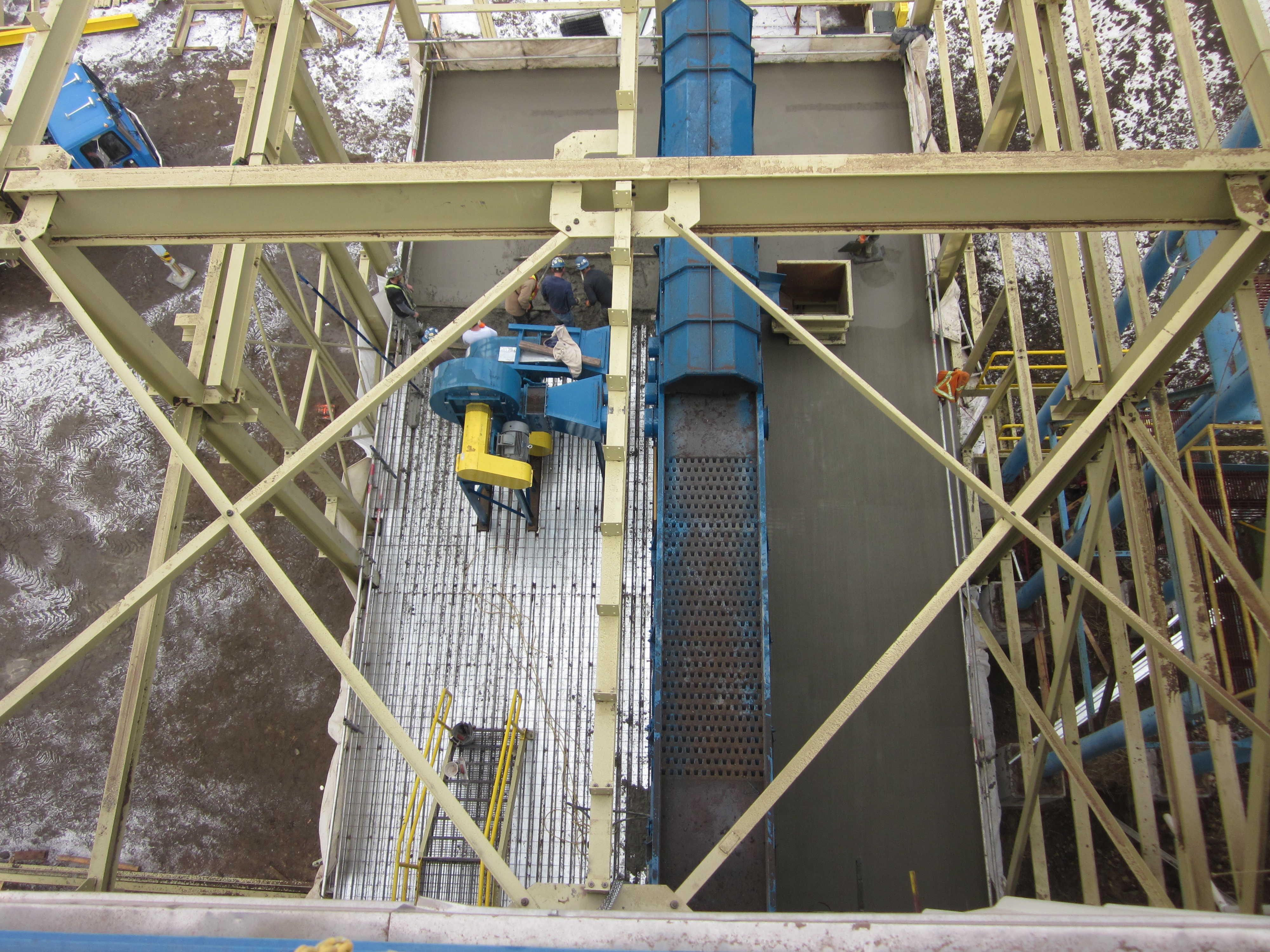

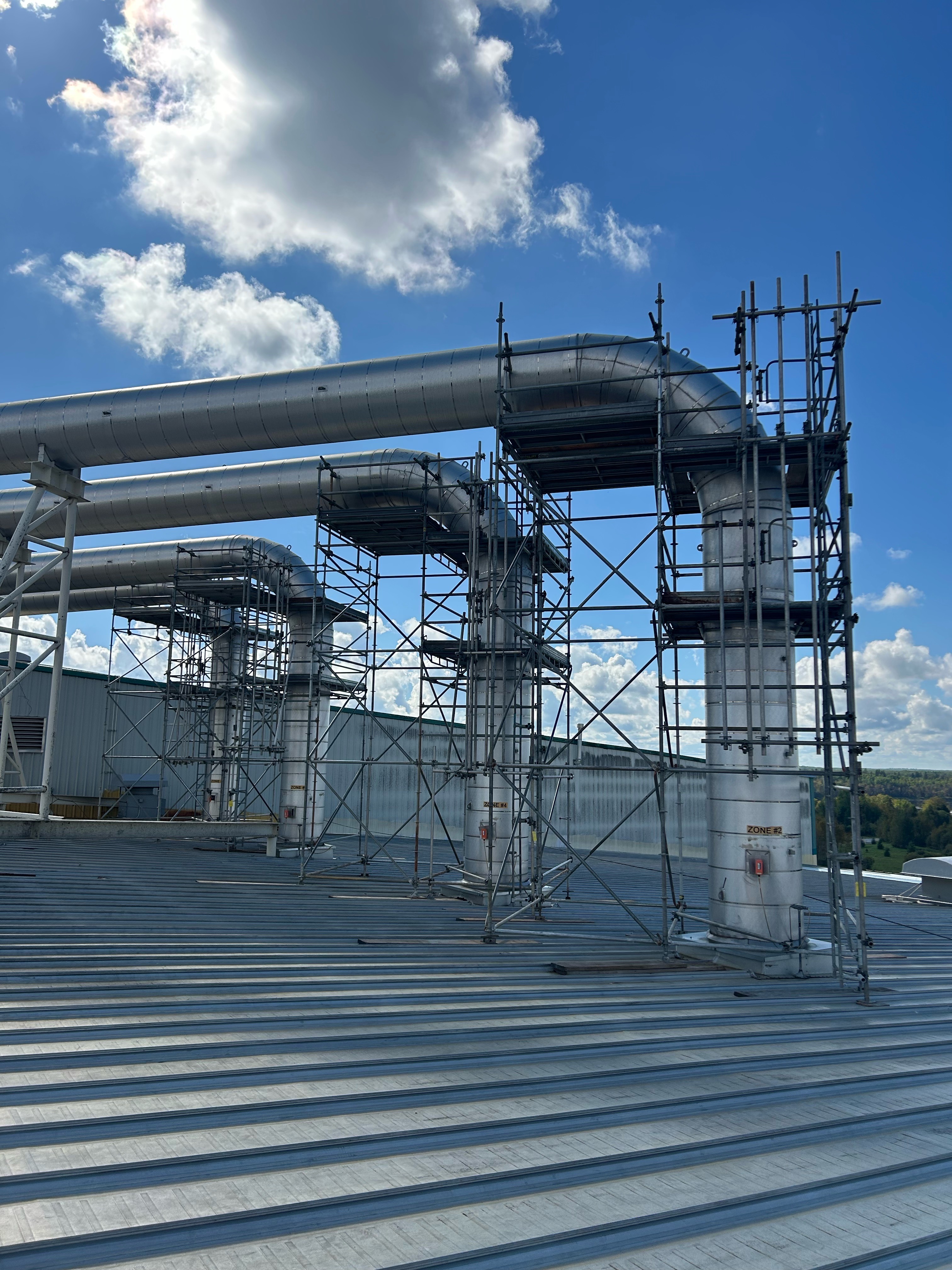

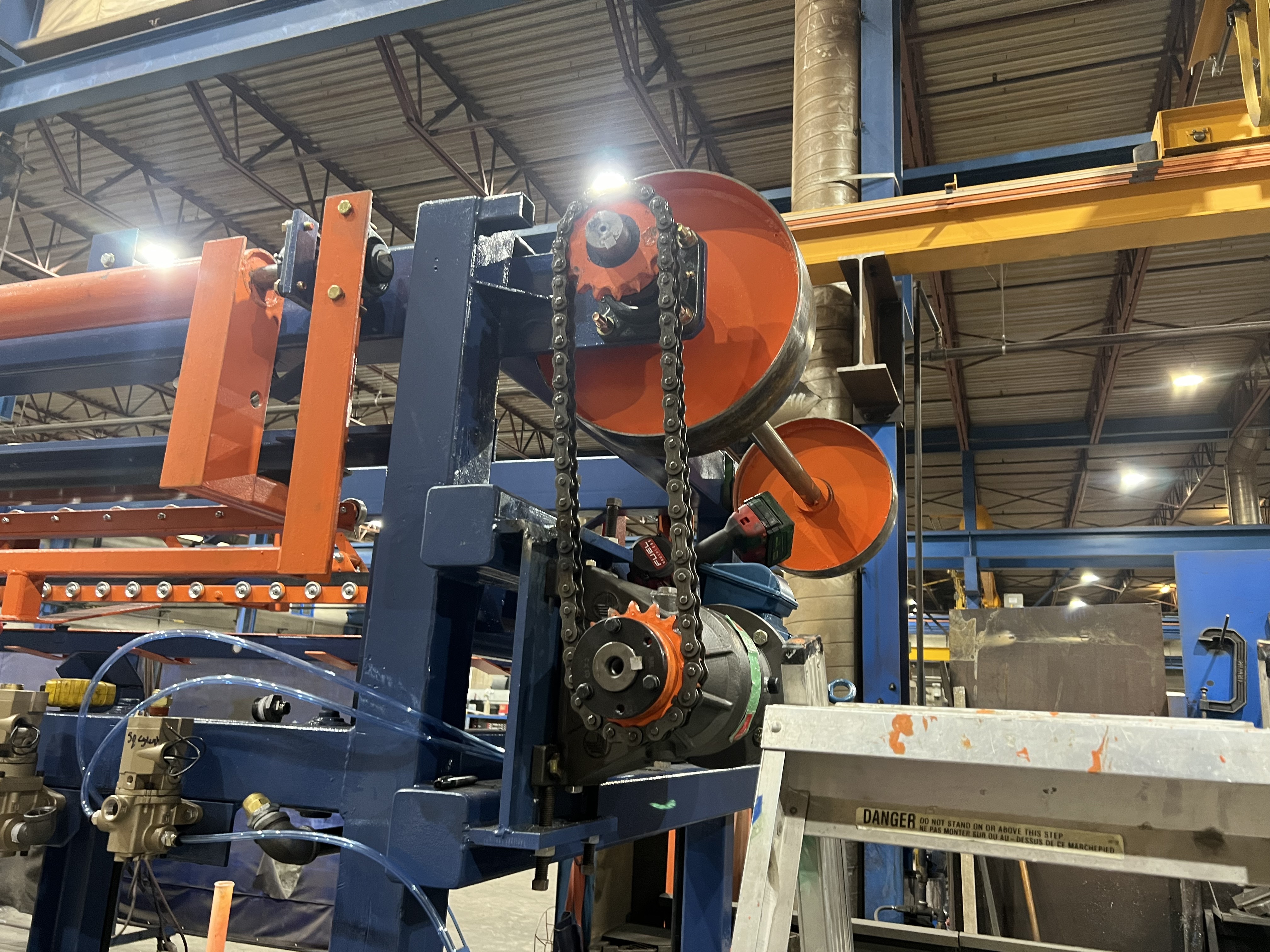

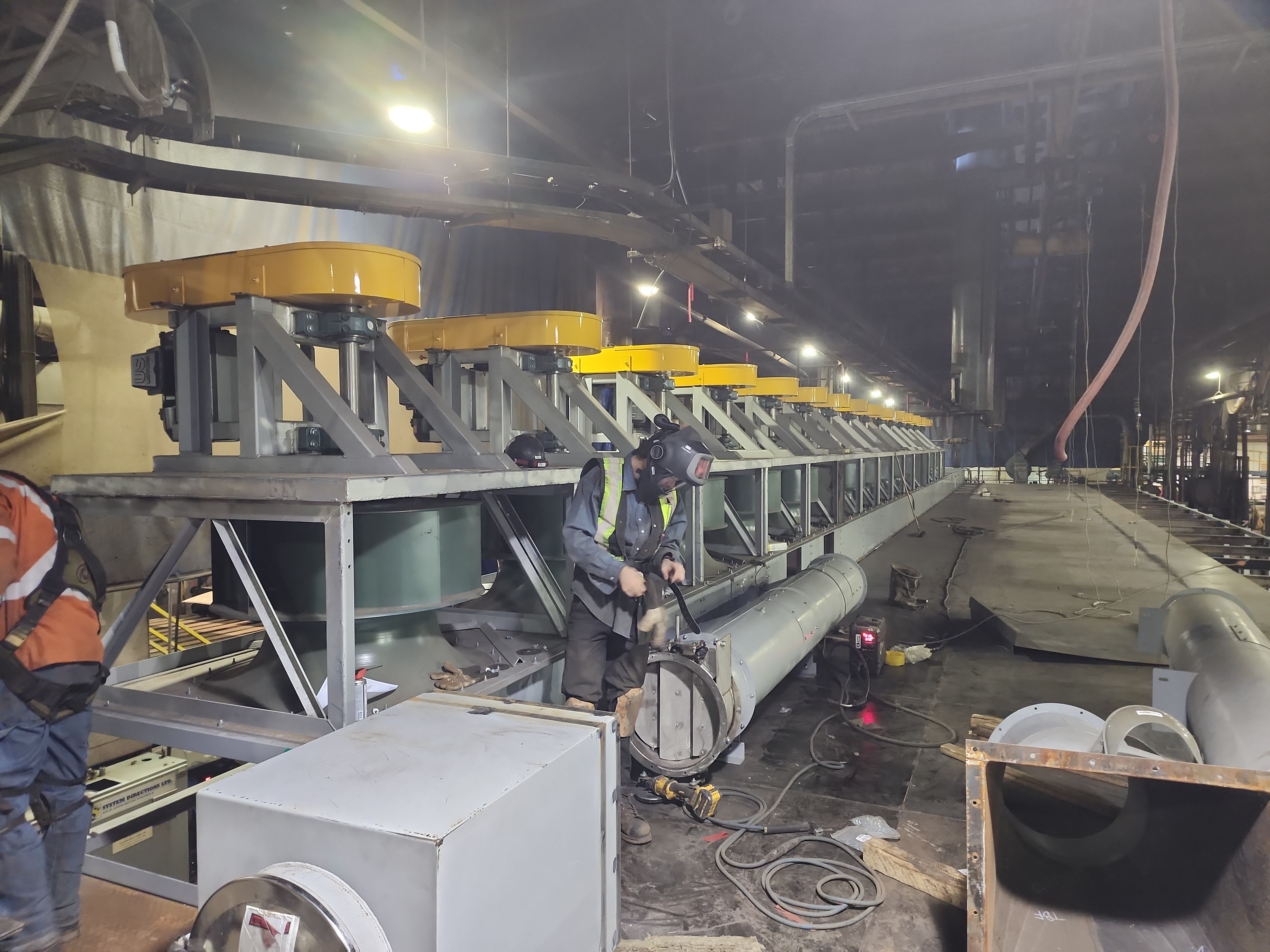

- Modify infeed conveyor and install new centering roll

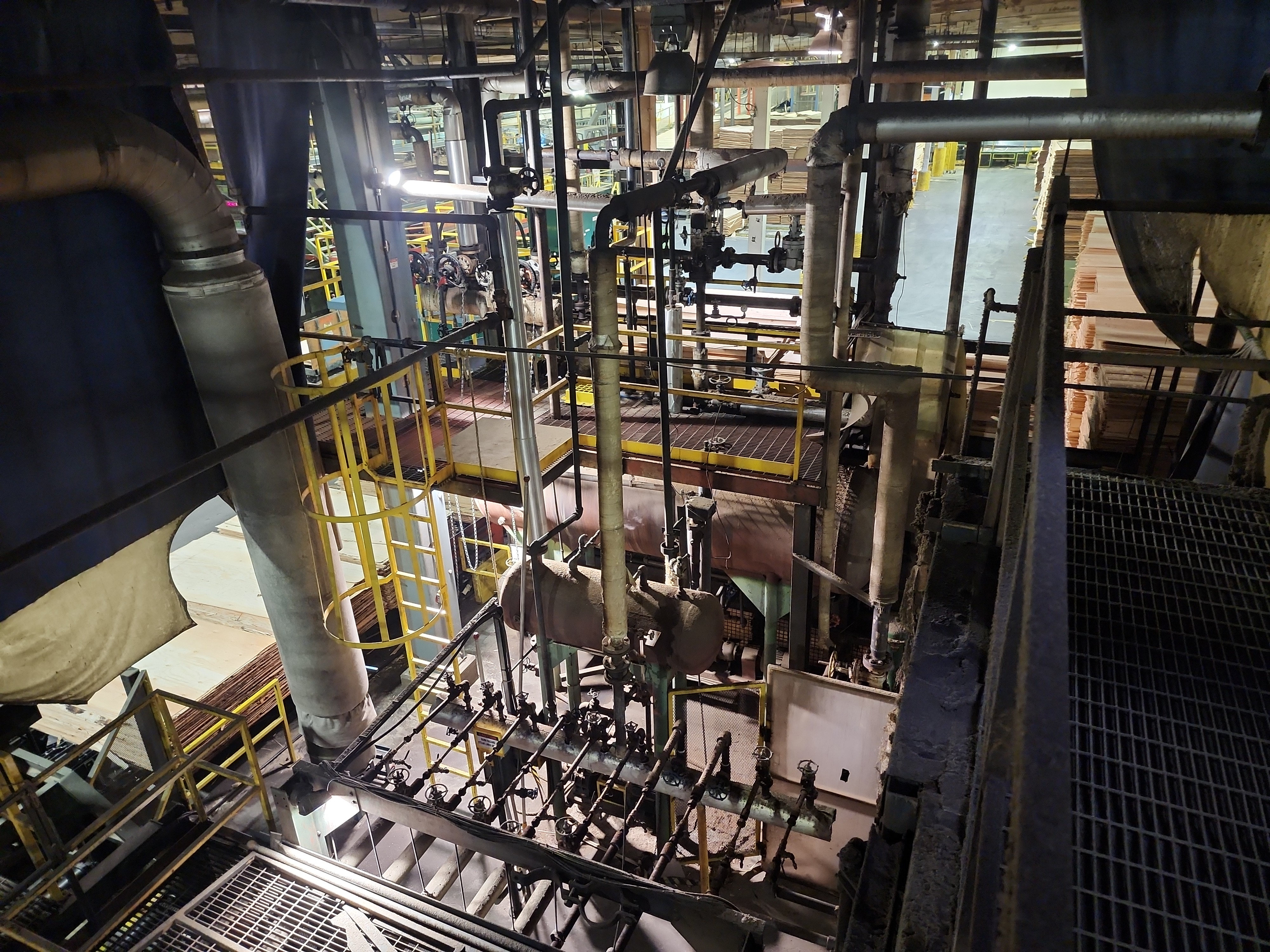

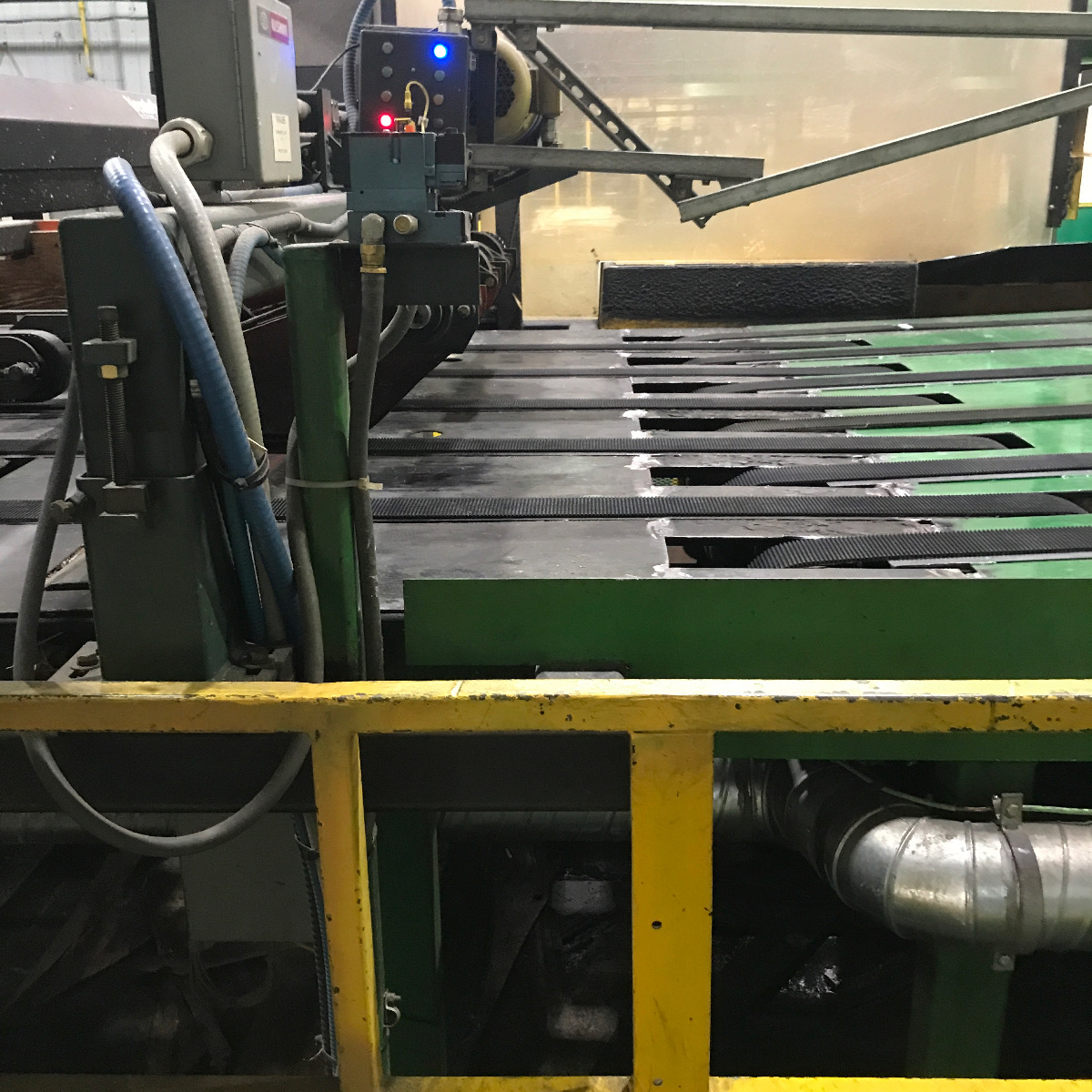

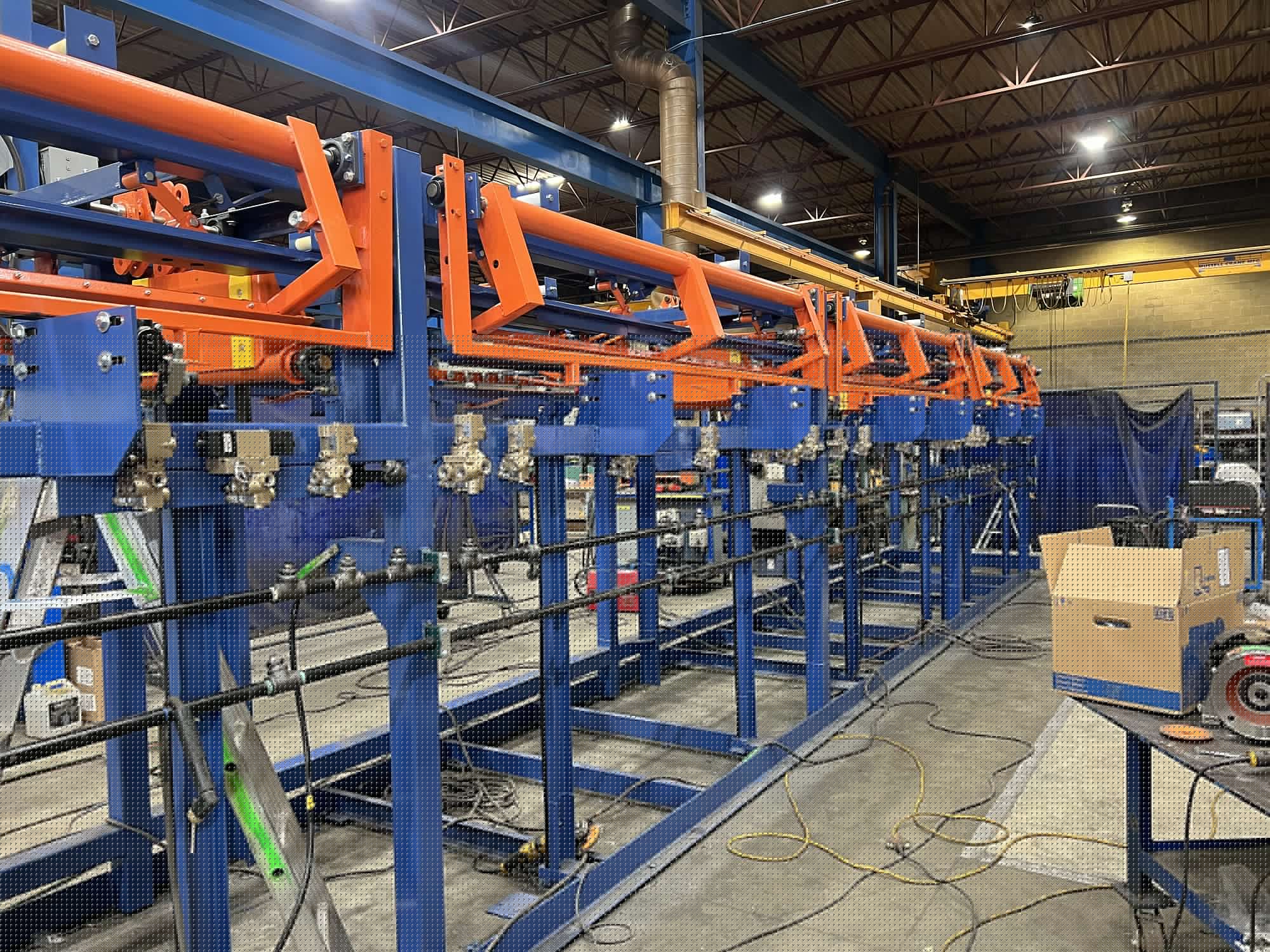

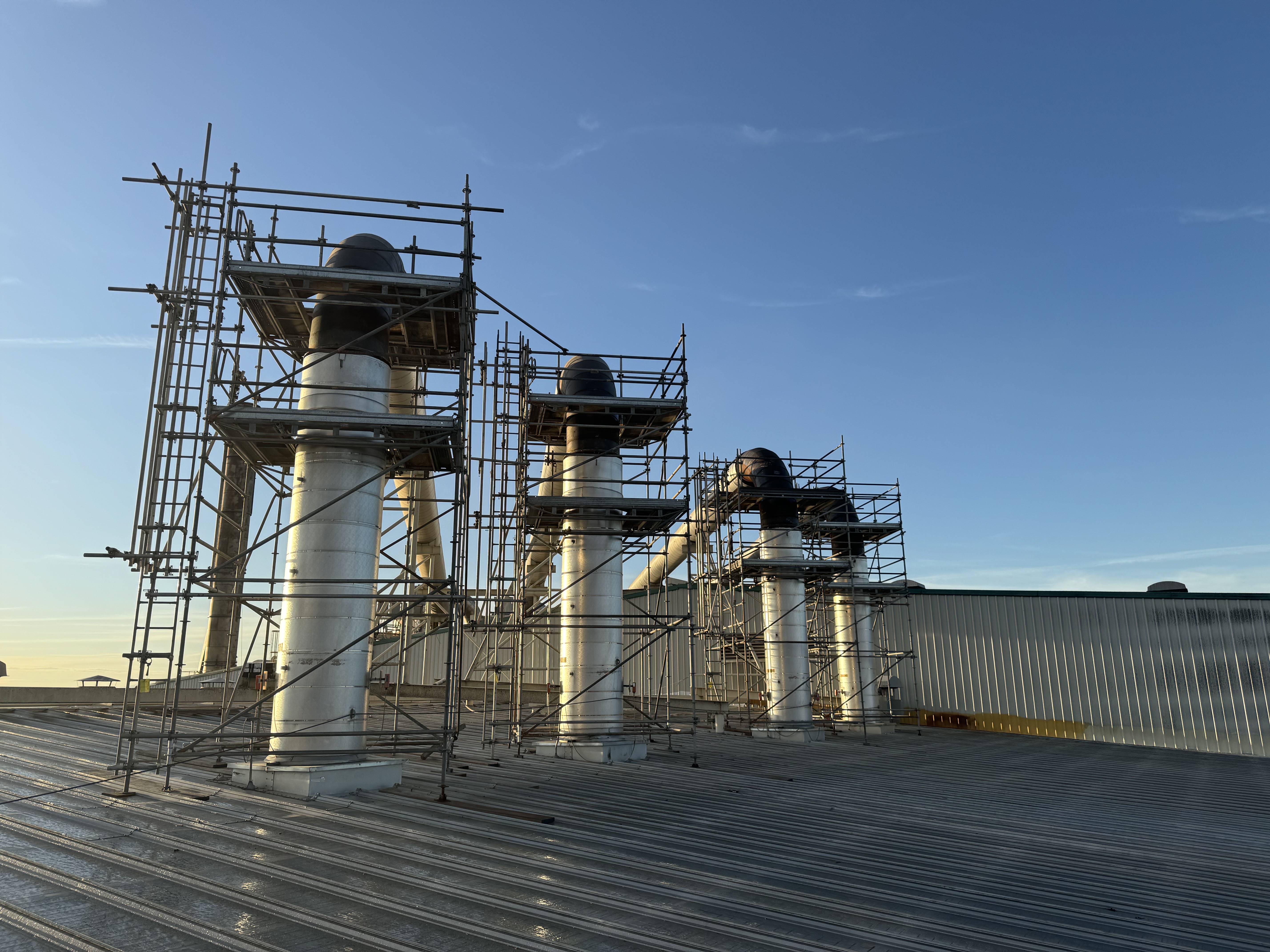

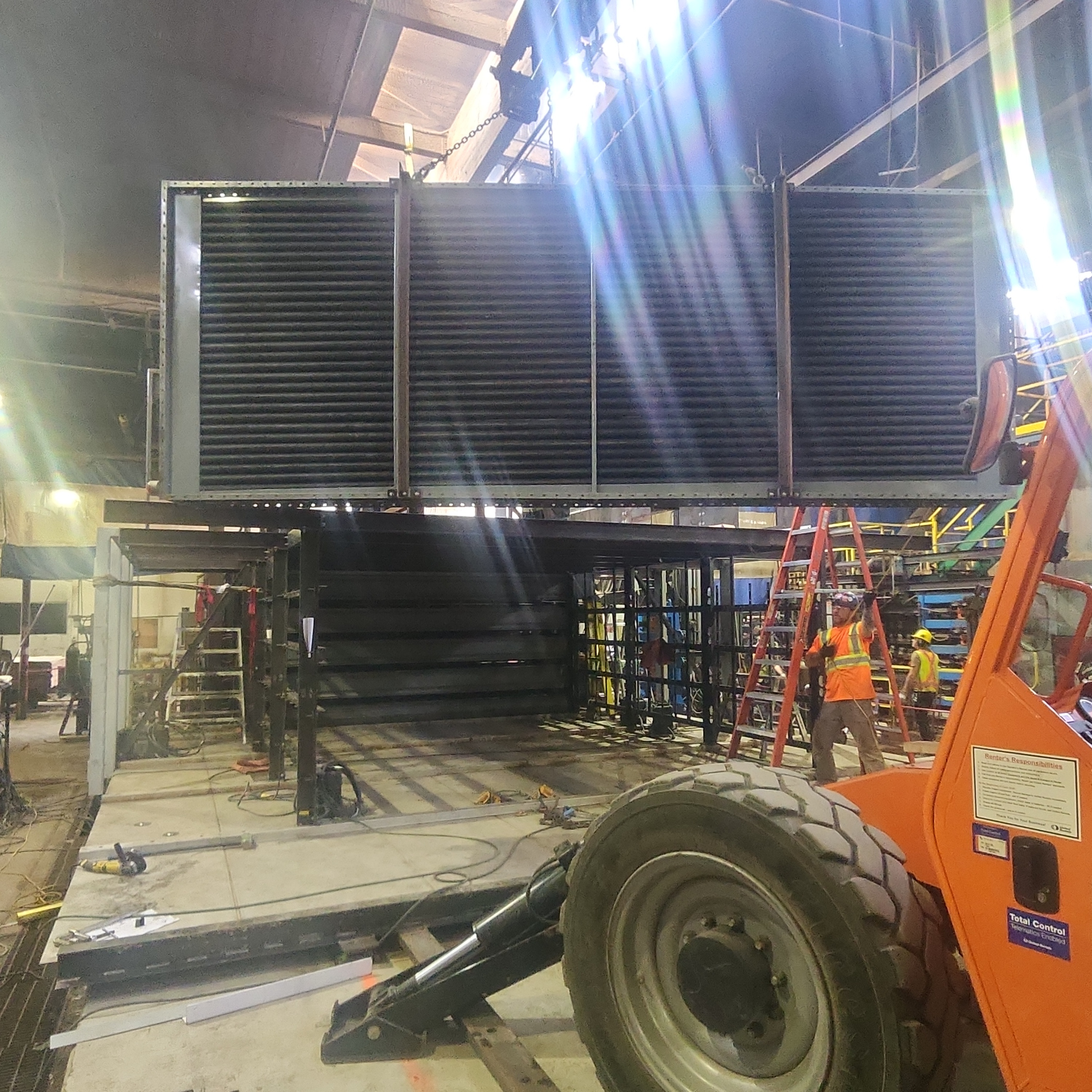

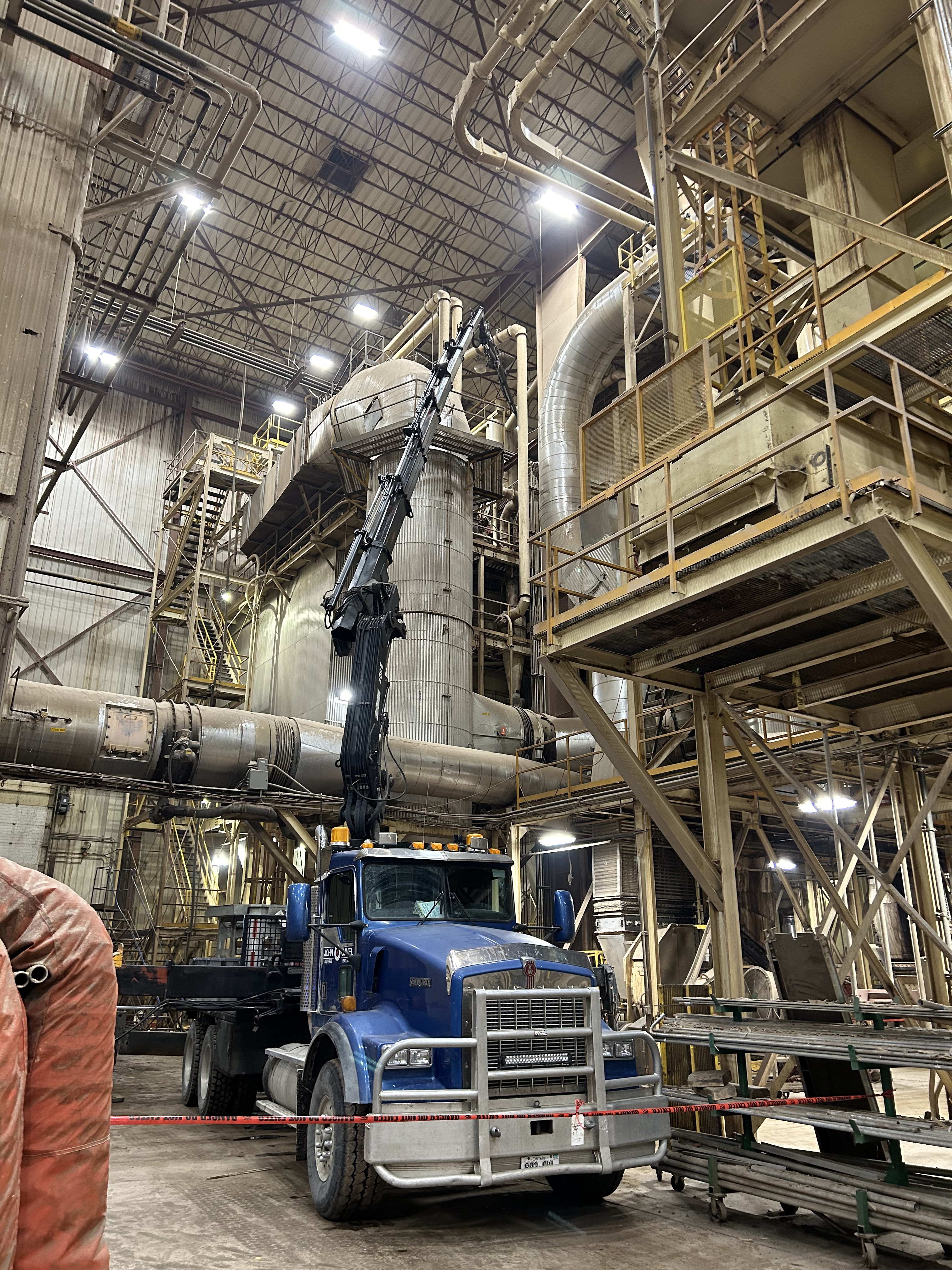

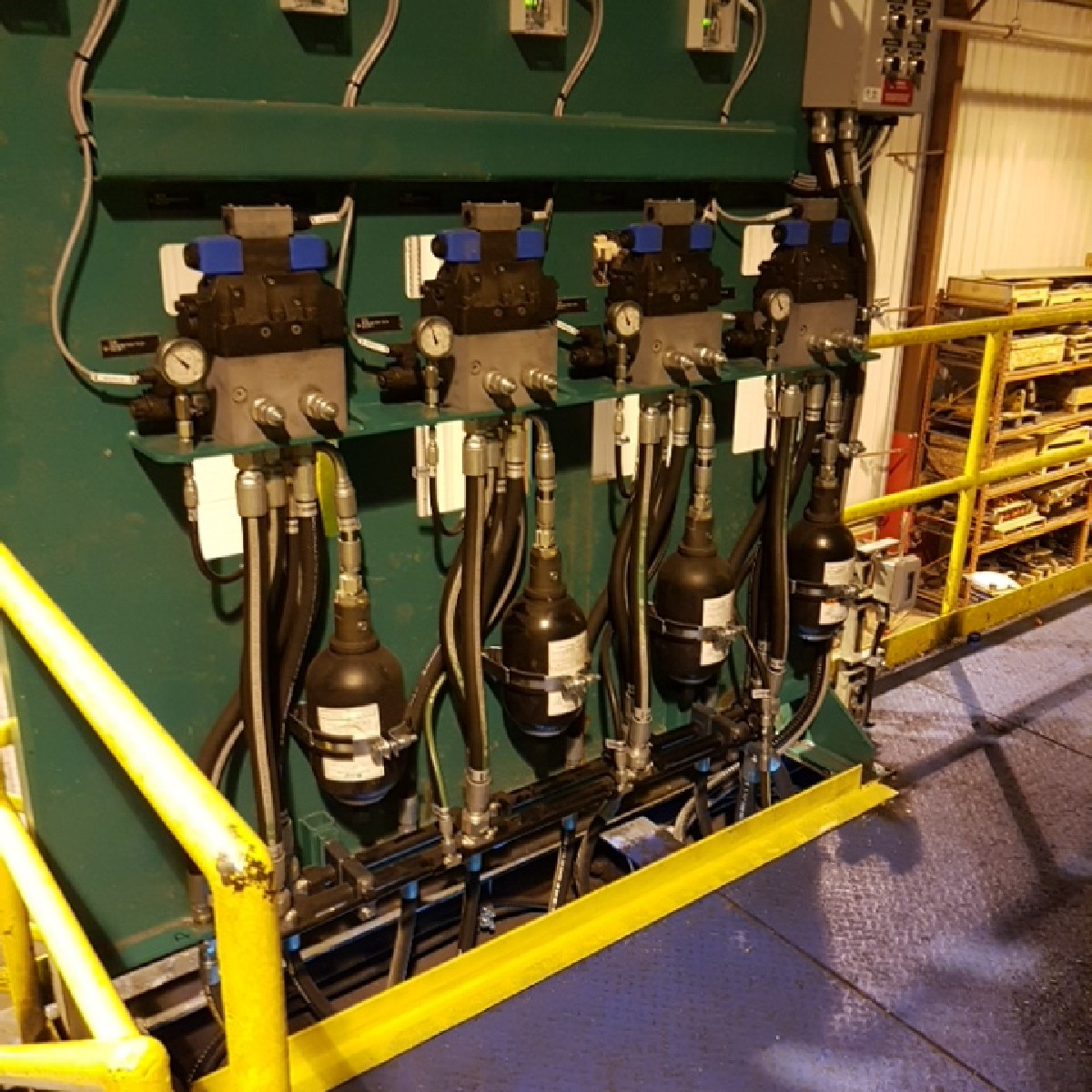

- Install new hydraulic power pack, lubricator and ring pullout HPU

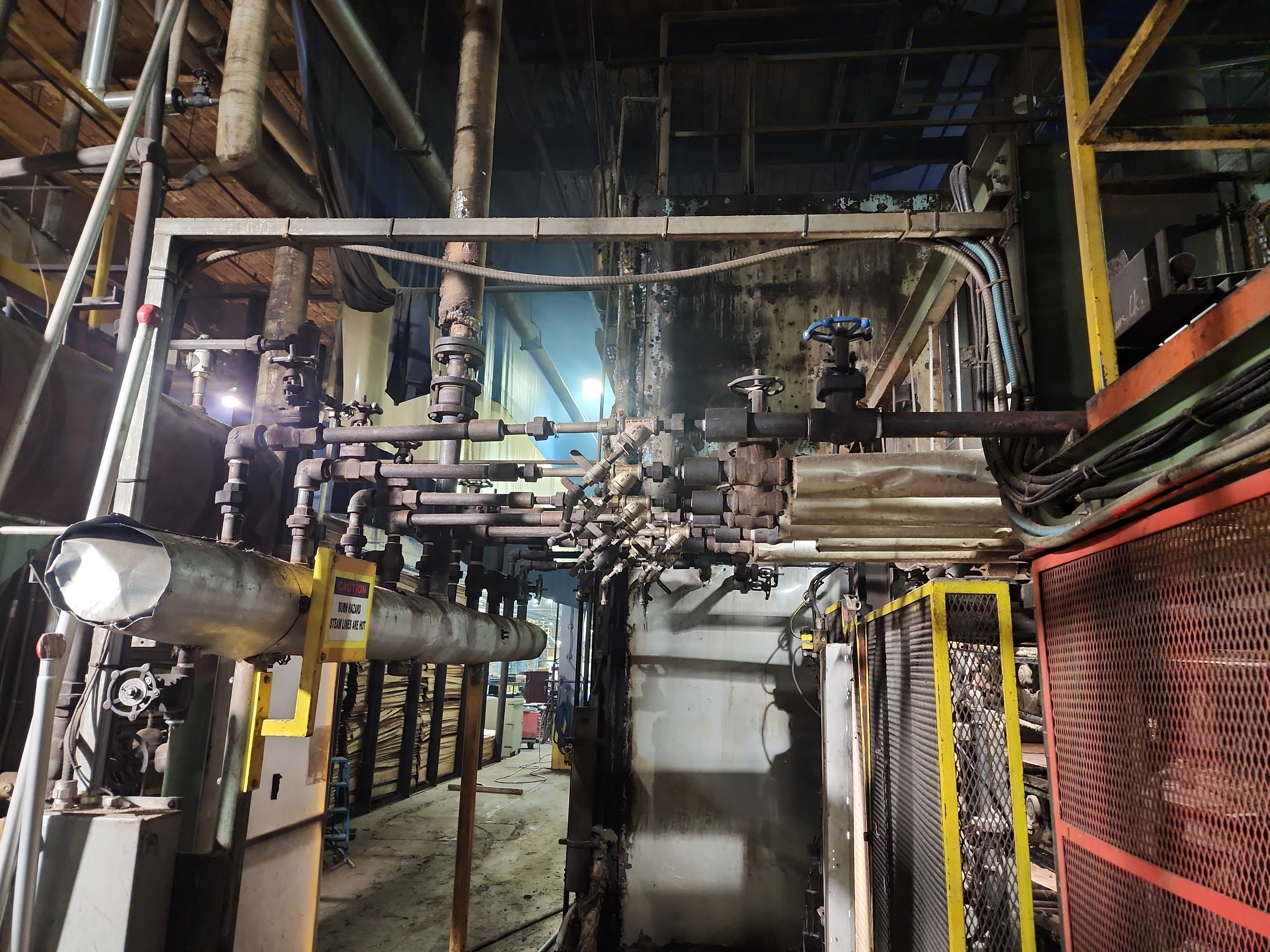

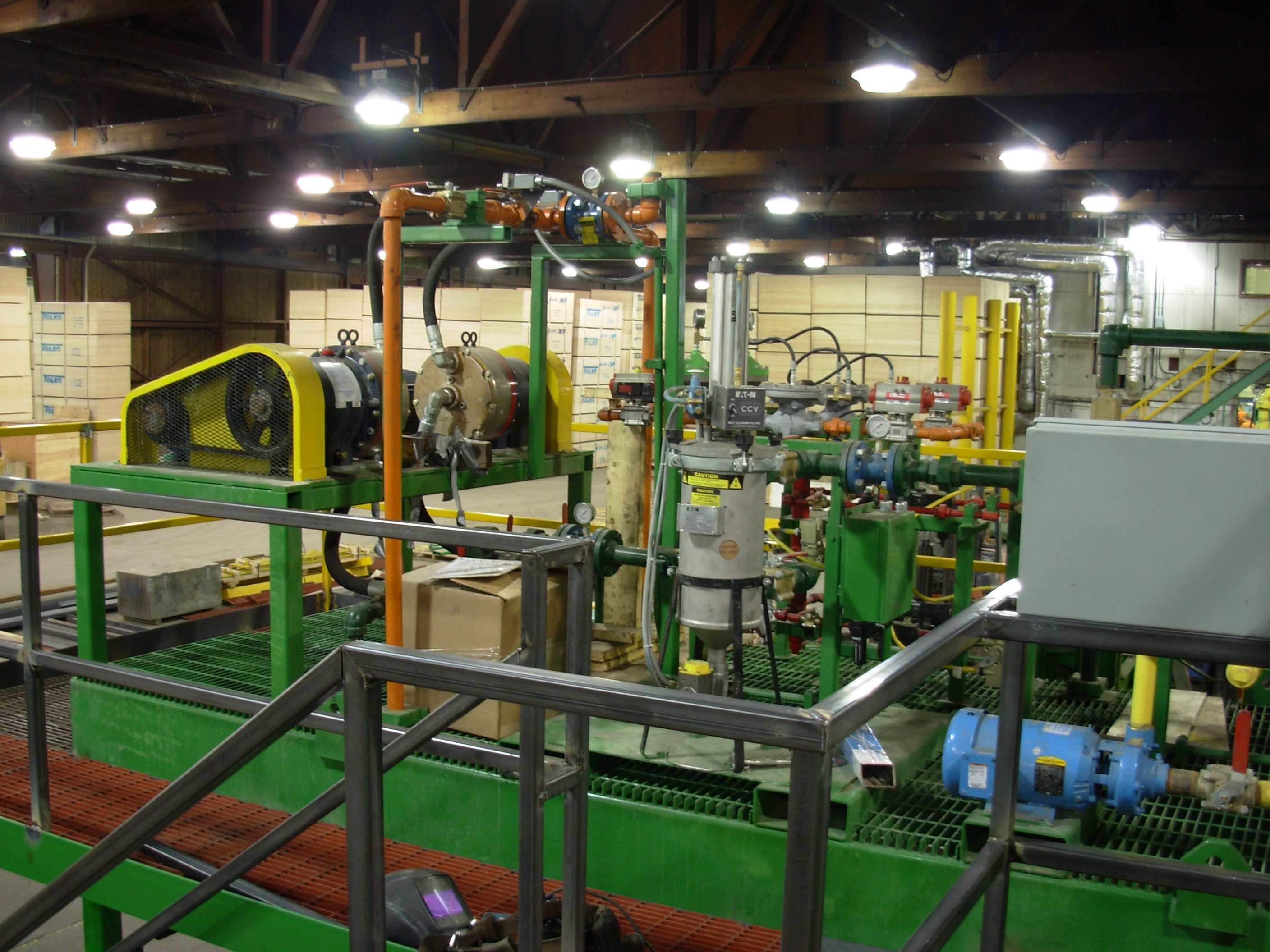

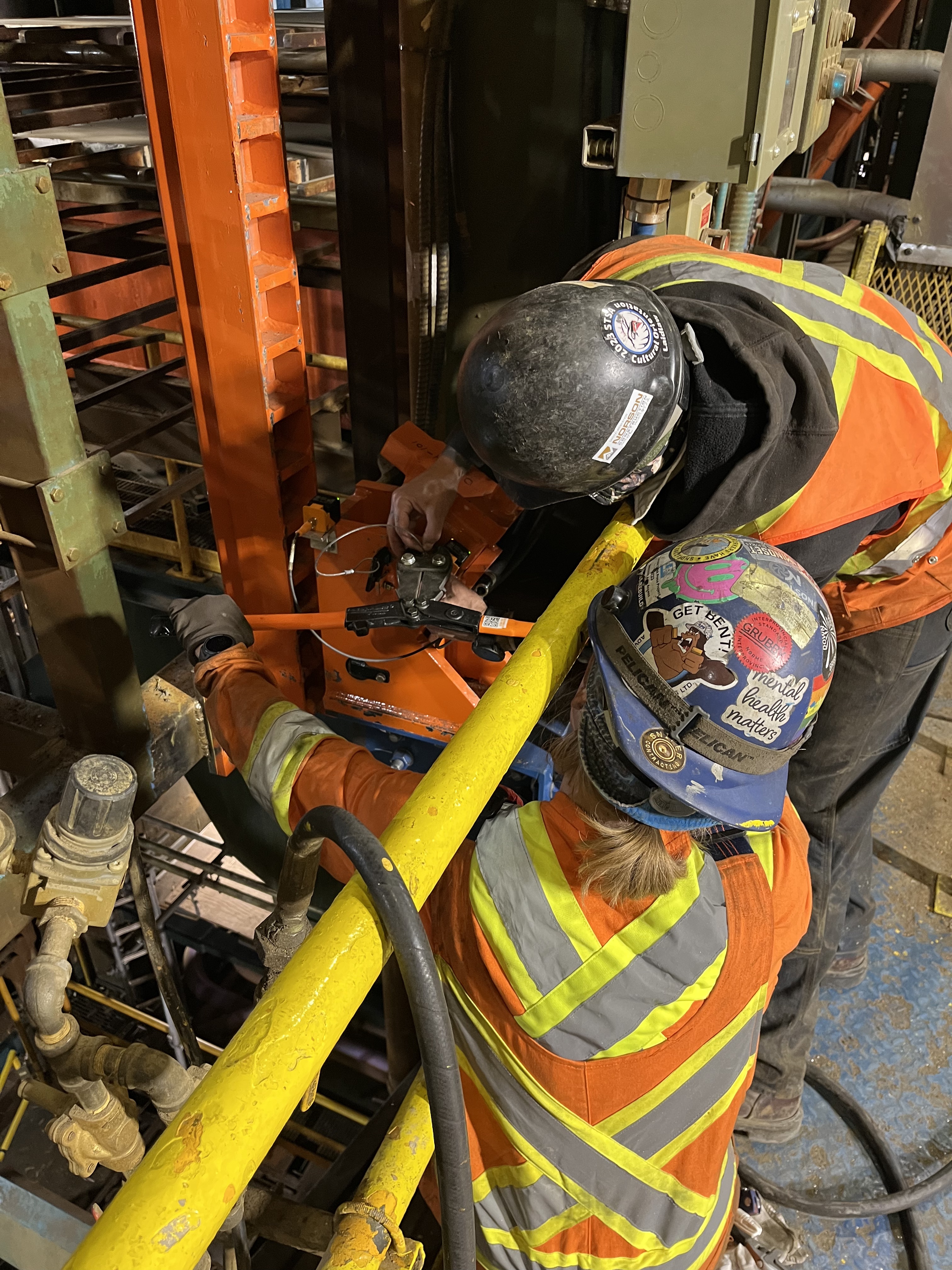

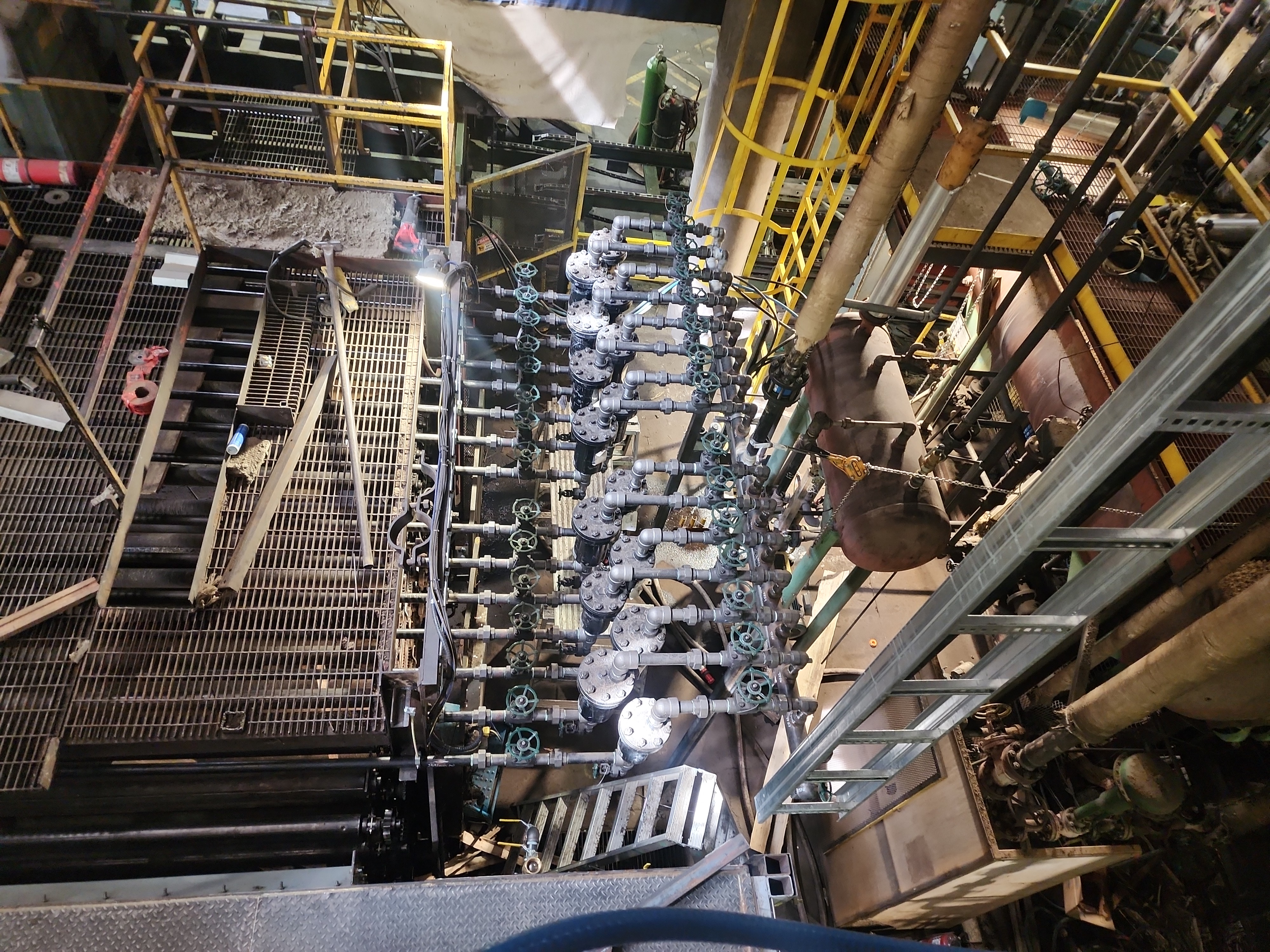

- Install hydraulic control valve bank and associated piping
- Modify compressed air system and install newly supplied air receiver
